Jedi Masters Reveal: Foundation Pack Best Practices Building Process Integrations Rajesh Raheja Senior Director, AIA Development October 13, 2009 Ivan Lazarov Director, AIA Product Management
The following is intended to outline our general product direction. It is intended for information purposes only, and may not be incorporated into any contract. It is not a commitment to deliver any material, code, or functionality, and should not be relied upon in making purchasing decisions. The development, release, and timing of any features or functionality described for Oracle’s products remains at the sole discretion of Oracle.

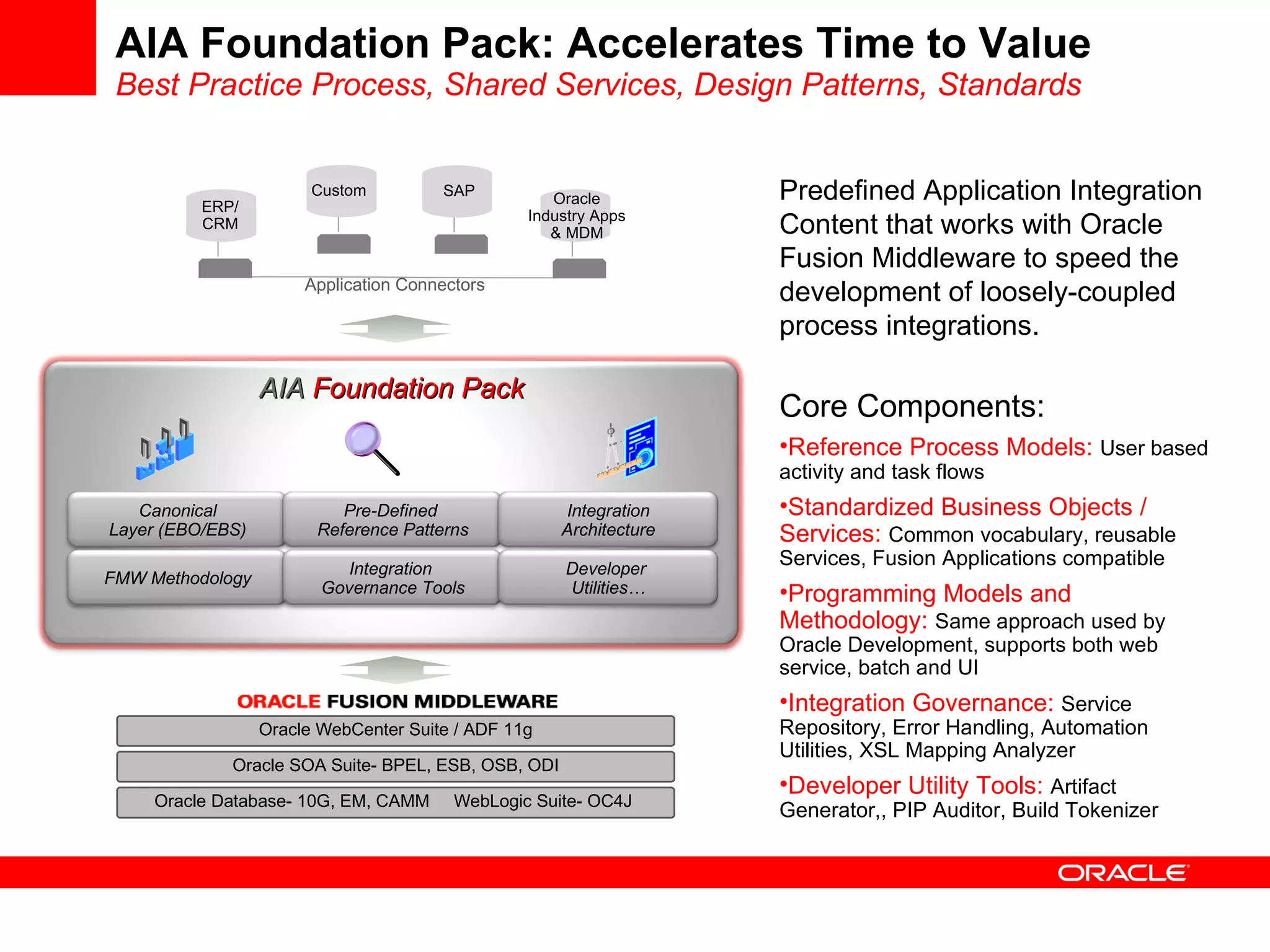

AIA Foundation Pack: Accelerates Time to Value Best Practice Process, Shared Services, Design Patterns, Standards Oracle Database- 10G, EM, CAMM WebLogic Suite- OC4J Oracle SOA Suite- BPEL, ESB, OSB, ODI Oracle WebCenter Suite / ADF 11g Application Connectors Predefined Application Integration Content that works with Oracle Fusion Middleware to speed the development of loosely-coupled process integrations. Core Components: Reference Process Models: User based activity and task flows Standardized Business Objects / Services: Common vocabulary, reusable Services, Fusion Applications compatible Programming Models and Methodology: Same approach used by Oracle Development, supports both web service, batch and UI Integration Governance: Service Repository, Error Handling, Automation Utilities, XSL Mapping Analyzer Developer Utility Tools: Artifact Generator,, PIP Auditor, Build Tokenizer SAP AIA Foundation Pack Canonical Layer (EBO/EBS) Pre-Defined Reference Patterns Integration Architecture FMW Methodology Integration Governance Tools Developer Utilities… Custom ERP/ CRM Oracle Industry Apps & MDM
Integration Project Phases <Insert Picture Here> Project Planning Requirements, Architecture and Design Extensions or new Development End to End Integration Testing Implementation and Rollout 5% 35% 20% 35% 5% Typical Integration Project Phases and Time Spent

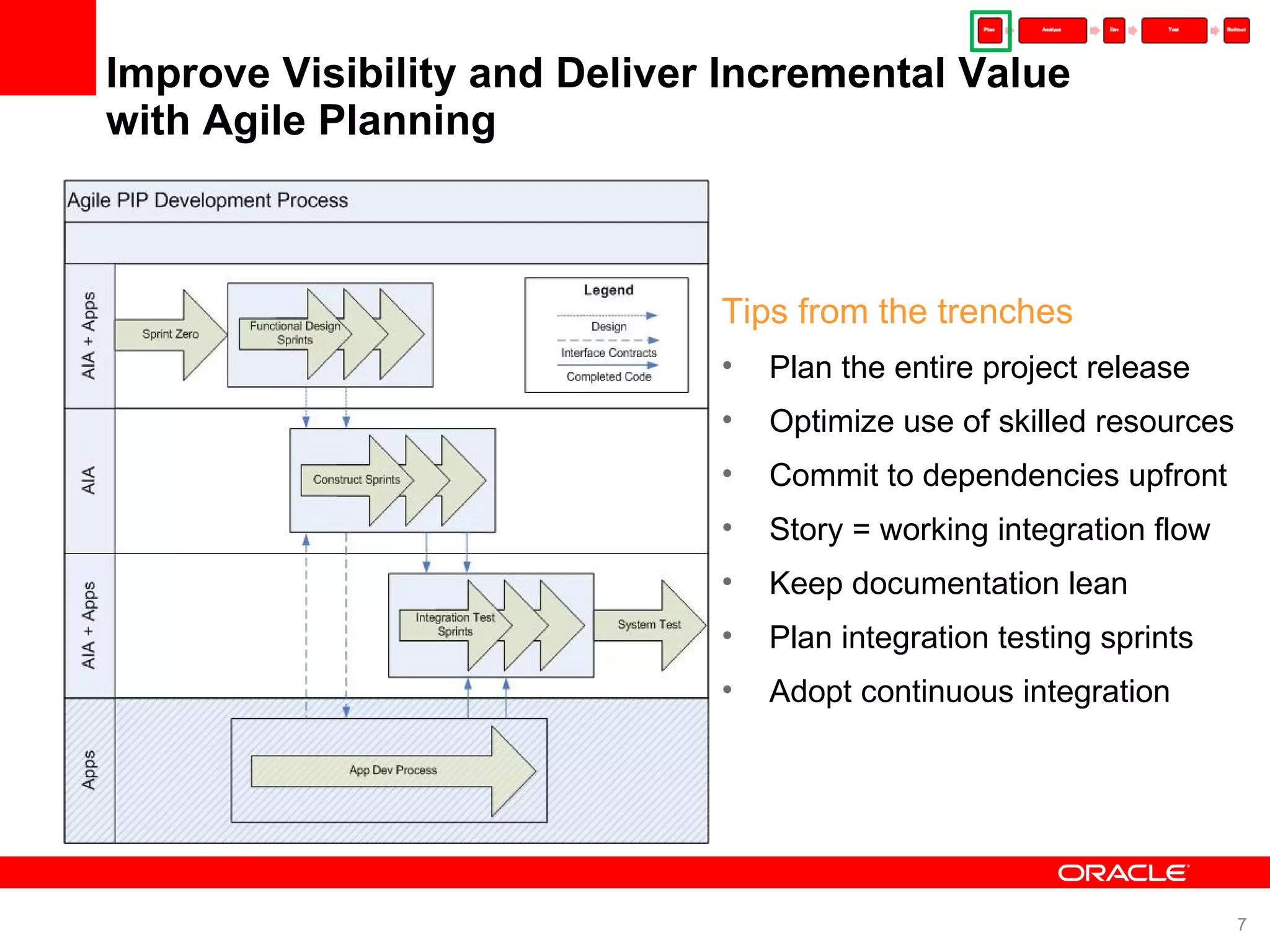

Improve Visibility and Deliver Incremental Value with Agile Planning Tips from the trenches Plan the entire project release Optimize use of skilled resources Commit to dependencies upfront Story = working integration flow Keep documentation lean Plan integration testing sprints Adopt continuous integration

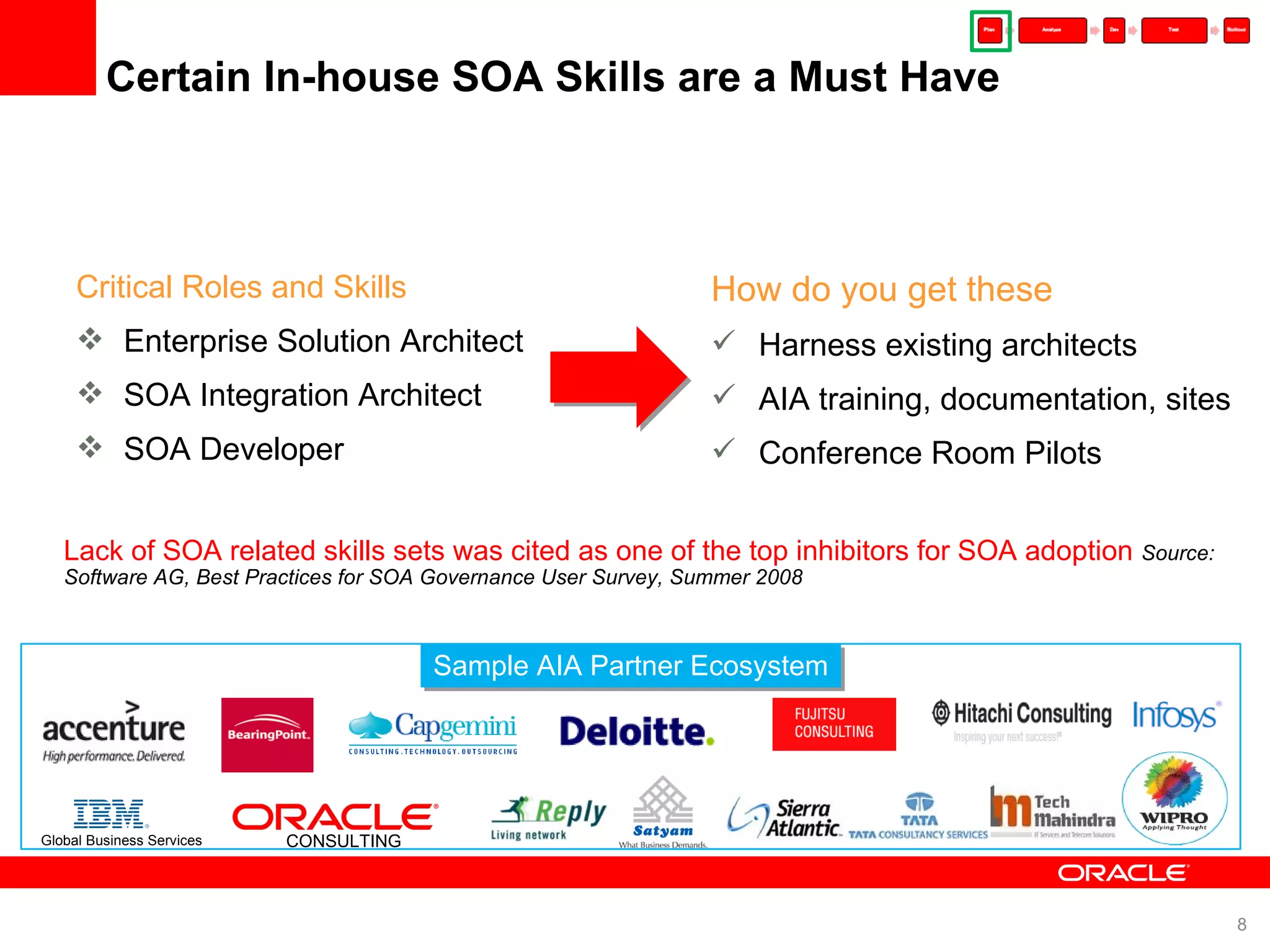

Certain In-house SOA Skills are a Must Have Critical Roles and Skills Enterprise Solution Architect SOA Integration Architect SOA Developer How do you get these Harness existing architects AIA training, documentation, sites Conference Room Pilots Lack of SOA related skills sets was cited as one of the top inhibitors for SOA adoption Source: Software AG, Best Practices for SOA Governance User Survey, Summer 2008 CONSULTING Global Business Services Sample AIA Partner Ecosystem

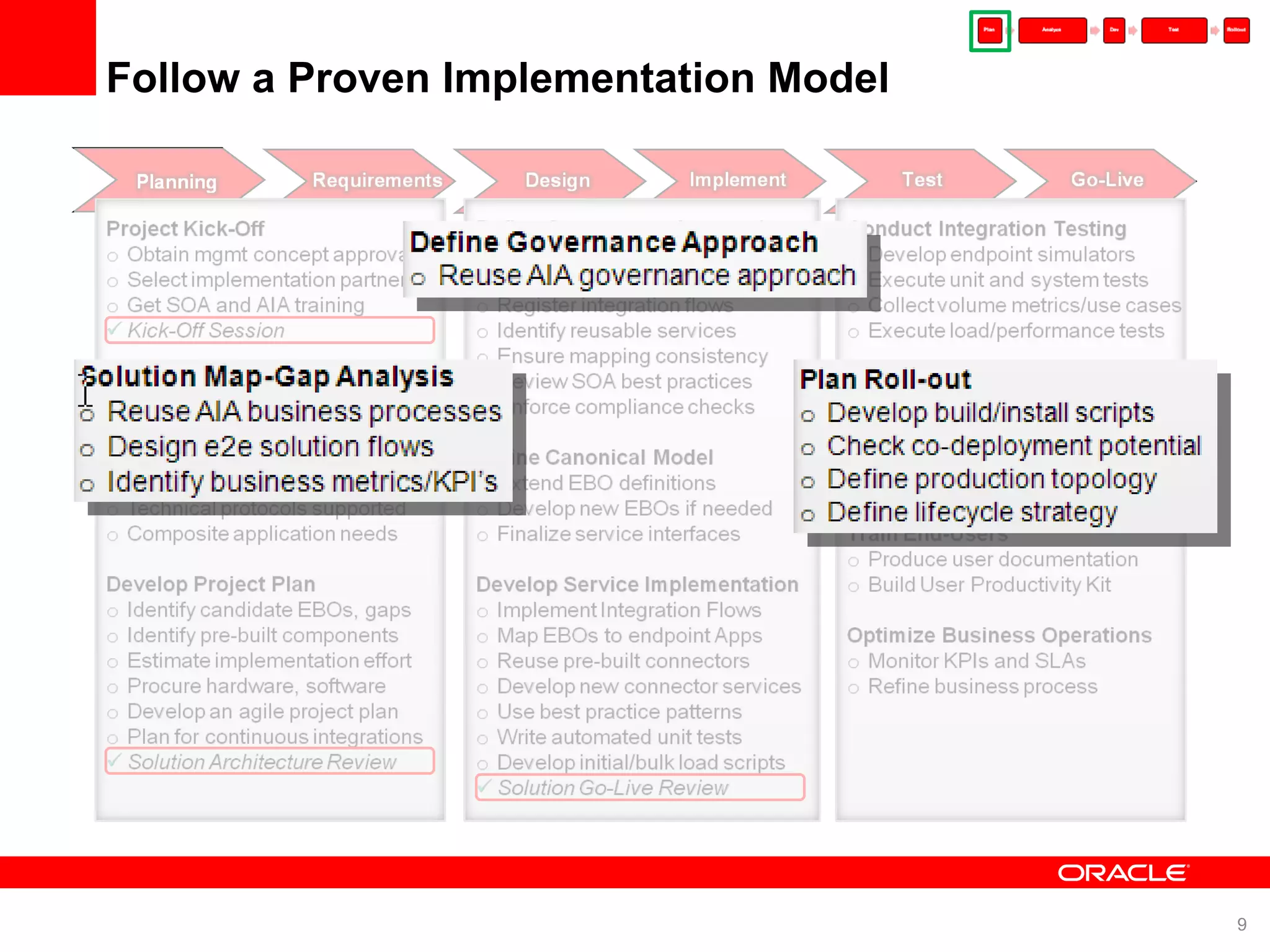

Follow a Proven Implementation Model

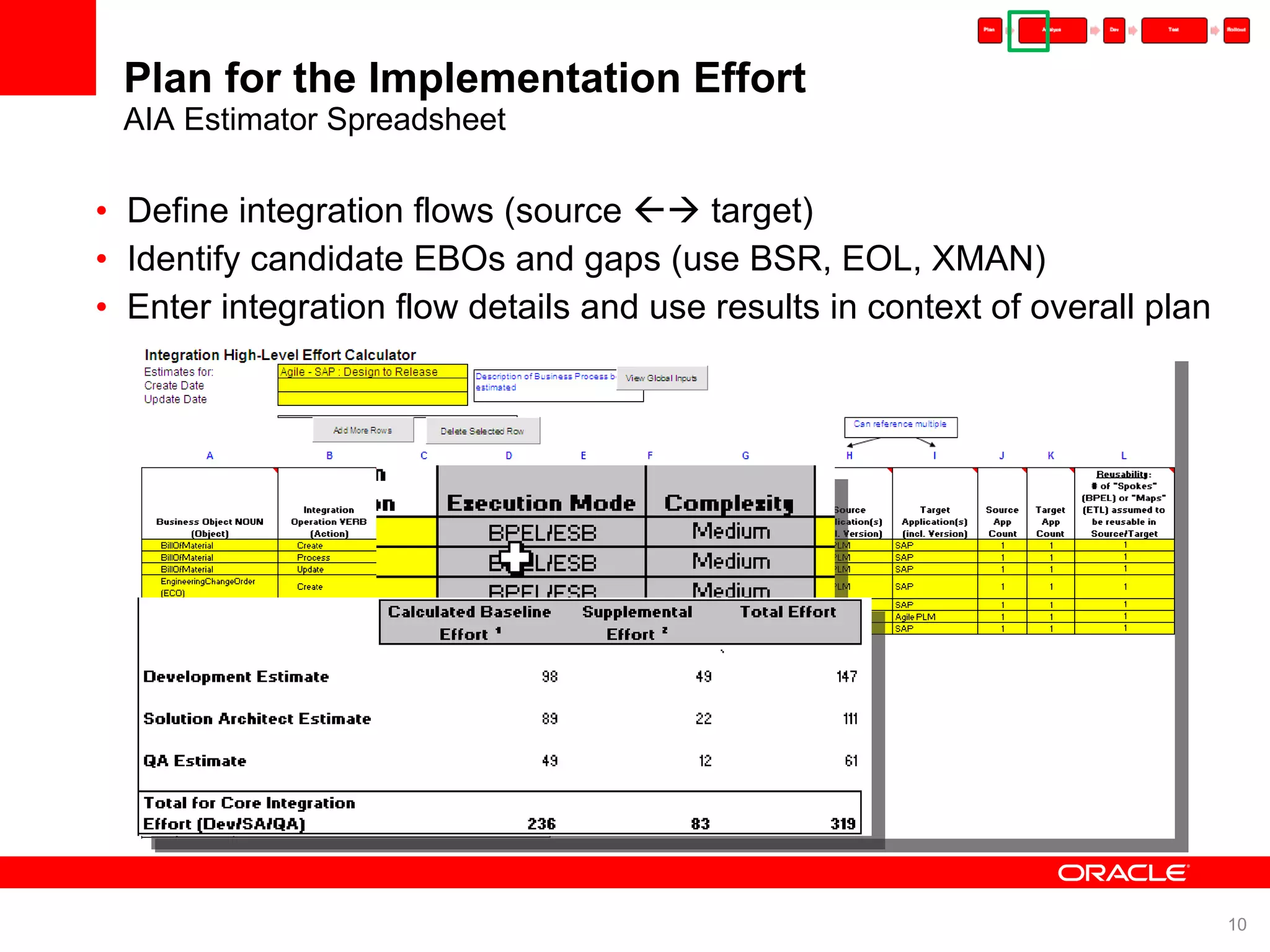

Plan for the Implementation Effort AIA Estimator Spreadsheet Define integration flows (source  target) Identify candidate EBOs and gaps (use BSR, EOL, XMAN) Enter integration flow details and use results in context of overall plan Siebel UI (new/updated Billing Mgmt screens) CustomerPartyEBS (Requestor ABCSs) CRM AIA BRM (Provider ABCSs) GetAccountBalanceSiebelABCS QueryCustomerListPortal ProvImplABCS BRM Web Service (JCA Adapter) BRM API (Opcode)

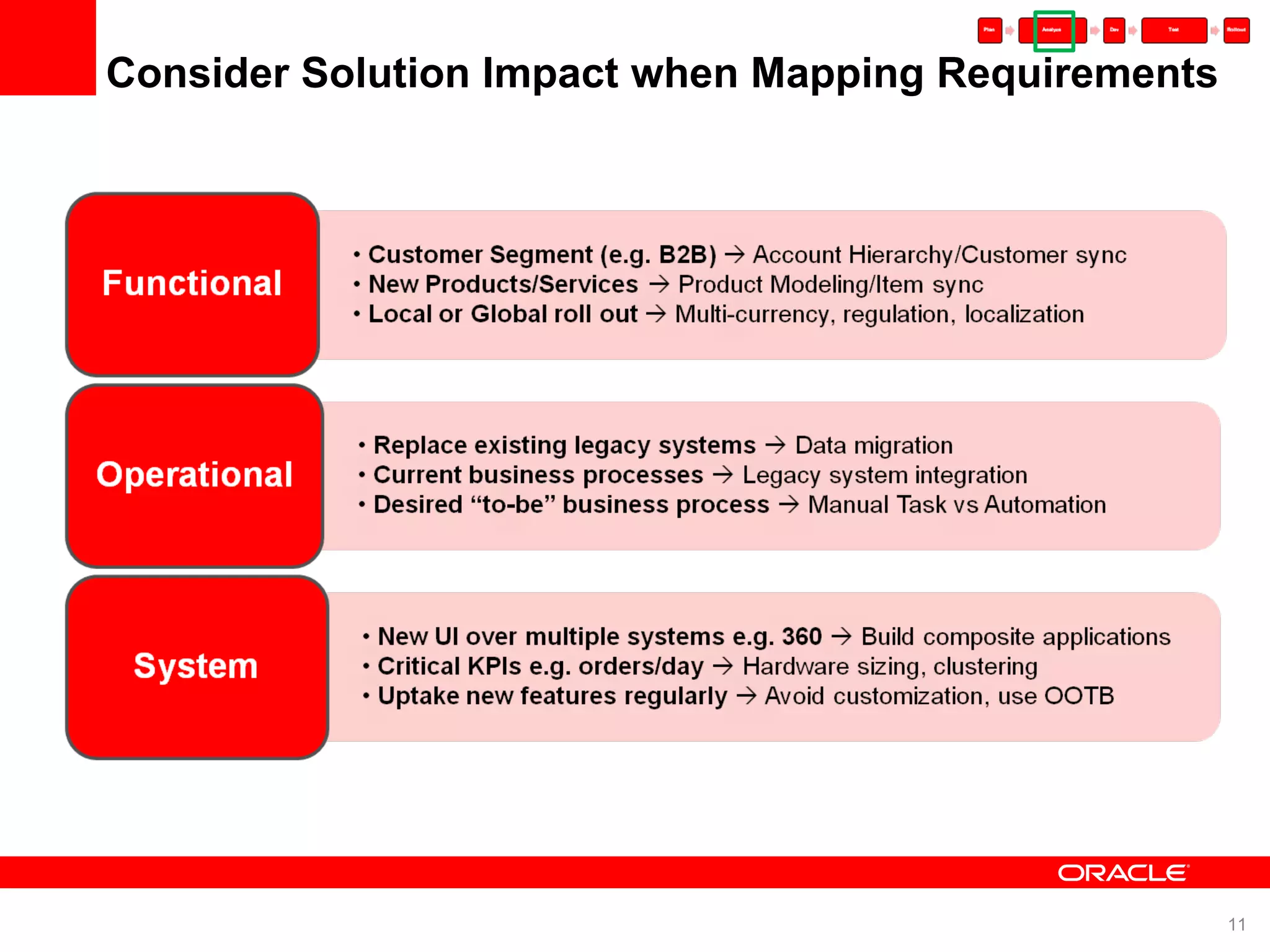

Consider Solution Impact when Mapping Requirements

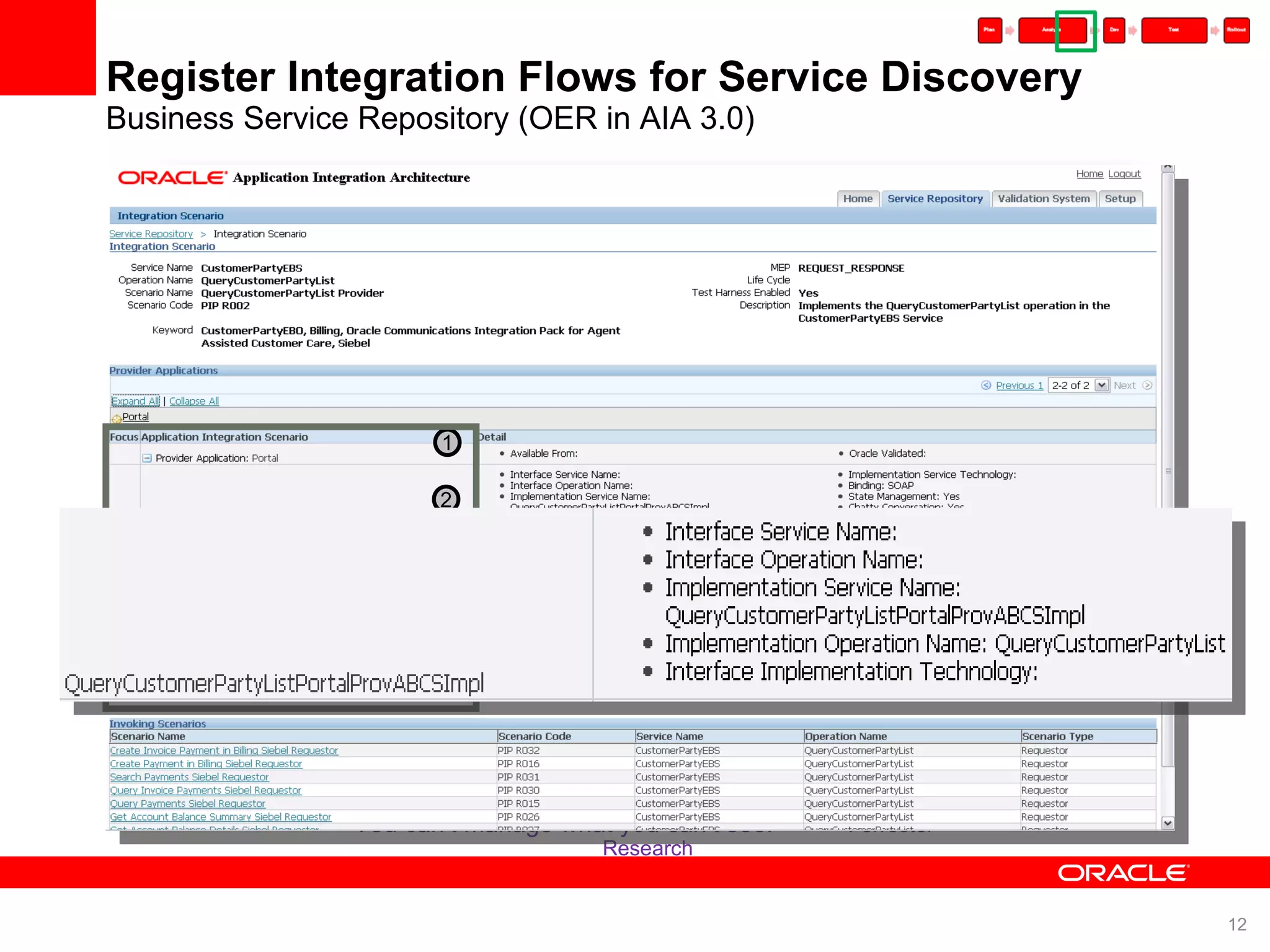

Register Integration Flows for Service Discovery Business Service Repository (OER in AIA 3.0) “ You can’t manage what you can’t see.” --- Forrester Research 1 2 3 4 5 Siebel UI (new/updated Billing Mgmt screens) CustomerPartyEBS (Requestor ABCSs) CRM AIA BRM (Provider ABCSs) GetAccountBalanceSiebelABCS QueryCustomerListPortal ProvImplABCS BRM Web Service (JCA Adapter) BRM API (Opcode)

Repository alone is insufficient for SOA governance Source: Software AG, Best Practices for SOA Governance User Survey, Summer 2008 Key Learning: SOA Governance should be… Engrained in the SDLC, not just confined to the “architects club” Automated and productive for developers to use everyday Focused on service interoperability in addition to discovery

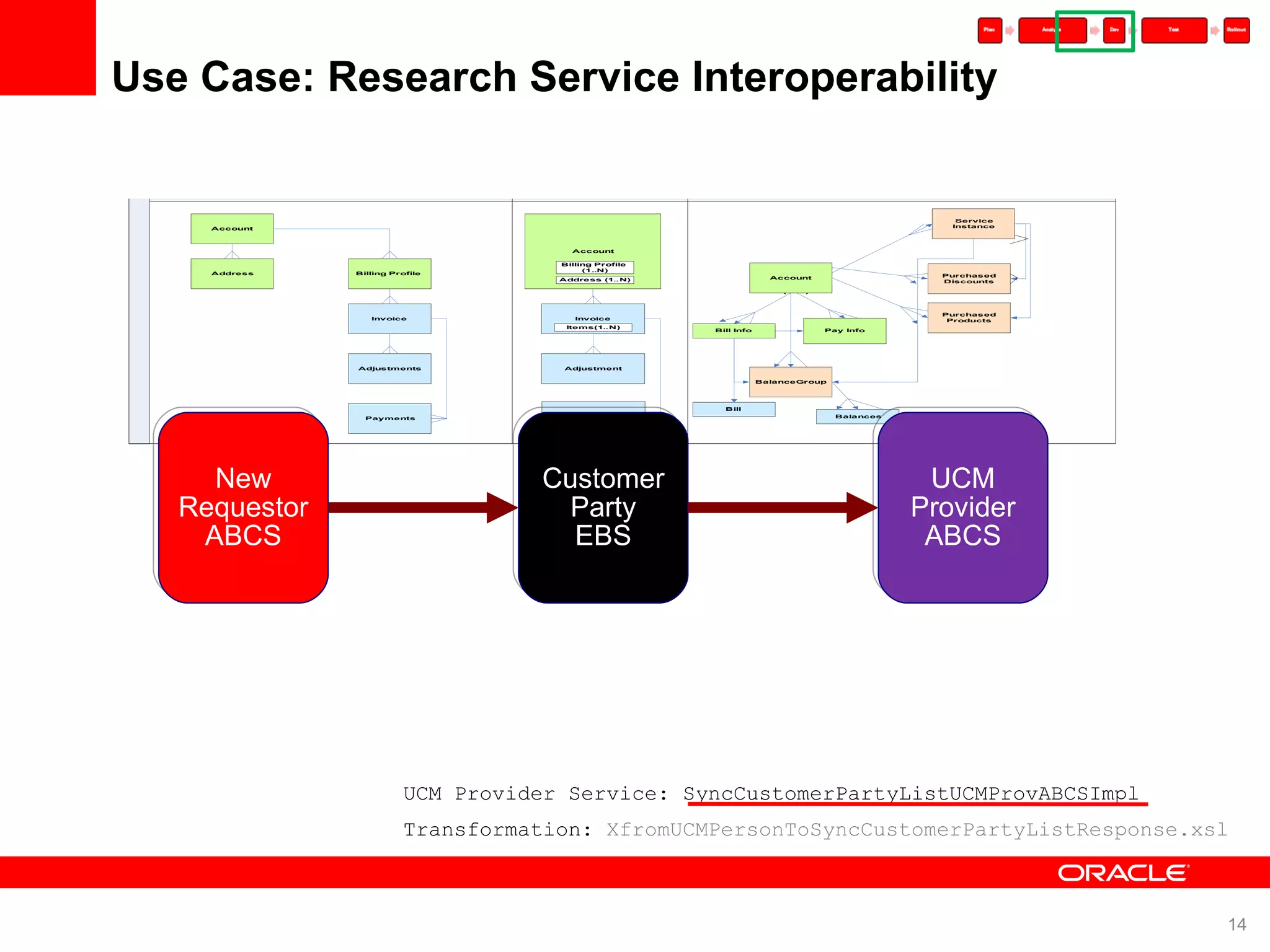

Use Case: Research Service Interoperability UCM Provider ABCS Customer Party EBS UCM Provider Service: SyncCustomerPartyListUCMProvABCSImpl Transformation: XfromUCMPersonToSyncCustomerPartyListResponse.xsl New Requestor ABCS

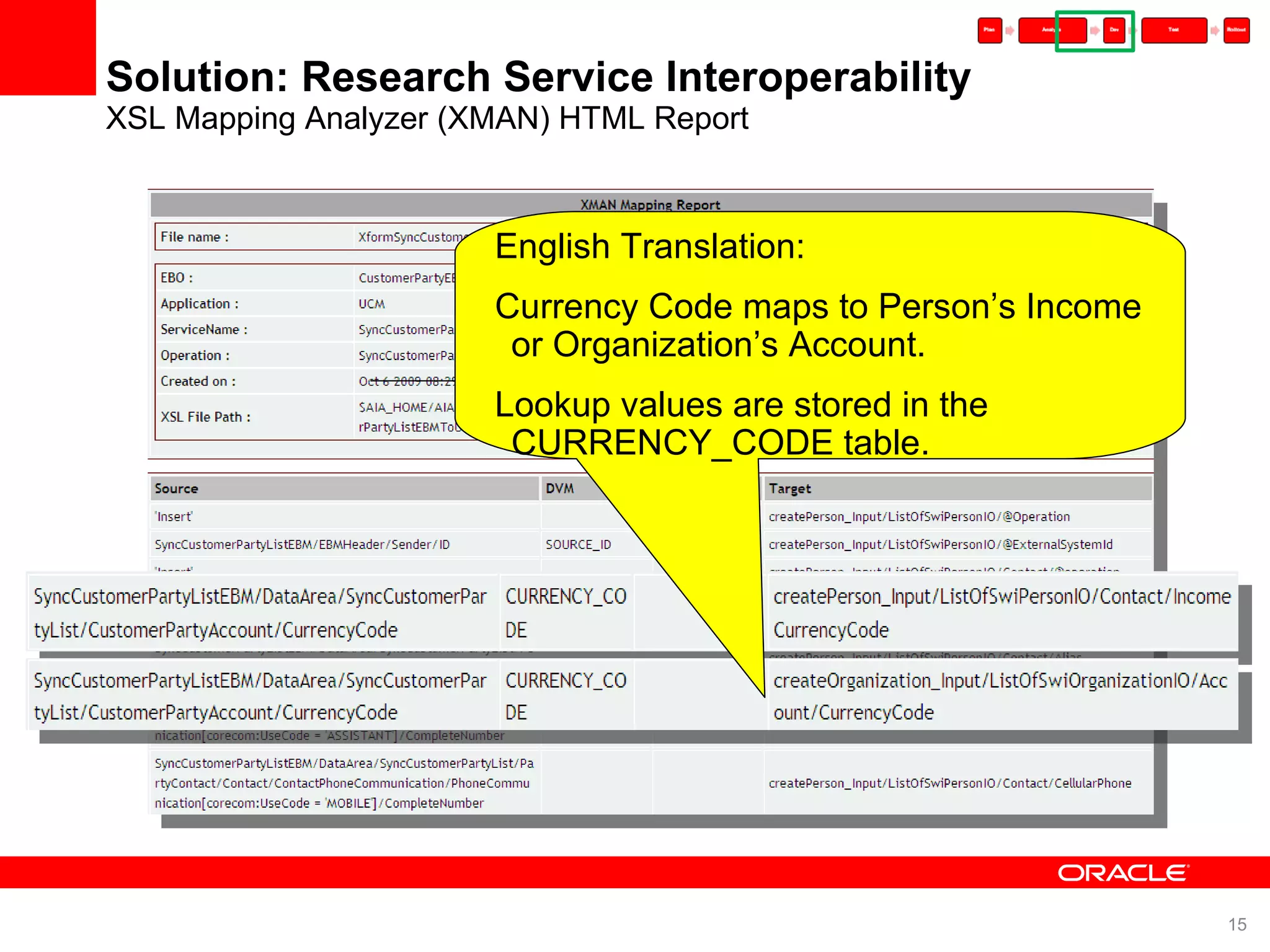

Solution: Research Service Interoperability XSL Mapping Analyzer (XMAN) HTML Report English Translation: Currency Code maps to Person’s Income or Organization’s Account. Lookup values are stored in the CURRENCY_CODE table.

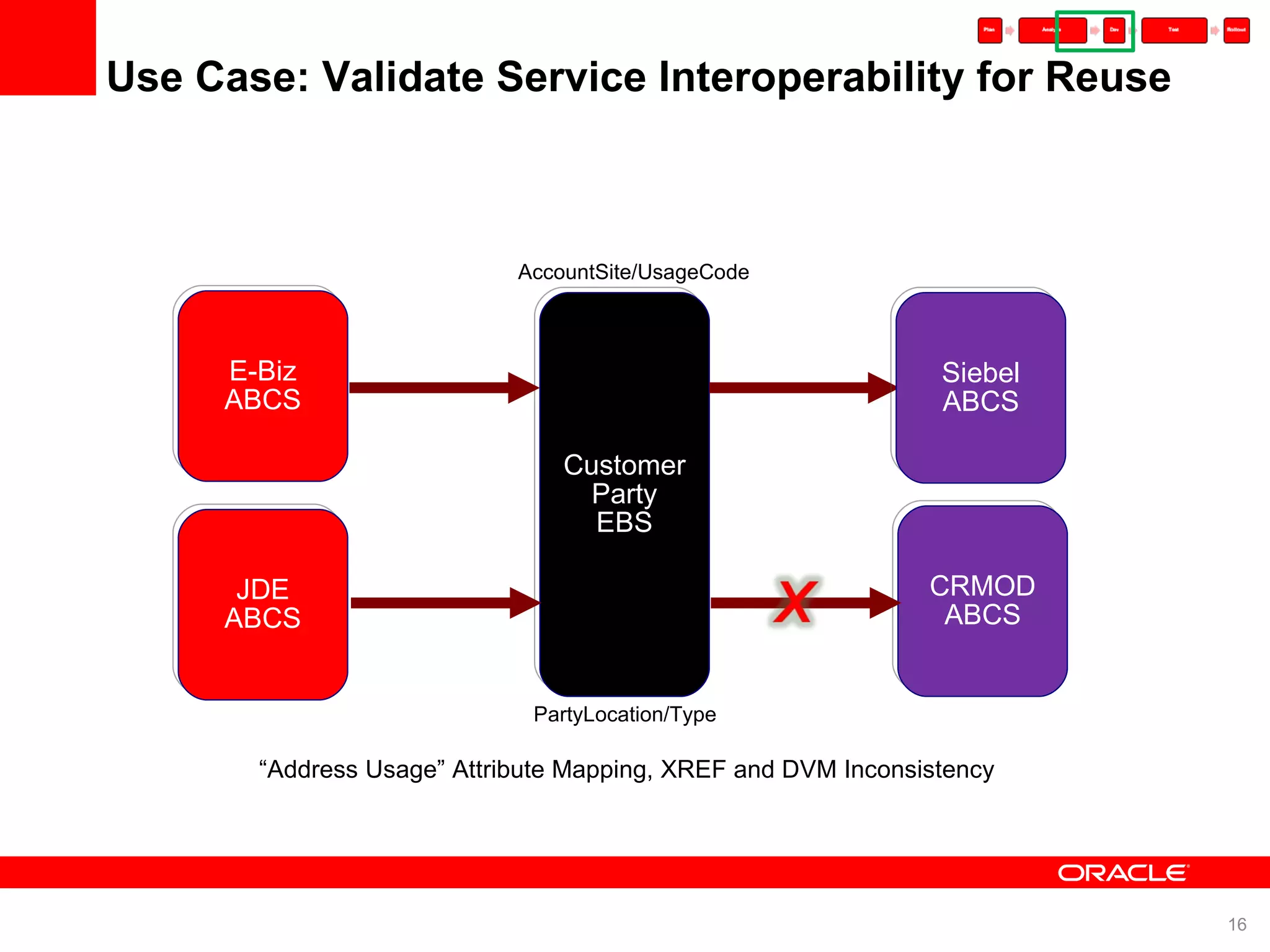

Use Case: Validate Service Interoperability for Reuse Customer Party EBS CRMOD ABCS Siebel ABCS E-Biz ABCS JDE ABCS AccountSite/UsageCode PartyLocation/Type “ Address Usage” Attribute Mapping, XREF and DVM Inconsistency

Solution: Validate Service Interoperability for Reuse XSL Mapping Analyzer (XMAN) CSV Reports English Translation: CRMOD ignores DUNS Inquiry Identifier. EBiz ignores a Contact’s phone/fax numbers.
Solution: Validate Service Interoperability for Reuse XSL Mapping Analyzer (XMAN) CSV Reports English Translation: CRMOD ignores Accounts (uses Party). Only BRM and Siebel care about Billing Profile.

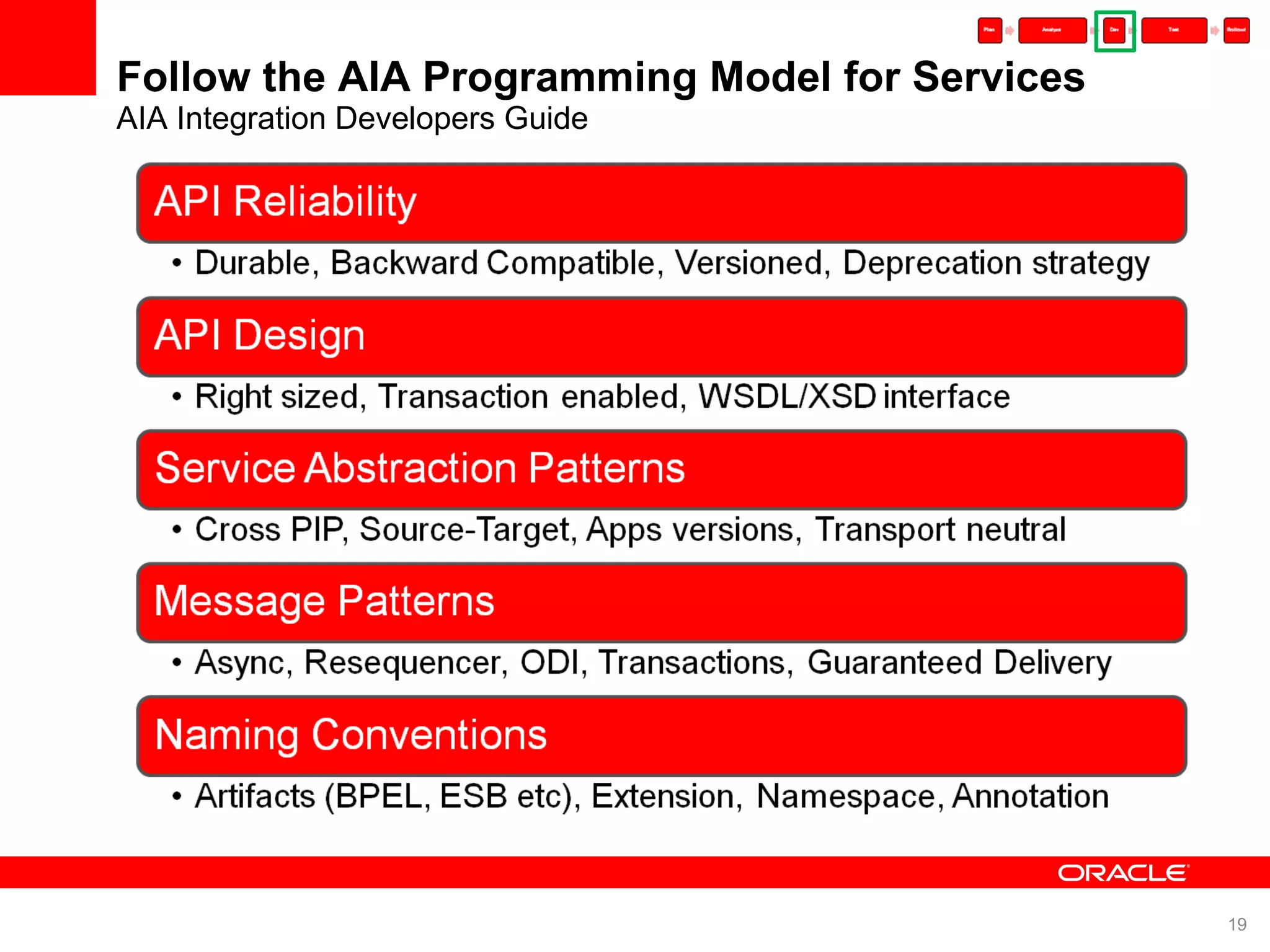

Follow the AIA Programming Model for Services AIA Integration Developers Guide

Ensure Adherence to Architecture Standards SOA Validation Checklists (Architecture and SOA Component Level)
Generate Standards Compliant Service Outlines AIA Artifact Generator AIA Artifact Generator Template Files e.g. BPEL Output BPEL ABCS File <process name= “ UpdateSalesOrderSiebelProvABCSImpl” … </process> Service Design Specification <ABCSType>Provider</ABCSType> <Verb>Update</Verb> Automates All AIA Naming Conventions Namespace definitions EBM Header population Error Handling and Extension hook points Invoke activities … and more…. SAVES TIME!!!

Ensure Adherence to AIA Standards PIP Auditor with Extensible, Categorized and Prioritized Test Cases

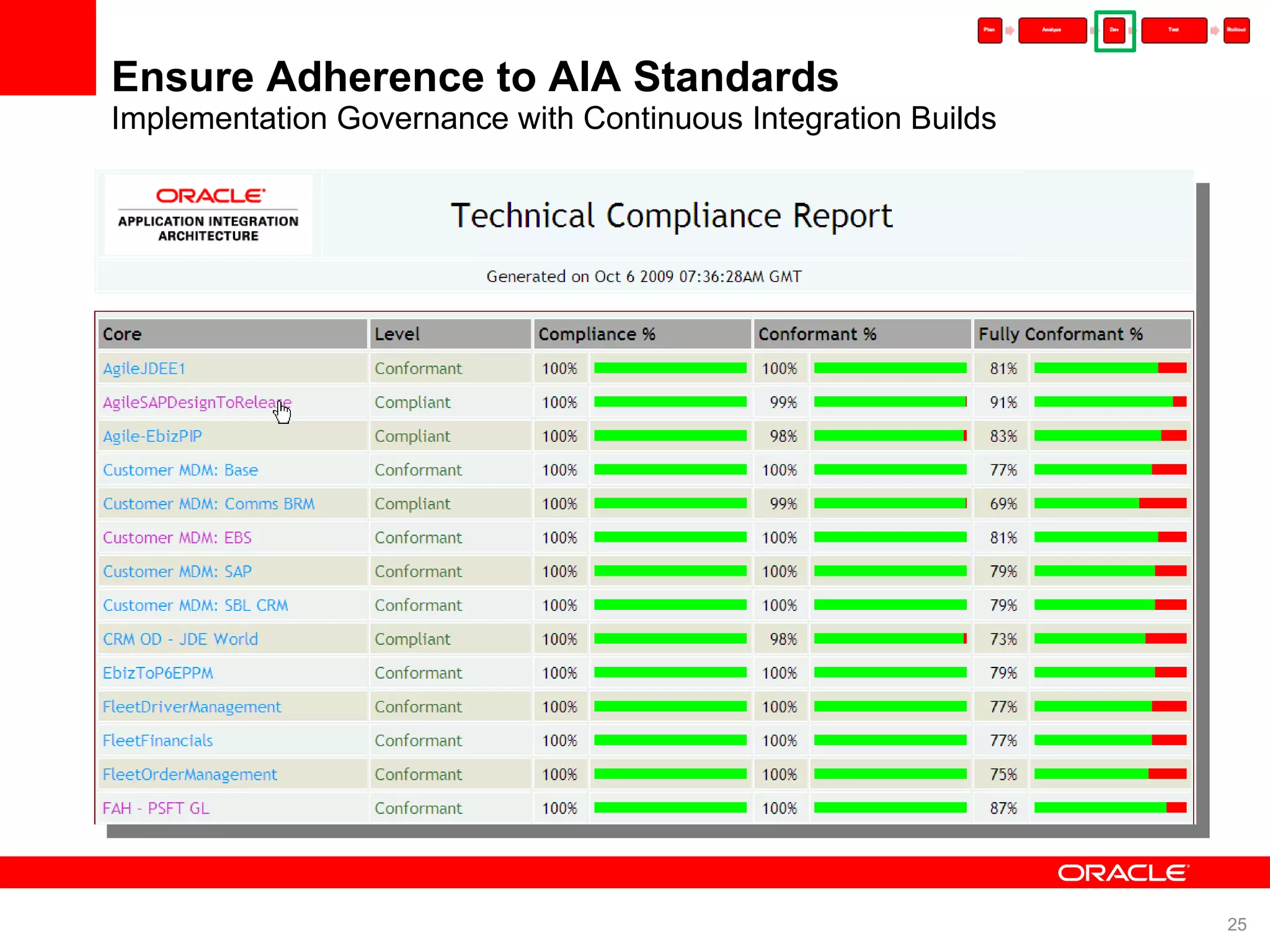

Ensure Adherence to AIA Standards PIP Auditor Detailed Results
Ensure Adherence to AIA Standards PIP Auditor –Analyze Co-Deployment between every PIP combination
Ensure Adherence to AIA Standards Implementation Governance with Continuous Integration Builds

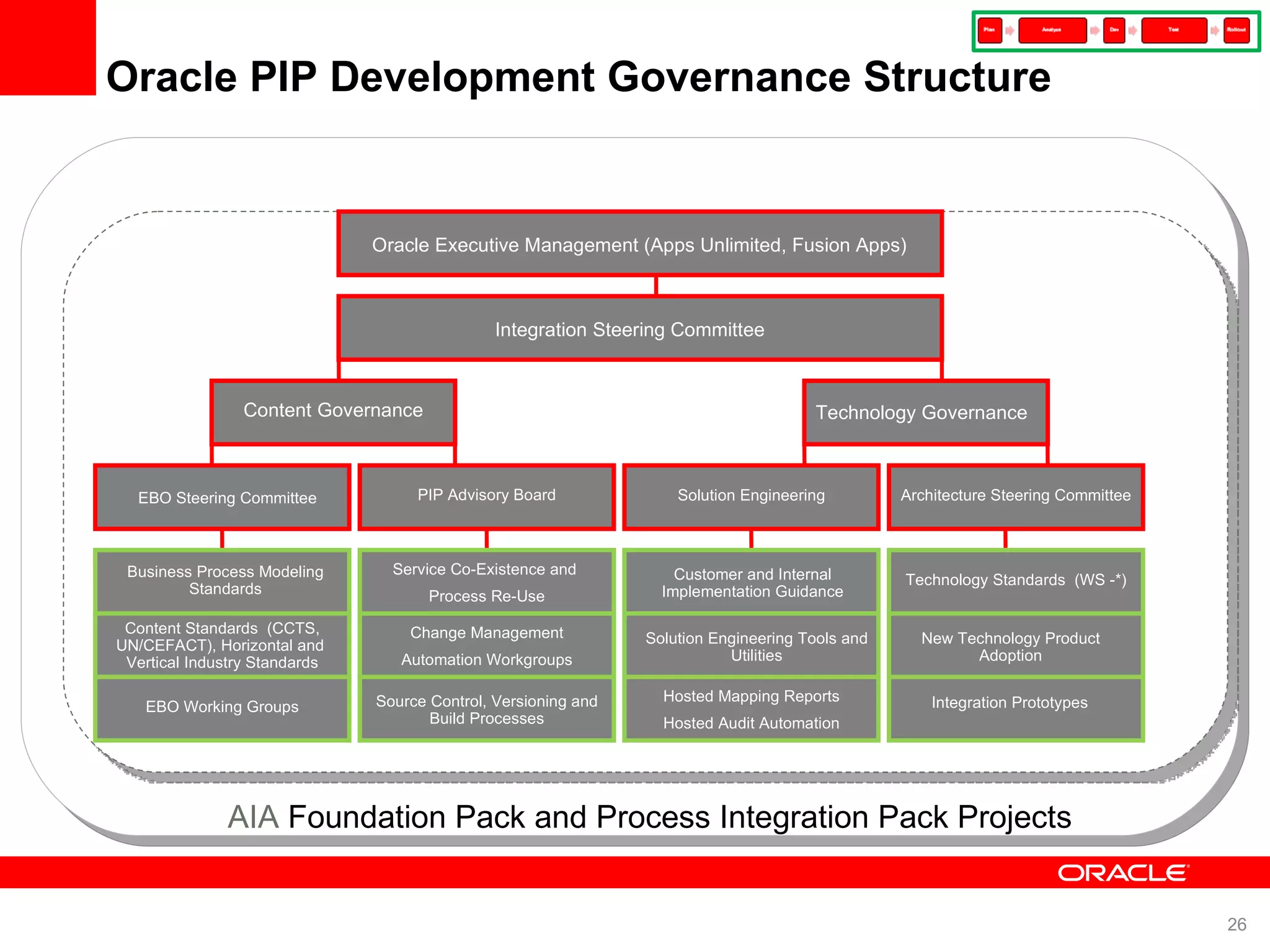

Oracle PIP Development Governance Structure AIA Foundation Pack and Process Integration Pack Projects Oracle Executive Management (Apps Unlimited, Fusion Apps) ‏ Integration Steering Committee Technology Governance Content Governance EBO Steering Committee Solution Engineering Architecture Steering Committee PIP Advisory Board Content Standards (CCTS, UN/CEFACT), Horizontal and Vertical Industry Standards Business Process Modeling Standards EBO Working Groups Service Co-Existence and Process Re-Use Change Management Automation Workgroups Technology Standards (WS -*) New Technology Product Adoption Integration Prototypes Source Control, Versioning and Build Processes Hosted Mapping Reports Hosted Audit Automation Solution Engineering Tools and Utilities Customer and Internal Implementation Guidance

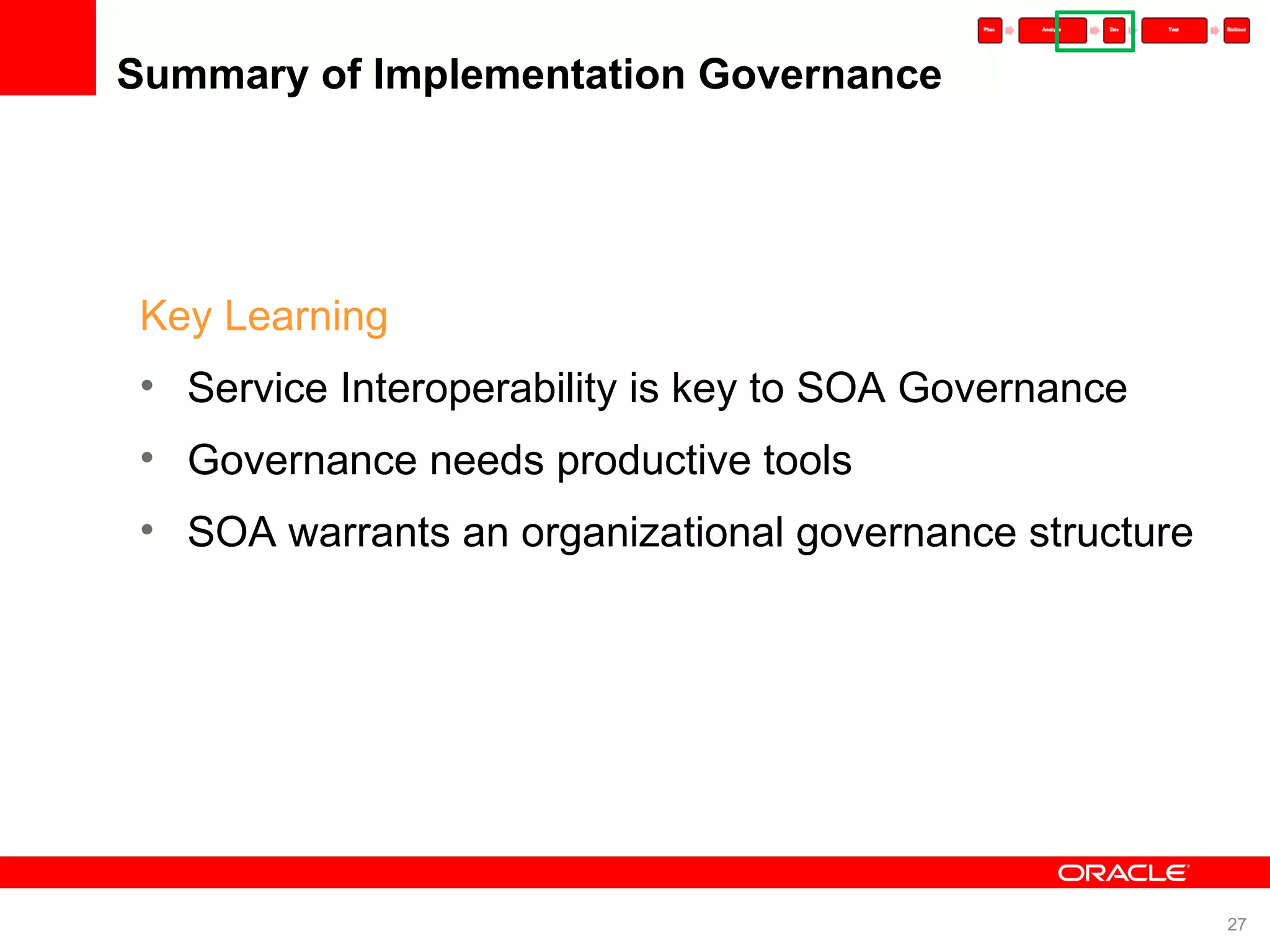

Summary of Implementation Governance Key Learning Service Interoperability is key to SOA Governance Governance needs productive tools SOA warrants an organizational governance structure
Define Lifecycle Strategy Build, Install, Apps Setup, Data Setup, Tuning Development Stage Source control and label custom/extended artifacts Write custom build, deploy and PIP manifest scripts Setup Apps seed data, configuration and export Build Stage Install AIA using “Files Only” option to lay down code Run custom build script and URL tokenizer Zip up entire AIA_HOME and create SOA env clone Deploy Stage Unzip AIA_HOME on production SOA (or clone) Run all deploy scripts – OOTB and custom Import Apps seed data and configuration

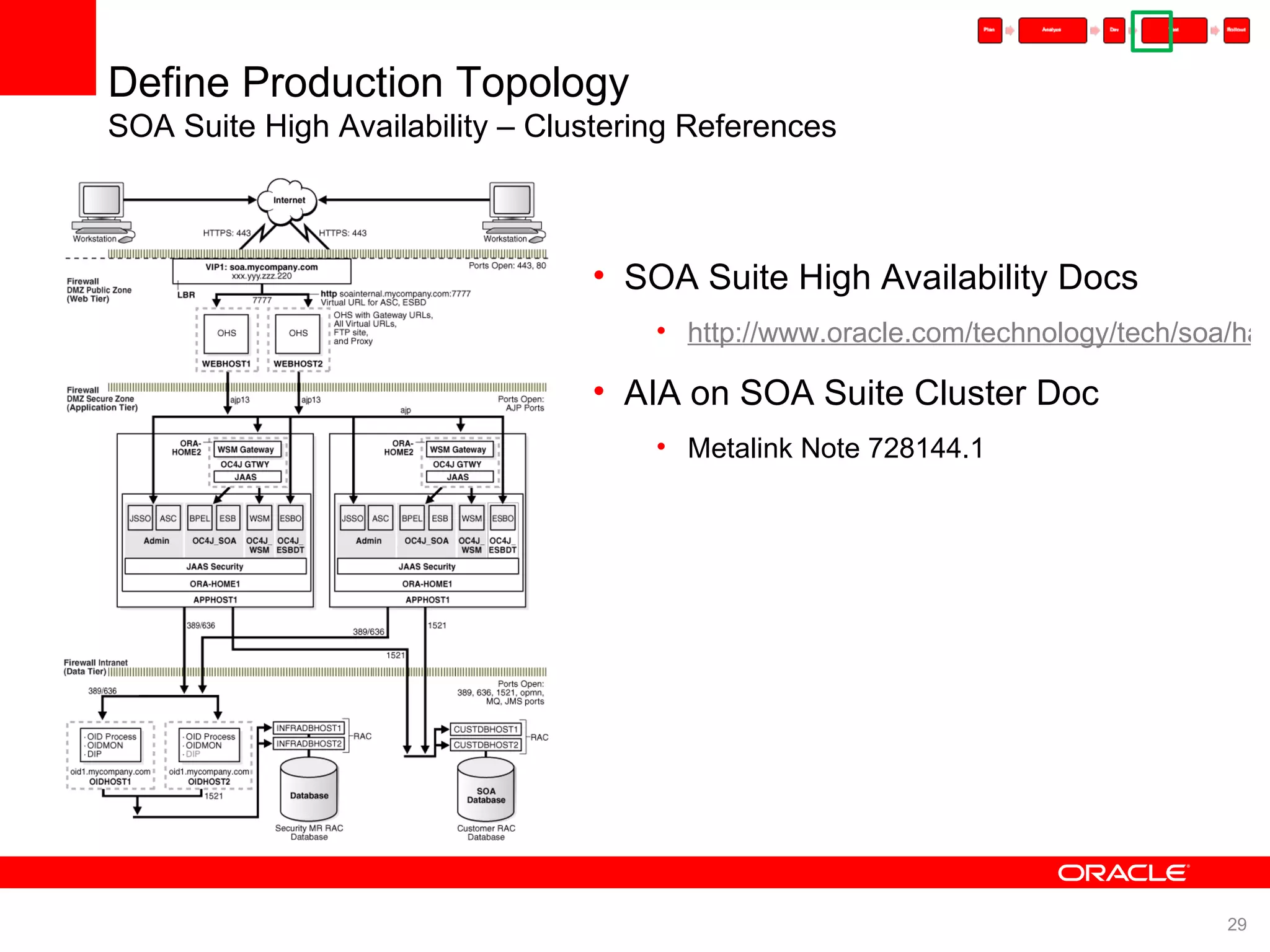

Define Production Topology SOA Suite High Availability – Clustering References SOA Suite High Availability Docs http://www.oracle.com/technology/tech/soa/ha/index.html AIA on SOA Suite Cluster Doc Metalink Note 728144.1

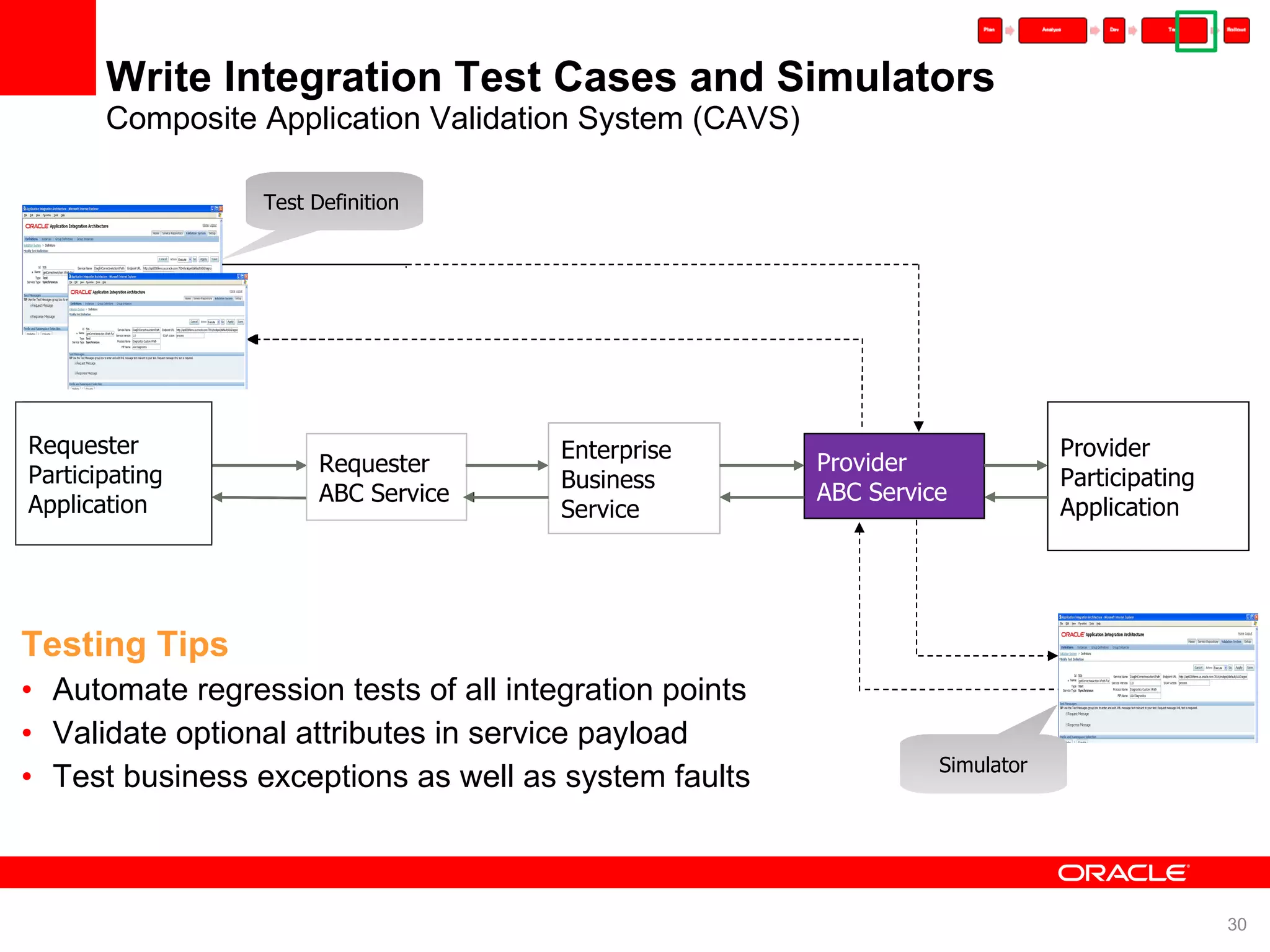

Write Integration Test Cases and Simulators Composite Application Validation System (CAVS) Testing Tips Automate regression tests of all integration points Validate optional attributes in service payload Test business exceptions as well as system faults Provider Participating Application Provider Participating Application Provider ABC Service Provider ABC Service Provider ABC Service Requester Participating Application Enterprise Business Service Requester ABC Service Test Definition Simulator Requester Participating Application Enterprise Business Service Requester ABC Service

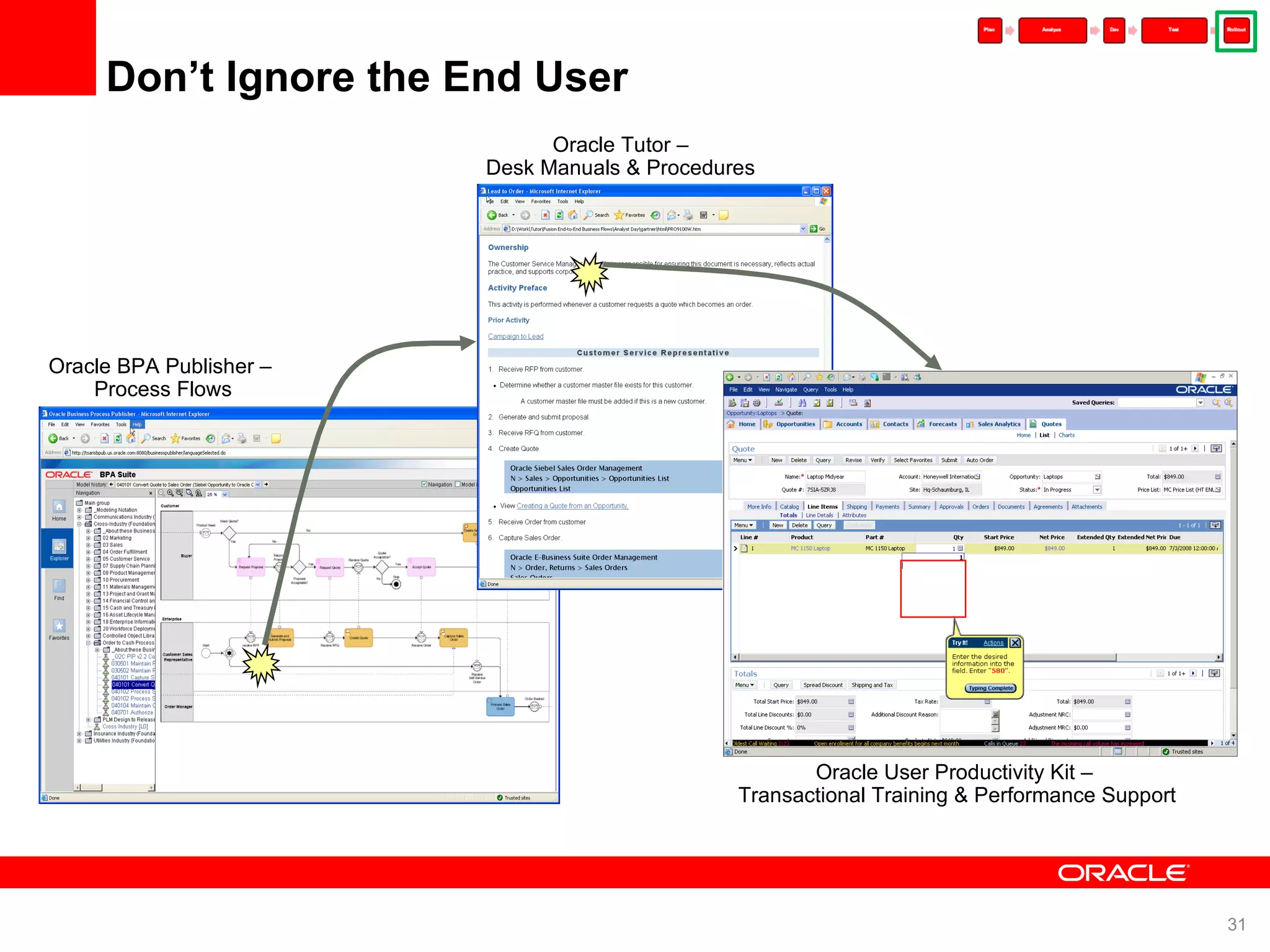

Don’t Ignore the End User Oracle BPA Publisher – Process Flows Oracle Tutor – Desk Manuals & Procedures Oracle User Productivity Kit – Transactional Training & Performance Support

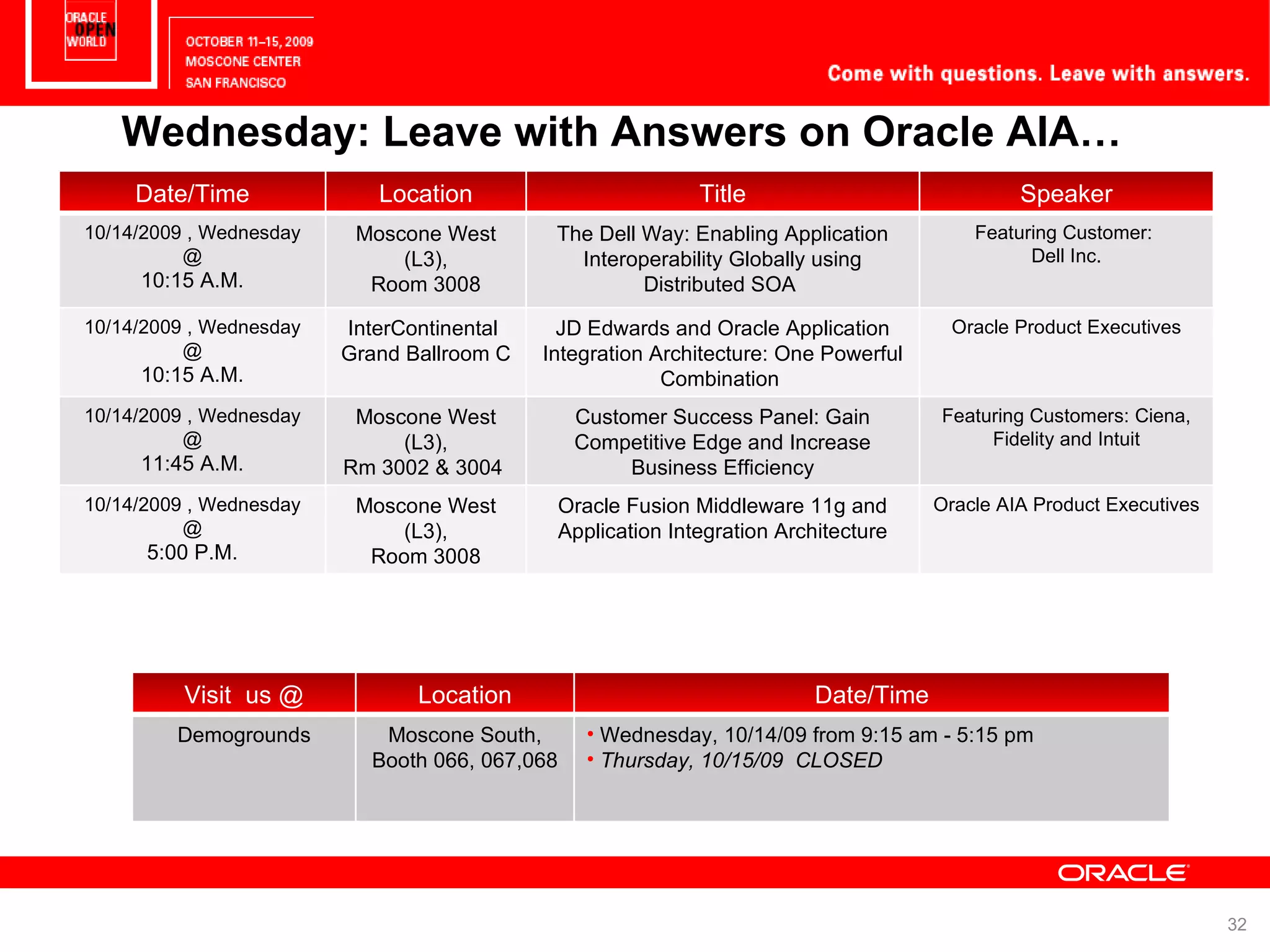

Wednesday: Leave with Answers on Oracle AIA… Date/Time Location Title Speaker 10/14/2009 , Wednesday @ 10:15 A.M. Moscone West (L3), Room 3008 The Dell Way: Enabling Application Interoperability Globally using Distributed SOA Featuring Customer: Dell Inc. 10/14/2009 , Wednesday @ 10:15 A.M. InterContinental Grand Ballroom C JD Edwards and Oracle Application Integration Architecture: One Powerful Combination Oracle Product Executives 10/14/2009 , Wednesday @ 11:45 A.M. Moscone West (L3), Rm 3002 & 3004 Customer Success Panel: Gain Competitive Edge and Increase Business Efficiency Featuring Customers: Ciena, Fidelity and Intuit 10/14/2009 , Wednesday @ 5:00 P.M. Moscone West (L3), Room 3008 Oracle Fusion Middleware 11g and Application Integration Architecture Oracle AIA Product Executives Visit us @ Location Date/Time Demogrounds Moscone South, Booth 066, 067,068 Wednesday, 10/14/09 from 9:15 am - 5:15 pm Thursday, 10/15/09 CLOSED

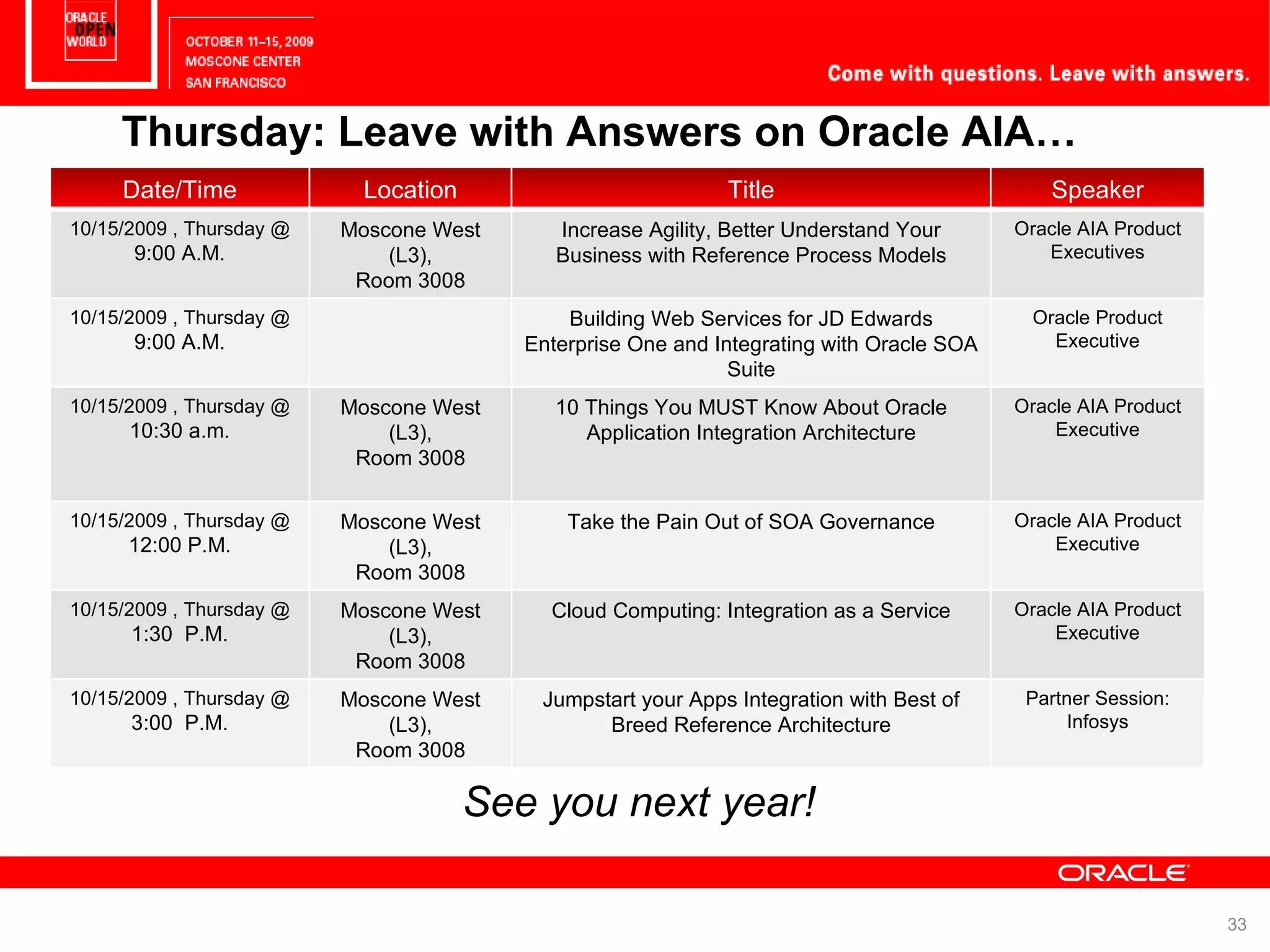

Thursday: Leave with Answers on Oracle AIA… See you next year! Date/Time Location Title Speaker 10/15/2009 , Thursday @ 9:00 A.M. Moscone West (L3), Room 3008 Increase Agility, Better Understand Your Business with Reference Process Models Oracle AIA Product Executives 10/15/2009 , Thursday @ 9:00 A.M. Building Web Services for JD Edwards Enterprise One and Integrating with Oracle SOA Suite Oracle Product Executive 10/15/2009 , Thursday @ 10:30 a.m. Moscone West (L3), Room 3008 10 Things You MUST Know About Oracle Application Integration Architecture Oracle AIA Product Executive 10/15/2009 , Thursday @ 12:00 P.M. Moscone West (L3), Room 3008 Take the Pain Out of SOA Governance Oracle AIA Product Executive 10/15/2009 , Thursday @ 1:30 P.M. Moscone West (L3), Room 3008 Cloud Computing: Integration as a Service Oracle AIA Product Executive 10/15/2009 , Thursday @ 3:00 P.M. Moscone West (L3), Room 3008 Jumpstart your Apps Integration with Best of Breed Reference Architecture Partner Session: Infosys

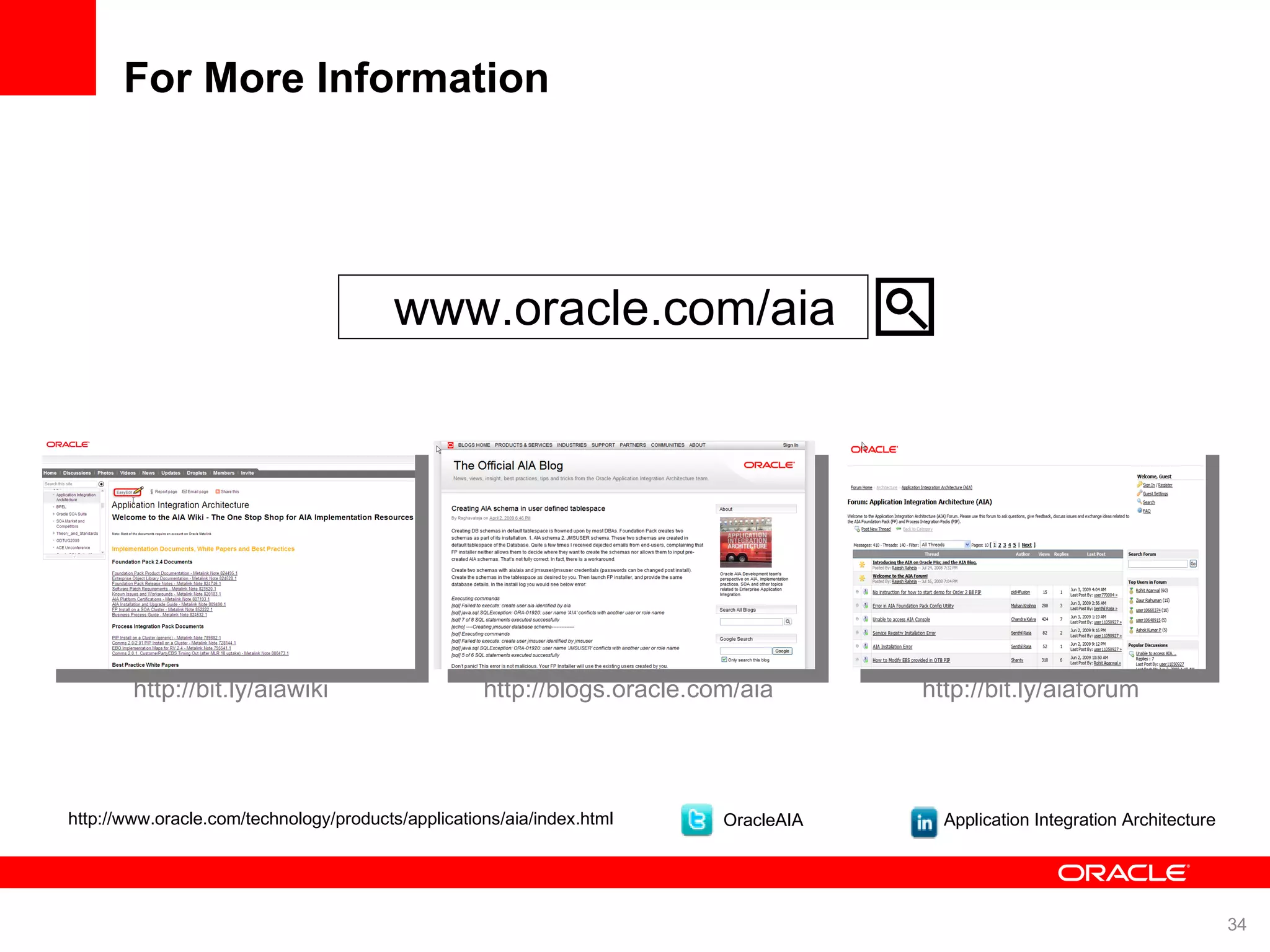

For More Information www.oracle.com/aia http://bit.ly/aiawiki http://blogs.oracle.com/aia http://bit.ly/aiaforum OracleAIA Application Integration Architecture http://www.oracle.com/technology/products/applications/aia/index.html
<Insert Picture Here> Appendix
<Insert Picture Here> Appendix Suggested SOA Reviews

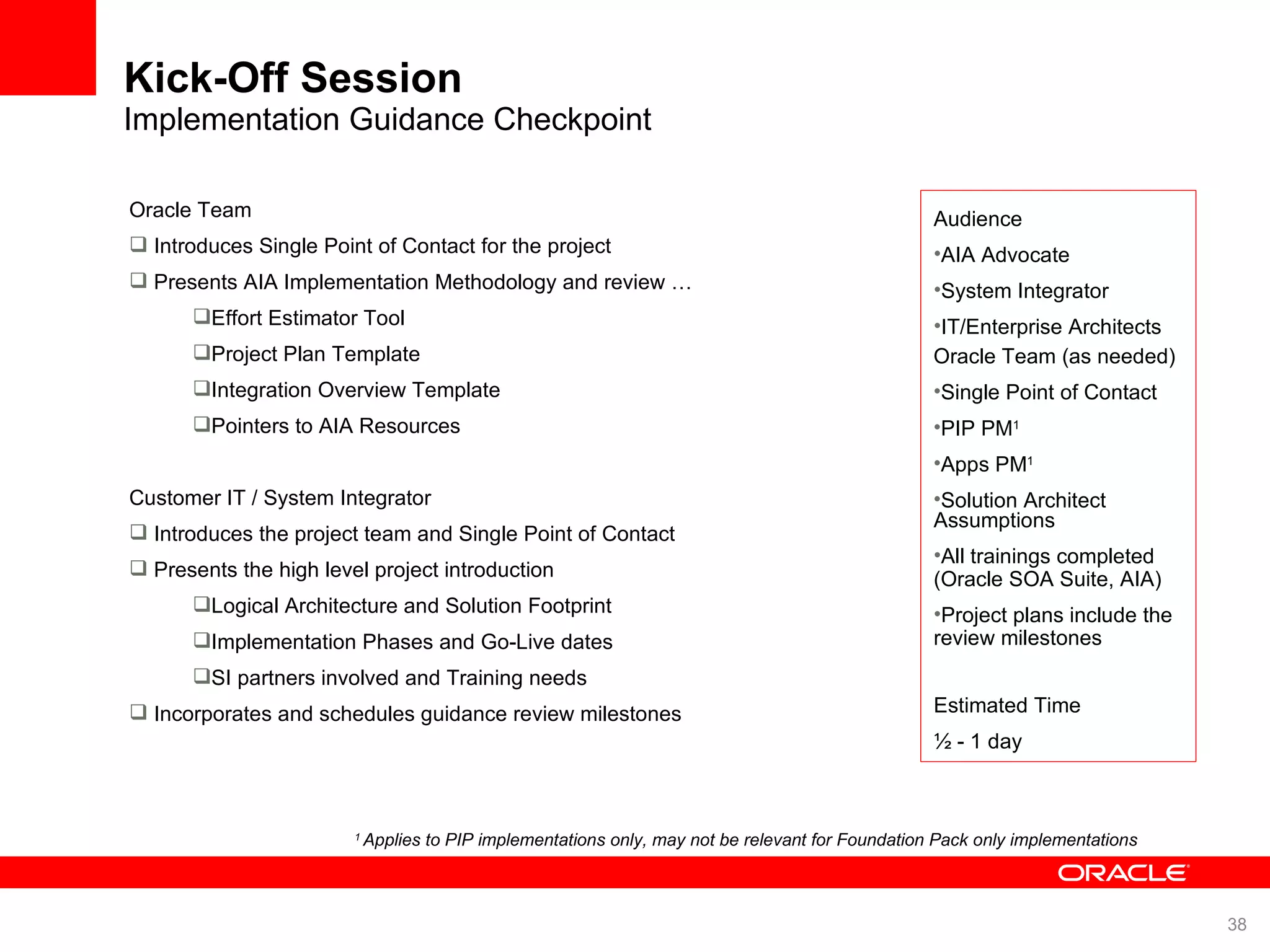

Kick-Off Session Implementation Guidance Checkpoint Oracle Team Introduces Single Point of Contact for the project Presents AIA Implementation Methodology and review … Effort Estimator Tool Project Plan Template Integration Overview Template Pointers to AIA Resources Customer IT / System Integrator Introduces the project team and Single Point of Contact Presents the high level project introduction Logical Architecture and Solution Footprint Implementation Phases and Go-Live dates SI partners involved and Training needs Incorporates and schedules guidance review milestones Estimated Time ½ - 1 day Audience AIA Advocate System Integrator IT/Enterprise Architects Assumptions All trainings completed (Oracle SOA Suite, AIA) Project plans include the review milestones Oracle Team (as needed) Single Point of Contact PIP PM 1 Apps PM 1 Solution Architect 1 Applies to PIP implementations only, may not be relevant for Foundation Pack only implementations

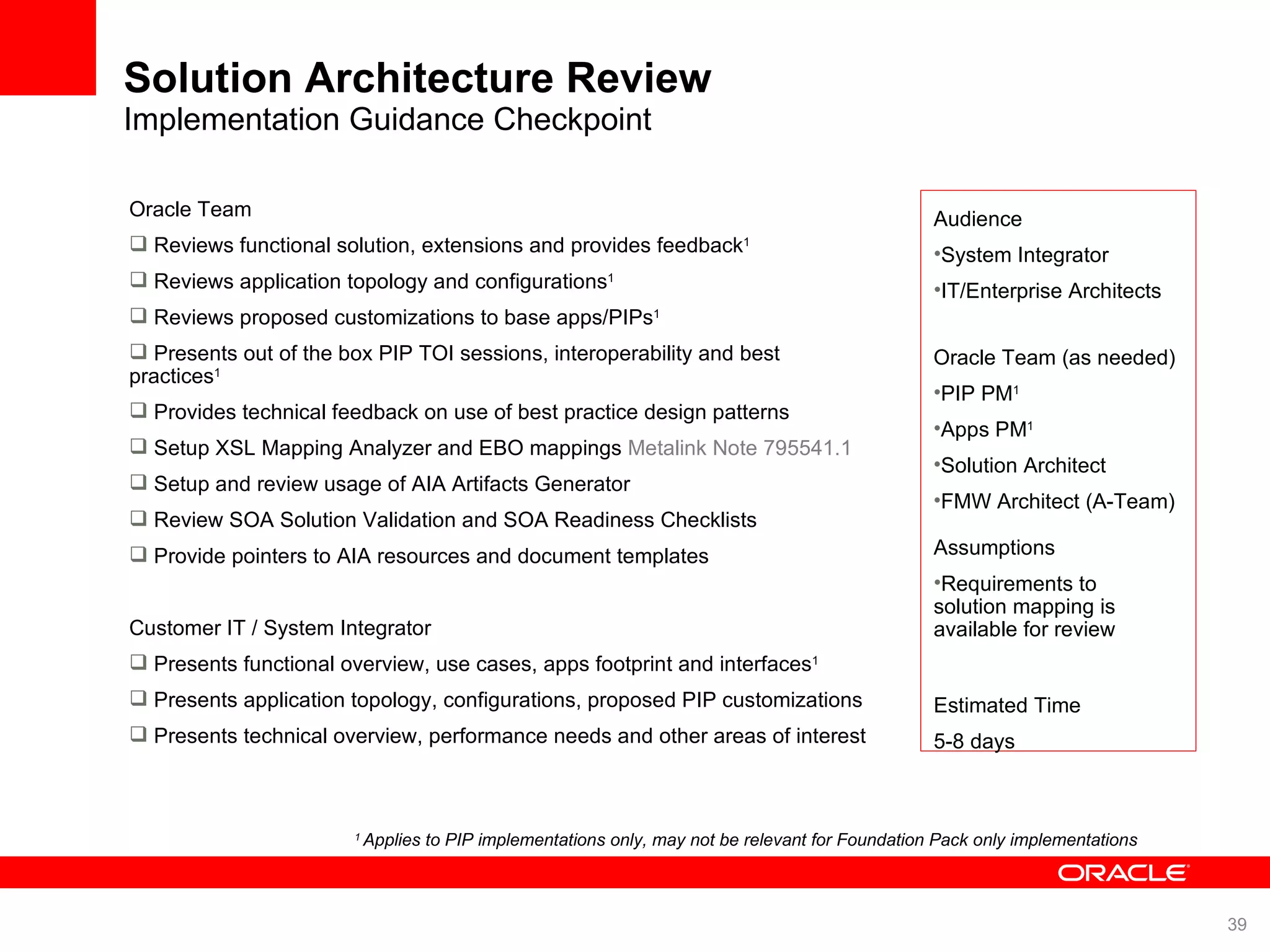

Solution Architecture Review Implementation Guidance Checkpoint Oracle Team Reviews functional solution, extensions and provides feedback 1 Reviews application topology and configurations 1 Reviews proposed customizations to base apps/PIPs 1 Presents out of the box PIP TOI sessions, interoperability and best practices 1 Provides technical feedback on use of best practice design patterns Setup XSL Mapping Analyzer and EBO mappings Metalink Note 795541.1 Setup and review usage of AIA Artifacts Generator Review SOA Solution Validation and SOA Readiness Checklists Provide pointers to AIA resources and document templates Customer IT / System Integrator Presents functional overview, use cases, apps footprint and interfaces 1 Presents application topology, configurations, proposed PIP customizations Presents technical overview, performance needs and other areas of interest Estimated Time 5-8 days Audience System Integrator IT/Enterprise Architects Assumptions Requirements to solution mapping is available for review Oracle Team (as needed) PIP PM 1 Apps PM 1 Solution Architect FMW Architect (A-Team) 1 Applies to PIP implementations only, may not be relevant for Foundation Pack only implementations

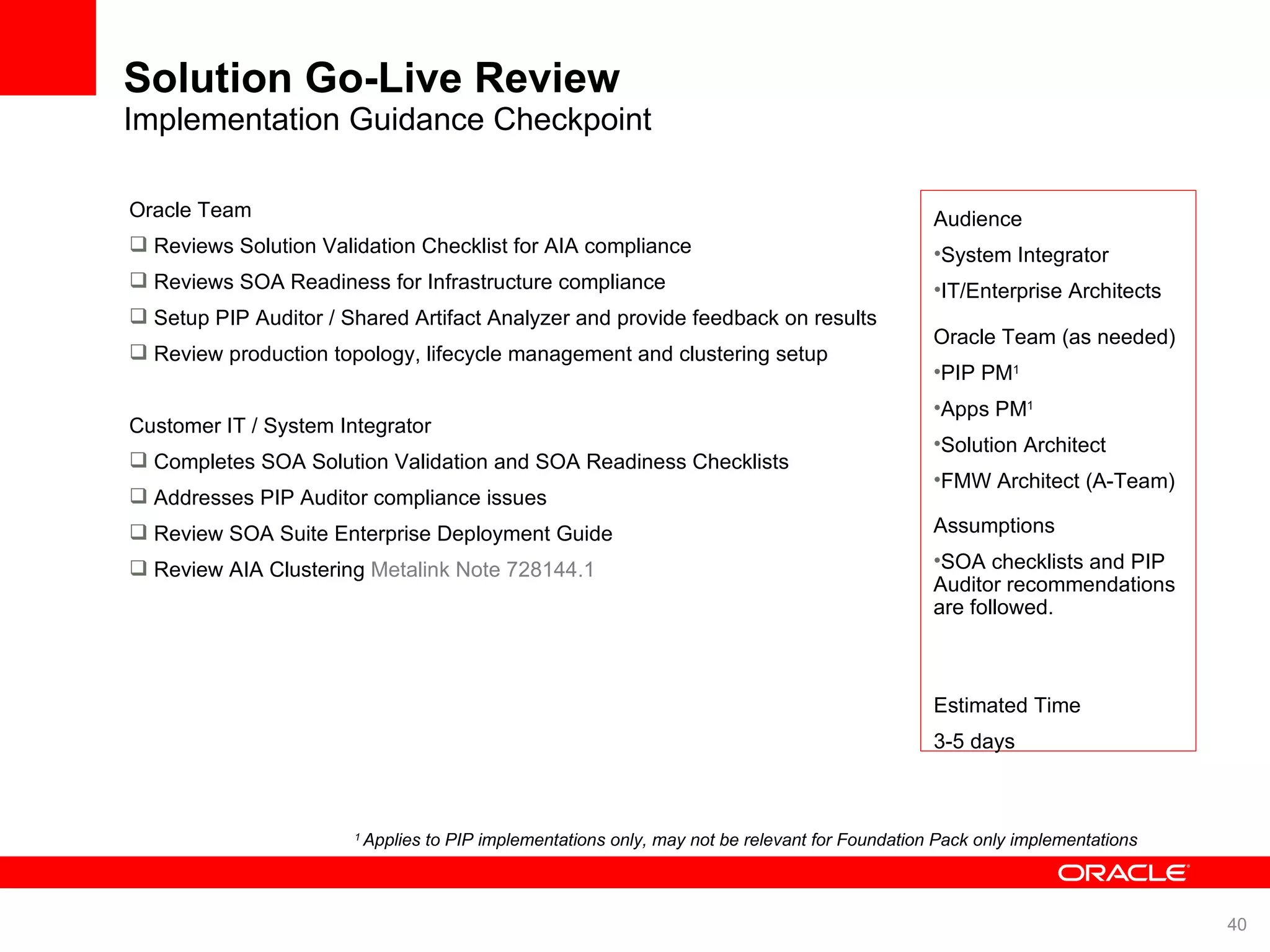

Solution Go-Live Review Implementation Guidance Checkpoint Estimated Time 3-5 days Audience System Integrator IT/Enterprise Architects Assumptions SOA checklists and PIP Auditor recommendations are followed. Oracle Team Reviews Solution Validation Checklist for AIA compliance Reviews SOA Readiness for Infrastructure compliance Setup PIP Auditor / Shared Artifact Analyzer and provide feedback on results Review production topology, lifecycle management and clustering setup Customer IT / System Integrator Completes SOA Solution Validation and SOA Readiness Checklists Addresses PIP Auditor compliance issues Review SOA Suite Enterprise Deployment Guide Review AIA Clustering Metalink Note 728144.1 Oracle Team (as needed) PIP PM 1 Apps PM 1 Solution Architect FMW Architect (A-Team) 1 Applies to PIP implementations only, may not be relevant for Foundation Pack only implementations
<Insert Picture Here> Appendix Implementation Tasks
Follow a Structured Implementation Model

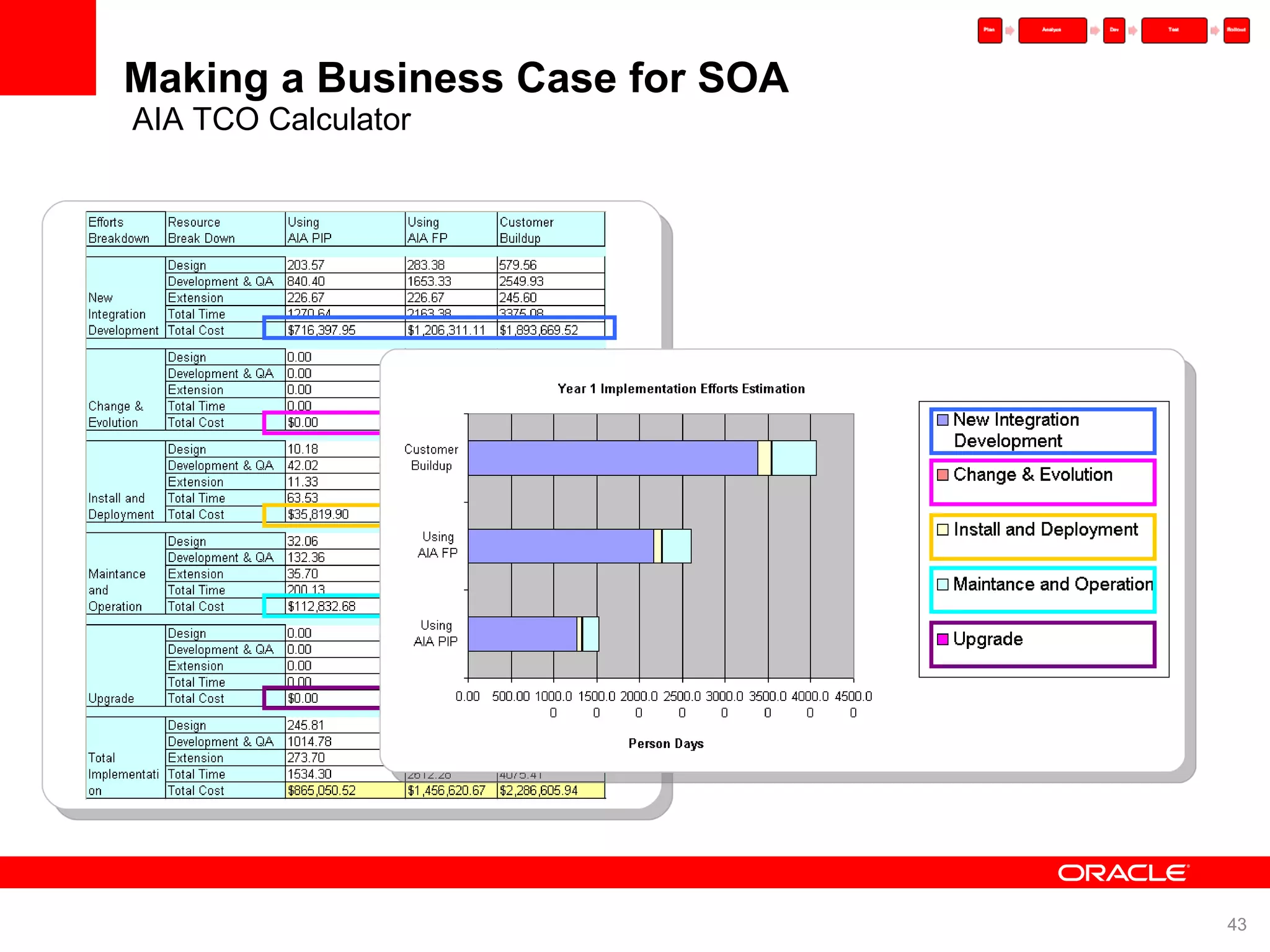

Making a Business Case for SOA AIA TCO Calculator

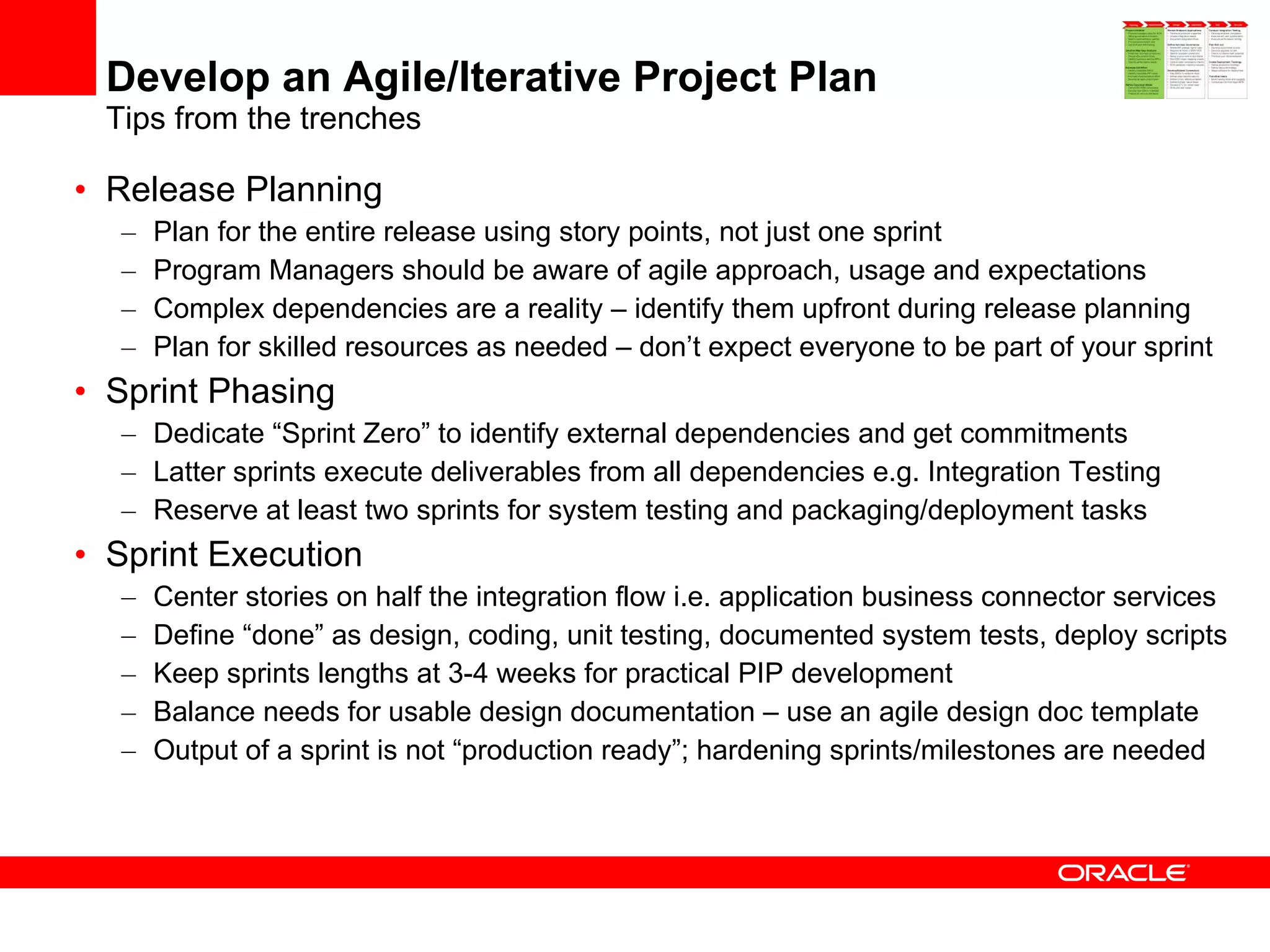

Develop an Agile/Iterative Project Plan Tips from the trenches Release Planning Plan for the entire release using story points, not just one sprint Program Managers should be aware of agile approach, usage and expectations Complex dependencies are a reality – identify them upfront during release planning Plan for skilled resources as needed – don’t expect everyone to be part of your sprint Sprint Phasing Dedicate “Sprint Zero” to identify external dependencies and get commitments Latter sprints execute deliverables from all dependencies e.g. Integration Testing Reserve at least two sprints for system testing and packaging/deployment tasks Sprint Execution Center stories on half the integration flow i.e. application business connector services Define “done” as design, coding, unit testing, documented system tests, deploy scripts Keep sprints lengths at 3-4 weeks for practical PIP development Balance needs for usable design documentation – use an agile design doc template Output of a sprint is not “production ready”; hardening sprints/milestones are needed
Identify and Analyze Gaps in Candidate EBOs Business Service Repository and XSL Mapping Analyzer Use the service repository for discovering EBOs Use EBO HTML documentation to analyze content Use mapping reports to analyze attribute fitment

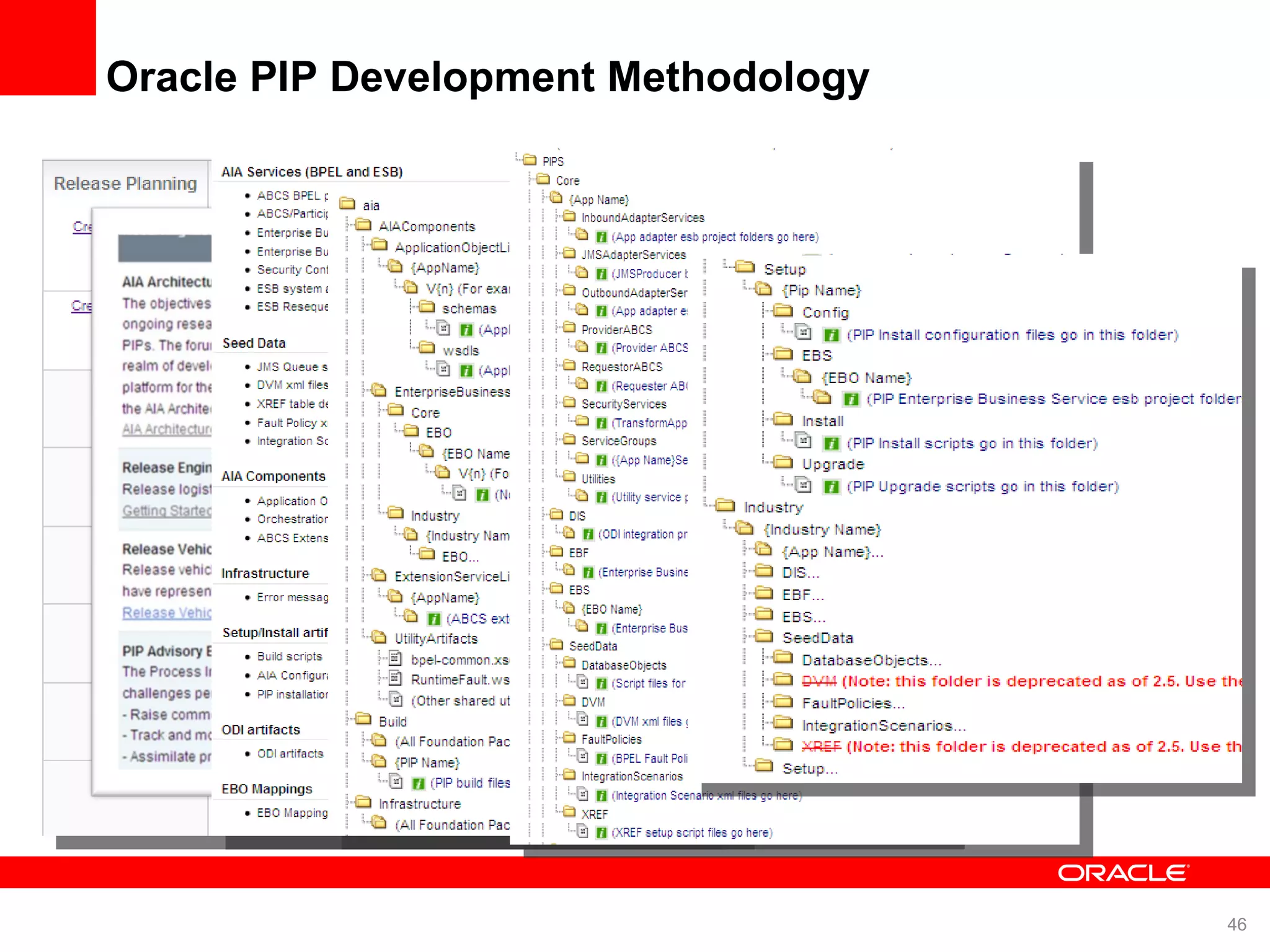

Oracle PIP Development Methodology
Ensure API Level Governance Durable across integrations and releases Backward compatible – deprecate and version enable Right level of service granularity Transaction enabled; uses Adapter services if needed Conforms to XSD standards; provides WSDL interfaces

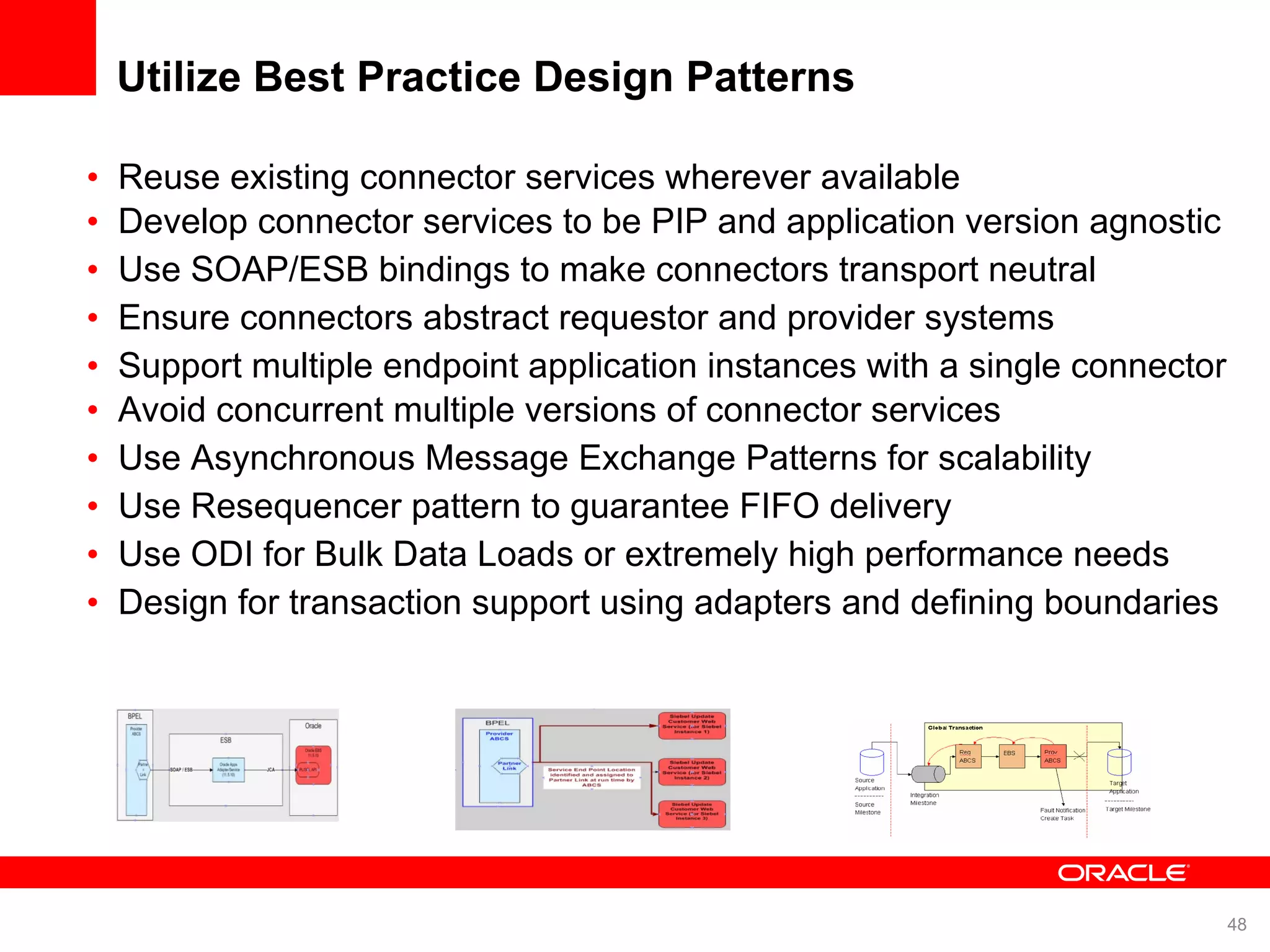

Utilize Best Practice Design Patterns Reuse existing connector services wherever available Develop connector services to be PIP and application version agnostic Use SOAP/ESB bindings to make connectors transport neutral Ensure connectors abstract requestor and provider systems Support multiple endpoint application instances with a single connector Avoid concurrent multiple versions of connector services Use Asynchronous Message Exchange Patterns for scalability Use Resequencer pattern to guarantee FIFO delivery Use ODI for Bulk Data Loads or extremely high performance needs Design for transaction support using adapters and defining boundaries

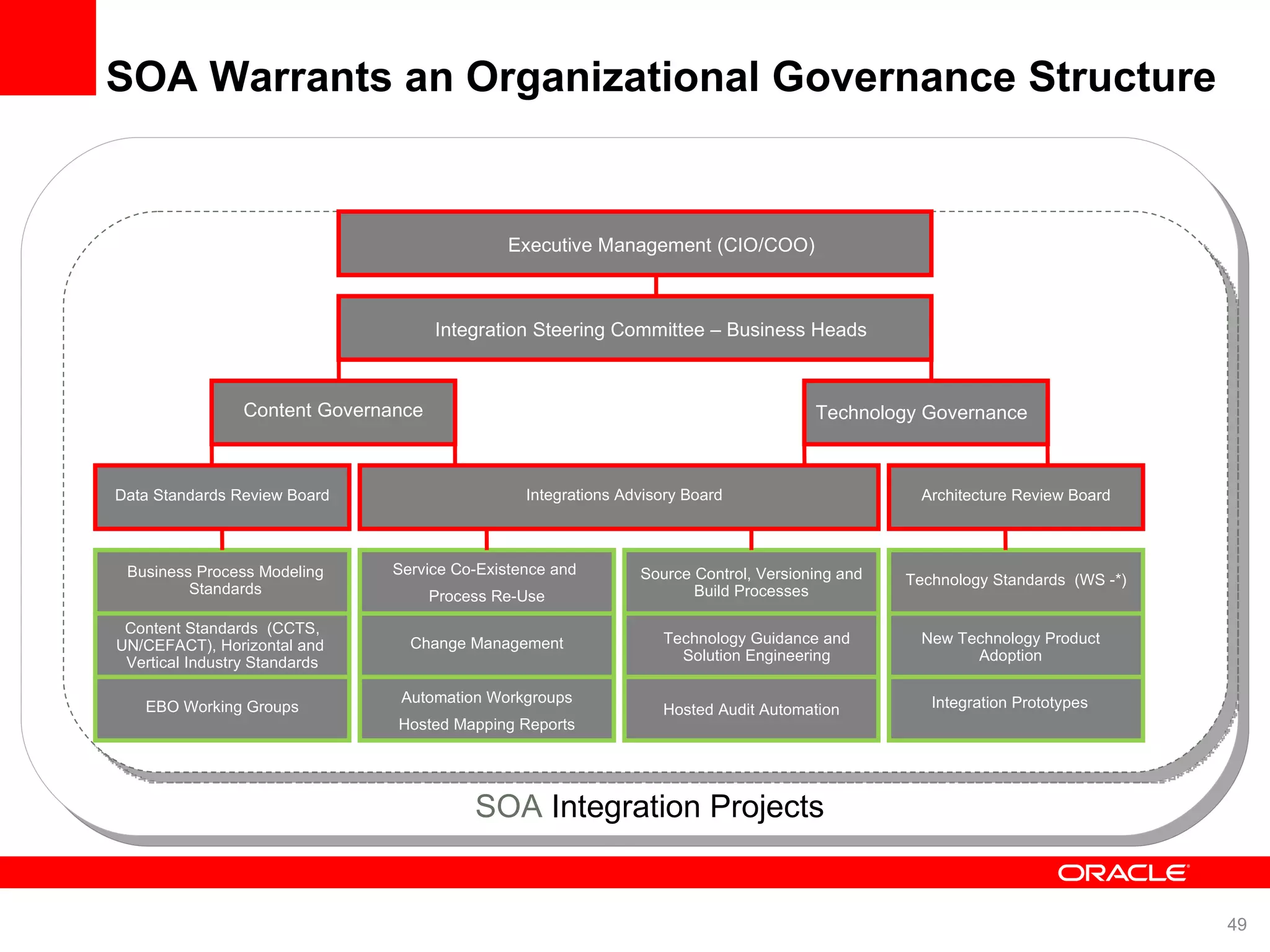

SOA Warrants an Organizational Governance Structure SOA Integration Projects Executive Management (CIO/COO) ‏ Integration Steering Committee – Business Heads Technology Governance Content Governance Data Standards Review Board Solution Engineering Architecture Review Board Content Standards (CCTS, UN/CEFACT), Horizontal and Vertical Industry Standards Business Process Modeling Standards EBO Working Groups Source Control, Versioning and Build Processes Technology Standards (WS -*) New Technology Product Adoption Integration Prototypes Integrations Advisory Board Service Co-Existence and Process Re-Use Change Management Automation Workgroups Hosted Mapping Reports Hosted Audit Automation Technology Guidance and Solution Engineering
<Insert Picture Here> Appendix Content Governance Example Service Interoperability

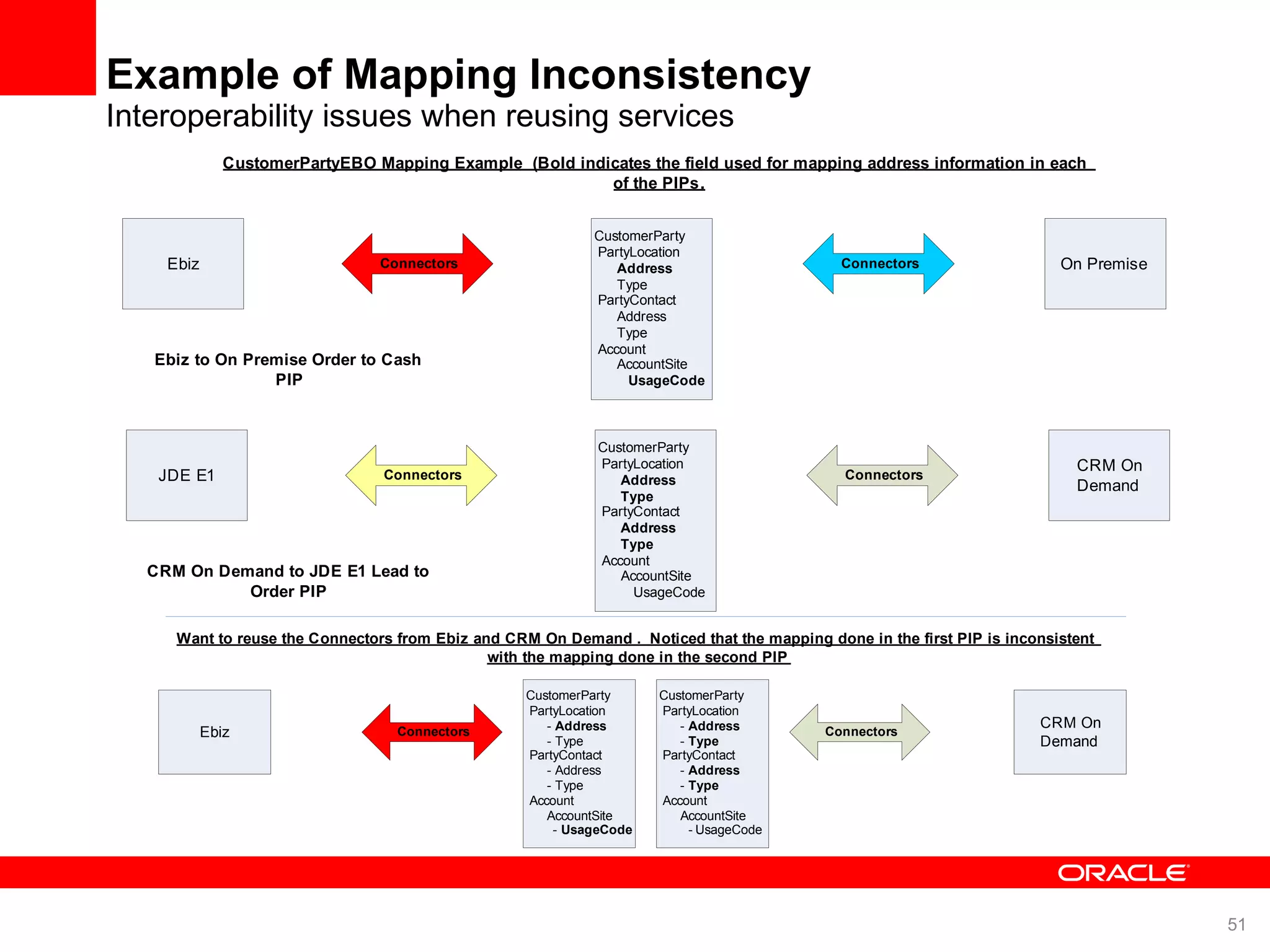

Example of Mapping Inconsistency Interoperability issues when reusing services

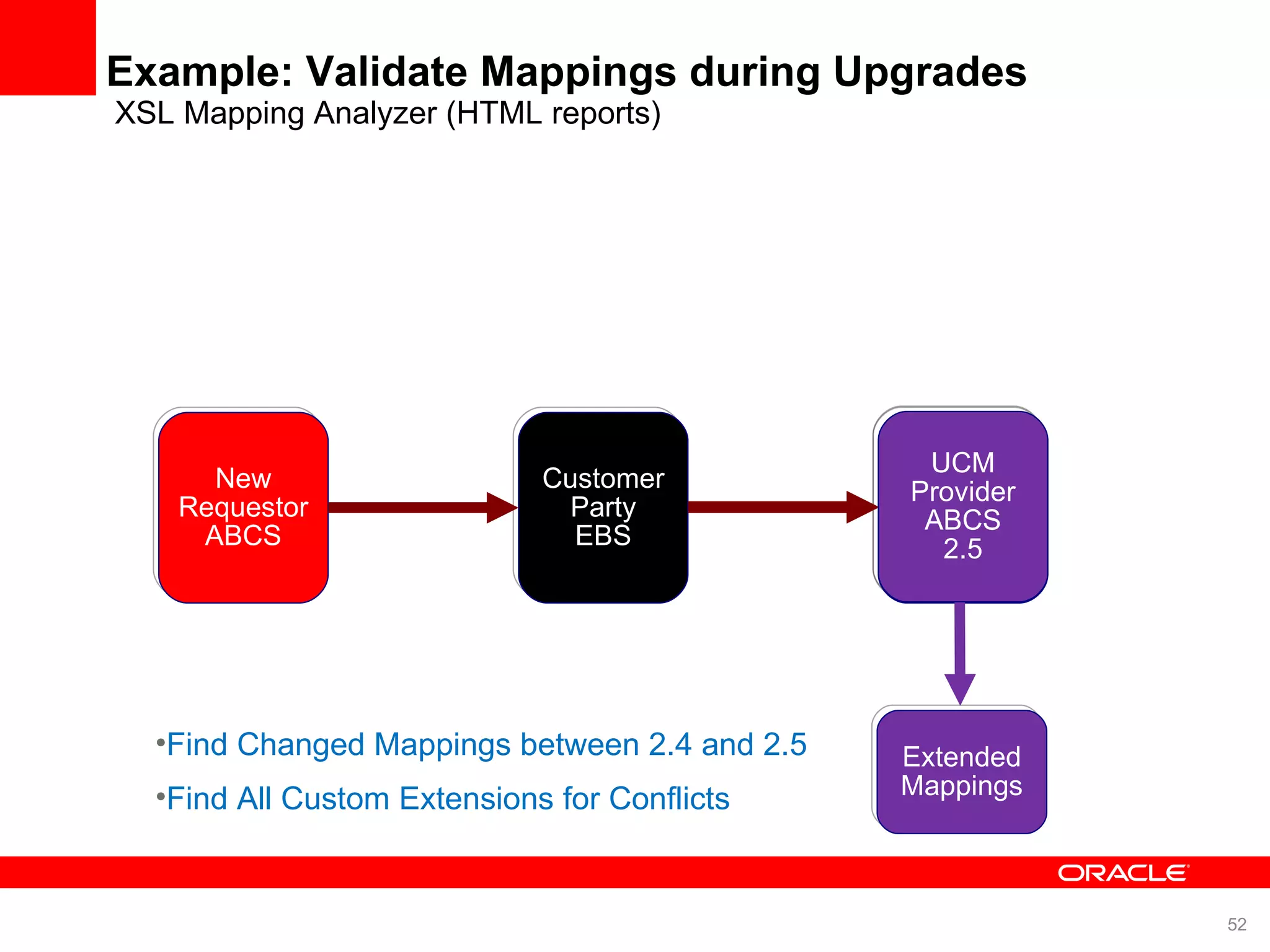

Example: Validate Mappings during Upgrades XSL Mapping Analyzer (HTML reports) Find Changed Mappings between 2.4 and 2.5 Find All Custom Extensions for Conflicts Customer Party EBS New Requestor ABCS Extended Mappings UCM Provider ABCS 2.4 UCM Provider ABCS 2.5

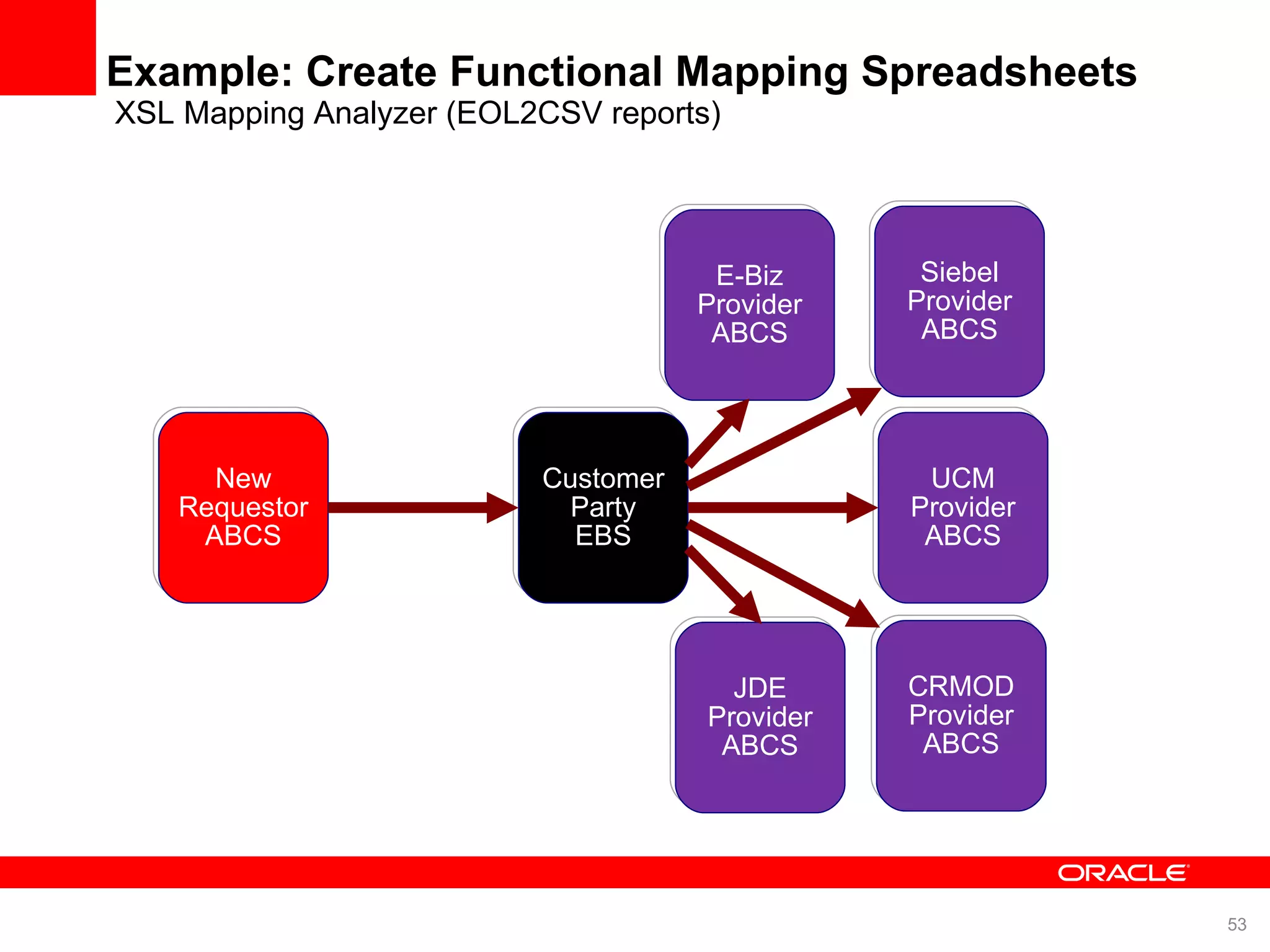

Example: Create Functional Mapping Spreadsheets XSL Mapping Analyzer (EOL2CSV reports) UCM Provider ABCS Customer Party EBS CRMOD Provider ABCS Siebel Provider ABCS E-Biz Provider ABCS JDE Provider ABCS New Requestor ABCS
<Insert Picture Here> Appendix OOW AIA Sessions
Monday: Leave with Answers on Oracle AIA… Date/Time Location Title Speaker 10/ 12/2009 , Monday @ 11:30 a.m. Moscone West (L3), Room 3008 Insights from the Trenches: Partners Speak Out On Delivering Real Value Partner Panel: IBM Global Services, Deloitte Consulting, Infosys, Tech Mahindra 10/ 12/2009 , Monday @ 1:00 p.m. Moscone West (L3), Room 3008 Ready to Go, Pre-built Business Process Based Integrations to SAP! Partner: Infosys 10/ 12/2009 , Monday @ 2:30 p.m. Moscone West (L3), Room 3008 Strategic Development Partnerships Delivering Superior Value Partner Panel: Wipro Technologies, HCL Technologies, L&T Infotech, Accenture 10/ 12/2009 , Monday @ 4:00 P.M. Moscone West (L3), Room 3010 & 3012 KEYNOTE: Smart Strategies: Prepare For Tomorrow, Leverage what you Have Today Jose Lazares, Oracle V.P. Customers: Adrian Dilworth, CIO, Vodafone Qatar; V.K. Rajaram, Vice President, Intuit Visit us @ Location Date/Time Demogrounds Moscone South, Booth 066, 067,068 Monday, 10/12/09 from 10:30 am - 6:30 pm Tuesday, 10/13/09 from 10:30 am - 6:30 pm Wednesday, 10/14/09 from 9:15 am - 5:15 pm Thursday, 10/15/09 CLOSED Apps Lounge – Meet the Experts Moscone West 2 nd Floor Lobby Monday, 10/12/09 @ 02:00 P.M. – 3:00 P.M. Tuesday, 10/13/09@ 10:00 AM – 11:00 A.M.

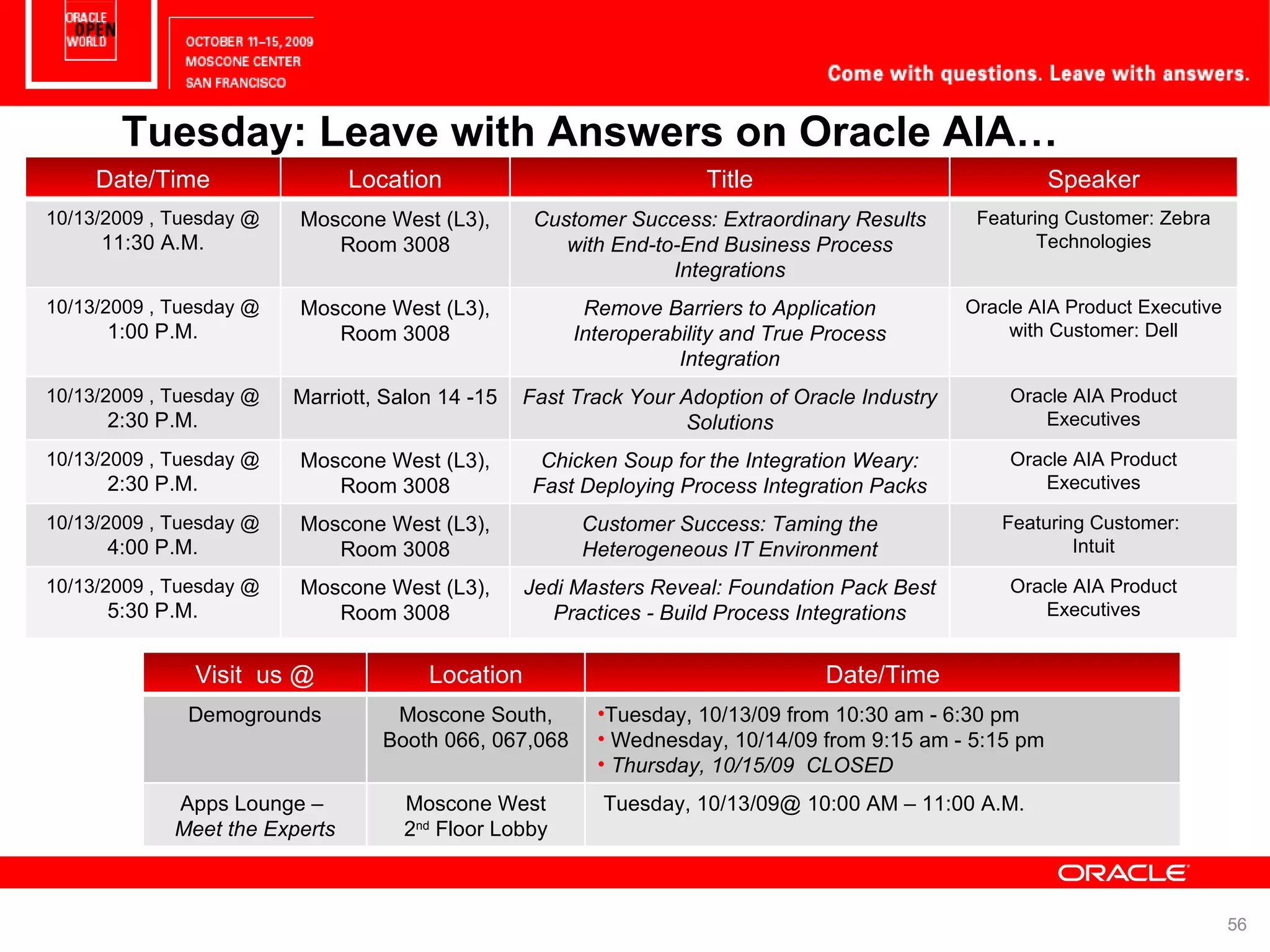

Tuesday: Leave with Answers on Oracle AIA… Date/Time Location Title Speaker 10/13/2009 , Tuesday @ 11:30 A.M. Moscone West (L3), Room 3008 Customer Success: Extraordinary Results with End-to-End Business Process Integrations Featuring Customer: Zebra Technologies 10/13/2009 , Tuesday @ 1:00 P.M. Moscone West (L3), Room 3008 Remove Barriers to Application Interoperability and True Process Integration Oracle AIA Product Executive with Customer: Dell 10/13/2009 , Tuesday @ 2:30 P.M. Marriott, Salon 14 -15 Fast Track Your Adoption of Oracle Industry Solutions Oracle AIA Product Executives 10/13/2009 , Tuesday @ 2:30 P.M. Moscone West (L3), Room 3008 Chicken Soup for the Integration Weary: Fast Deploying Process Integration Packs Oracle AIA Product Executives 10/13/2009 , Tuesday @ 4:00 P.M. Moscone West (L3), Room 3008 Customer Success: Taming the Heterogeneous IT Environment Featuring Customer: Intuit 10/13/2009 , Tuesday @ 5:30 P.M. Moscone West (L3), Room 3008 Jedi Masters Reveal: Foundation Pack Best Practices - Build Process Integrations Oracle AIA Product Executives Visit us @ Location Date/Time Demogrounds Moscone South, Booth 066, 067,068 Tuesday, 10/13/09 from 10:30 am - 6:30 pm Wednesday, 10/14/09 from 9:15 am - 5:15 pm Thursday, 10/15/09 CLOSED Apps Lounge – Meet the Experts Moscone West 2 nd Floor Lobby Tuesday, 10/13/09@ 10:00 AM – 11:00 A.M.

Oracle OpenWorld 2009 AIA Best Practices

  • 1.
  • 2.
  • 3.
    Jedi Masters Reveal: Foundation Pack Best Practices Building Process Integrations Rajesh Raheja Senior Director, AIA Development October 13, 2009 Ivan Lazarov Director, AIA Product Management
  • 4.
    The following isintended to outline our general product direction. It is intended for information purposes only, and may not be incorporated into any contract. It is not a commitment to deliver any material, code, or functionality, and should not be relied upon in making purchasing decisions. The development, release, and timing of any features or functionality described for Oracle’s products remains at the sole discretion of Oracle.
  • 5.
    AIA Foundation Pack:Accelerates Time to Value Best Practice Process, Shared Services, Design Patterns, Standards Oracle Database- 10G, EM, CAMM WebLogic Suite- OC4J Oracle SOA Suite- BPEL, ESB, OSB, ODI Oracle WebCenter Suite / ADF 11g Application Connectors Predefined Application Integration Content that works with Oracle Fusion Middleware to speed the development of loosely-coupled process integrations. Core Components: Reference Process Models: User based activity and task flows Standardized Business Objects / Services: Common vocabulary, reusable Services, Fusion Applications compatible Programming Models and Methodology: Same approach used by Oracle Development, supports both web service, batch and UI Integration Governance: Service Repository, Error Handling, Automation Utilities, XSL Mapping Analyzer Developer Utility Tools: Artifact Generator,, PIP Auditor, Build Tokenizer SAP AIA Foundation Pack Canonical Layer (EBO/EBS) Pre-Defined Reference Patterns Integration Architecture FMW Methodology Integration Governance Tools Developer Utilities… Custom ERP/ CRM Oracle Industry Apps & MDM
  • 6.

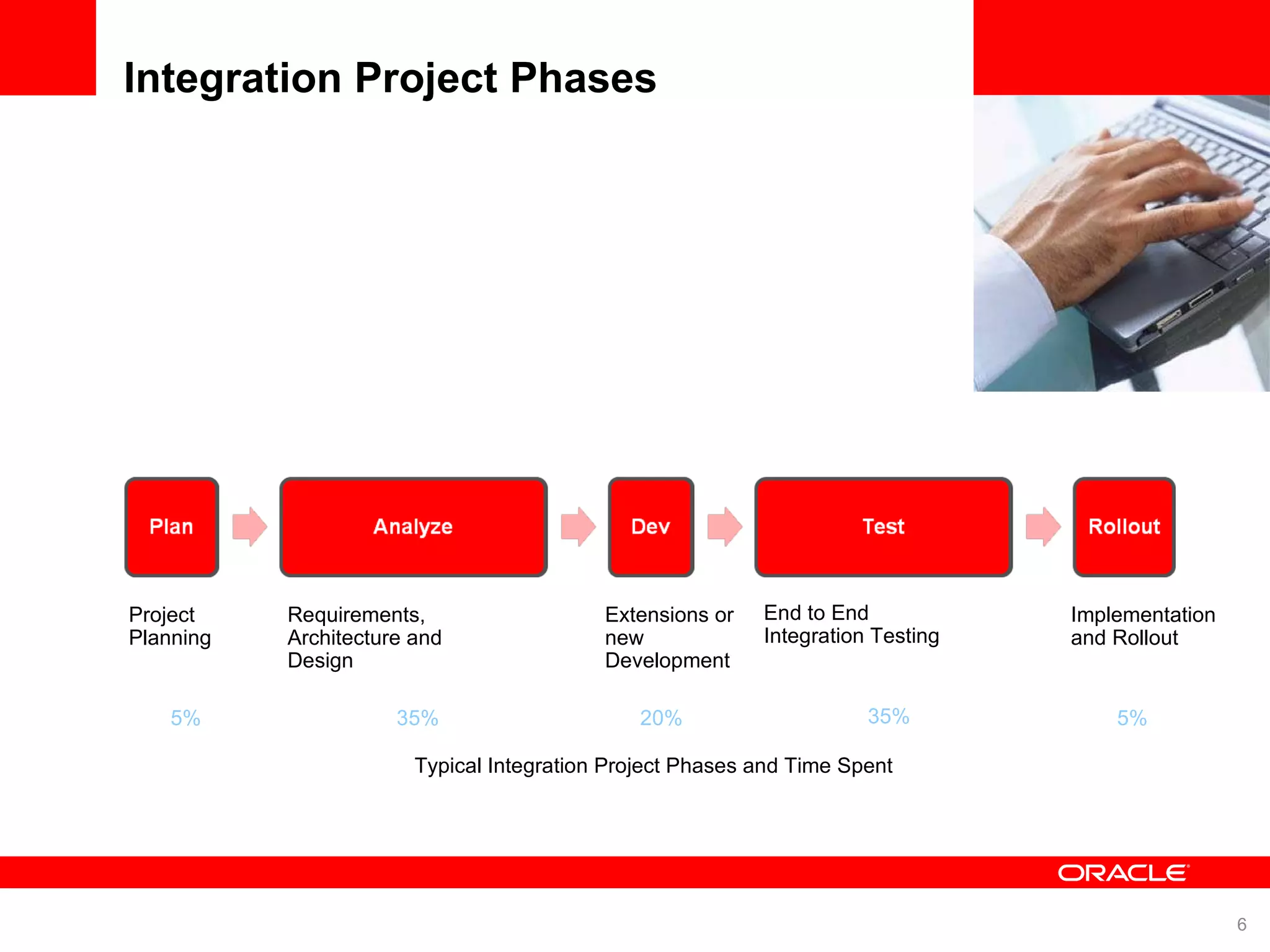

    Integration Project Phases<Insert Picture Here> Project Planning Requirements, Architecture and Design Extensions or new Development End to End Integration Testing Implementation and Rollout 5% 35% 20% 35% 5% Typical Integration Project Phases and Time Spent
  • 7.
    Improve Visibility andDeliver Incremental Value with Agile Planning Tips from the trenches Plan the entire project release Optimize use of skilled resources Commit to dependencies upfront Story = working integration flow Keep documentation lean Plan integration testing sprints Adopt continuous integration
  • 8.
    Certain In-house SOASkills are a Must Have Critical Roles and Skills Enterprise Solution Architect SOA Integration Architect SOA Developer How do you get these Harness existing architects AIA training, documentation, sites Conference Room Pilots Lack of SOA related skills sets was cited as one of the top inhibitors for SOA adoption Source: Software AG, Best Practices for SOA Governance User Survey, Summer 2008 CONSULTING Global Business Services Sample AIA Partner Ecosystem
  • 9.
    Follow a ProvenImplementation Model
  • 10.
    Plan for theImplementation Effort AIA Estimator Spreadsheet Define integration flows (source  target) Identify candidate EBOs and gaps (use BSR, EOL, XMAN) Enter integration flow details and use results in context of overall plan Siebel UI (new/updated Billing Mgmt screens) CustomerPartyEBS (Requestor ABCSs) CRM AIA BRM (Provider ABCSs) GetAccountBalanceSiebelABCS QueryCustomerListPortal ProvImplABCS BRM Web Service (JCA Adapter) BRM API (Opcode)
  • 11.
    Consider Solution Impactwhen Mapping Requirements
  • 12.
    Register Integration Flowsfor Service Discovery Business Service Repository (OER in AIA 3.0) “ You can’t manage what you can’t see.” --- Forrester Research 1 2 3 4 5 Siebel UI (new/updated Billing Mgmt screens) CustomerPartyEBS (Requestor ABCSs) CRM AIA BRM (Provider ABCSs) GetAccountBalanceSiebelABCS QueryCustomerListPortal ProvImplABCS BRM Web Service (JCA Adapter) BRM API (Opcode)
  • 13.
    Repository alone isinsufficient for SOA governance Source: Software AG, Best Practices for SOA Governance User Survey, Summer 2008 Key Learning: SOA Governance should be… Engrained in the SDLC, not just confined to the “architects club” Automated and productive for developers to use everyday Focused on service interoperability in addition to discovery
  • 14.
    Use Case: ResearchService Interoperability UCM Provider ABCS Customer Party EBS UCM Provider Service: SyncCustomerPartyListUCMProvABCSImpl Transformation: XfromUCMPersonToSyncCustomerPartyListResponse.xsl New Requestor ABCS
  • 15.
    Solution: Research ServiceInteroperability XSL Mapping Analyzer (XMAN) HTML Report English Translation: Currency Code maps to Person’s Income or Organization’s Account. Lookup values are stored in the CURRENCY_CODE table.
  • 16.
    Use Case: ValidateService Interoperability for Reuse Customer Party EBS CRMOD ABCS Siebel ABCS E-Biz ABCS JDE ABCS AccountSite/UsageCode PartyLocation/Type “ Address Usage” Attribute Mapping, XREF and DVM Inconsistency
  • 17.

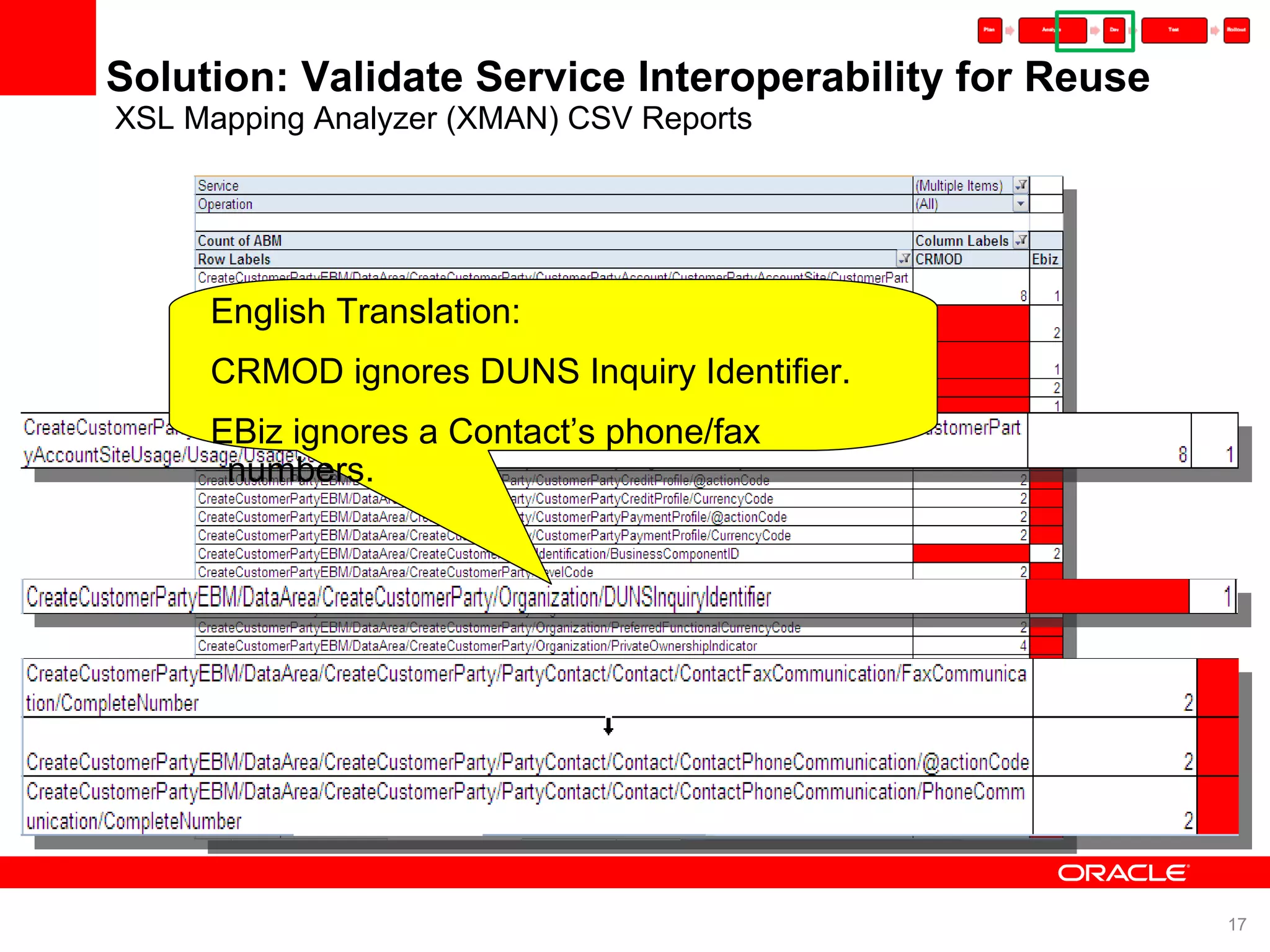

    Solution: Validate ServiceInteroperability for Reuse XSL Mapping Analyzer (XMAN) CSV Reports English Translation: CRMOD ignores DUNS Inquiry Identifier. EBiz ignores a Contact’s phone/fax numbers.
  • 18.
    Solution: Validate ServiceInteroperability for Reuse XSL Mapping Analyzer (XMAN) CSV Reports English Translation: CRMOD ignores Accounts (uses Party). Only BRM and Siebel care about Billing Profile.
  • 19.
    Follow the AIAProgramming Model for Services AIA Integration Developers Guide
  • 20.
    Ensure Adherence toArchitecture Standards SOA Validation Checklists (Architecture and SOA Component Level)
  • 21.

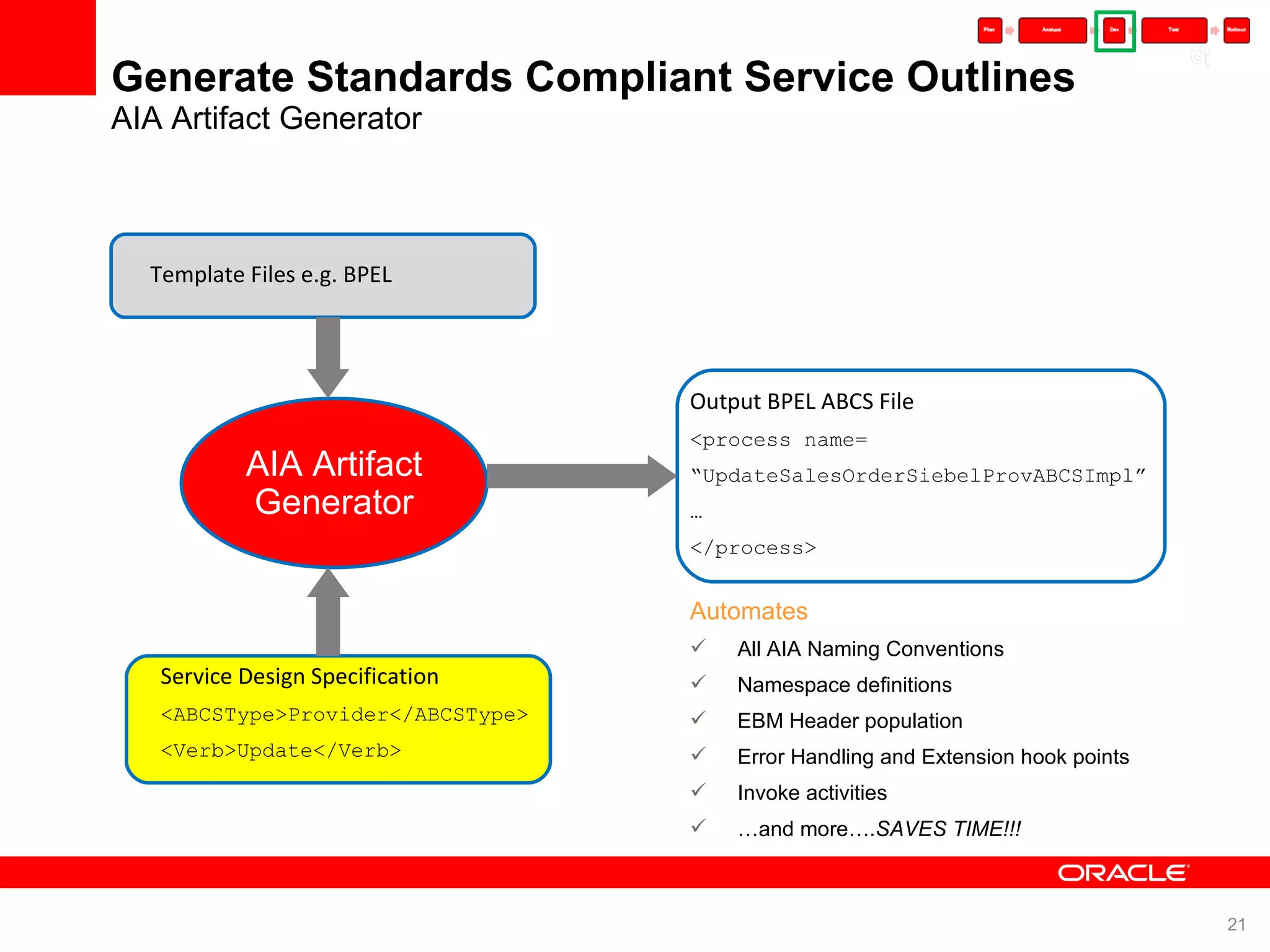

    Generate Standards CompliantService Outlines AIA Artifact Generator AIA Artifact Generator Template Files e.g. BPEL Output BPEL ABCS File <process name= “ UpdateSalesOrderSiebelProvABCSImpl” … </process> Service Design Specification <ABCSType>Provider</ABCSType> <Verb>Update</Verb> Automates All AIA Naming Conventions Namespace definitions EBM Header population Error Handling and Extension hook points Invoke activities … and more…. SAVES TIME!!!
  • 22.
    Ensure Adherence toAIA Standards PIP Auditor with Extensible, Categorized and Prioritized Test Cases
  • 23.

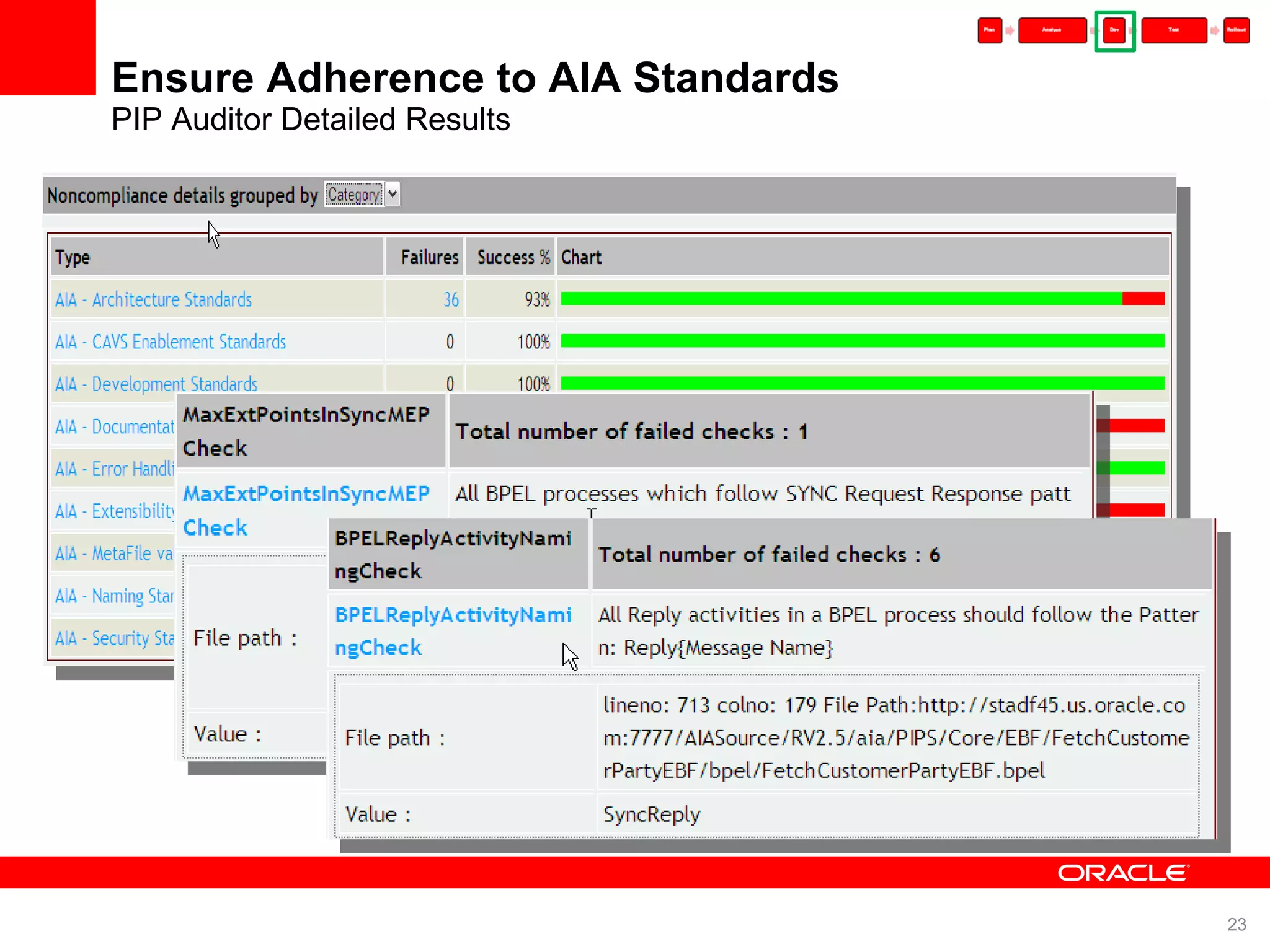

    Ensure Adherence toAIA Standards PIP Auditor Detailed Results
  • 24.

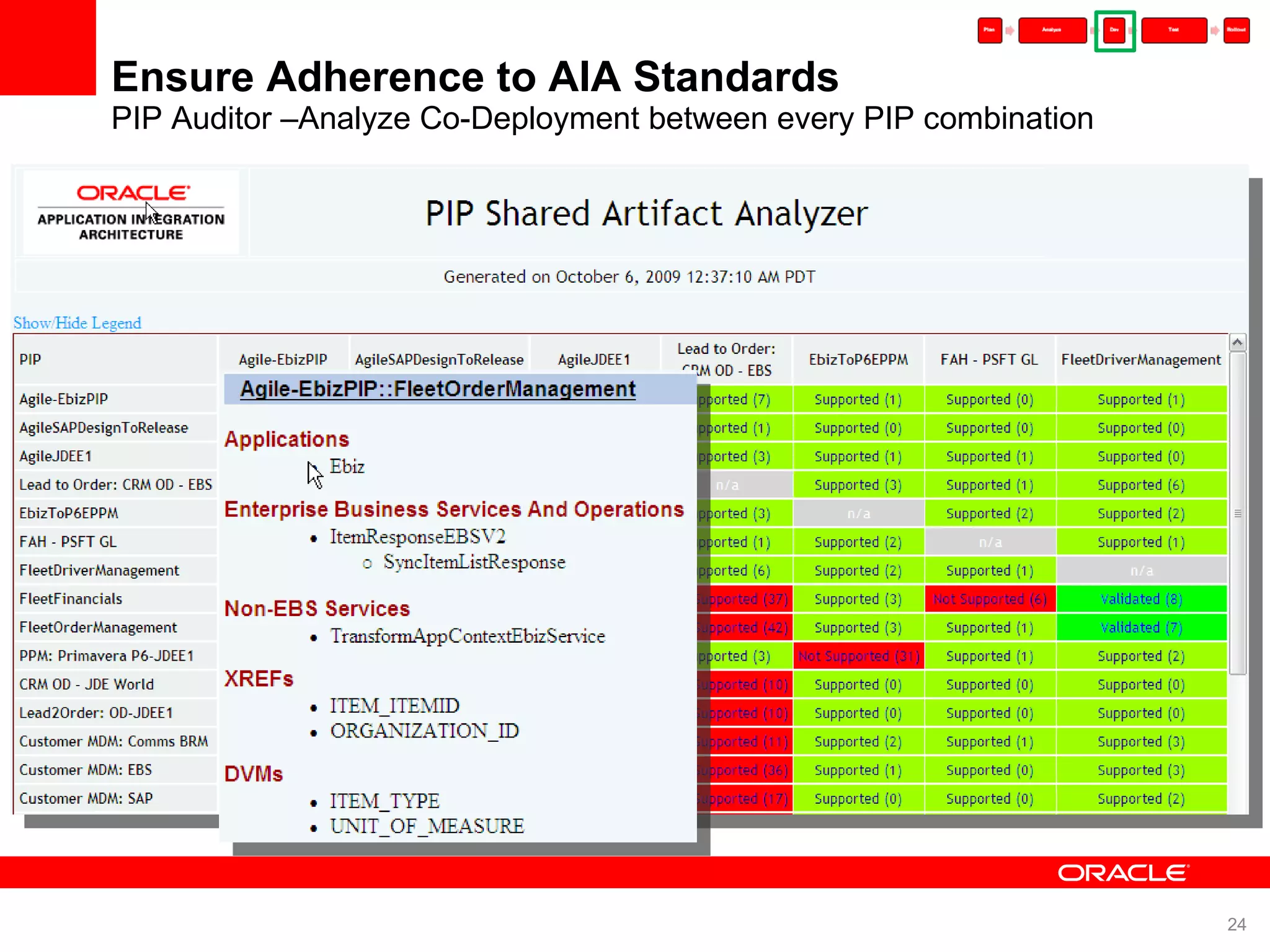

    Ensure Adherence toAIA Standards PIP Auditor –Analyze Co-Deployment between every PIP combination
  • 25.
    Ensure Adherence toAIA Standards Implementation Governance with Continuous Integration Builds
  • 26.
    Oracle PIP DevelopmentGovernance Structure AIA Foundation Pack and Process Integration Pack Projects Oracle Executive Management (Apps Unlimited, Fusion Apps) ‏ Integration Steering Committee Technology Governance Content Governance EBO Steering Committee Solution Engineering Architecture Steering Committee PIP Advisory Board Content Standards (CCTS, UN/CEFACT), Horizontal and Vertical Industry Standards Business Process Modeling Standards EBO Working Groups Service Co-Existence and Process Re-Use Change Management Automation Workgroups Technology Standards (WS -*) New Technology Product Adoption Integration Prototypes Source Control, Versioning and Build Processes Hosted Mapping Reports Hosted Audit Automation Solution Engineering Tools and Utilities Customer and Internal Implementation Guidance
  • 27.
    Summary of ImplementationGovernance Key Learning Service Interoperability is key to SOA Governance Governance needs productive tools SOA warrants an organizational governance structure
  • 28.
    Define Lifecycle StrategyBuild, Install, Apps Setup, Data Setup, Tuning Development Stage Source control and label custom/extended artifacts Write custom build, deploy and PIP manifest scripts Setup Apps seed data, configuration and export Build Stage Install AIA using “Files Only” option to lay down code Run custom build script and URL tokenizer Zip up entire AIA_HOME and create SOA env clone Deploy Stage Unzip AIA_HOME on production SOA (or clone) Run all deploy scripts – OOTB and custom Import Apps seed data and configuration
  • 29.
    Define Production TopologySOA Suite High Availability – Clustering References SOA Suite High Availability Docs http://www.oracle.com/technology/tech/soa/ha/index.html AIA on SOA Suite Cluster Doc Metalink Note 728144.1
  • 30.
    Write Integration TestCases and Simulators Composite Application Validation System (CAVS) Testing Tips Automate regression tests of all integration points Validate optional attributes in service payload Test business exceptions as well as system faults Provider Participating Application Provider Participating Application Provider ABC Service Provider ABC Service Provider ABC Service Requester Participating Application Enterprise Business Service Requester ABC Service Test Definition Simulator Requester Participating Application Enterprise Business Service Requester ABC Service
  • 31.
    Don’t Ignore theEnd User Oracle BPA Publisher – Process Flows Oracle Tutor – Desk Manuals & Procedures Oracle User Productivity Kit – Transactional Training & Performance Support
  • 32.
    Wednesday: Leave withAnswers on Oracle AIA… Date/Time Location Title Speaker 10/14/2009 , Wednesday @ 10:15 A.M. Moscone West (L3), Room 3008 The Dell Way: Enabling Application Interoperability Globally using Distributed SOA Featuring Customer: Dell Inc. 10/14/2009 , Wednesday @ 10:15 A.M. InterContinental Grand Ballroom C JD Edwards and Oracle Application Integration Architecture: One Powerful Combination Oracle Product Executives 10/14/2009 , Wednesday @ 11:45 A.M. Moscone West (L3), Rm 3002 & 3004 Customer Success Panel: Gain Competitive Edge and Increase Business Efficiency Featuring Customers: Ciena, Fidelity and Intuit 10/14/2009 , Wednesday @ 5:00 P.M. Moscone West (L3), Room 3008 Oracle Fusion Middleware 11g and Application Integration Architecture Oracle AIA Product Executives Visit us @ Location Date/Time Demogrounds Moscone South, Booth 066, 067,068 Wednesday, 10/14/09 from 9:15 am - 5:15 pm Thursday, 10/15/09 CLOSED
  • 33.
    Thursday: Leave withAnswers on Oracle AIA… See you next year! Date/Time Location Title Speaker 10/15/2009 , Thursday @ 9:00 A.M. Moscone West (L3), Room 3008 Increase Agility, Better Understand Your Business with Reference Process Models Oracle AIA Product Executives 10/15/2009 , Thursday @ 9:00 A.M. Building Web Services for JD Edwards Enterprise One and Integrating with Oracle SOA Suite Oracle Product Executive 10/15/2009 , Thursday @ 10:30 a.m. Moscone West (L3), Room 3008 10 Things You MUST Know About Oracle Application Integration Architecture Oracle AIA Product Executive 10/15/2009 , Thursday @ 12:00 P.M. Moscone West (L3), Room 3008 Take the Pain Out of SOA Governance Oracle AIA Product Executive 10/15/2009 , Thursday @ 1:30 P.M. Moscone West (L3), Room 3008 Cloud Computing: Integration as a Service Oracle AIA Product Executive 10/15/2009 , Thursday @ 3:00 P.M. Moscone West (L3), Room 3008 Jumpstart your Apps Integration with Best of Breed Reference Architecture Partner Session: Infosys
  • 34.
    For More Informationwww.oracle.com/aia http://bit.ly/aiawiki http://blogs.oracle.com/aia http://bit.ly/aiaforum OracleAIA Application Integration Architecture http://www.oracle.com/technology/products/applications/aia/index.html
  • 36.
  • 37.
    <Insert Picture Here>Appendix Suggested SOA Reviews
  • 38.
    Kick-Off Session ImplementationGuidance Checkpoint Oracle Team Introduces Single Point of Contact for the project Presents AIA Implementation Methodology and review … Effort Estimator Tool Project Plan Template Integration Overview Template Pointers to AIA Resources Customer IT / System Integrator Introduces the project team and Single Point of Contact Presents the high level project introduction Logical Architecture and Solution Footprint Implementation Phases and Go-Live dates SI partners involved and Training needs Incorporates and schedules guidance review milestones Estimated Time ½ - 1 day Audience AIA Advocate System Integrator IT/Enterprise Architects Assumptions All trainings completed (Oracle SOA Suite, AIA) Project plans include the review milestones Oracle Team (as needed) Single Point of Contact PIP PM 1 Apps PM 1 Solution Architect 1 Applies to PIP implementations only, may not be relevant for Foundation Pack only implementations
  • 39.
    Solution Architecture ReviewImplementation Guidance Checkpoint Oracle Team Reviews functional solution, extensions and provides feedback 1 Reviews application topology and configurations 1 Reviews proposed customizations to base apps/PIPs 1 Presents out of the box PIP TOI sessions, interoperability and best practices 1 Provides technical feedback on use of best practice design patterns Setup XSL Mapping Analyzer and EBO mappings Metalink Note 795541.1 Setup and review usage of AIA Artifacts Generator Review SOA Solution Validation and SOA Readiness Checklists Provide pointers to AIA resources and document templates Customer IT / System Integrator Presents functional overview, use cases, apps footprint and interfaces 1 Presents application topology, configurations, proposed PIP customizations Presents technical overview, performance needs and other areas of interest Estimated Time 5-8 days Audience System Integrator IT/Enterprise Architects Assumptions Requirements to solution mapping is available for review Oracle Team (as needed) PIP PM 1 Apps PM 1 Solution Architect FMW Architect (A-Team) 1 Applies to PIP implementations only, may not be relevant for Foundation Pack only implementations
  • 40.
    Solution Go-Live ReviewImplementation Guidance Checkpoint Estimated Time 3-5 days Audience System Integrator IT/Enterprise Architects Assumptions SOA checklists and PIP Auditor recommendations are followed. Oracle Team Reviews Solution Validation Checklist for AIA compliance Reviews SOA Readiness for Infrastructure compliance Setup PIP Auditor / Shared Artifact Analyzer and provide feedback on results Review production topology, lifecycle management and clustering setup Customer IT / System Integrator Completes SOA Solution Validation and SOA Readiness Checklists Addresses PIP Auditor compliance issues Review SOA Suite Enterprise Deployment Guide Review AIA Clustering Metalink Note 728144.1 Oracle Team (as needed) PIP PM 1 Apps PM 1 Solution Architect FMW Architect (A-Team) 1 Applies to PIP implementations only, may not be relevant for Foundation Pack only implementations
  • 41.
    <Insert Picture Here>Appendix Implementation Tasks
  • 42.

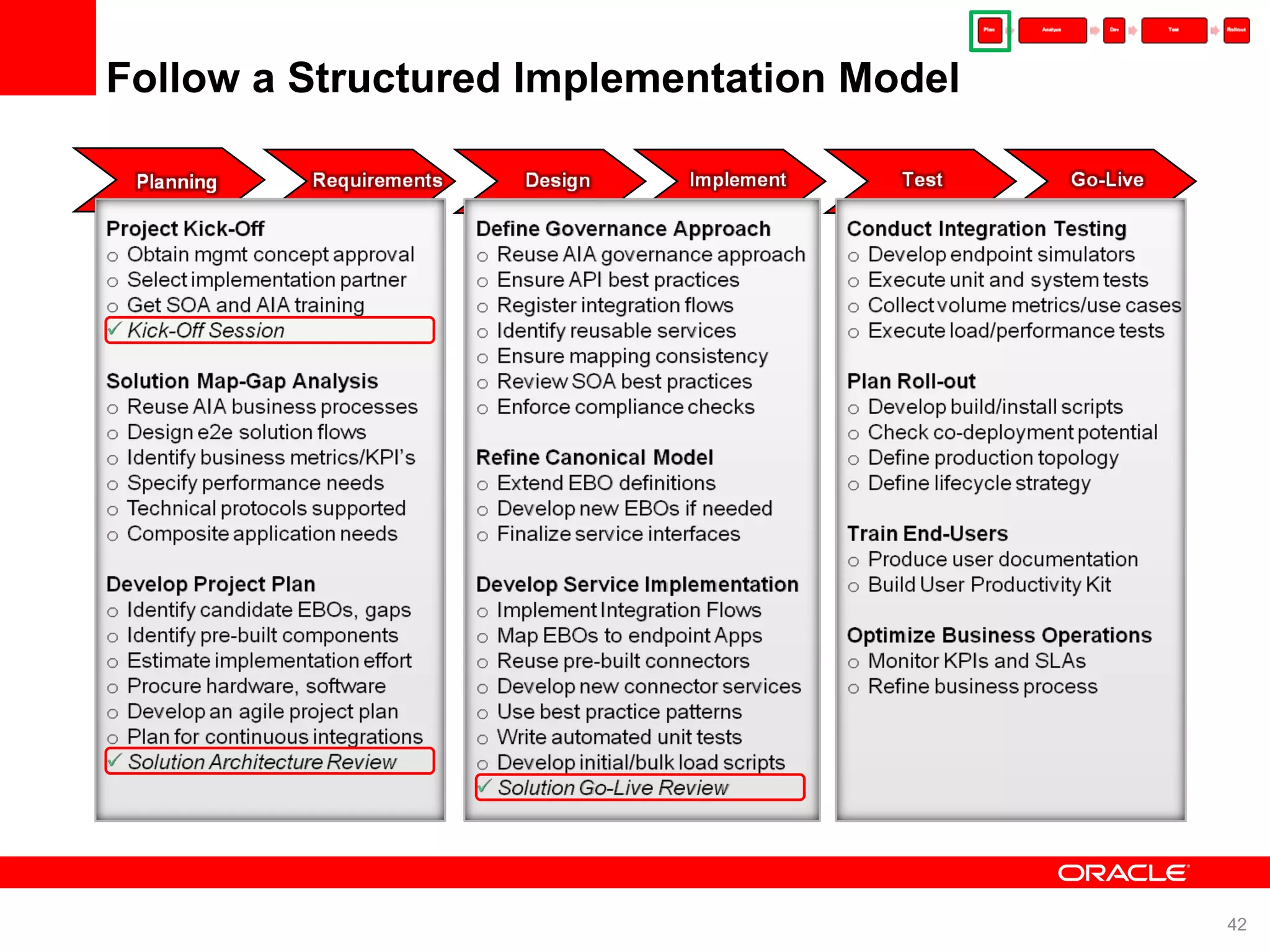

    Follow a StructuredImplementation Model
  • 43.
    Making a BusinessCase for SOA AIA TCO Calculator
  • 44.
    Develop an Agile/IterativeProject Plan Tips from the trenches Release Planning Plan for the entire release using story points, not just one sprint Program Managers should be aware of agile approach, usage and expectations Complex dependencies are a reality – identify them upfront during release planning Plan for skilled resources as needed – don’t expect everyone to be part of your sprint Sprint Phasing Dedicate “Sprint Zero” to identify external dependencies and get commitments Latter sprints execute deliverables from all dependencies e.g. Integration Testing Reserve at least two sprints for system testing and packaging/deployment tasks Sprint Execution Center stories on half the integration flow i.e. application business connector services Define “done” as design, coding, unit testing, documented system tests, deploy scripts Keep sprints lengths at 3-4 weeks for practical PIP development Balance needs for usable design documentation – use an agile design doc template Output of a sprint is not “production ready”; hardening sprints/milestones are needed
  • 45.

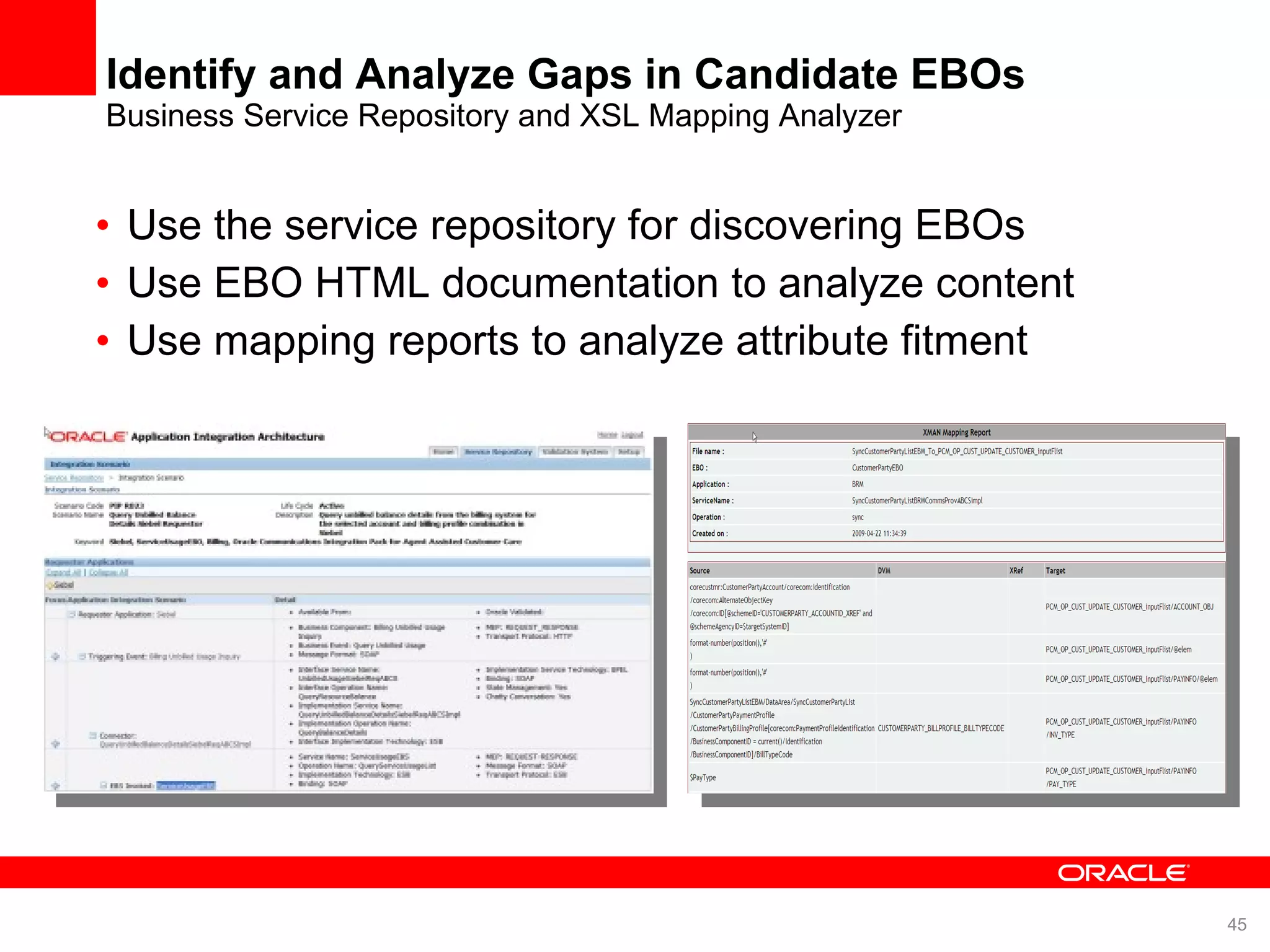

    Identify and AnalyzeGaps in Candidate EBOs Business Service Repository and XSL Mapping Analyzer Use the service repository for discovering EBOs Use EBO HTML documentation to analyze content Use mapping reports to analyze attribute fitment
  • 46.
  • 47.

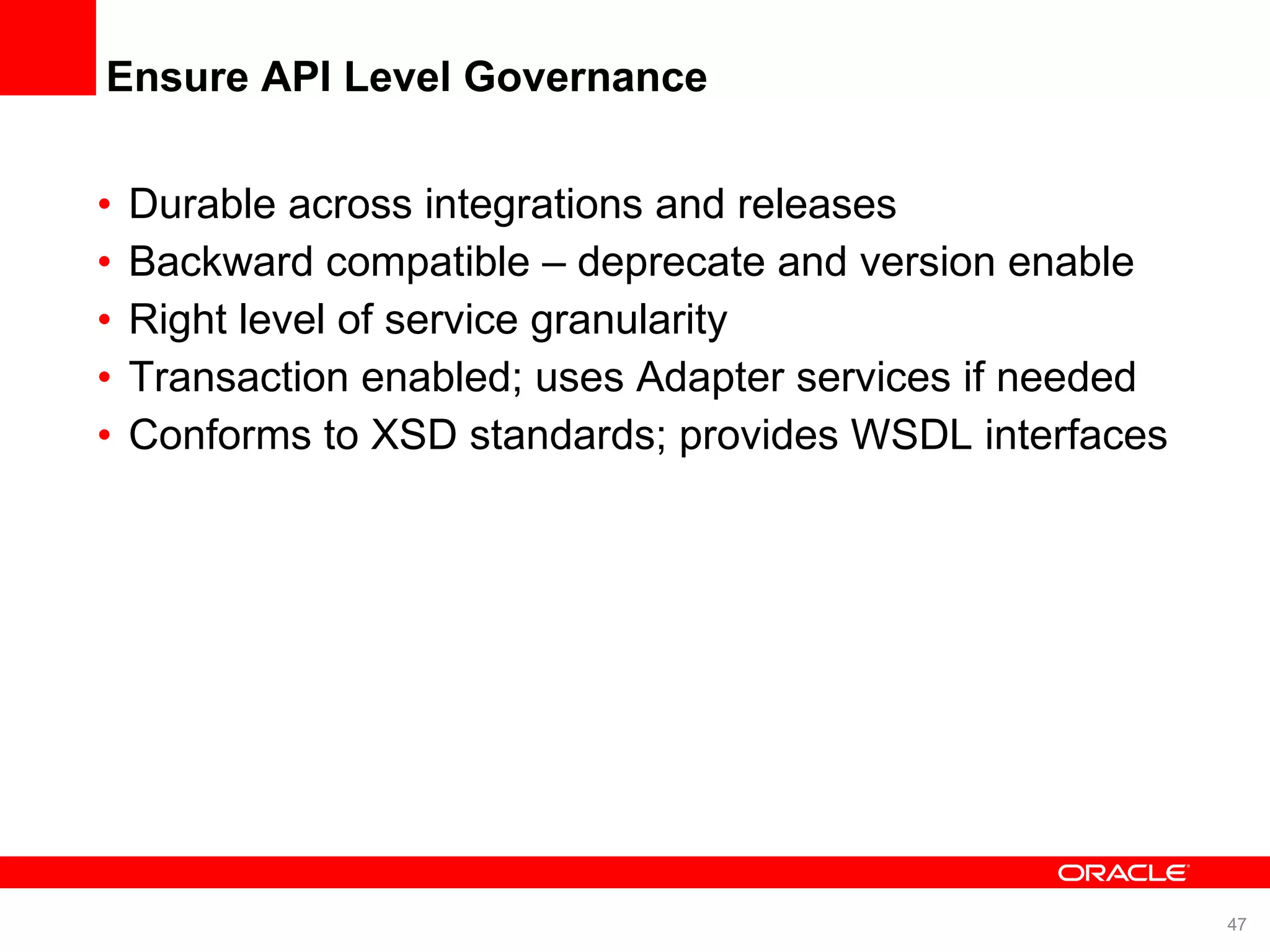

    Ensure API LevelGovernance Durable across integrations and releases Backward compatible – deprecate and version enable Right level of service granularity Transaction enabled; uses Adapter services if needed Conforms to XSD standards; provides WSDL interfaces
  • 48.
    Utilize Best PracticeDesign Patterns Reuse existing connector services wherever available Develop connector services to be PIP and application version agnostic Use SOAP/ESB bindings to make connectors transport neutral Ensure connectors abstract requestor and provider systems Support multiple endpoint application instances with a single connector Avoid concurrent multiple versions of connector services Use Asynchronous Message Exchange Patterns for scalability Use Resequencer pattern to guarantee FIFO delivery Use ODI for Bulk Data Loads or extremely high performance needs Design for transaction support using adapters and defining boundaries
  • 49.
    SOA Warrants anOrganizational Governance Structure SOA Integration Projects Executive Management (CIO/COO) ‏ Integration Steering Committee – Business Heads Technology Governance Content Governance Data Standards Review Board Solution Engineering Architecture Review Board Content Standards (CCTS, UN/CEFACT), Horizontal and Vertical Industry Standards Business Process Modeling Standards EBO Working Groups Source Control, Versioning and Build Processes Technology Standards (WS -*) New Technology Product Adoption Integration Prototypes Integrations Advisory Board Service Co-Existence and Process Re-Use Change Management Automation Workgroups Hosted Mapping Reports Hosted Audit Automation Technology Guidance and Solution Engineering
  • 50.
    <Insert Picture Here>Appendix Content Governance Example Service Interoperability
  • 51.
    Example of MappingInconsistency Interoperability issues when reusing services
  • 52.
    Example: Validate Mappingsduring Upgrades XSL Mapping Analyzer (HTML reports) Find Changed Mappings between 2.4 and 2.5 Find All Custom Extensions for Conflicts Customer Party EBS New Requestor ABCS Extended Mappings UCM Provider ABCS 2.4 UCM Provider ABCS 2.5
  • 53.
    Example: Create FunctionalMapping Spreadsheets XSL Mapping Analyzer (EOL2CSV reports) UCM Provider ABCS Customer Party EBS CRMOD Provider ABCS Siebel Provider ABCS E-Biz Provider ABCS JDE Provider ABCS New Requestor ABCS
  • 54.
    <Insert Picture Here>Appendix OOW AIA Sessions
  • 55.
    Monday: Leave withAnswers on Oracle AIA… Date/Time Location Title Speaker 10/ 12/2009 , Monday @ 11:30 a.m. Moscone West (L3), Room 3008 Insights from the Trenches: Partners Speak Out On Delivering Real Value Partner Panel: IBM Global Services, Deloitte Consulting, Infosys, Tech Mahindra 10/ 12/2009 , Monday @ 1:00 p.m. Moscone West (L3), Room 3008 Ready to Go, Pre-built Business Process Based Integrations to SAP! Partner: Infosys 10/ 12/2009 , Monday @ 2:30 p.m. Moscone West (L3), Room 3008 Strategic Development Partnerships Delivering Superior Value Partner Panel: Wipro Technologies, HCL Technologies, L&T Infotech, Accenture 10/ 12/2009 , Monday @ 4:00 P.M. Moscone West (L3), Room 3010 & 3012 KEYNOTE: Smart Strategies: Prepare For Tomorrow, Leverage what you Have Today Jose Lazares, Oracle V.P. Customers: Adrian Dilworth, CIO, Vodafone Qatar; V.K. Rajaram, Vice President, Intuit Visit us @ Location Date/Time Demogrounds Moscone South, Booth 066, 067,068 Monday, 10/12/09 from 10:30 am - 6:30 pm Tuesday, 10/13/09 from 10:30 am - 6:30 pm Wednesday, 10/14/09 from 9:15 am - 5:15 pm Thursday, 10/15/09 CLOSED Apps Lounge – Meet the Experts Moscone West 2 nd Floor Lobby Monday, 10/12/09 @ 02:00 P.M. – 3:00 P.M. Tuesday, 10/13/09@ 10:00 AM – 11:00 A.M.
  • 56.
    Tuesday: Leave withAnswers on Oracle AIA… Date/Time Location Title Speaker 10/13/2009 , Tuesday @ 11:30 A.M. Moscone West (L3), Room 3008 Customer Success: Extraordinary Results with End-to-End Business Process Integrations Featuring Customer: Zebra Technologies 10/13/2009 , Tuesday @ 1:00 P.M. Moscone West (L3), Room 3008 Remove Barriers to Application Interoperability and True Process Integration Oracle AIA Product Executive with Customer: Dell 10/13/2009 , Tuesday @ 2:30 P.M. Marriott, Salon 14 -15 Fast Track Your Adoption of Oracle Industry Solutions Oracle AIA Product Executives 10/13/2009 , Tuesday @ 2:30 P.M. Moscone West (L3), Room 3008 Chicken Soup for the Integration Weary: Fast Deploying Process Integration Packs Oracle AIA Product Executives 10/13/2009 , Tuesday @ 4:00 P.M. Moscone West (L3), Room 3008 Customer Success: Taming the Heterogeneous IT Environment Featuring Customer: Intuit 10/13/2009 , Tuesday @ 5:30 P.M. Moscone West (L3), Room 3008 Jedi Masters Reveal: Foundation Pack Best Practices - Build Process Integrations Oracle AIA Product Executives Visit us @ Location Date/Time Demogrounds Moscone South, Booth 066, 067,068 Tuesday, 10/13/09 from 10:30 am - 6:30 pm Wednesday, 10/14/09 from 9:15 am - 5:15 pm Thursday, 10/15/09 CLOSED Apps Lounge – Meet the Experts Moscone West 2 nd Floor Lobby Tuesday, 10/13/09@ 10:00 AM – 11:00 A.M.
