Agile Engineering Practices Concepts and Usage

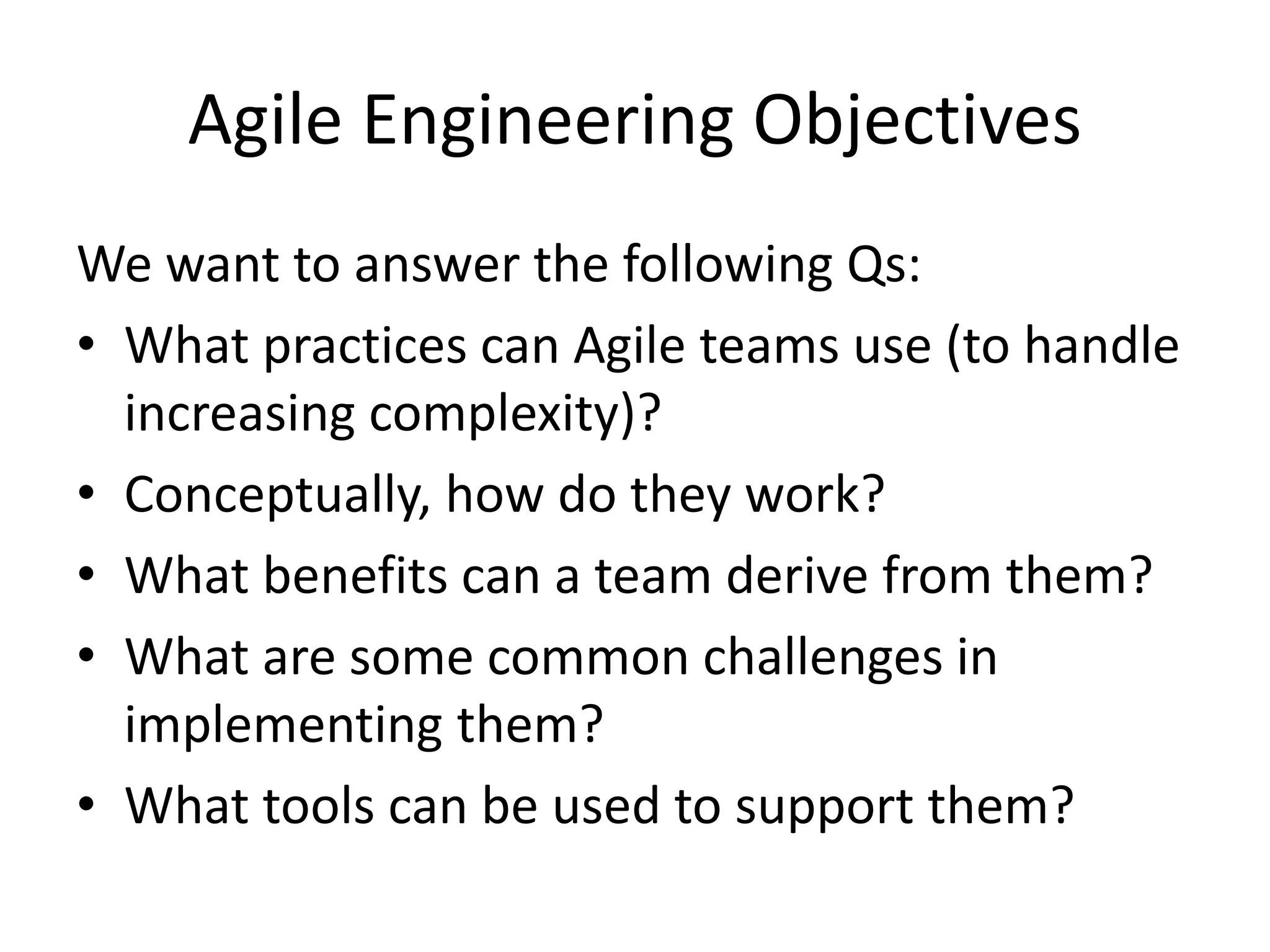

Agile Engineering Objectives We want to answer the following Qs: • What practices can Agile teams use (to handle increasing complexity)? • Conceptually, how do they work? • What benefits can a team derive from them? • What are some common challenges in implementing them? • What tools can be used to support them?

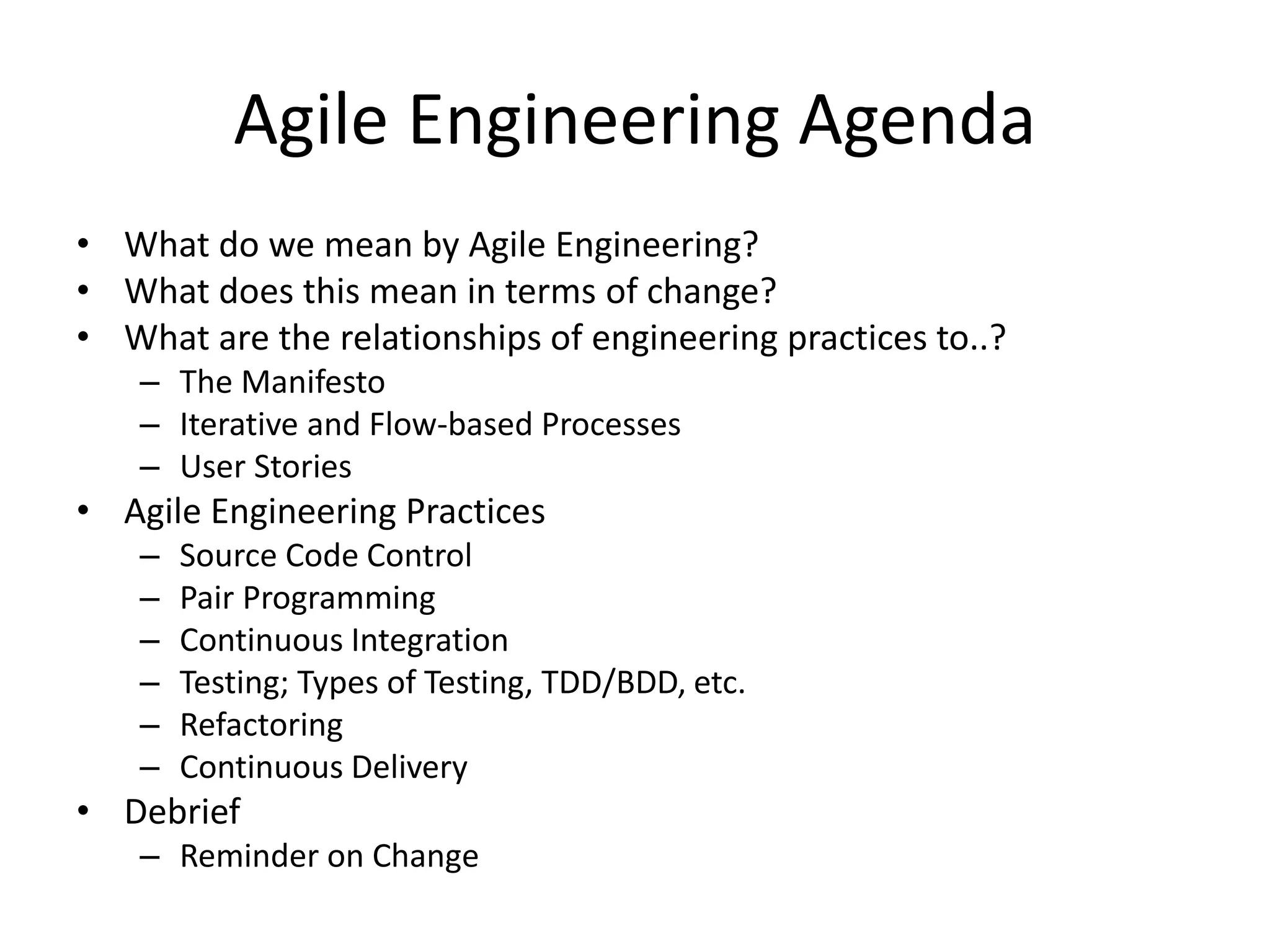

Agile Engineering Agenda • What do we mean by Agile Engineering? • What does this mean in terms of change? • What are the relationships of engineering practices to..? – The Manifesto – Iterative and Flow-based Processes – User Stories • Agile Engineering Practices – Source Code Control – Pair Programming – Continuous Integration – Testing; Types of Testing, TDD/BDD, etc. – Refactoring – Continuous Delivery • Debrief – Reminder on Change

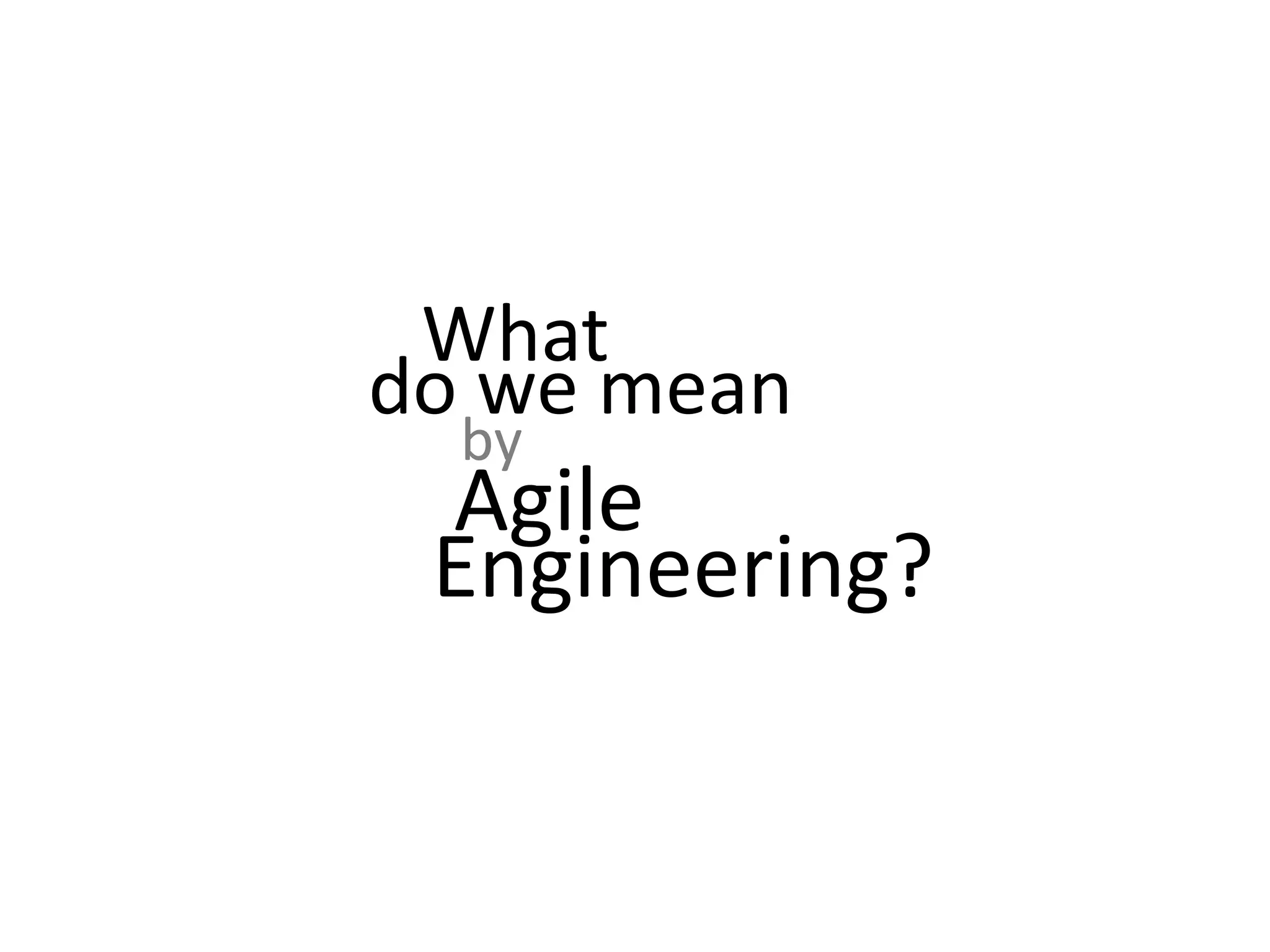

What do we mean Agile by Engineering?

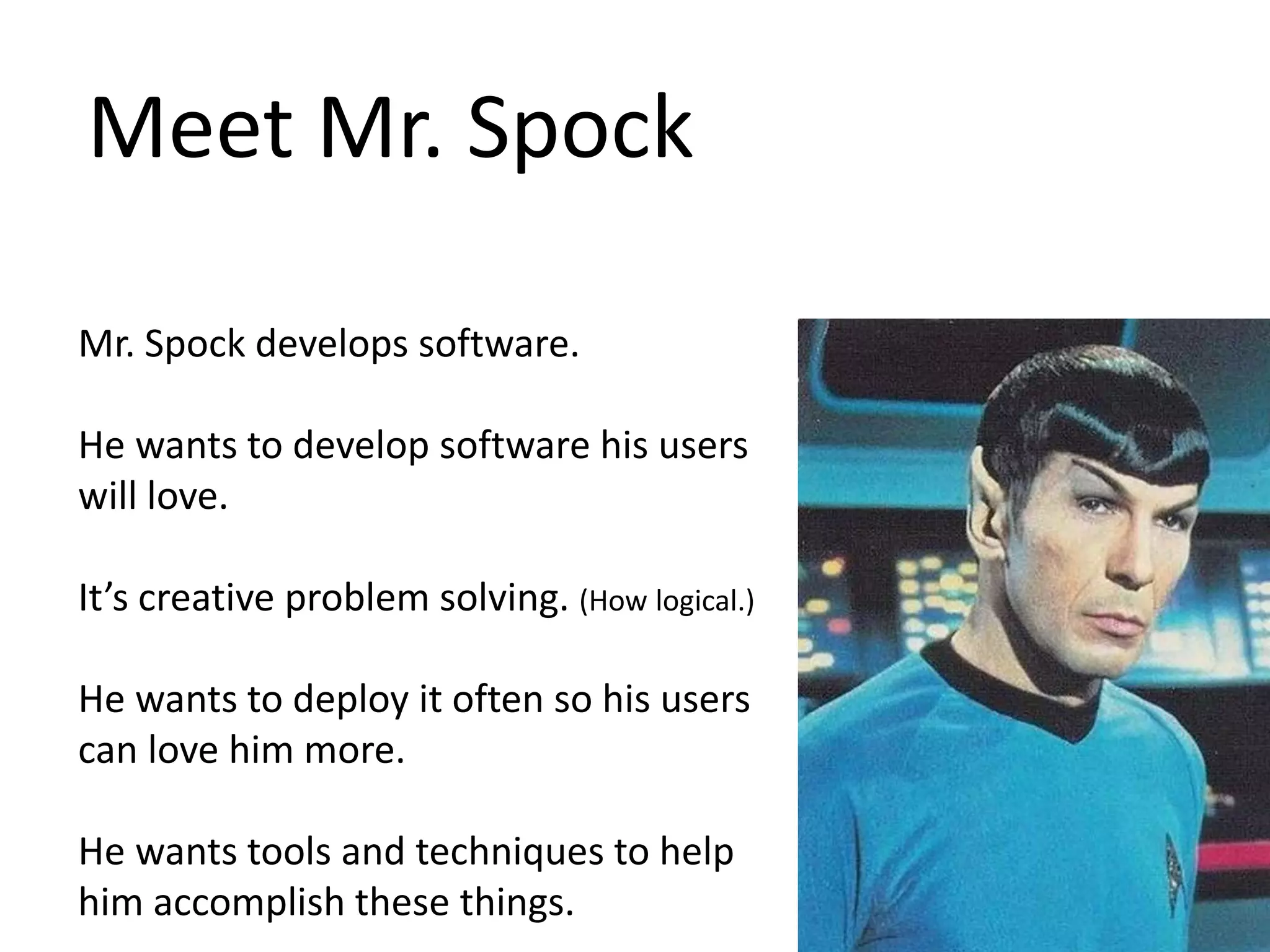

Meet Mr. Spock Mr. Spock develops software. He wants to develop software his users will love. It’s creative problem solving. (How logical.) He wants to deploy it often so his users can love him more. He wants tools and techniques to help him accomplish these things.
Meet Mr. Scott Mr. Scott runs systems. He wants the systems to run reliably. Problem-solving almost always means bad news for him. Users usually do not love it when he has to do problem-solving. Fast deployments hopefully don’t mean more work and outages.
When things don’t go well… CAPT Kirk, the CIO, shows more emotion than Mr. Spock would like. You’d thing the Klingons had taken his son or something…
Agile engineering practices help us… Protect us from ourselves Produce quality code Deploy often and reliably

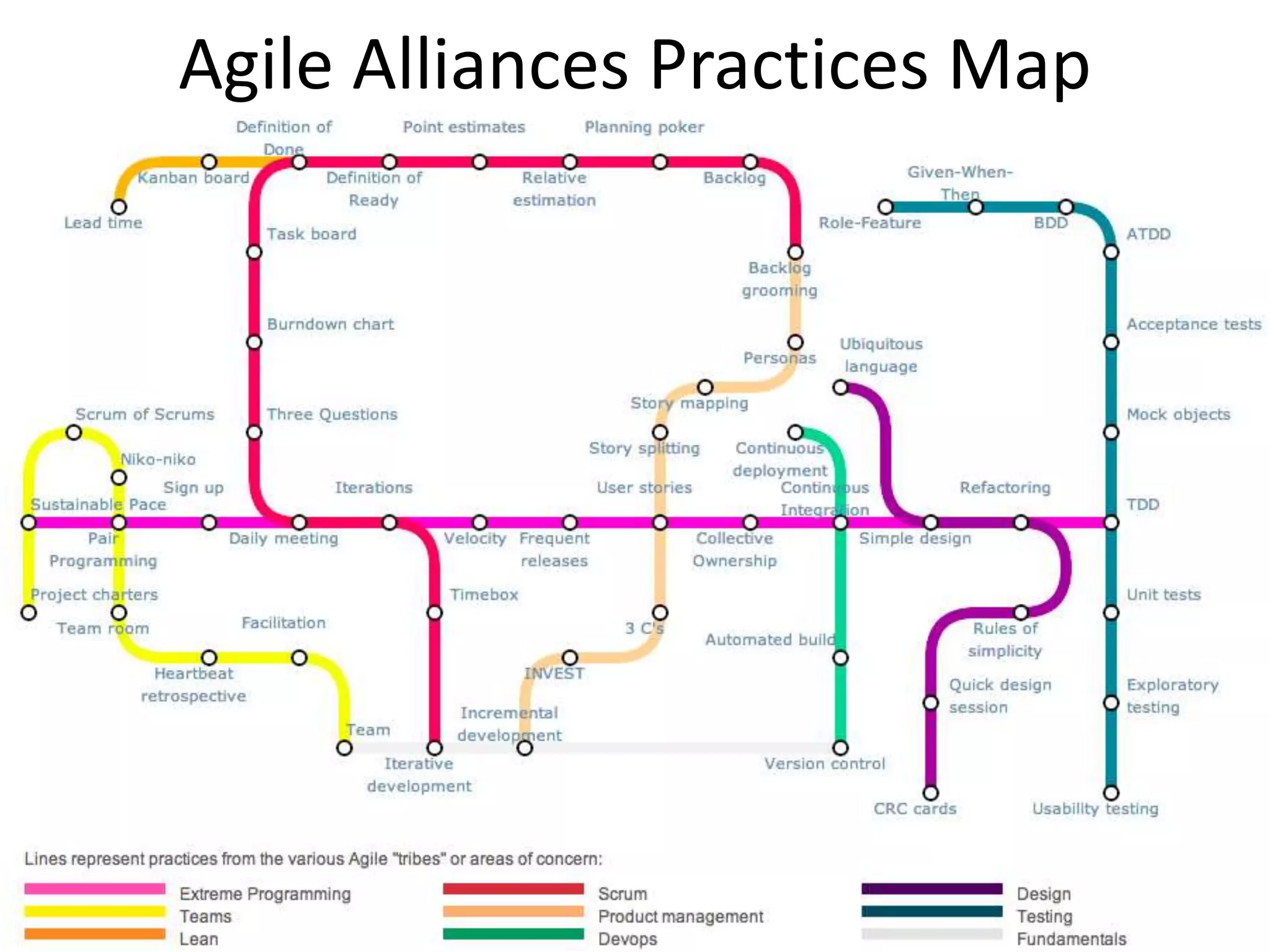

Agile Alliances Practices Map

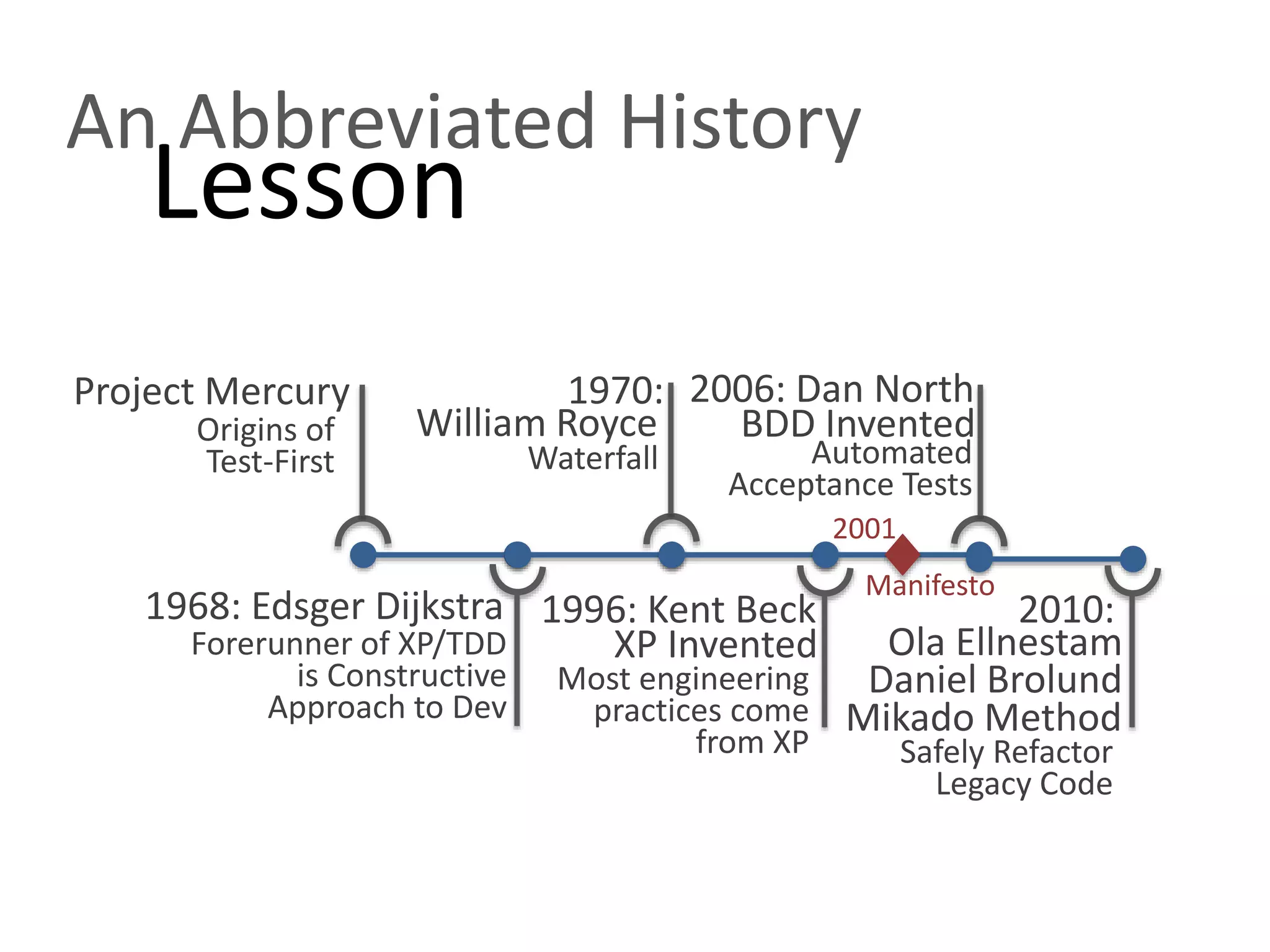

An Abbreviated History Lesson 1970: 2006: Dan North XP Invented Most engineering practices come from XP 1968: Edsger Dijkstra Forerunner of XP/TDD is Constructive Approach to Dev 1996: Kent Beck Project Mercury Origins of Test-First William Royce Waterfall BDD Invented Automated Acceptance Tests 2010: Manifesto Ola Ellnestam Daniel Brolund Mikado Method Safely Refactor Legacy Code 2001
What does this mean in terms of change?

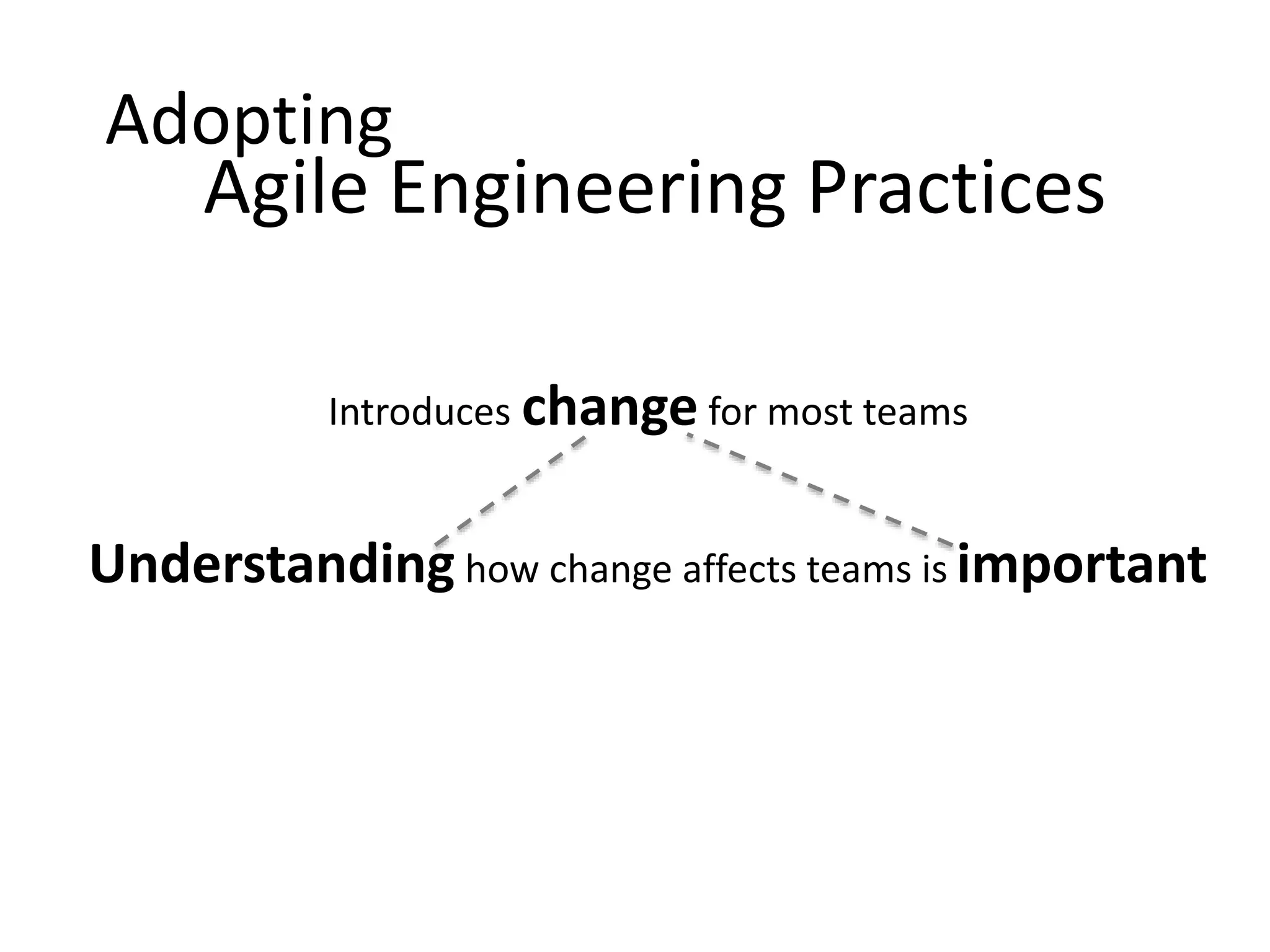

Adopting Agile Engineering Practices Introduces change for most teams Understanding how change affects teams is important

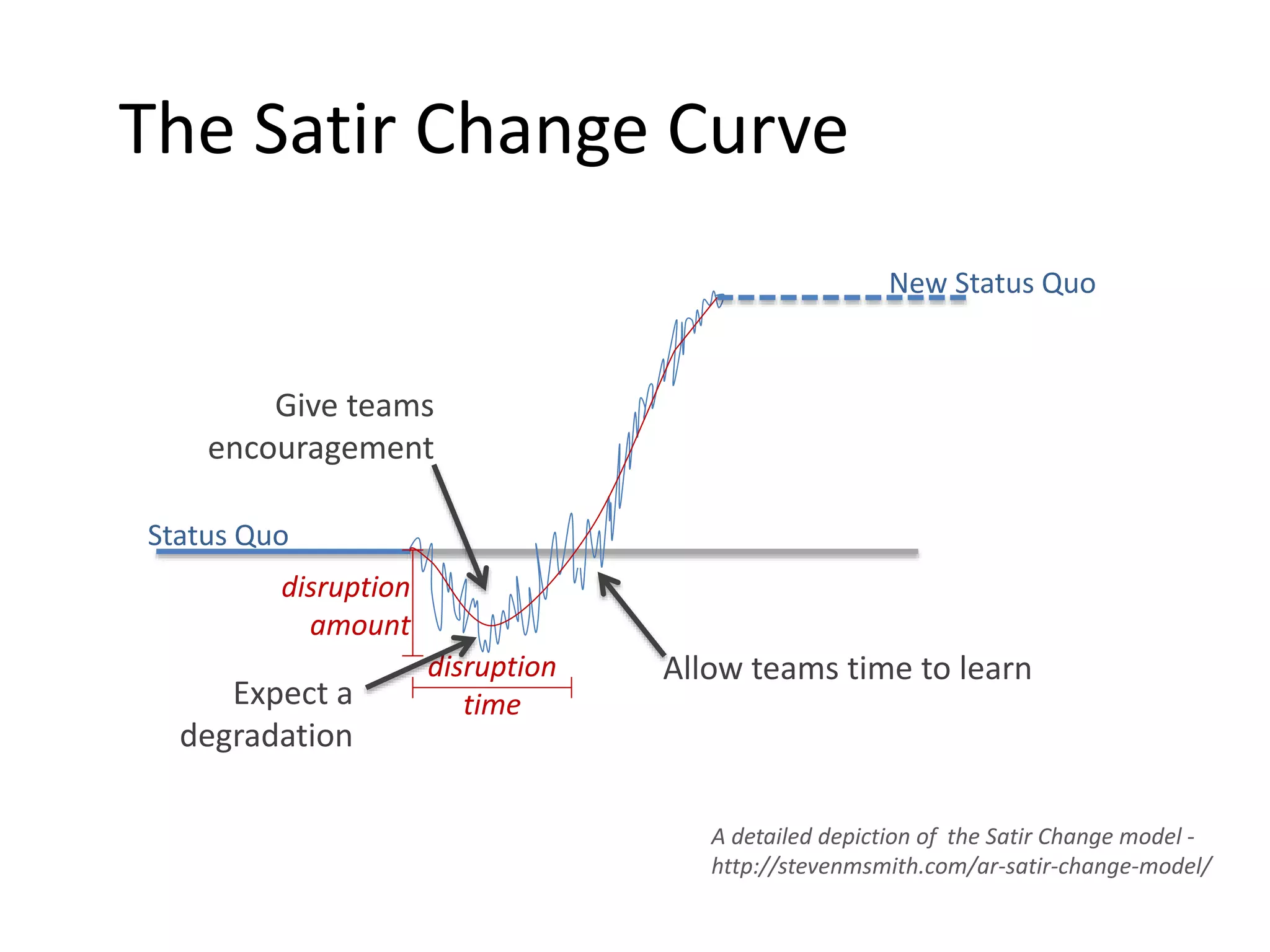

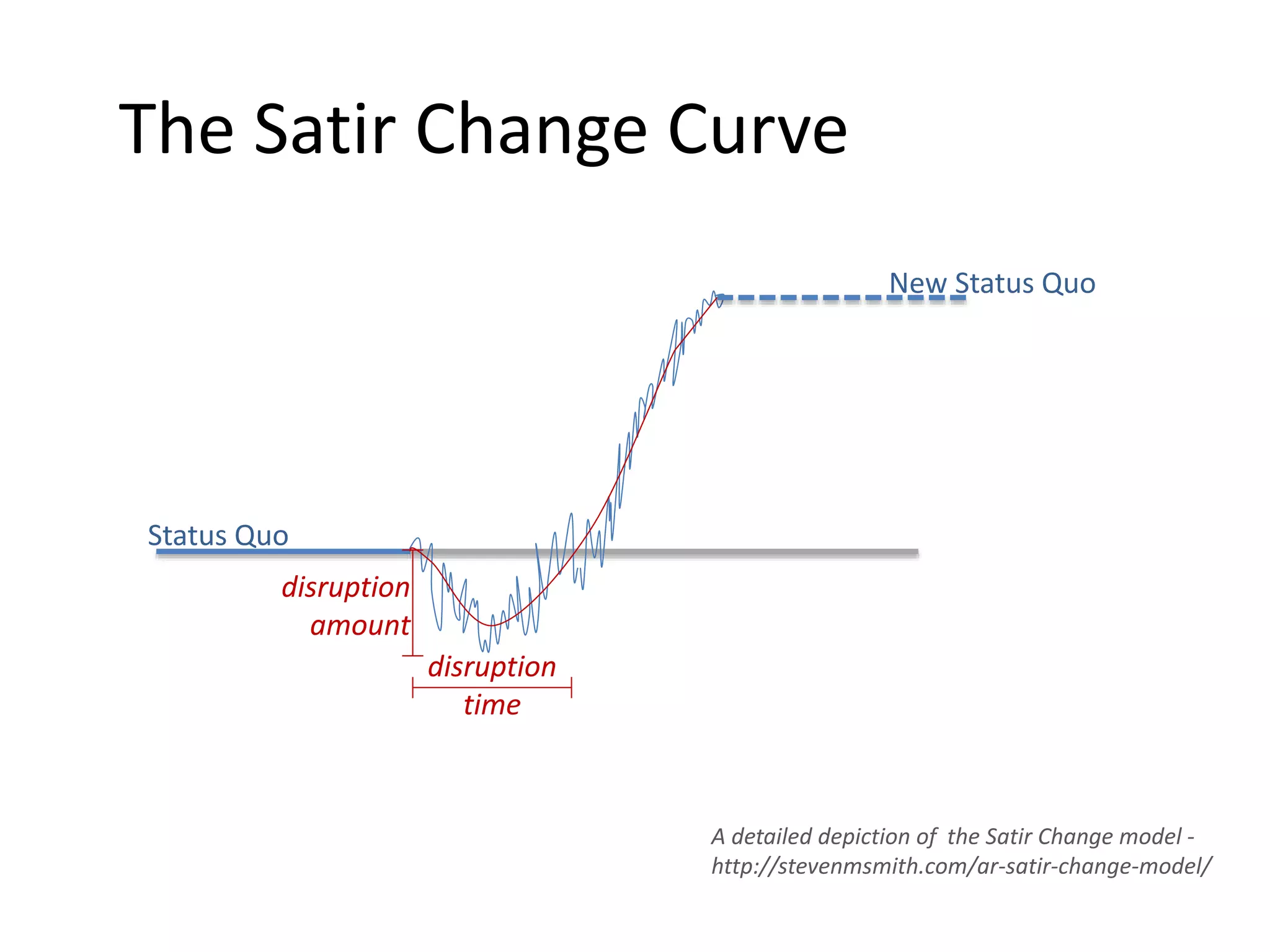

The Satir Change Curve Status Quo New Status Quo disruption amount disruption time A detailed depiction of the Satir Change model - http://stevenmsmith.com/ar-satir-change-model/
The Satir Change Curve Status Quo New Status Quo disruption amount disruption time Allow teams time to learn A detailed depiction of the Satir Change model - http://stevenmsmith.com/ar-satir-change-model/ Give teams encouragement Expect a degradation
How does Agile Engineering relate to the Agile Manifesto?

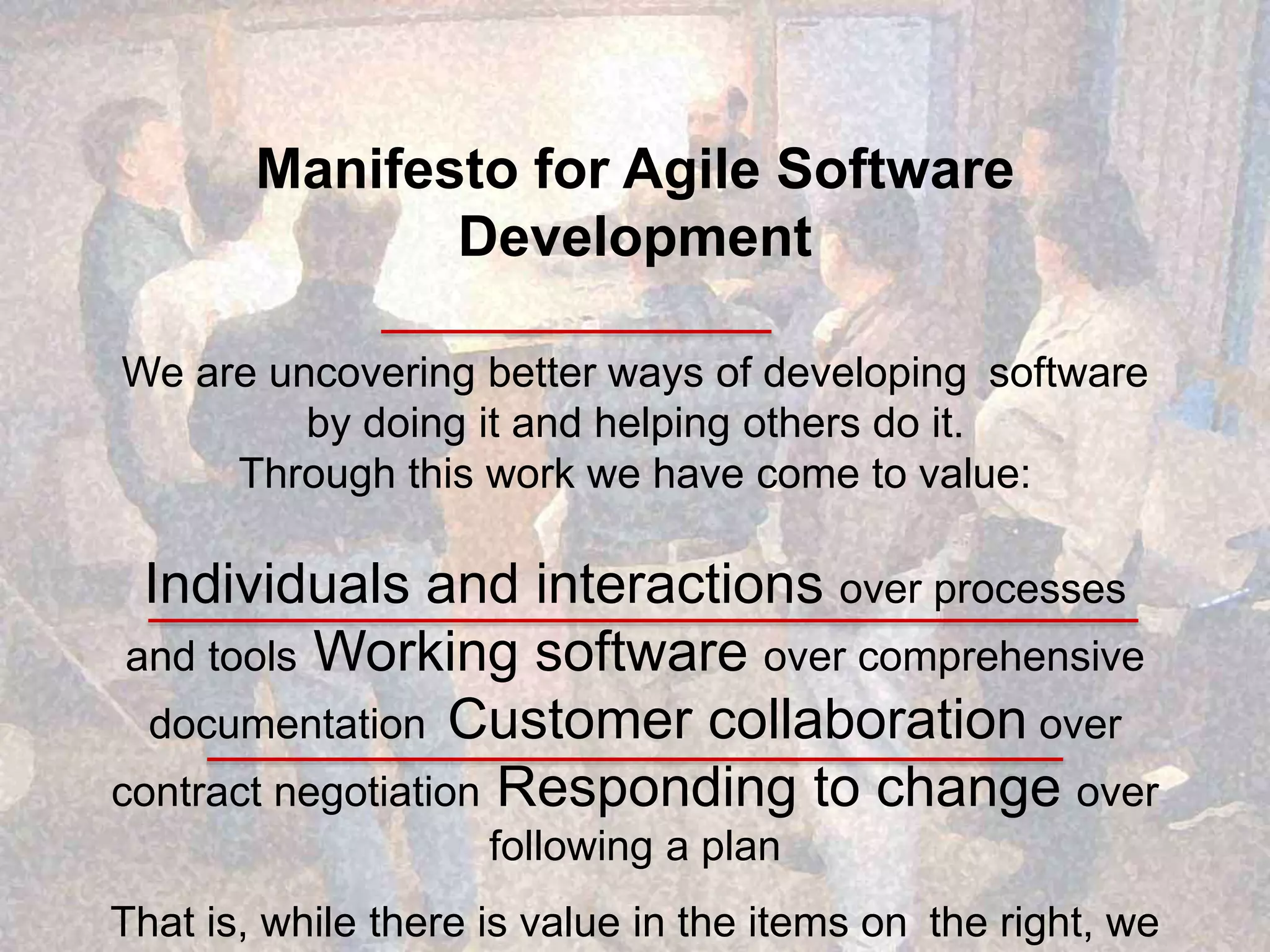

Manifesto for Agile Software Development We are uncovering better ways of developing software by doing it and helping others do it. Through this work we have come to value: Individuals and interactions over processes and tools Working software over comprehensive documentation Customer collaboration over contract negotiation Responding to change over following a plan That is, while there is value in the items on the right, we

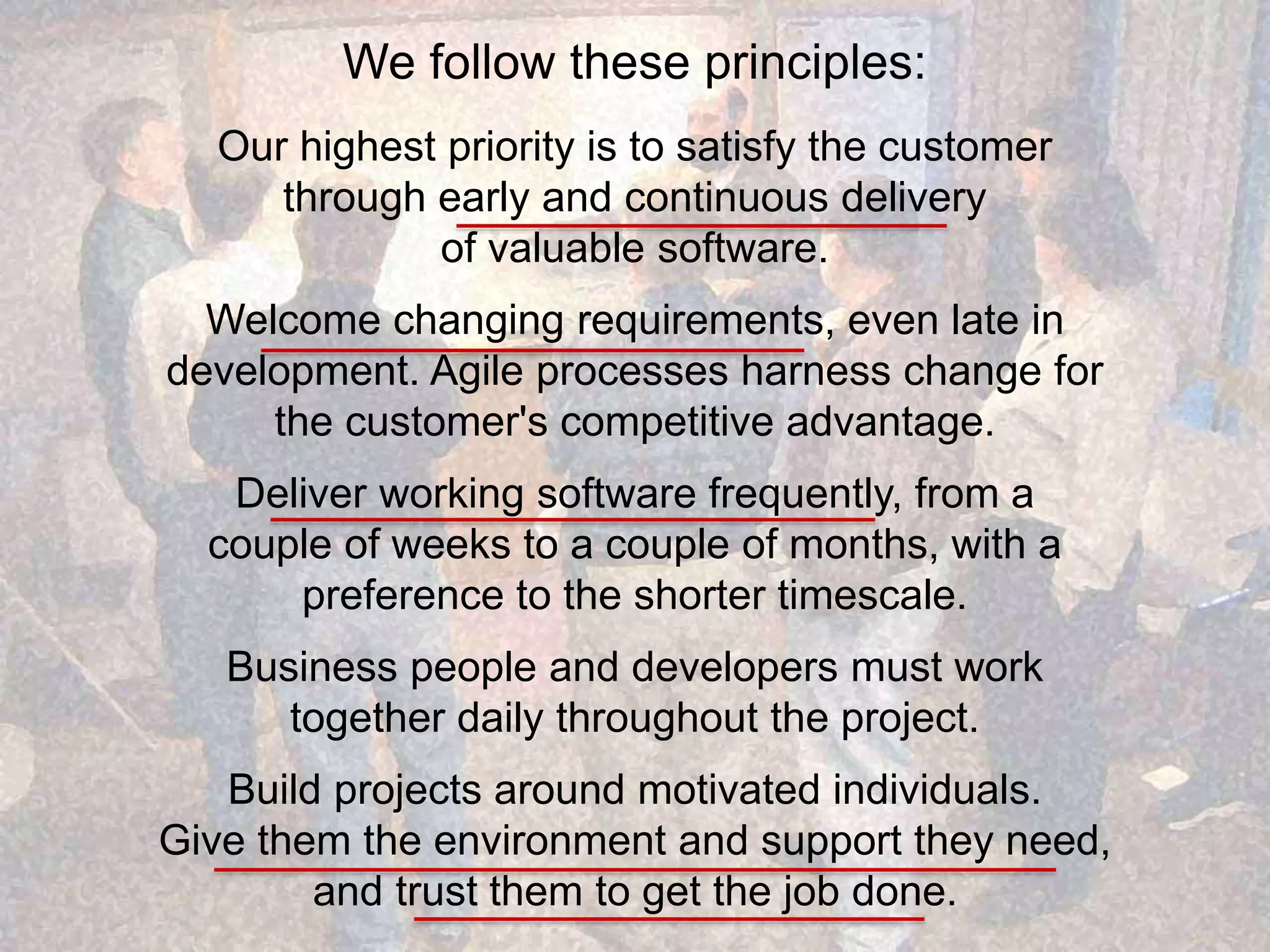

We follow these principles: Our highest priority is to satisfy the customer through early and continuous delivery of valuable software. Welcome changing requirements, even late in development. Agile processes harness change for the customer's competitive advantage. Deliver working software frequently, from a couple of weeks to a couple of months, with a preference to the shorter timescale. Business people and developers must work together daily throughout the project. Build projects around motivated individuals. Give them the environment and support they need, and trust them to get the job done.

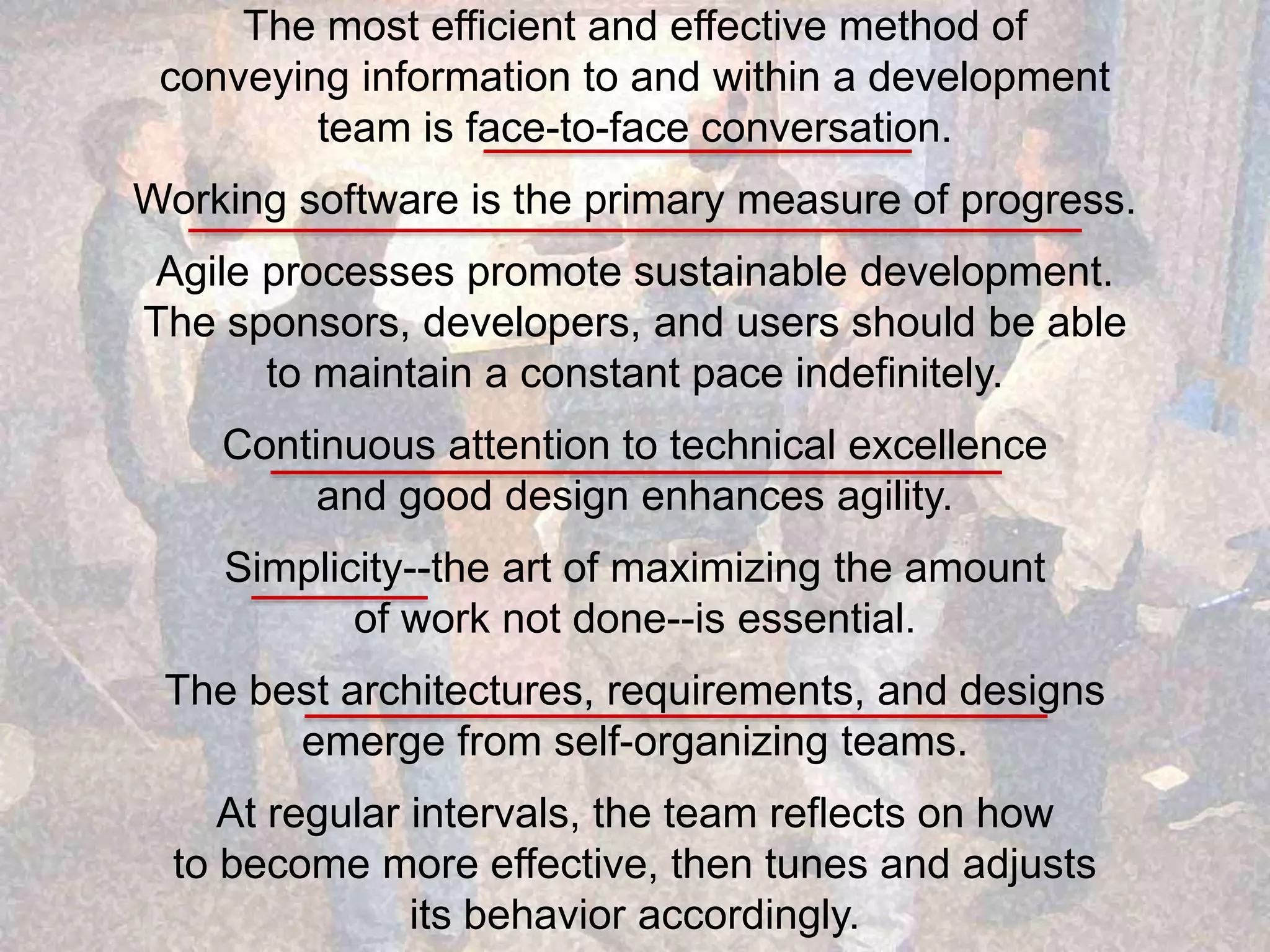

The most efficient and effective method of conveying information to and within a development team is face-to-face conversation. Working software is the primary measure of progress. Agile processes promote sustainable development. The sponsors, developers, and users should be able to maintain a constant pace indefinitely. Continuous attention to technical excellence and good design enhances agility. Simplicity--the art of maximizing the amount of work not done--is essential. The best architectures, requirements, and designs emerge from self-organizing teams. At regular intervals, the team reflects on how to become more effective, then tunes and adjusts its behavior accordingly.
How does Agile Engineering relate to the agile processes?

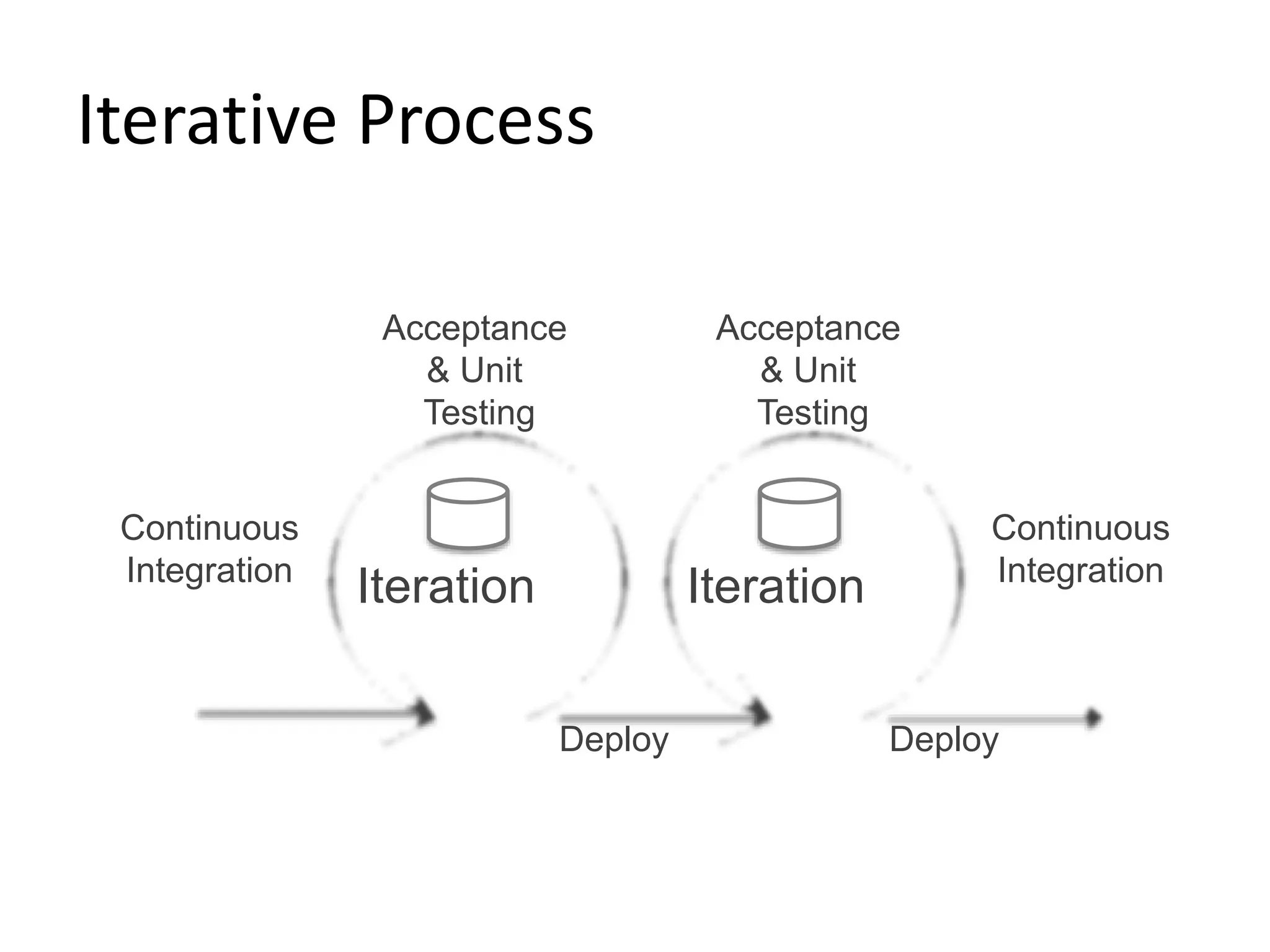

Iterative Process Acceptance Iteration Iteration Deploy Deploy & Unit Testing Continuous Integration Continuous Integration Acceptance & Unit Testing

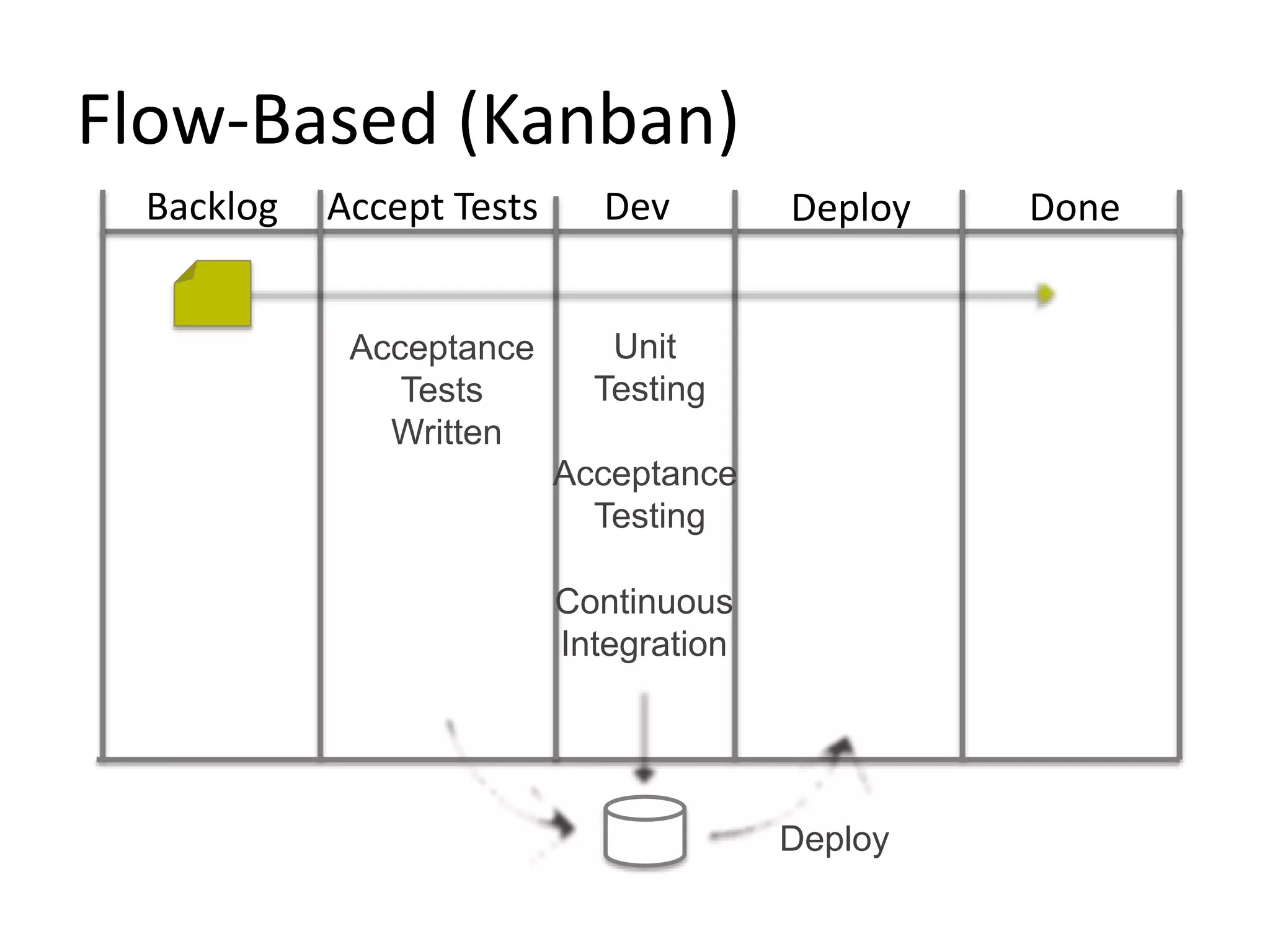

Flow-Based (Kanban) Backlog Accept Tests Dev Deploy Done Deploy Acceptance Tests Written Unit Testing Acceptance Testing Continuous Integration
How does Agile Engineering relate user to stories?

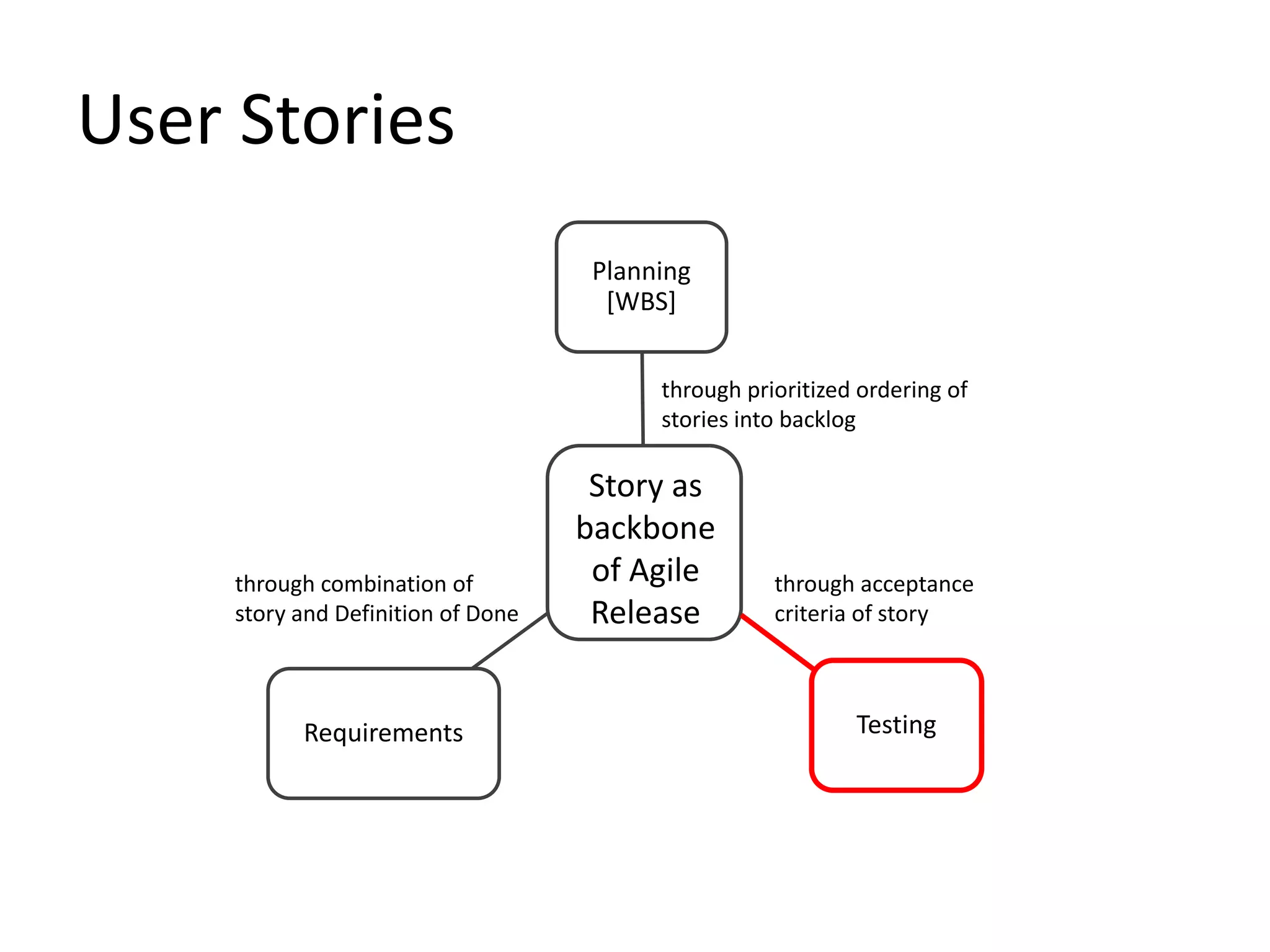

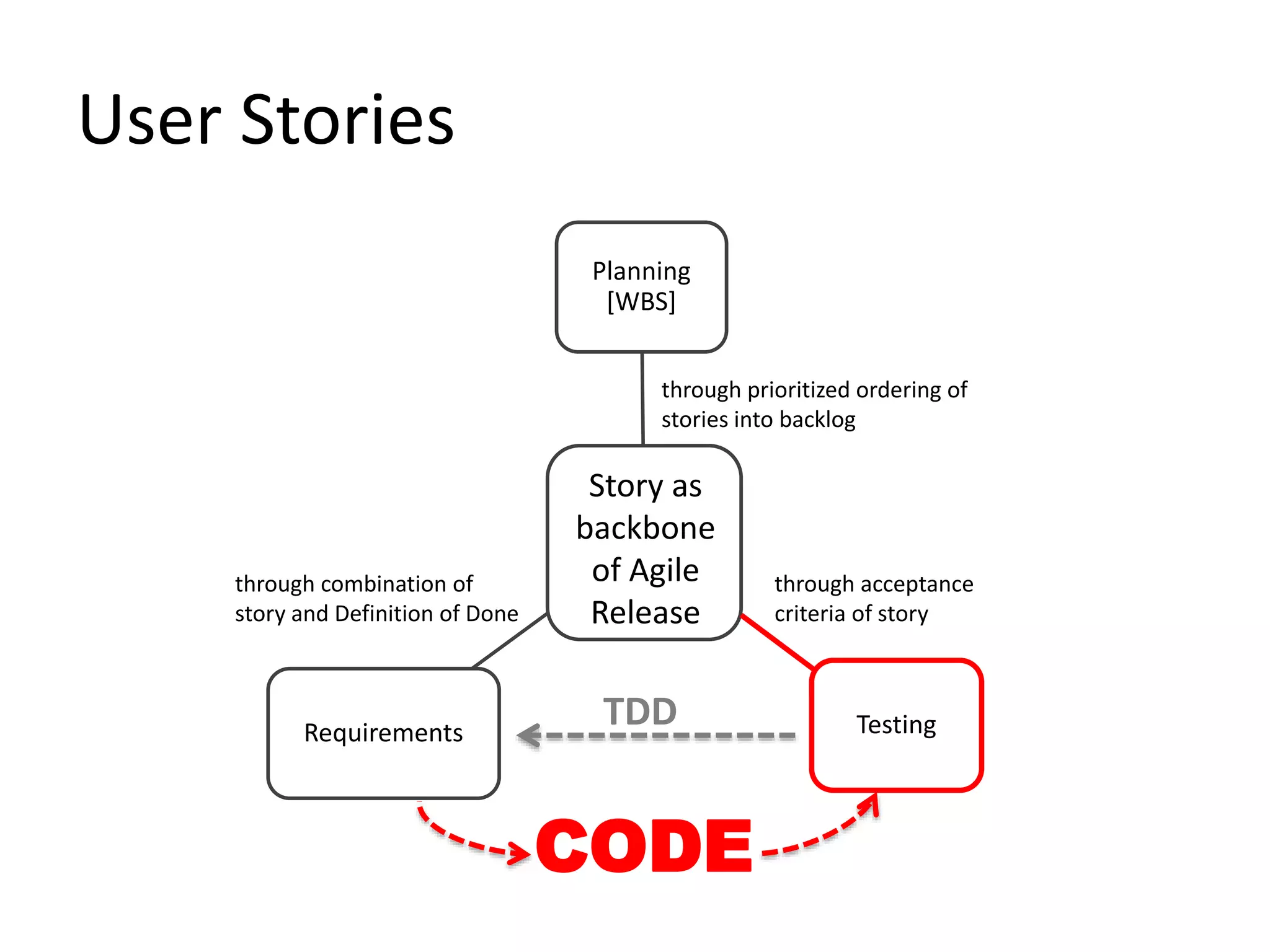

User Stories Planning [WBS] through prioritized ordering of stories into backlog Story as backbone of Agile Release through acceptance criteria of story through combination of story and Definition of Done Requirements Testing
User Stories Planning [WBS] through prioritized ordering of stories into backlog Story as backbone of Agile Release through acceptance criteria of story through combination of story and Definition of Done TDD Requirements Testing CODE
What are the Agile Engineering Practices?
Time for a break… As played by the Dave Brubeck Quartet… Take Five

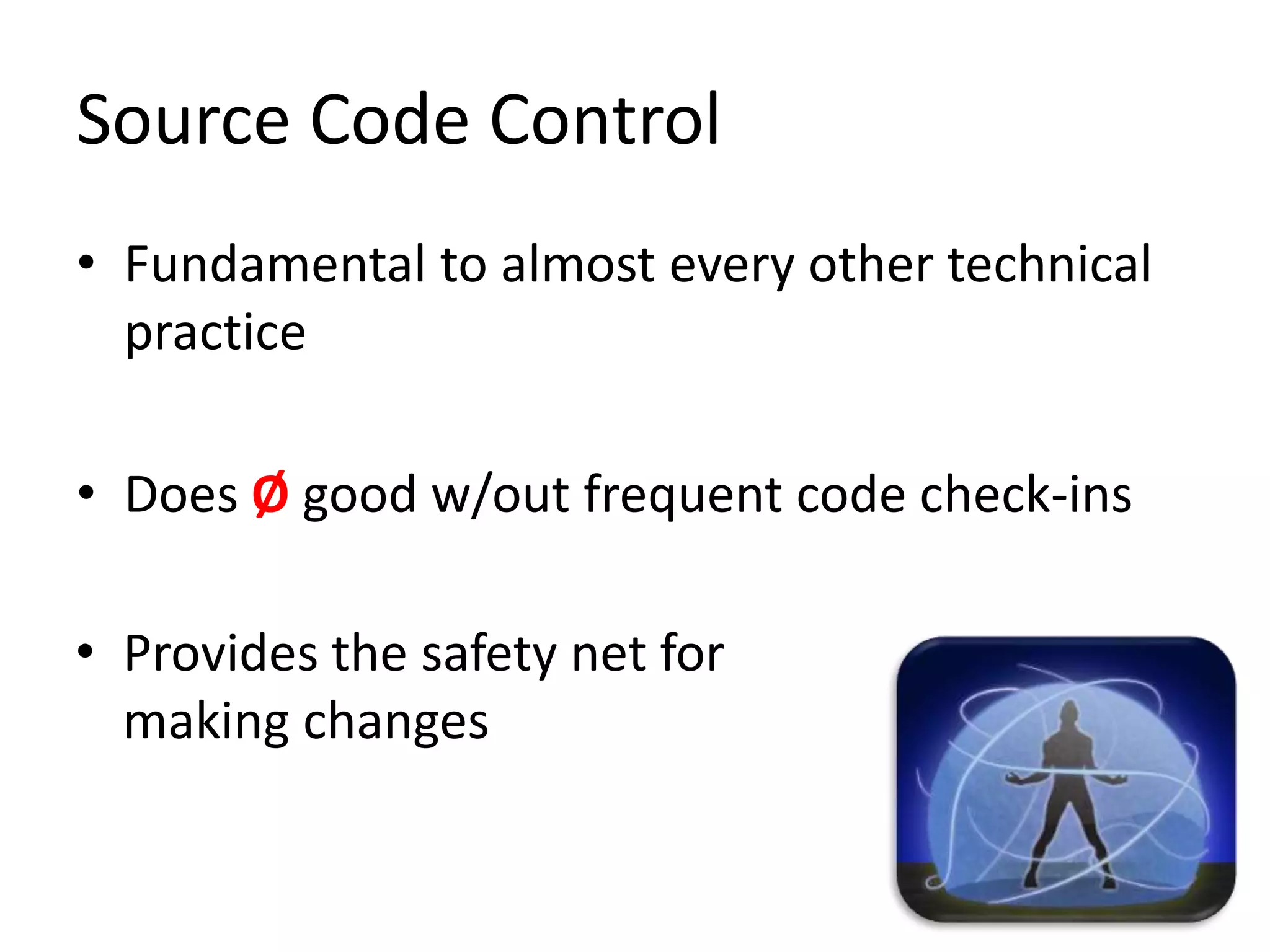

#1 Source Code Control
Source Code Control • Fundamental to almost every other technical practice • Does Ø good w/out frequent code check-ins • Provides the safety net for making changes
What is wrong with using a source code repository like this? Shared File Space Release Candidate Declare Release Release Who is this?

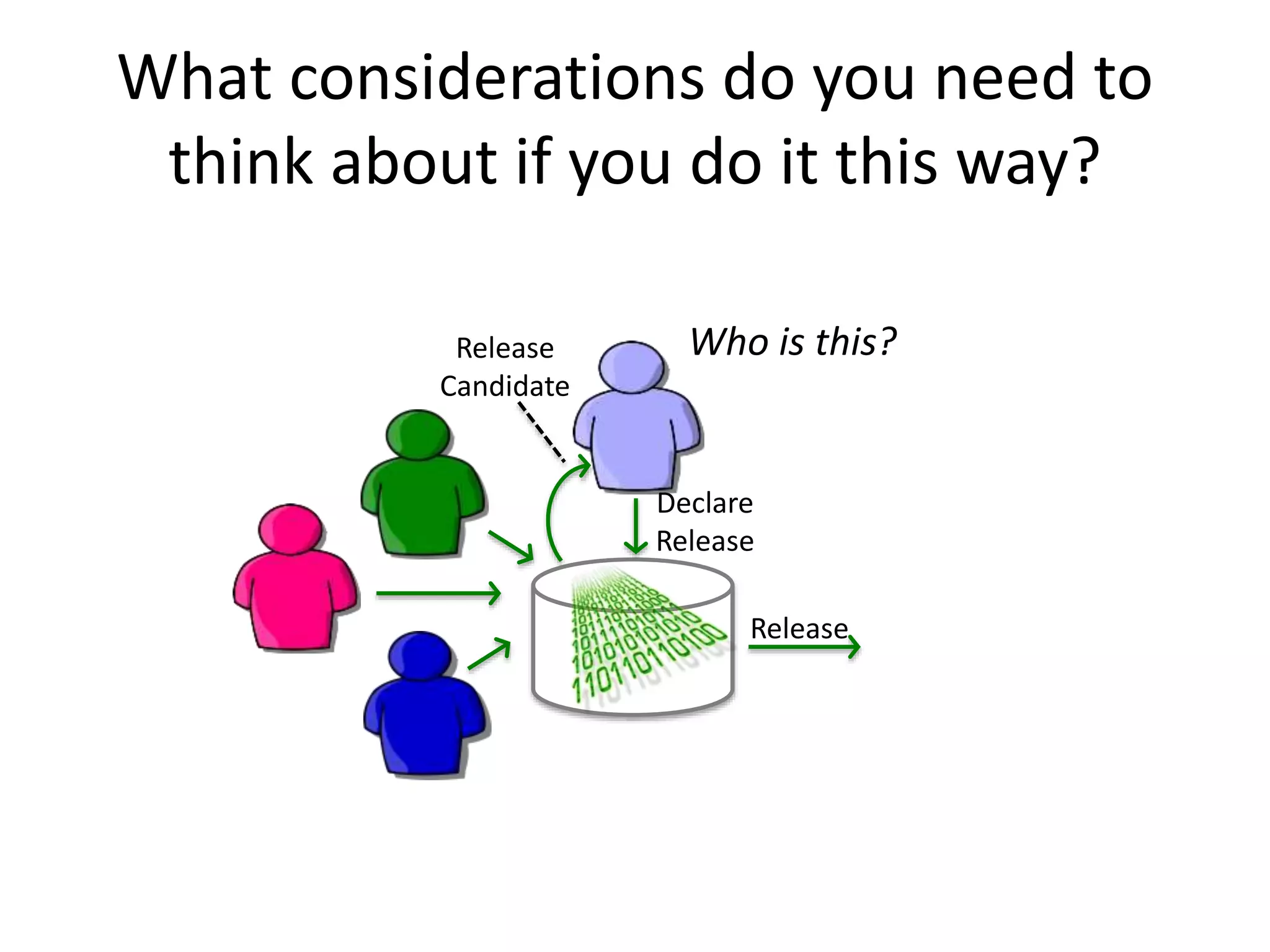

What considerations do you need to think about if you do it this way? Release Who is this? Candidate Declare Release Release
What considerations should we consider if developers horde code and don’t commit it to the repository? Declare Release Release Release Candidate X

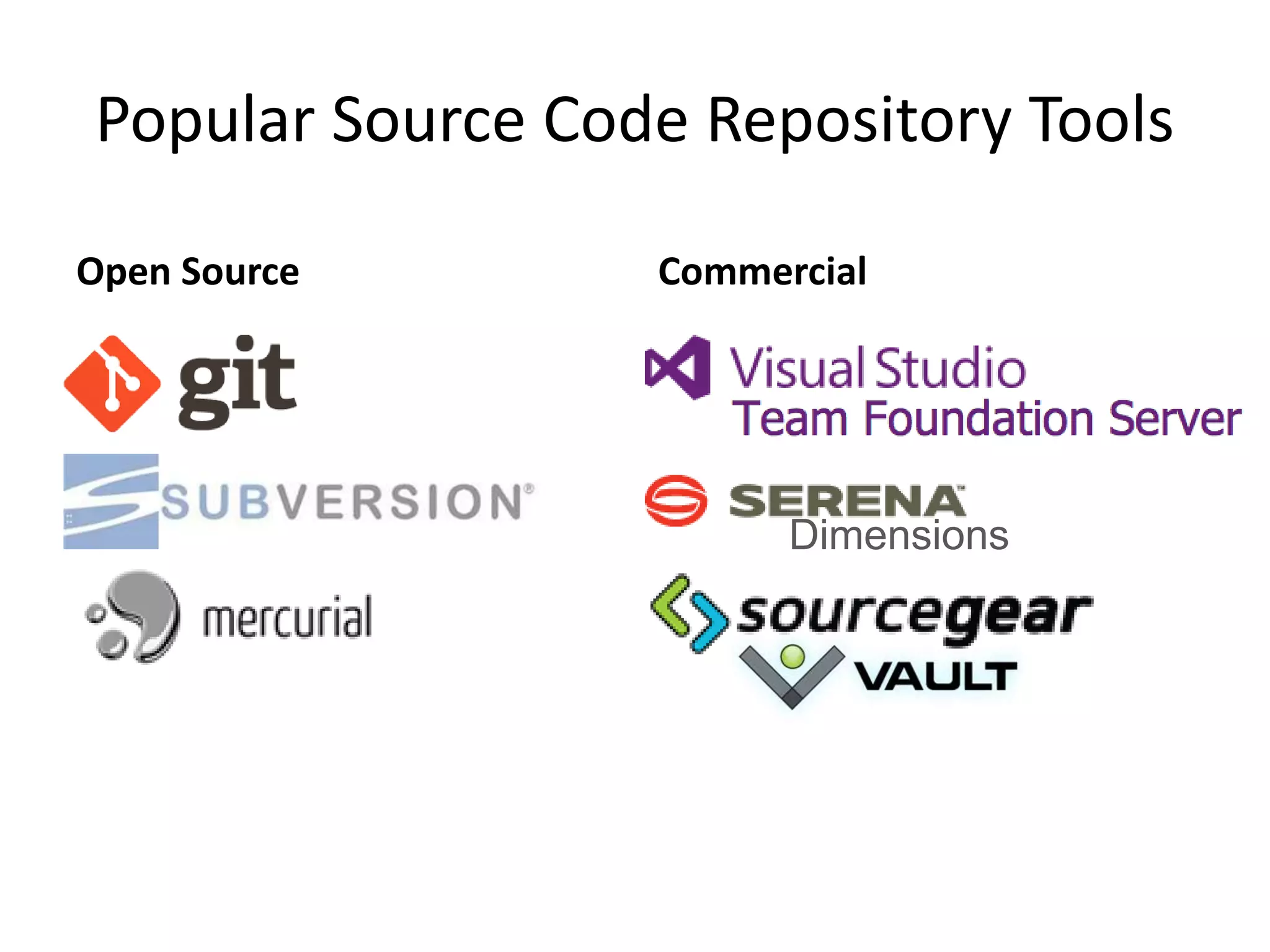

Popular Source Code Repository Tools Open Source Commercial Dimensions
#2 Pair Programming
What is Pair Programming? In a classic it’s XP sense, 2 Developers, 1 Keyboard

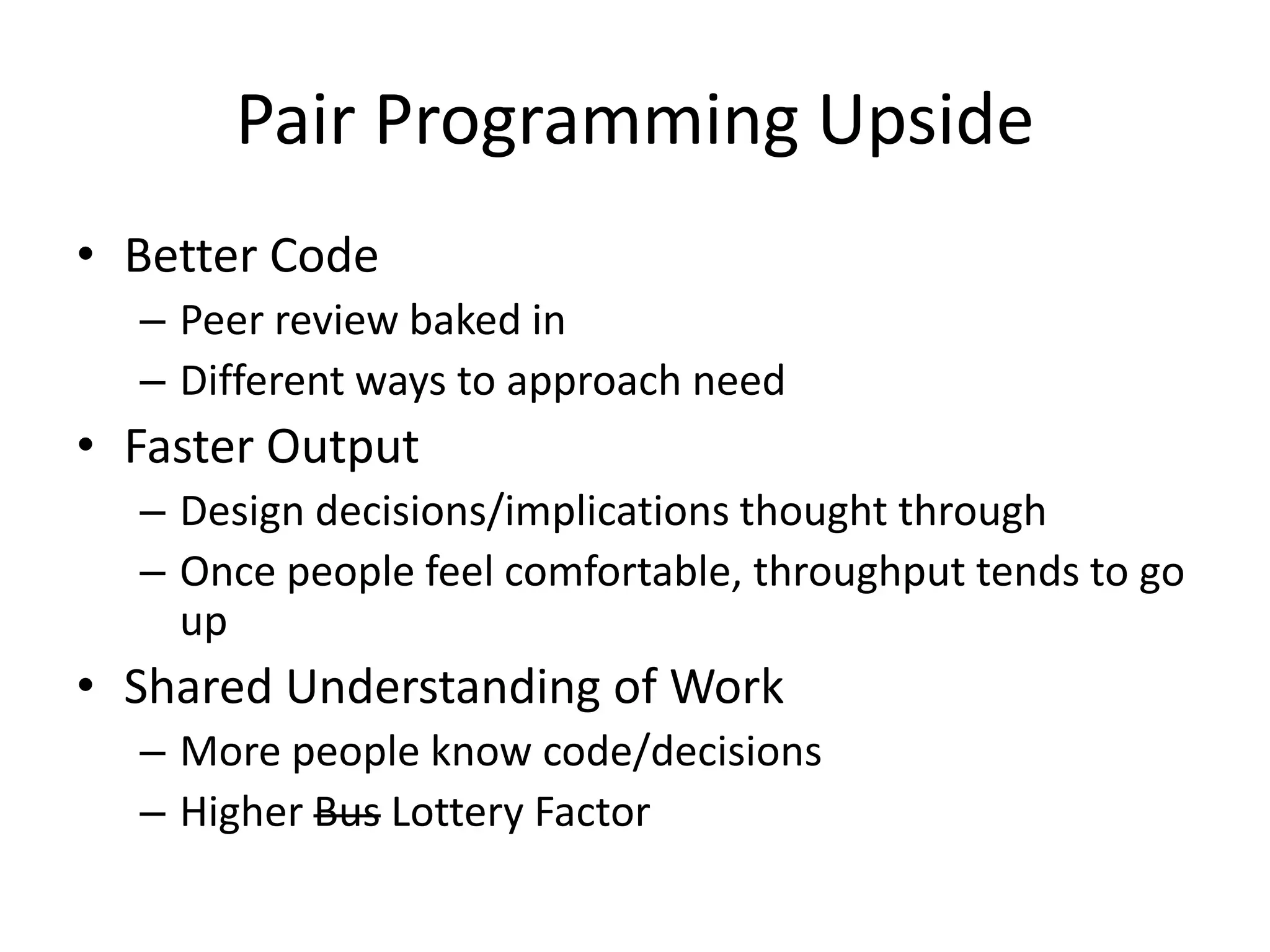

Pair Programming Upside • Better Code – Peer review baked in – Different ways to approach need • Faster Output – Design decisions/implications thought through – Once people feel comfortable, throughput tends to go up • Shared Understanding of Work – More people know code/decisions – Higher Bus Lottery Factor
Pair Programming Flipside • Personality Fits Are Important – Not everyone feels comfortable exposing their work – Need to avoid dominant controller – Good listening skills • Breather Time – Need space/time to selves, particularly for introverts – Consider allowing OK to check out – Space for people to go to… • Expect Some ‘Adjustment’ – Human dynamics of learning to share space/thoughts

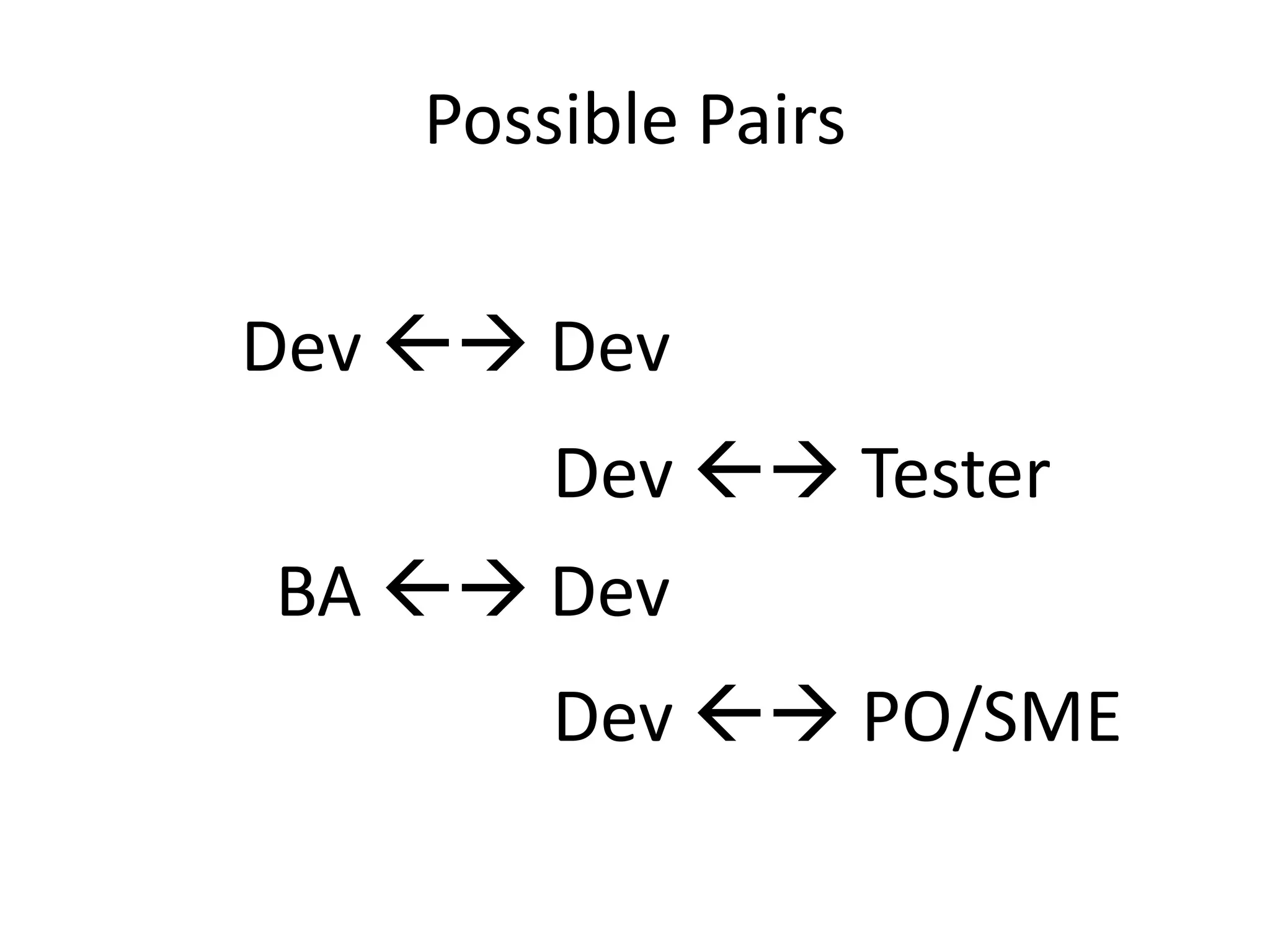

Possible Pairs Dev  Dev Dev  Tester BA  Dev Dev  PO/SME

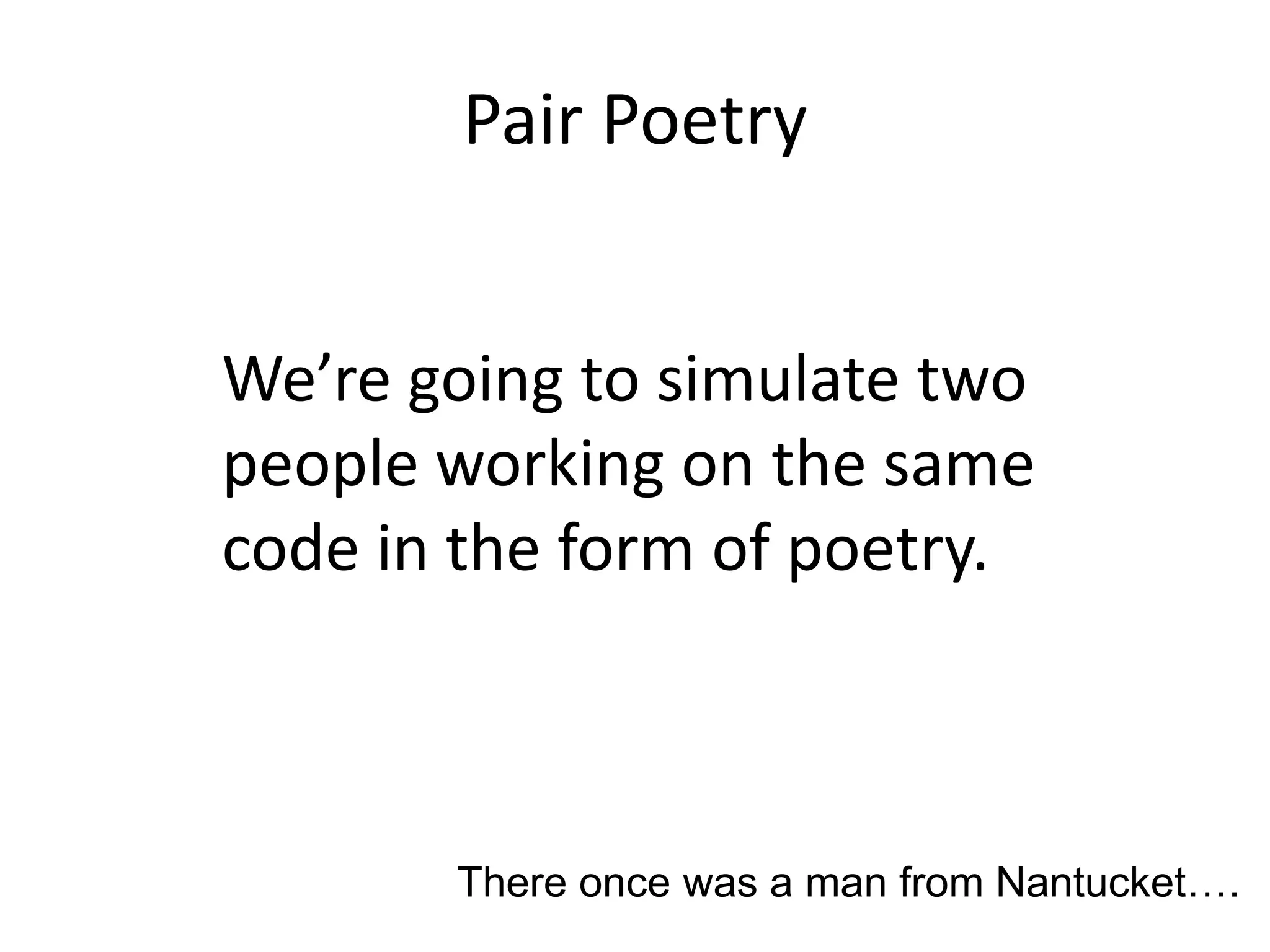

Pair Poetry We’re going to simulate two people working on the same code in the form of poetry. There once was a man from Nantucket….

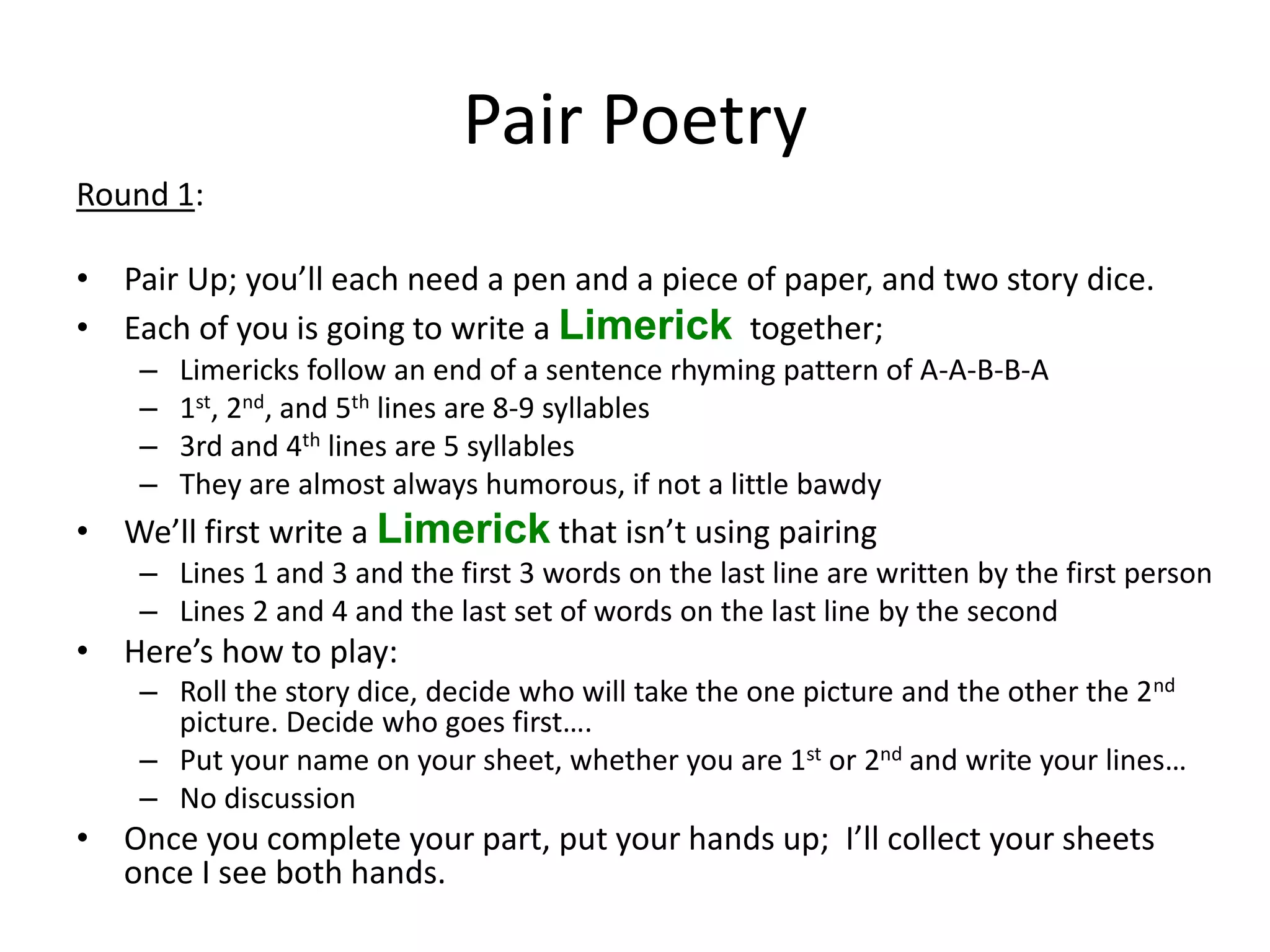

Pair Poetry Round 1: • Pair Up; you’ll each need a pen and a piece of paper, and two story dice. • Each of you is going to write a Limerick together; – Limericks follow an end of a sentence rhyming pattern of A-A-B-B-A – 1st, 2nd, and 5th lines are 8-9 syllables – 3rd and 4th lines are 5 syllables – They are almost always humorous, if not a little bawdy • We’ll first write a Limerick that isn’t using pairing – Lines 1 and 3 and the first 3 words on the last line are written by the first person – Lines 2 and 4 and the last set of words on the last line by the second • Here’s how to play: – Roll the story dice, decide who will take the one picture and the other the 2nd picture. Decide who goes first…. – Put your name on your sheet, whether you are 1st or 2nd and write your lines… – No discussion • Once you complete your part, put your hands up; I’ll collect your sheets once I see both hands.

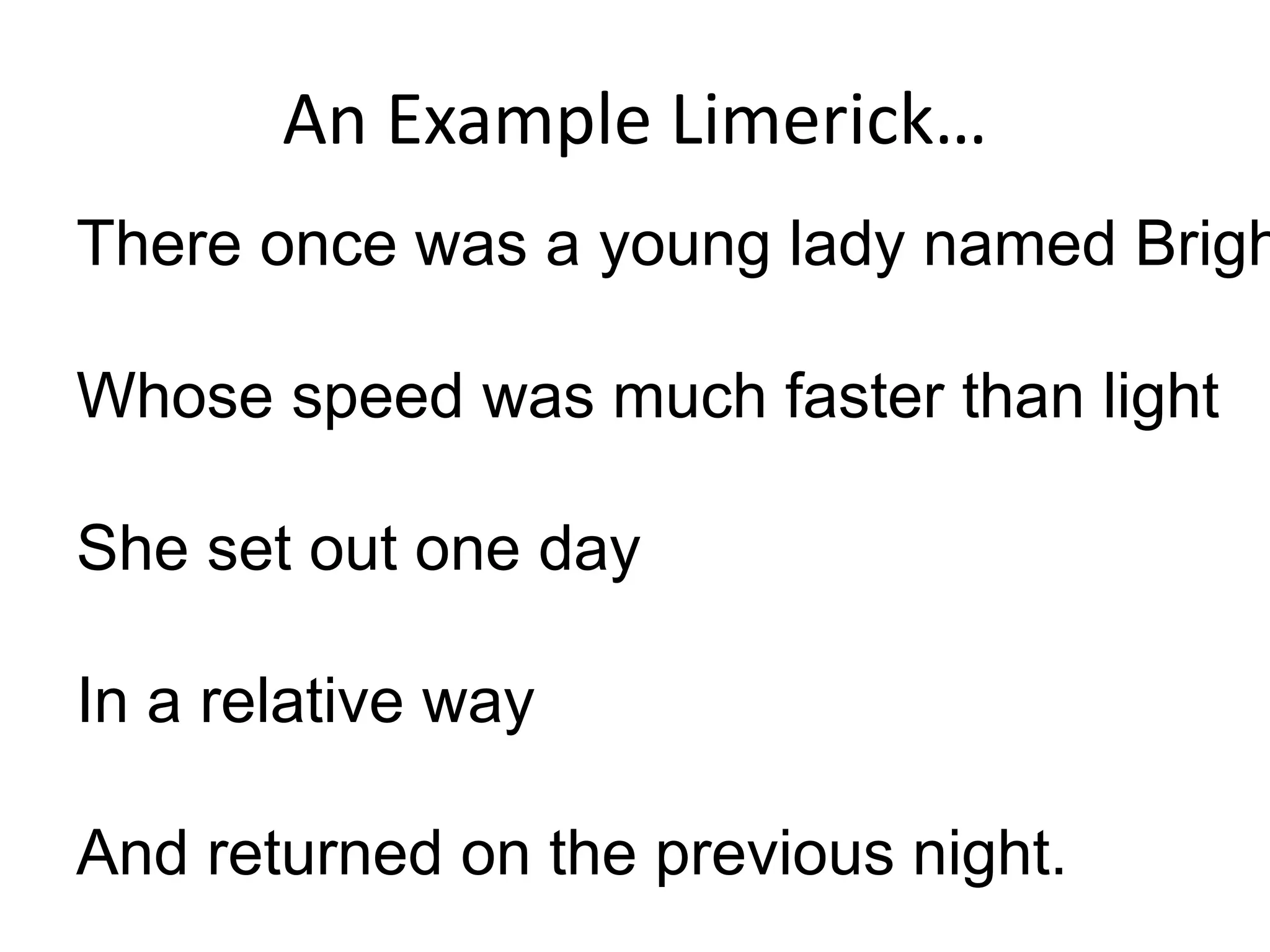

An Example Limerick… There once was a young lady named Bright Whose speed was much faster than light She set out one day In a relative way And returned on the previous night.

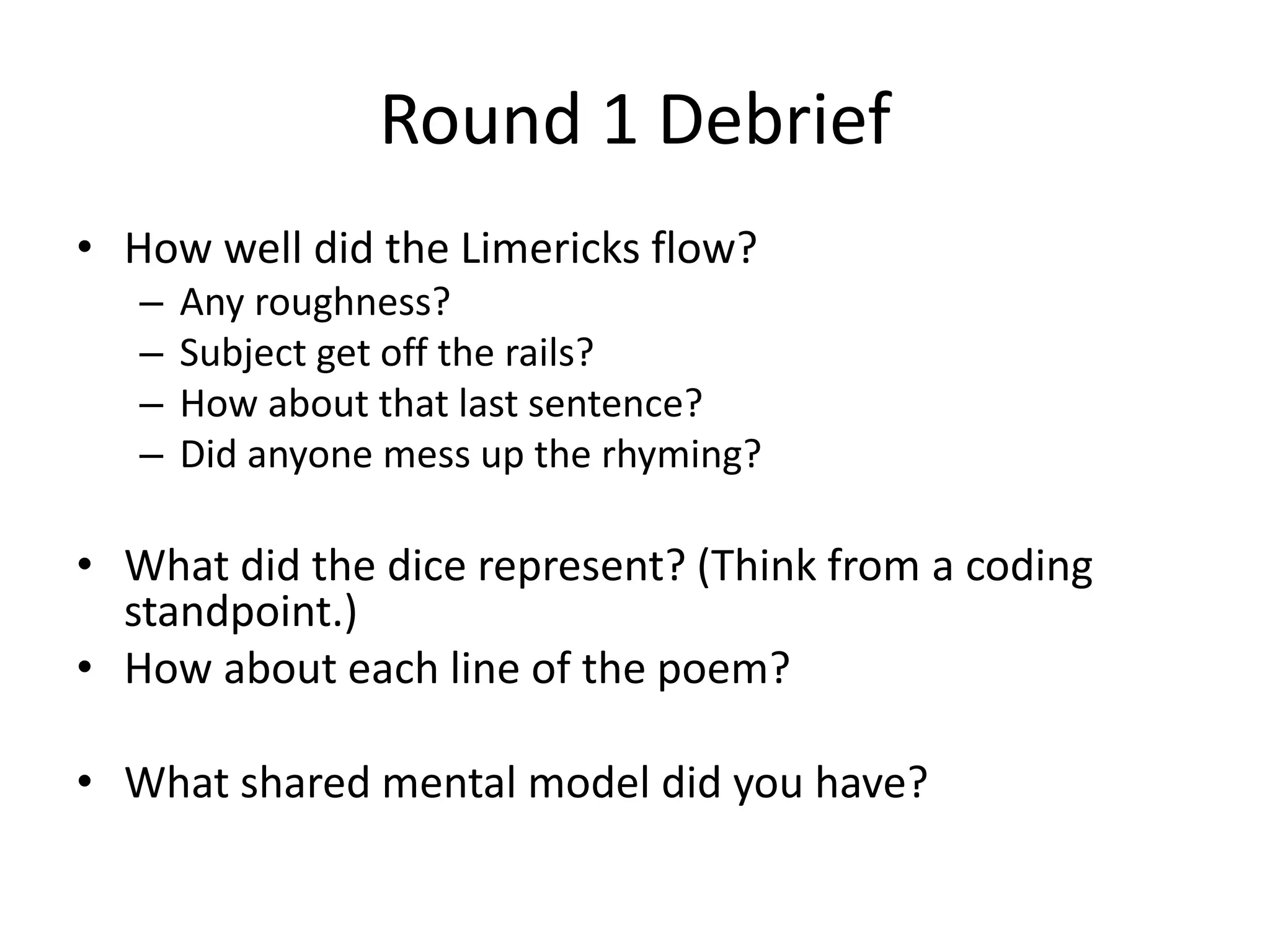

Round 1 Debrief • How well did the Limericks flow? – Any roughness? – Subject get off the rails? – How about that last sentence? – Did anyone mess up the rhyming? • What did the dice represent? (Think from a coding standpoint.) • How about each line of the poem? • What shared mental model did you have?

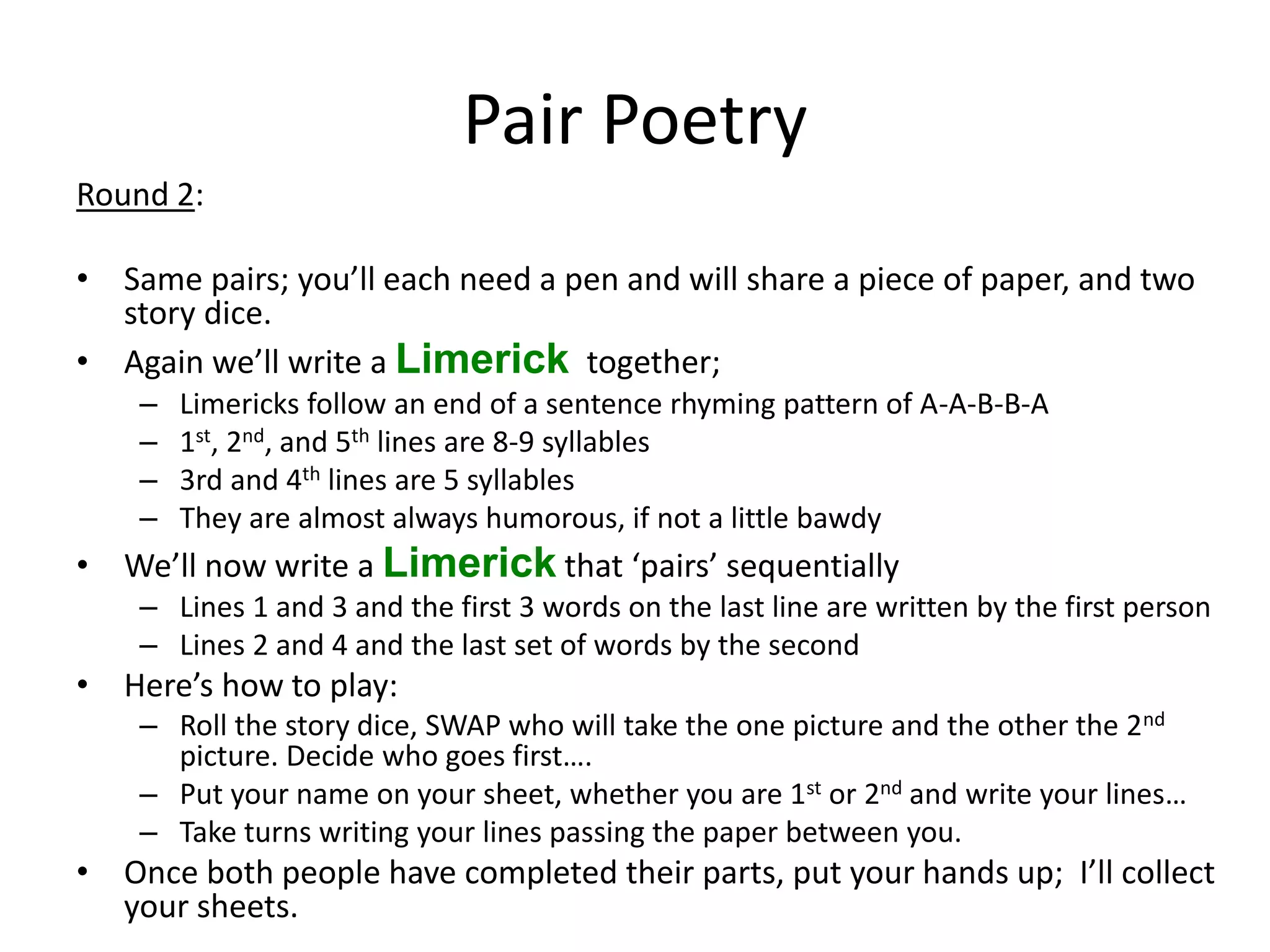

Pair Poetry Round 2: • Same pairs; you’ll each need a pen and will share a piece of paper, and two story dice. • Again we’ll write a Limerick together; – Limericks follow an end of a sentence rhyming pattern of A-A-B-B-A – 1st, 2nd, and 5th lines are 8-9 syllables – 3rd and 4th lines are 5 syllables – They are almost always humorous, if not a little bawdy • We’ll now write a Limerick that ‘pairs’ sequentially – Lines 1 and 3 and the first 3 words on the last line are written by the first person – Lines 2 and 4 and the last set of words by the second • Here’s how to play: – Roll the story dice, SWAP who will take the one picture and the other the 2nd picture. Decide who goes first…. – Put your name on your sheet, whether you are 1st or 2nd and write your lines… – Take turns writing your lines passing the paper between you. • Once both people have completed their parts, put your hands up; I’ll collect your sheets.

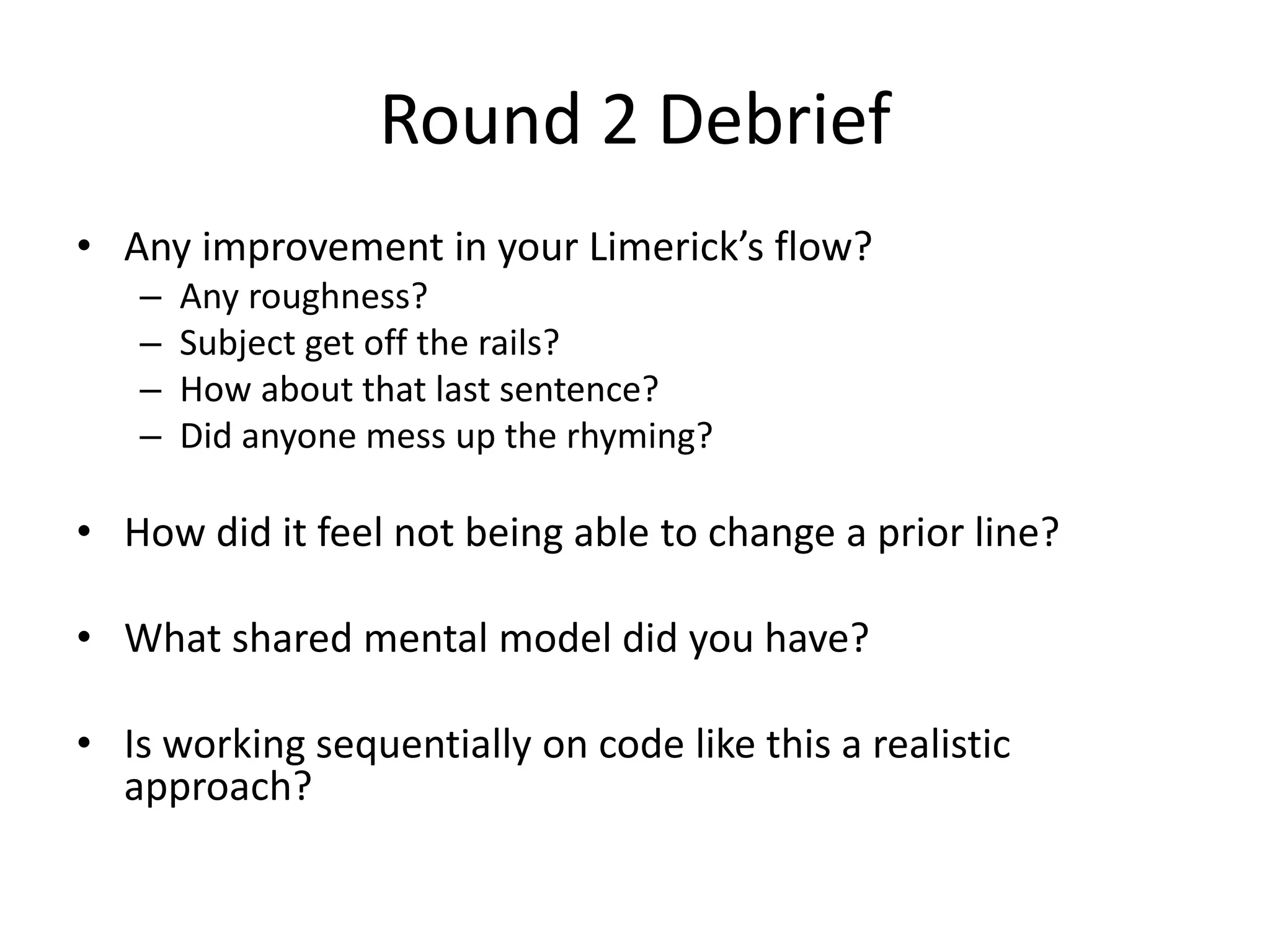

Round 2 Debrief • Any improvement in your Limerick’s flow? – Any roughness? – Subject get off the rails? – How about that last sentence? – Did anyone mess up the rhyming? • How did it feel not being able to change a prior line? • What shared mental model did you have? • Is working sequentially on code like this a realistic approach?
Pair Poetry Round 3: • Same pairs; you’ll each need only ONE pen and ONE piece of paper, and two story dice. • Again we’ll write a Limerick together; – Limericks follow an end of a sentence rhyming pattern of A-A-B-B-A – 1st, 2nd, and 5th lines are 8-9 syllables – 3rd and 4th lines are 5 syllables – They are almost always humorous, if not a little bawdy • We’ll now write a Limerick that pairs fully – Either of you can write, the other can comment, critique, provide input, etc. – You can also REQUEST THE PEN! – Change any line/word you want as long as both people agree • Here’s how to play: – Roll the story dice, use these two pictures when writing your Limerick – Put both your names on your sheet and write your lines together… • Once it is complete, put your hands up; I’ll collect your sheets.

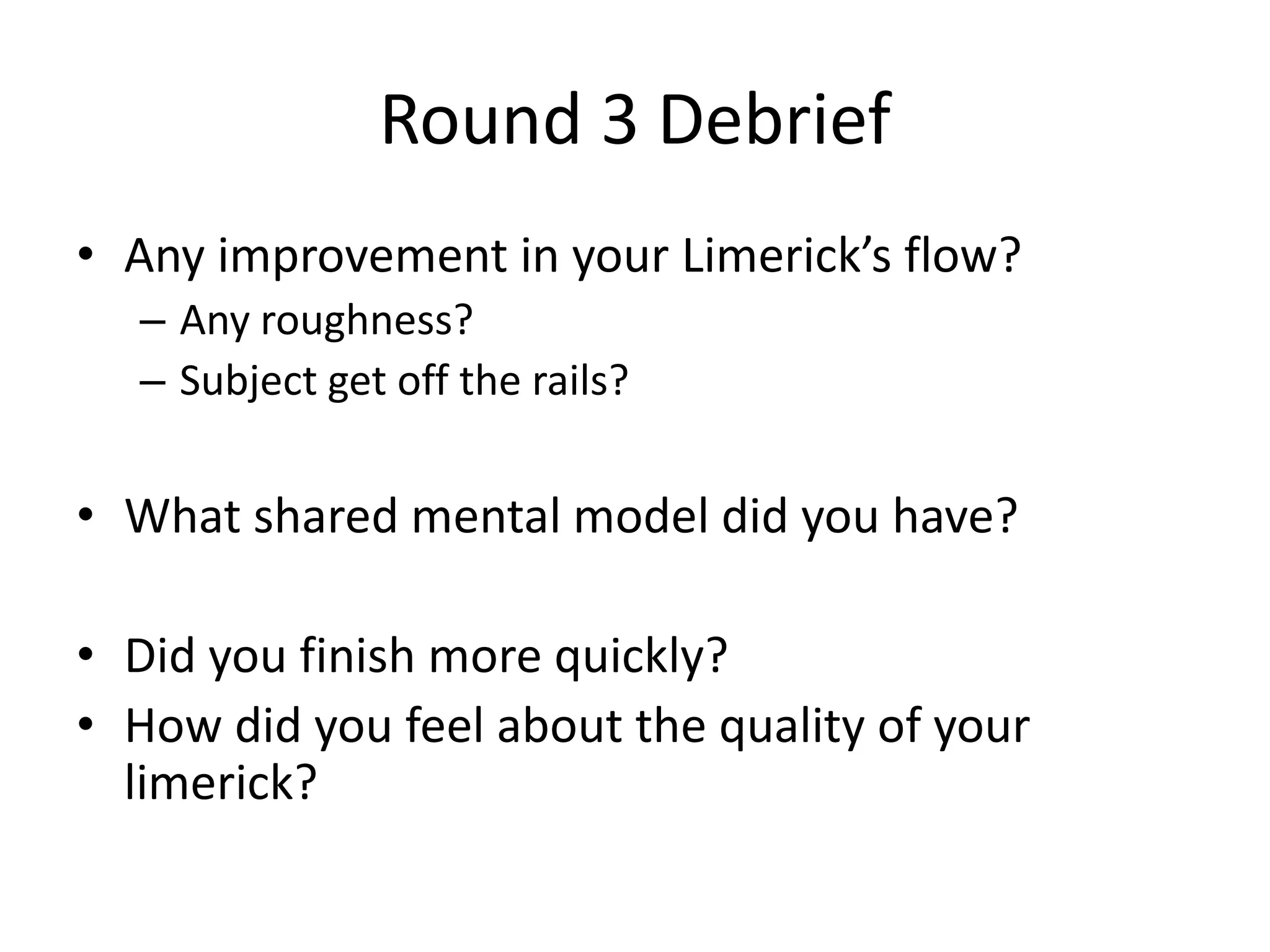

Round 3 Debrief • Any improvement in your Limerick’s flow? – Any roughness? – Subject get off the rails? • What shared mental model did you have? • Did you finish more quickly? • How did you feel about the quality of your limerick?
Beyond Pairs… Try Triads! Dev  Tester  Dev Dev  BA  Dev Dev  PO/SME  Tester Dev  Tester  BA
Some Tools for Remote Pairing • RealVNC • TeamViewer • Windows Remote Desktop • AeroAdmin • Chrome Remote Desktop • Remote Utilities • join.me • BeamYourScreen
Time for a break…
#3 Continuous Integration

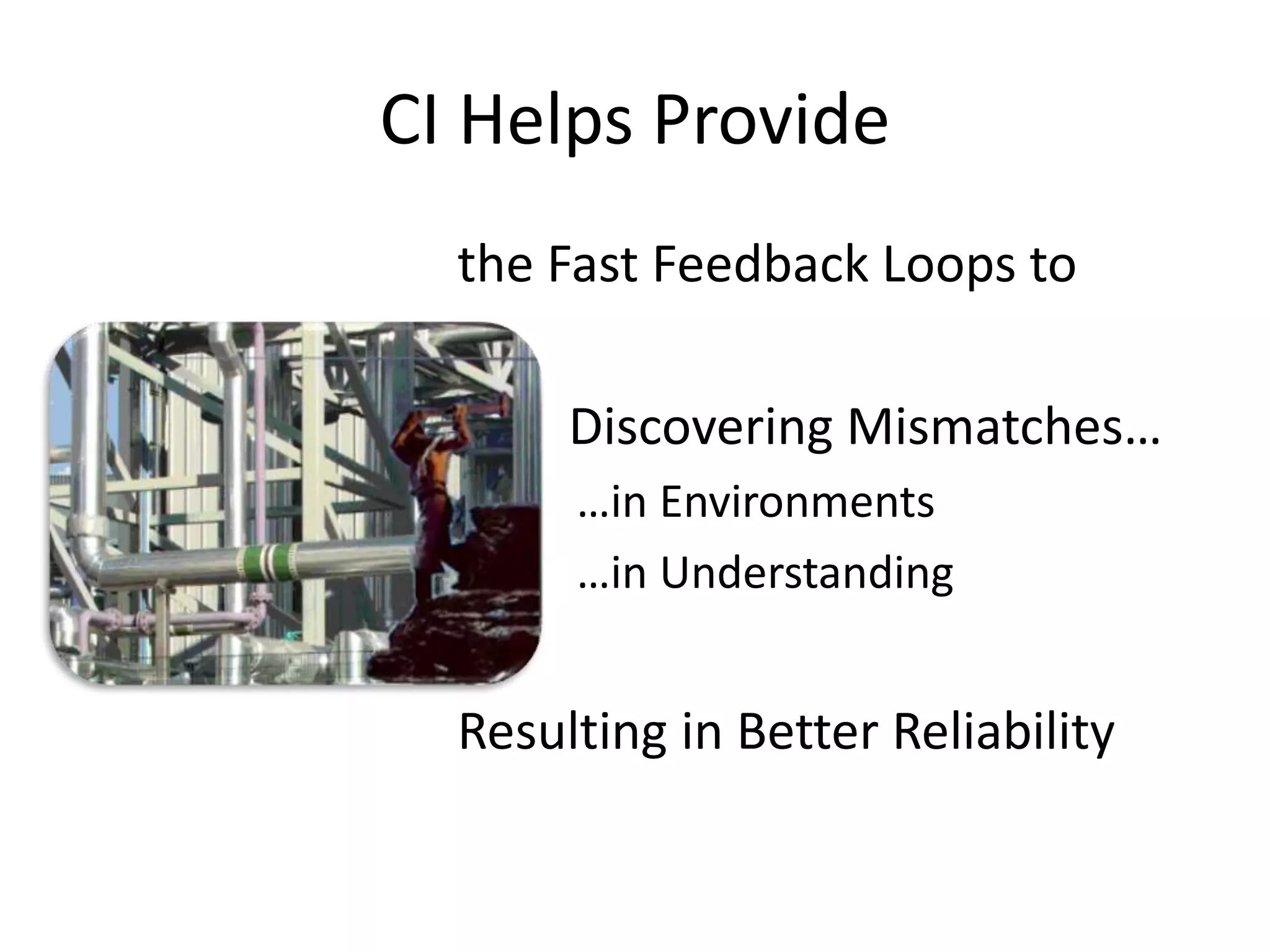

CI Helps Provide the Fast Feedback Loops to Discovering Mismatches… …in Environments …in Understanding Resulting in Better Reliability

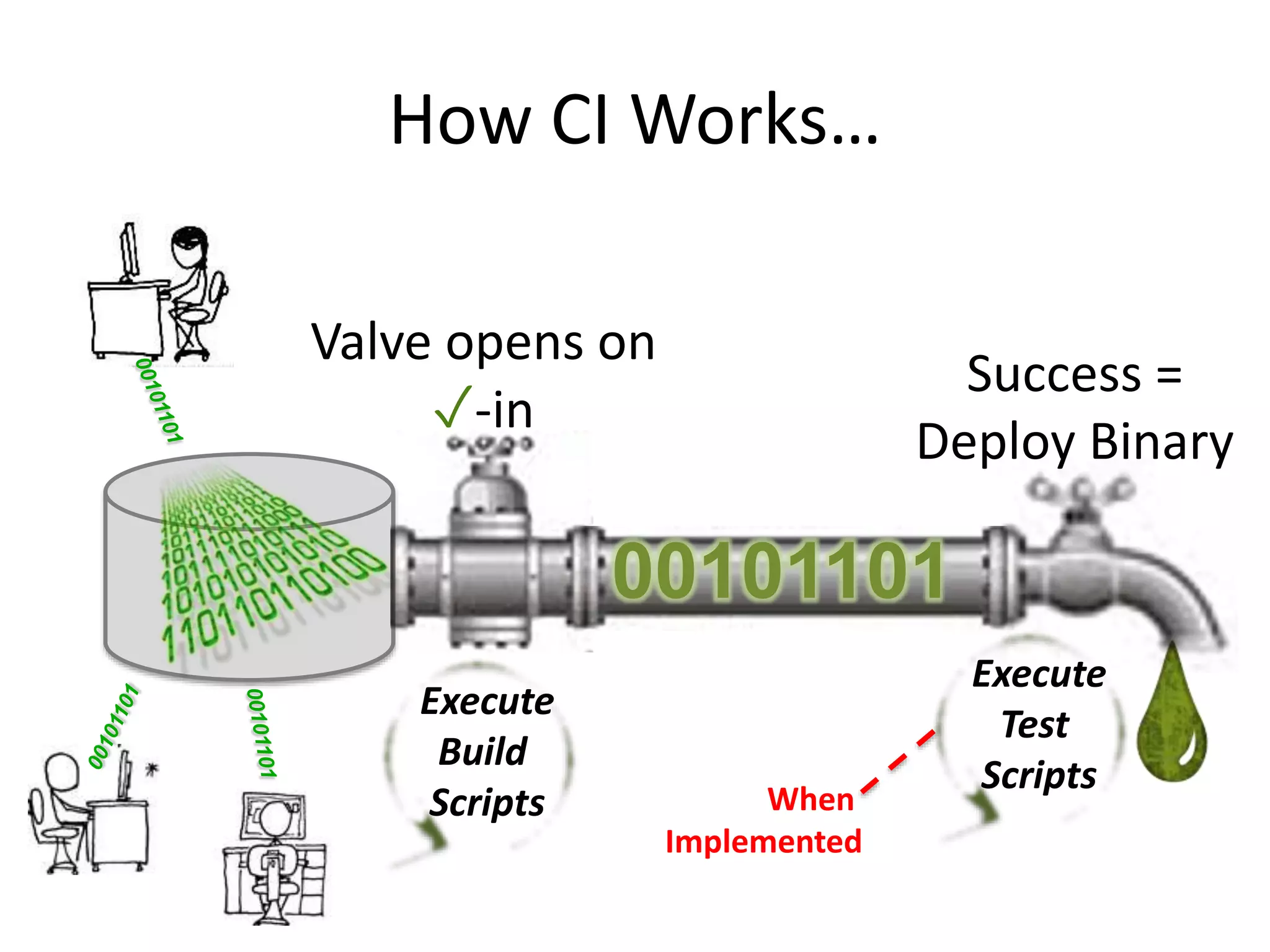

How CI Works… Valve opens on 00101101 ✓-in Success = Deploy Binary When Implemented Execute Build Scripts Execute Test Scripts
Continuous Integration with

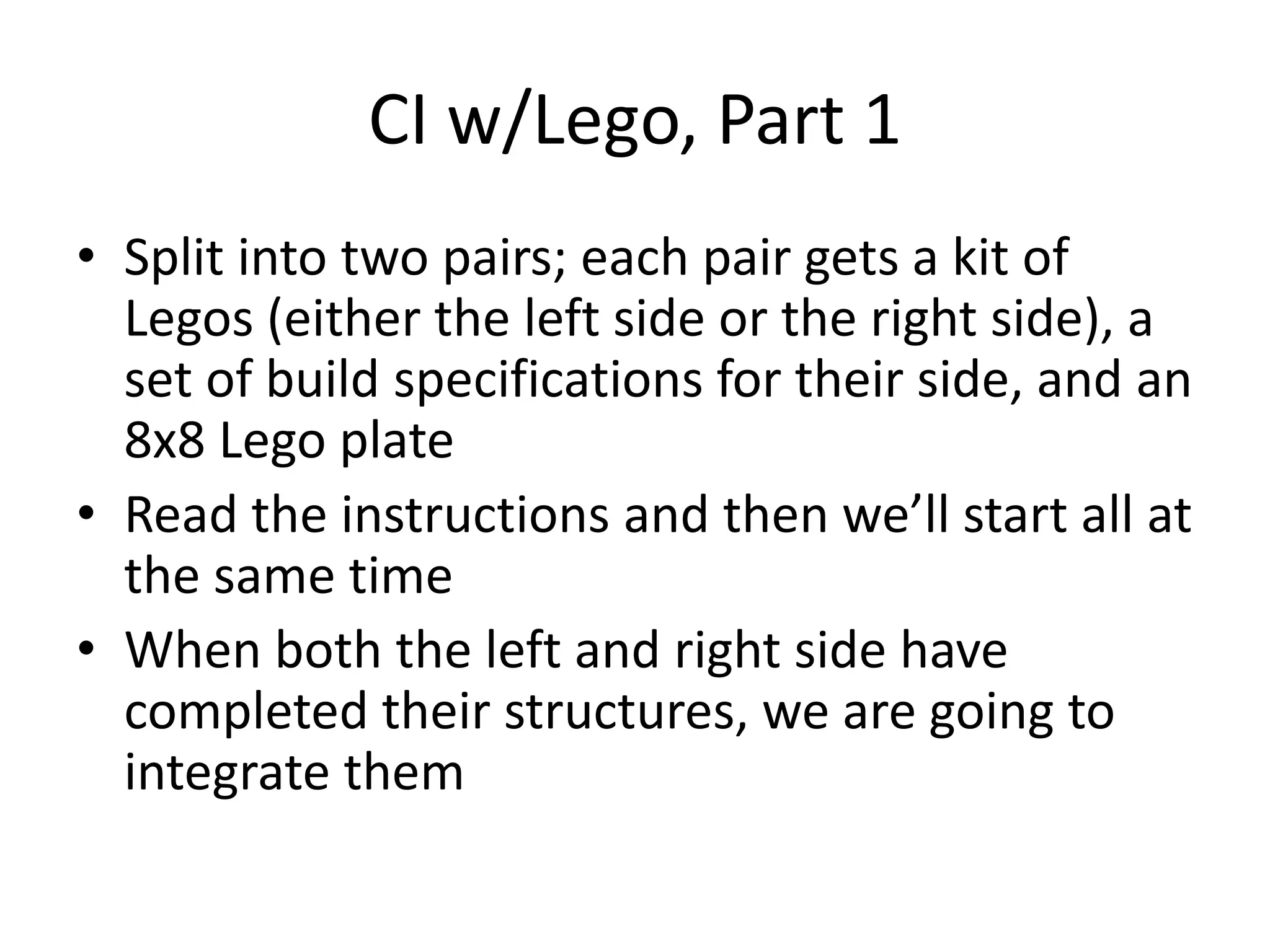

CI w/Lego, Part 1 • Split into two pairs; each pair gets a kit of Legos (either the left side or the right side), a set of build specifications for their side, and an 8x8 Lego plate • Read the instructions and then we’ll start all at the same time • When both the left and right side have completed their structures, we are going to integrate them

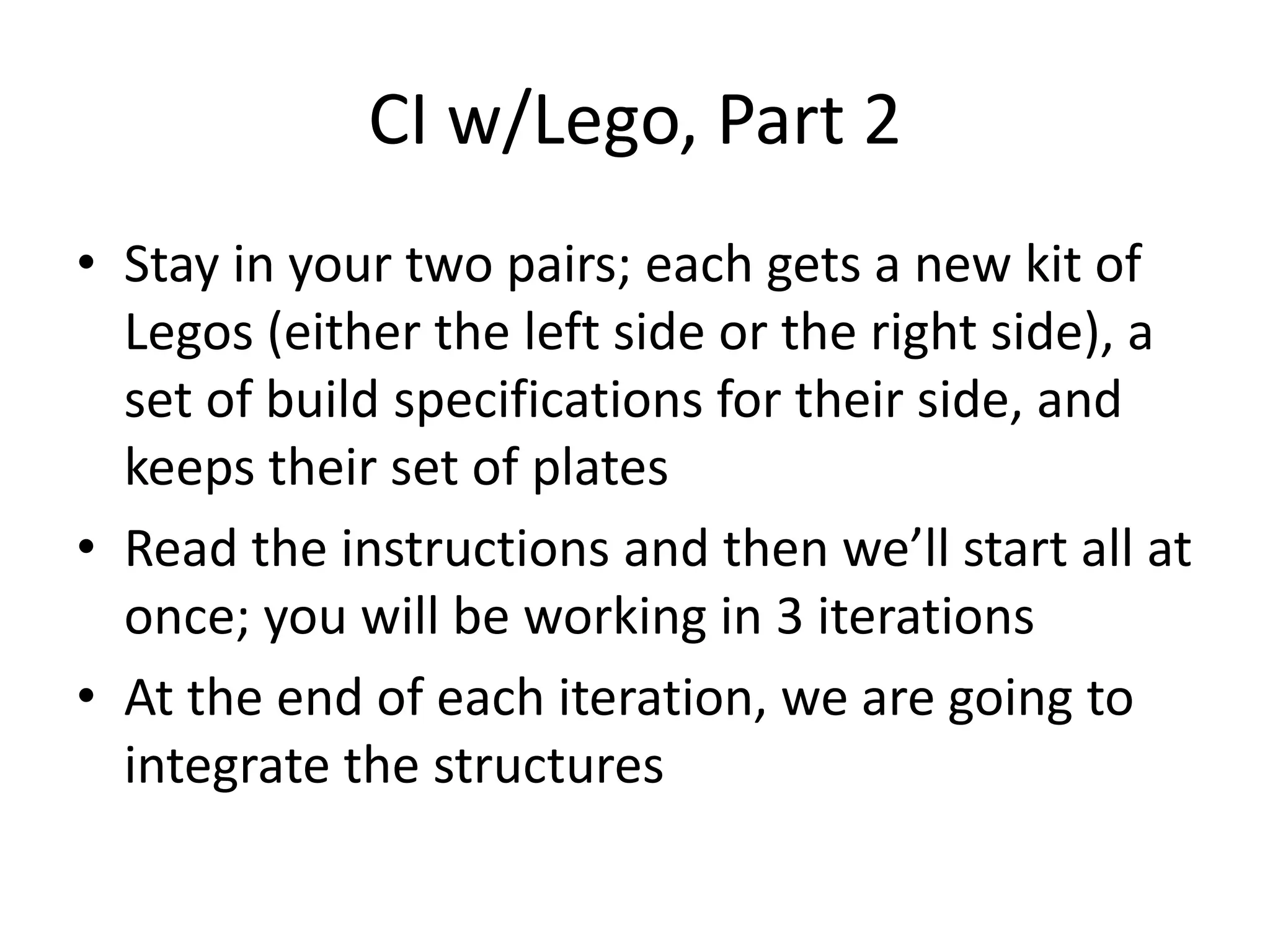

CI w/Lego, Part 2 • Stay in your two pairs; each gets a new kit of Legos (either the left side or the right side), a set of build specifications for their side, and keeps their set of plates • Read the instructions and then we’ll start all at once; you will be working in 3 iterations • At the end of each iteration, we are going to integrate the structures
Debrief
#4 Continuous Testing

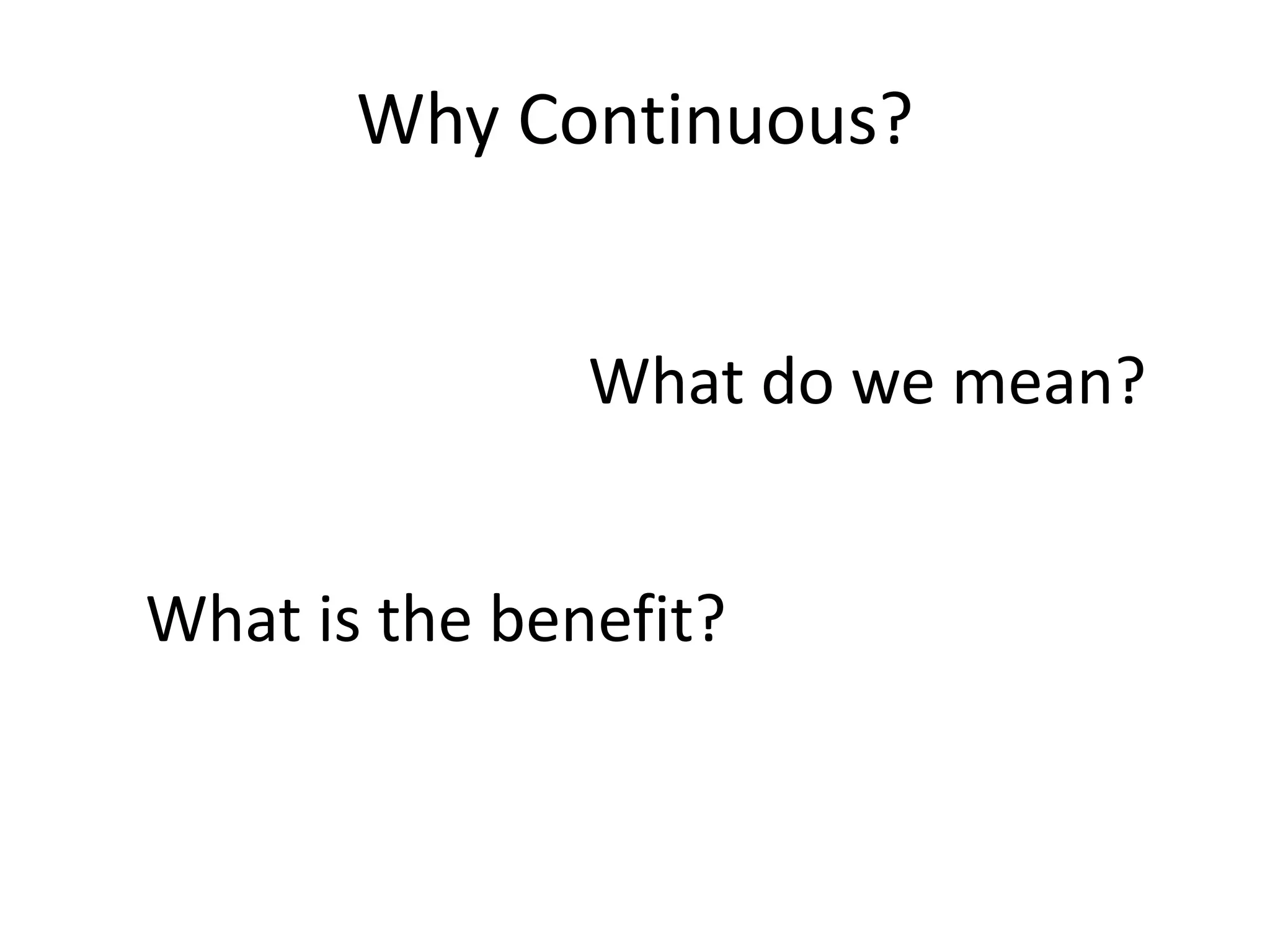

Why Continuous? What do we mean? What is the benefit?
Agile Jenga :: Let’s Get Started • Separate into pairs • Each pair takes a pair of dice (one red, one white), and a set of Jenga blocks; these are numbered. (Some pair may get the more challenging Jenga Extreme blocks…) • Decide who will be the developer and who will be the tester • You will need a small sheet of paper and a pen

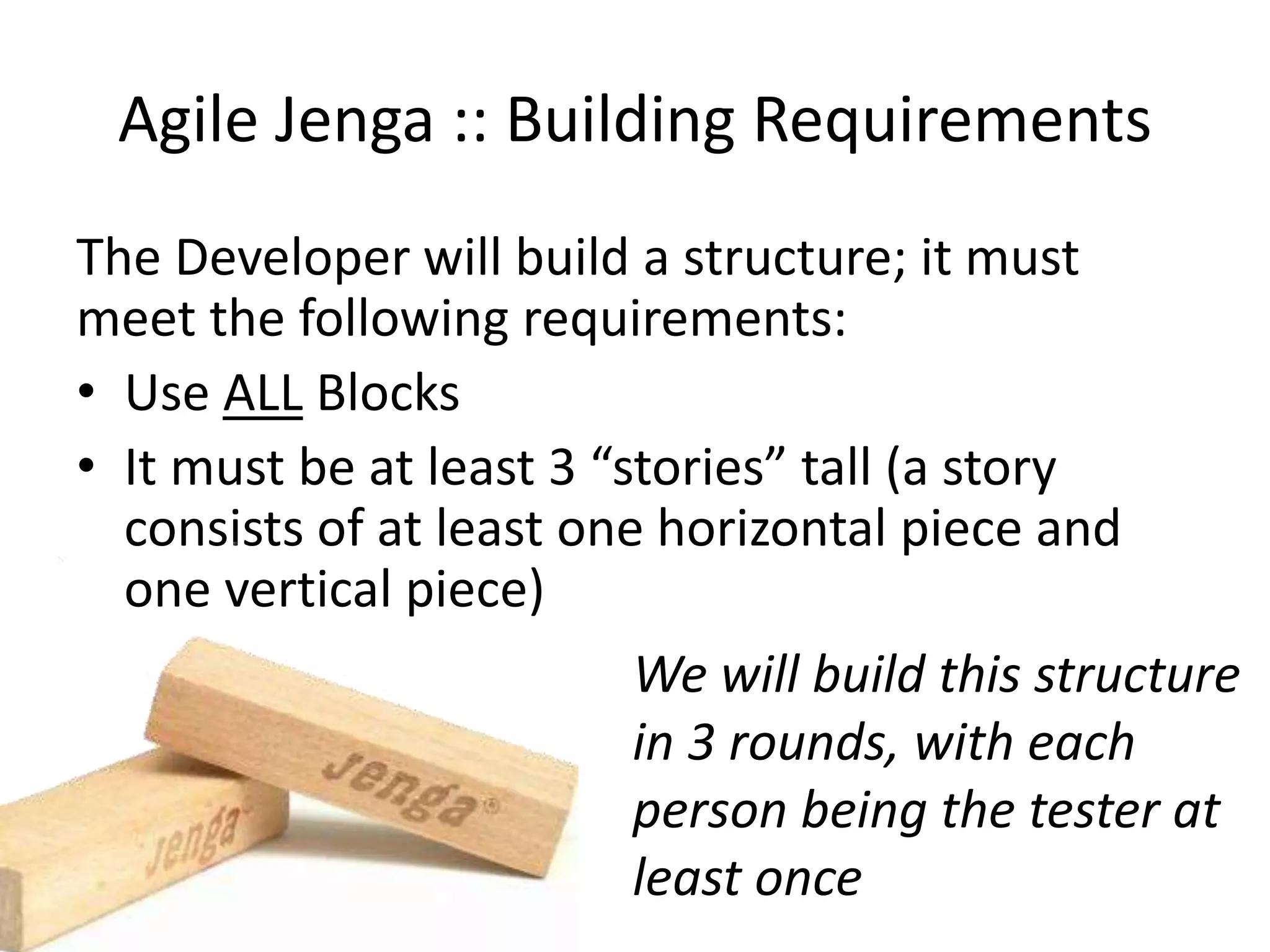

Agile Jenga :: Building Requirements The Developer will build a structure; it must meet the following requirements: • Use ALL Blocks • It must be at least 3 “stories” tall (a story consists of at least one horizontal piece and one vertical piece) We will build this structure in 3 rounds, with each person being the tester at least once

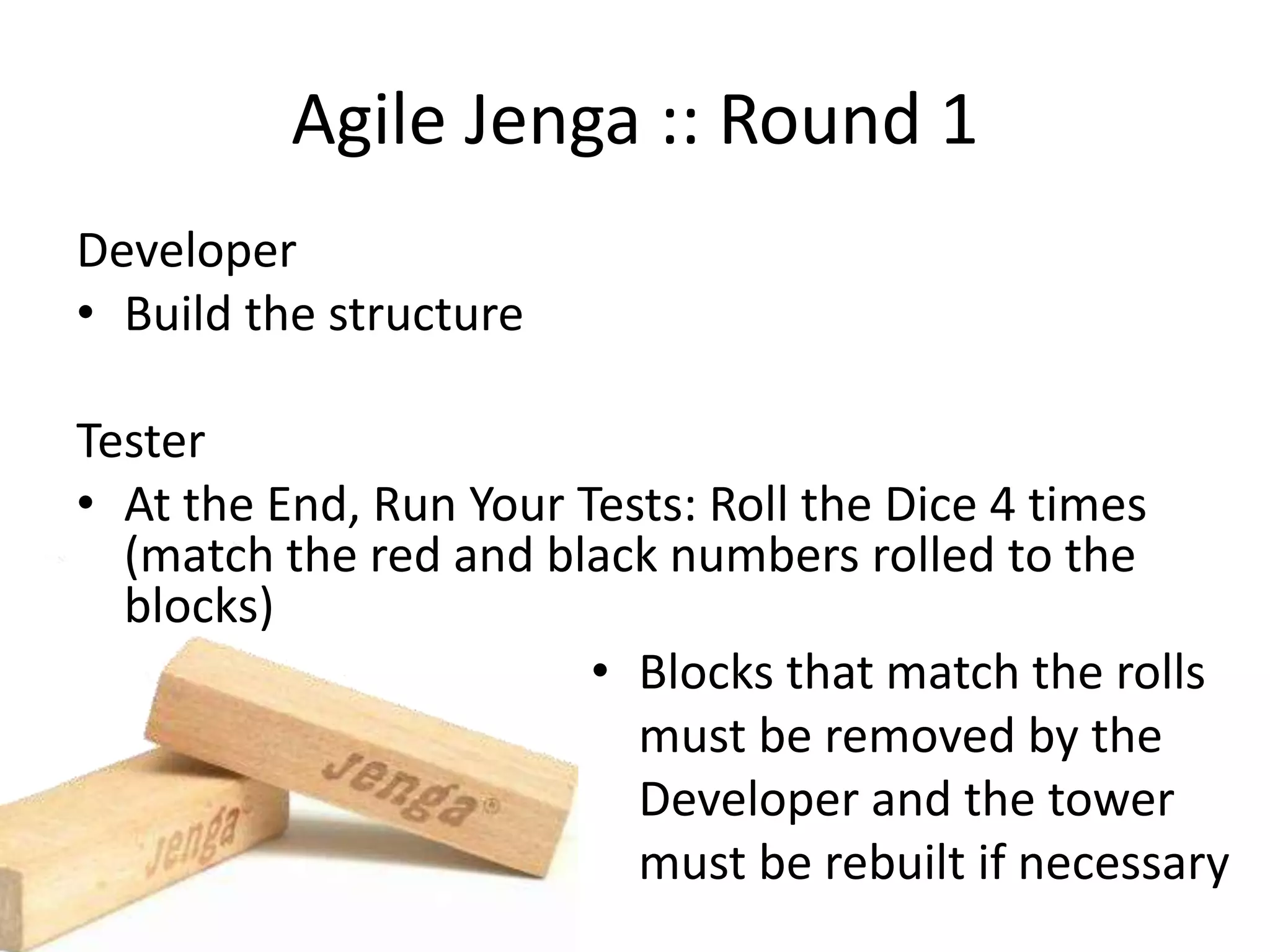

Agile Jenga :: Round 1 Developer • Build the structure Tester • At the End, Run Your Tests: Roll the Dice 4 times (match the red and black numbers rolled to the blocks) • Blocks that match the rolls must be removed by the Developer and the tower must be rebuilt if necessary

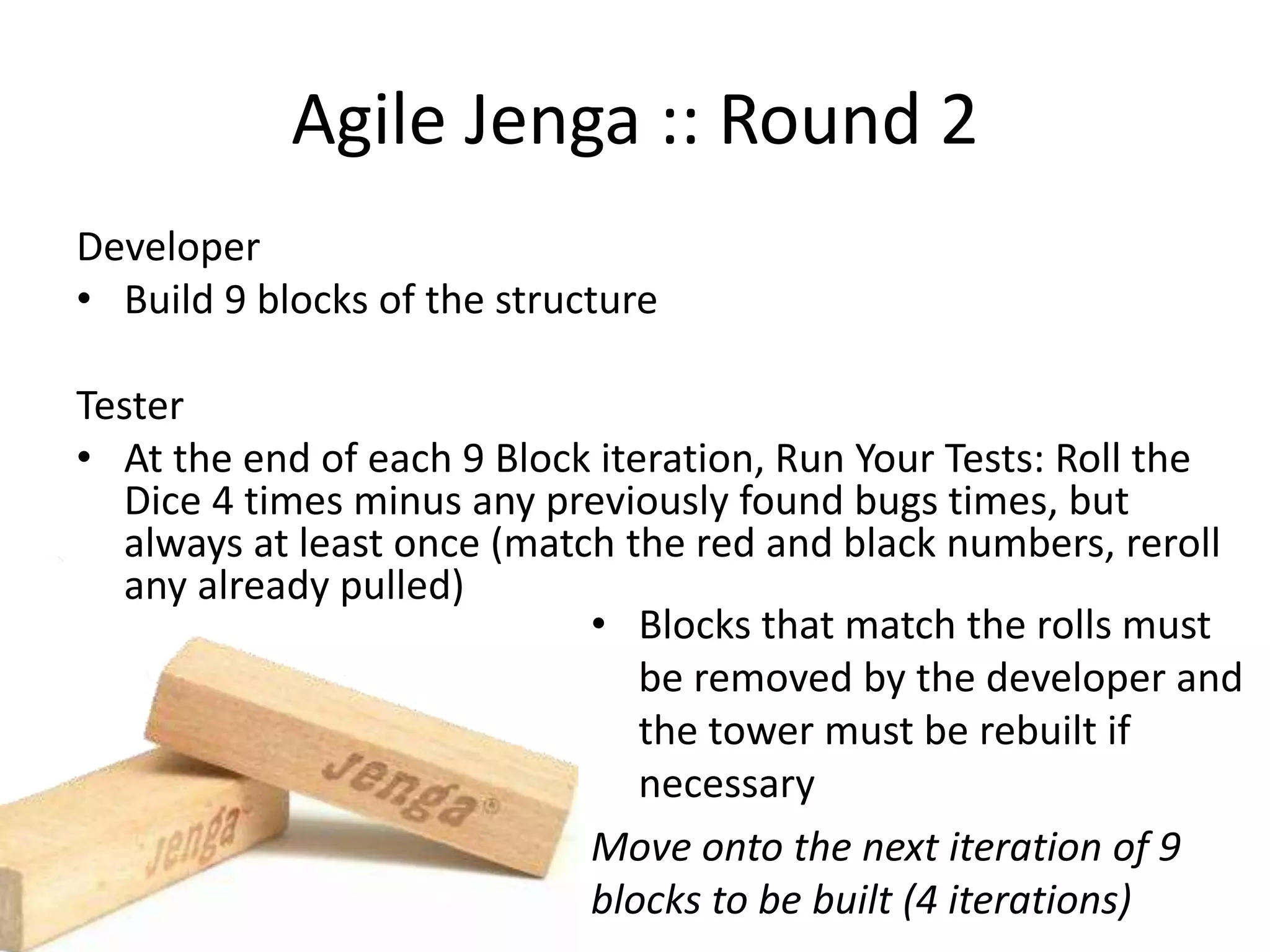

Agile Jenga :: Round 2 Developer • Build 9 blocks of the structure Tester • At the end of each 9 Block iteration, Run Your Tests: Roll the Dice 4 times minus any previously found bugs times, but always at least once (match the red and black numbers, reroll any already pulled) • Blocks that match the rolls must be removed by the developer and the tower must be rebuilt if necessary Move onto the next iteration of 9 blocks to be built (4 iterations)
Agile Jenga :: Round 3 Tester • At the Start, Run Your Tests: Roll the Dice 4 times and record the numbers (reroll if any have been previously removed); keep these “private” Developer • Select and build 9 blocks of the structure Tester • As the structure is built, remove any matching numbered blocks as you see them Move onto the next iteration of 9 blocks to be built (4 iterations)
Agile Jenga - Debrief -

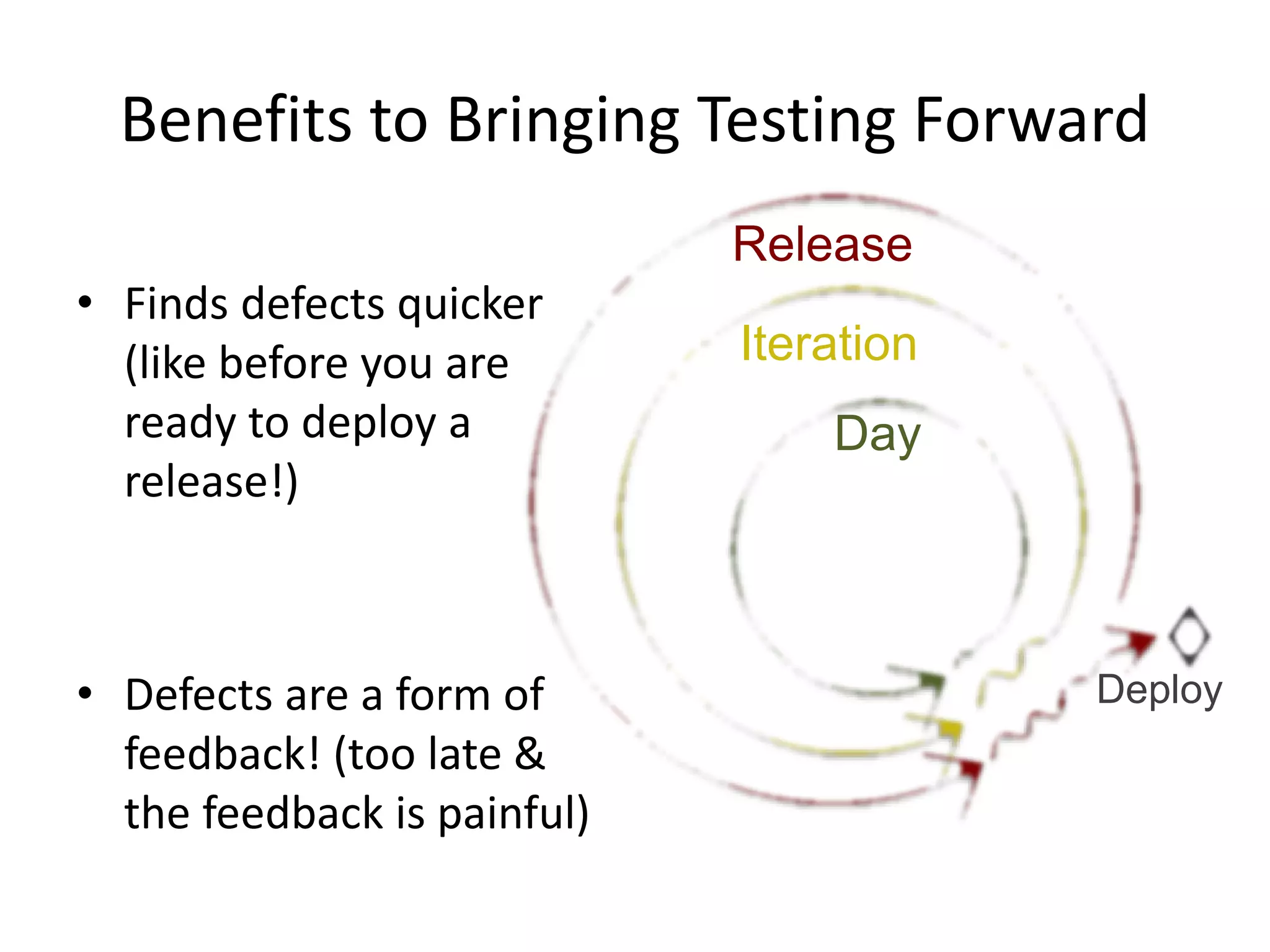

Benefits to Bringing Testing Forward Release Iteration Day • Finds defects quicker (like before you are ready to deploy a release!) • Defects are a form of feedback! (too late & the feedback is painful) Deploy
Test to Specification Test to Failure Product Design Technical Design Interaction Design Acceptance (Functional) Tests xUnit Tests UI Tests Exploratory Testing Stress Testing Security Testing Usability Testing (A/B Testing) Finite, Repeatable, Automated Environmental, Less Automated Diagram concept from p.76, Leading Lean Development, Mary & Tom Poppendieck, 2010 A Full Complement of Tests
Take a break! You have starting now… 5 Minutes

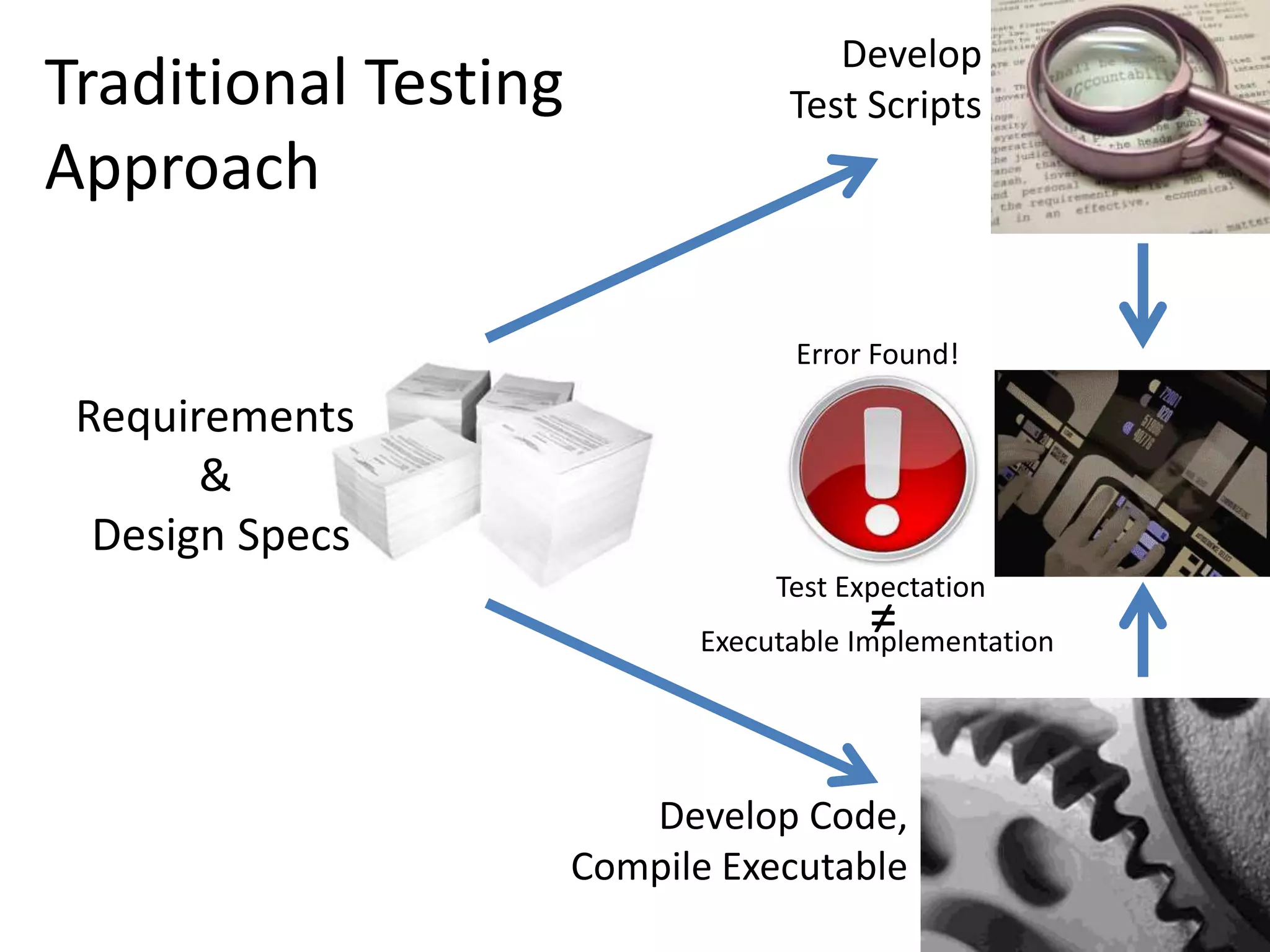

Traditional Testing Approach Requirements & Design Specs Develop Test Scripts Error Found! Execute Test Scripts Test Expectation ≠ Executable Implementation Develop Code, Compile Executable
WTF We’re supposed to be releasing next week and you tell me this isn’t working? Get that bug fixed!
The objective is to kill bugs quickly, but to AVOID them altogether!

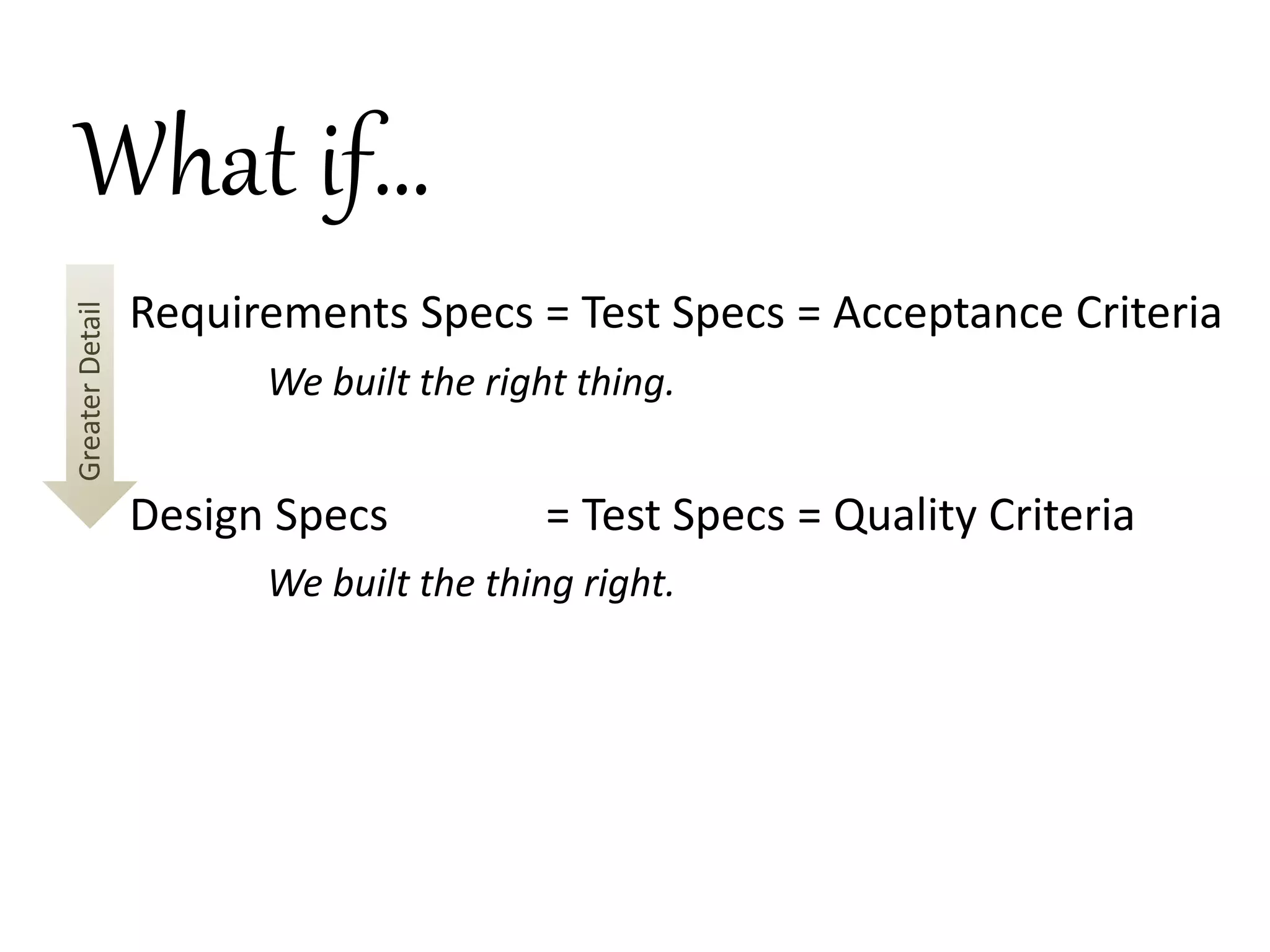

What if… Requirements Specs = Test Specs = Acceptance Criteria We built the right thing. Design Specs = Test Specs = Quality Criteria We built the thing right. Greater Detail

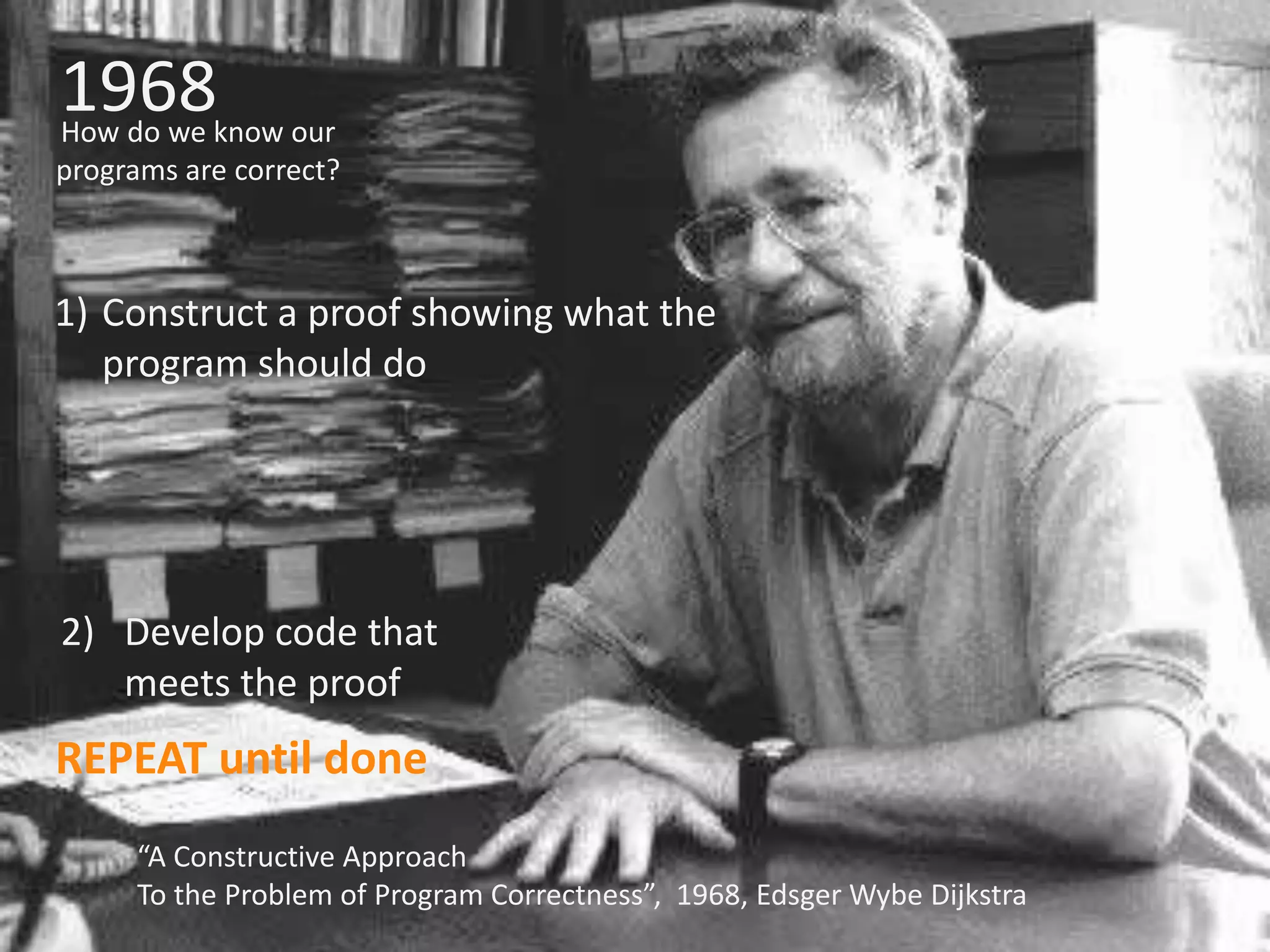

1968 How do we know our programs are correct? 1) Construct a proof showing what the program should do 2) Develop code that meets the proof REPEAT until done “A Constructive Approach To the Problem of Program Correctness”, 1968, EdsgerWybe Dijkstra

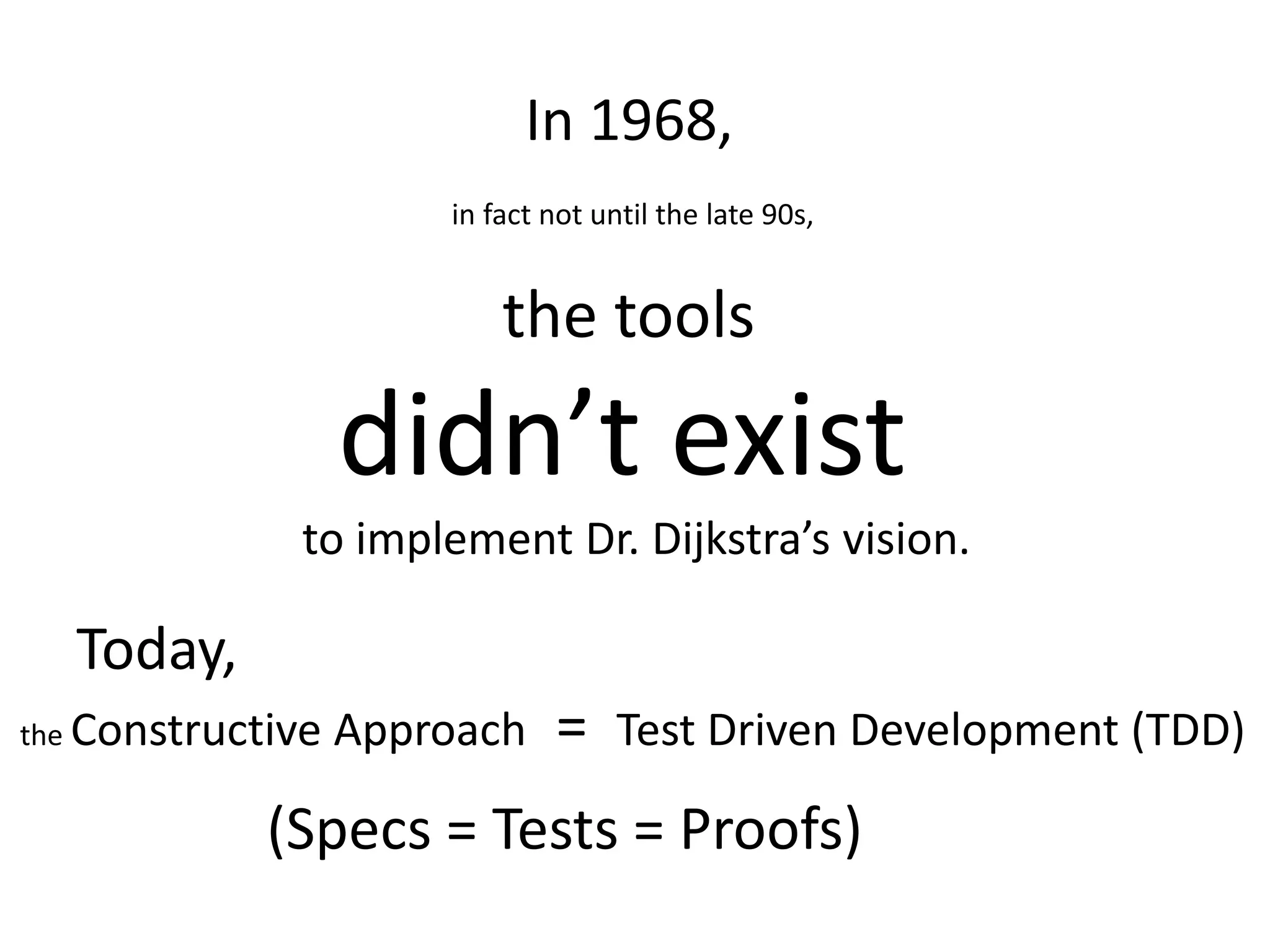

In 1968, in fact not until the late 90s, the tools didn’t exist to implement Dr. Dijkstra’s vision. Today, the Constructive Approach = Test Driven Development (TDD) (Specs = Tests = Proofs)

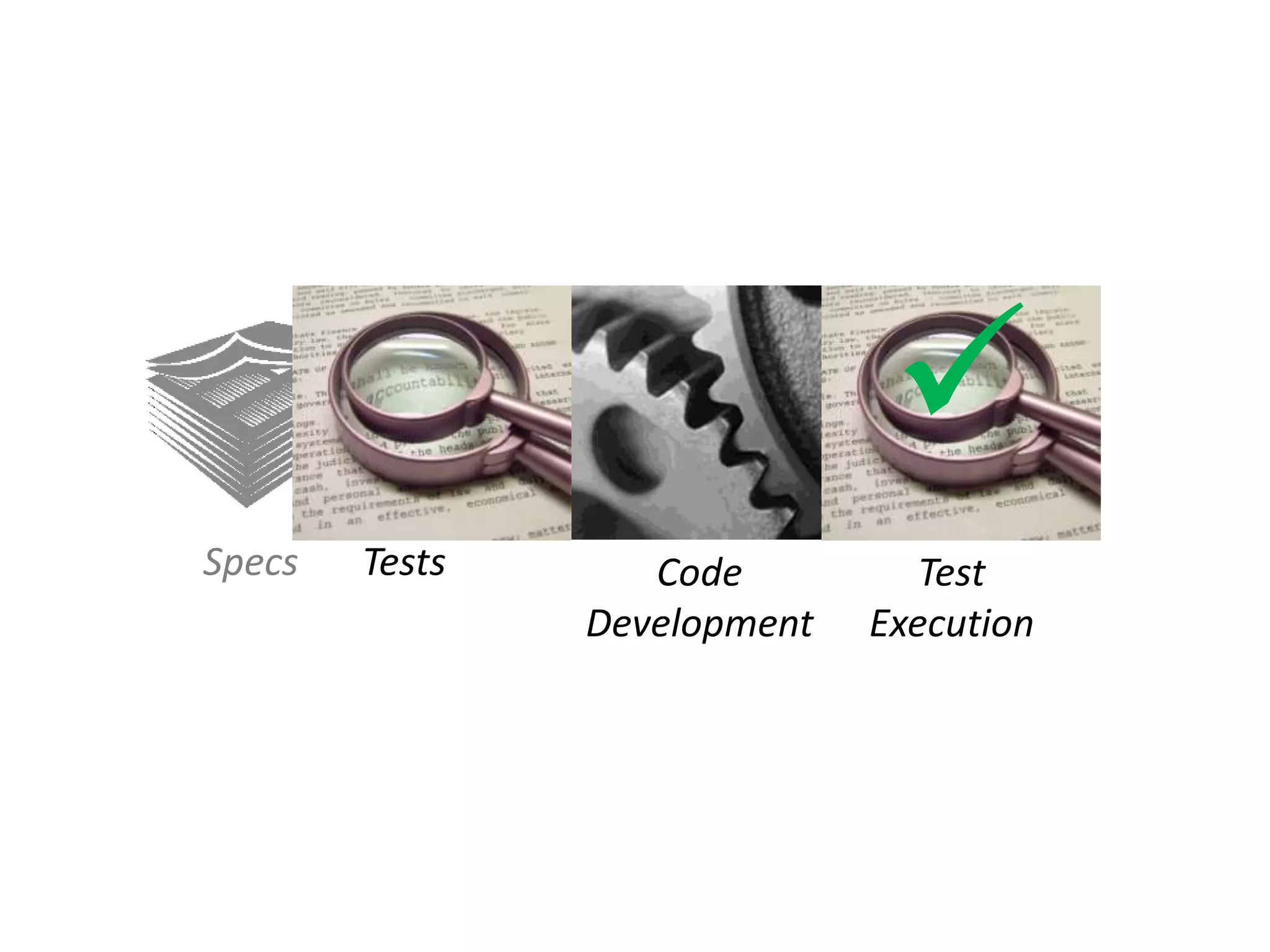

Specs Tests Code Development  Test Execution
Greater Detail Acceptance Tests  Stories/Functions Mark as ready for test when completed; based on Product Owner priority xUnit Tests  Specific Detailed Methods/Functions Test completed code

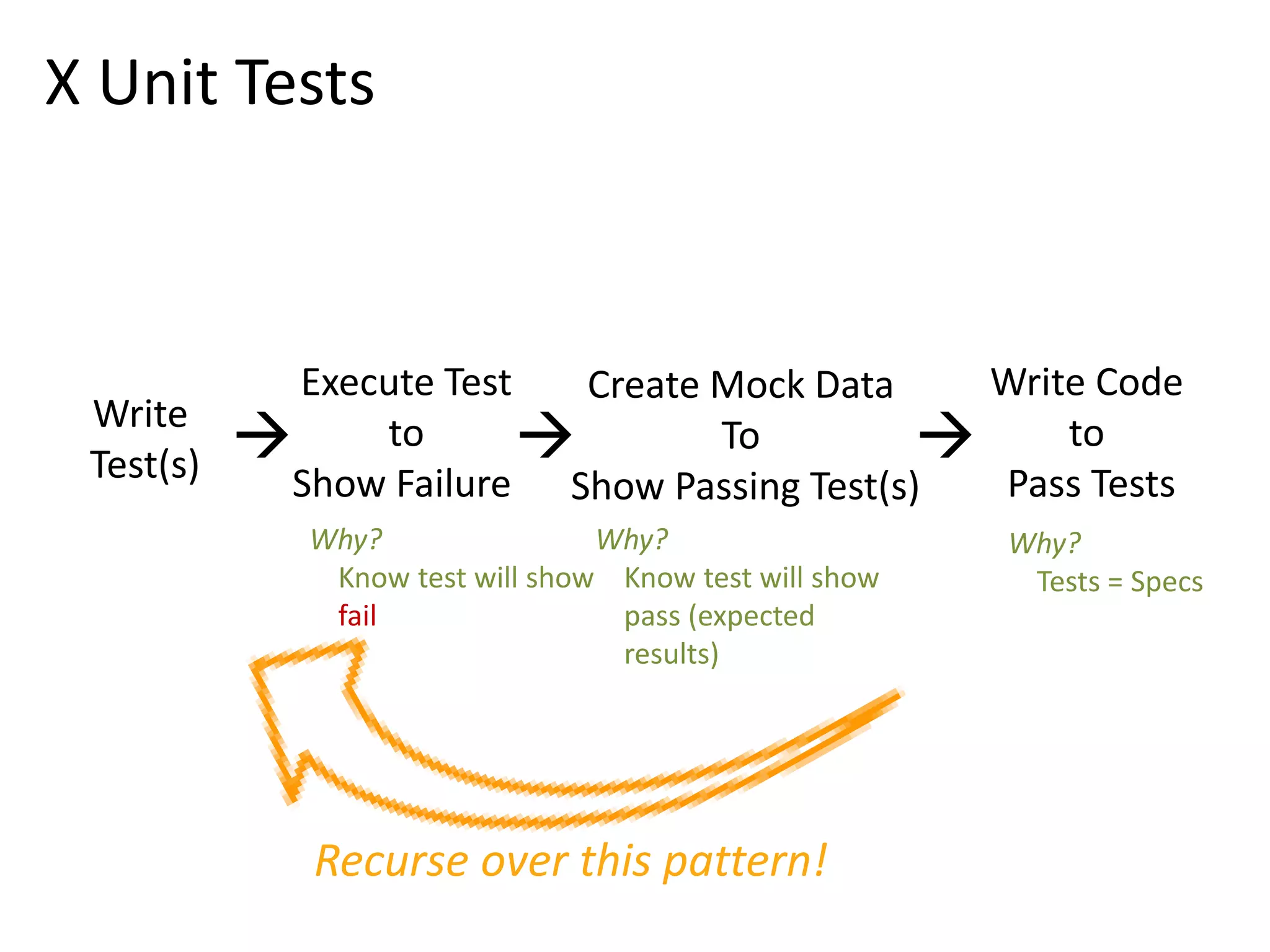

Write Test(s)  Execute Test to Show Failure Create Mock Data To Show Passing Test(s) Write Code to Pass Tests   Why? Know test will show fail Why? Tests = Specs X Unit Tests Why? Know test will show pass (expected results) Recurse over this pattern!
What does an xUnit Test look like? Say you've got a method, getName(String path) that parses a file name from a file path. You can write a JUnit test class to feed it a path and ensure that the results are what you expected. Simple example from jGuru.com

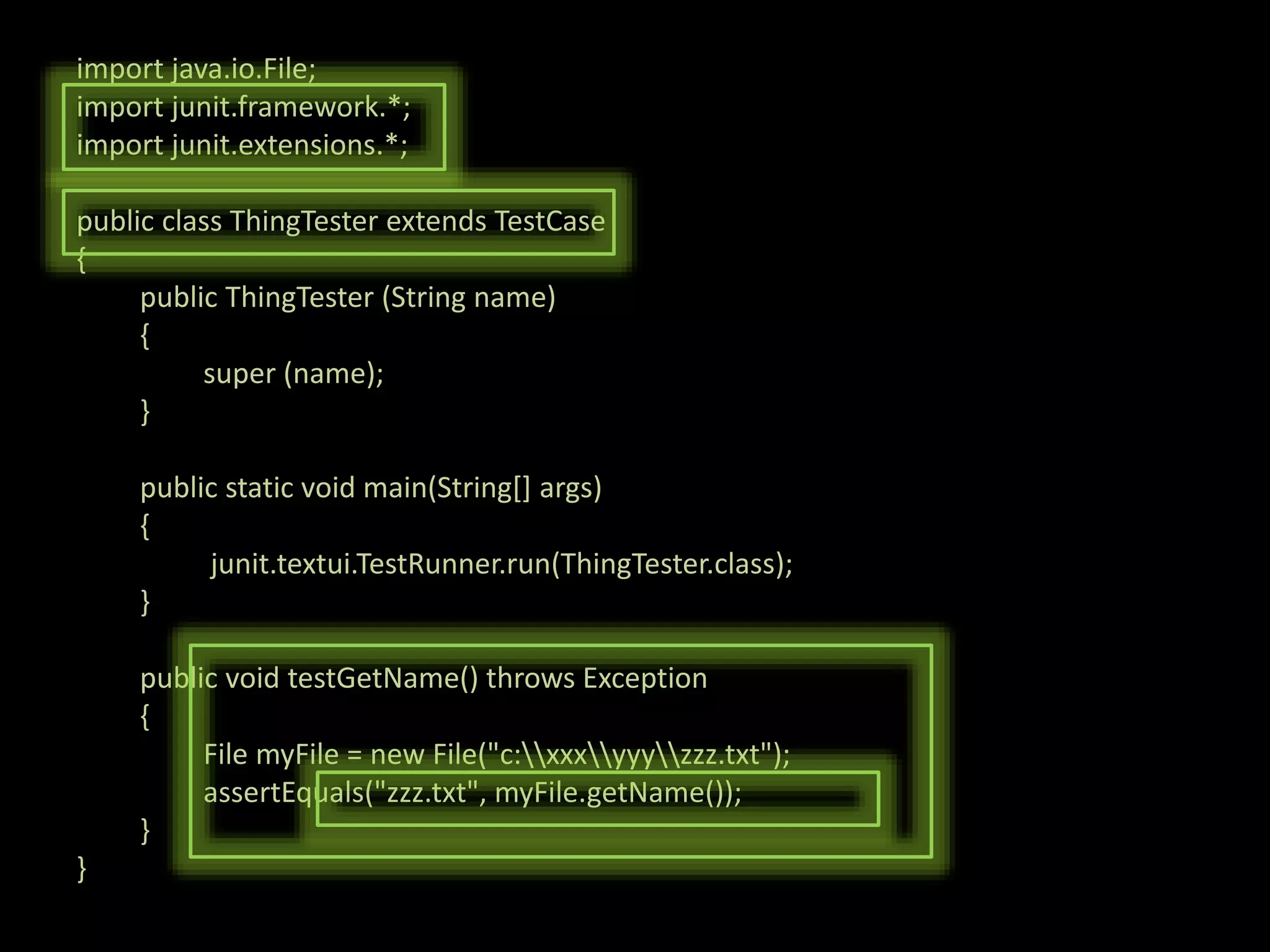

import java.io.File; import junit.framework.*; import junit.extensions.*; public class ThingTester extends TestCase { public ThingTester (String name) { super (name); } public static void main(String[] args) { junit.textui.TestRunner.run(ThingTester.class); } public void testGetName() throws Exception { File myFile = new File("c:xxxyyyzzz.txt"); assertEquals("zzz.txt", myFile.getName()); } }
To exercise the test: Compile & run ThingTester. • Little Dot = Passing Test; • Assertion Failure & Stack Trace = Failure & location • Write test code BEFORE program code used to make it pass. No problems? Add more test cases. Examples: long paths, files with spaces in the name, etc. Stop when you feel you have enough edge cases covered.

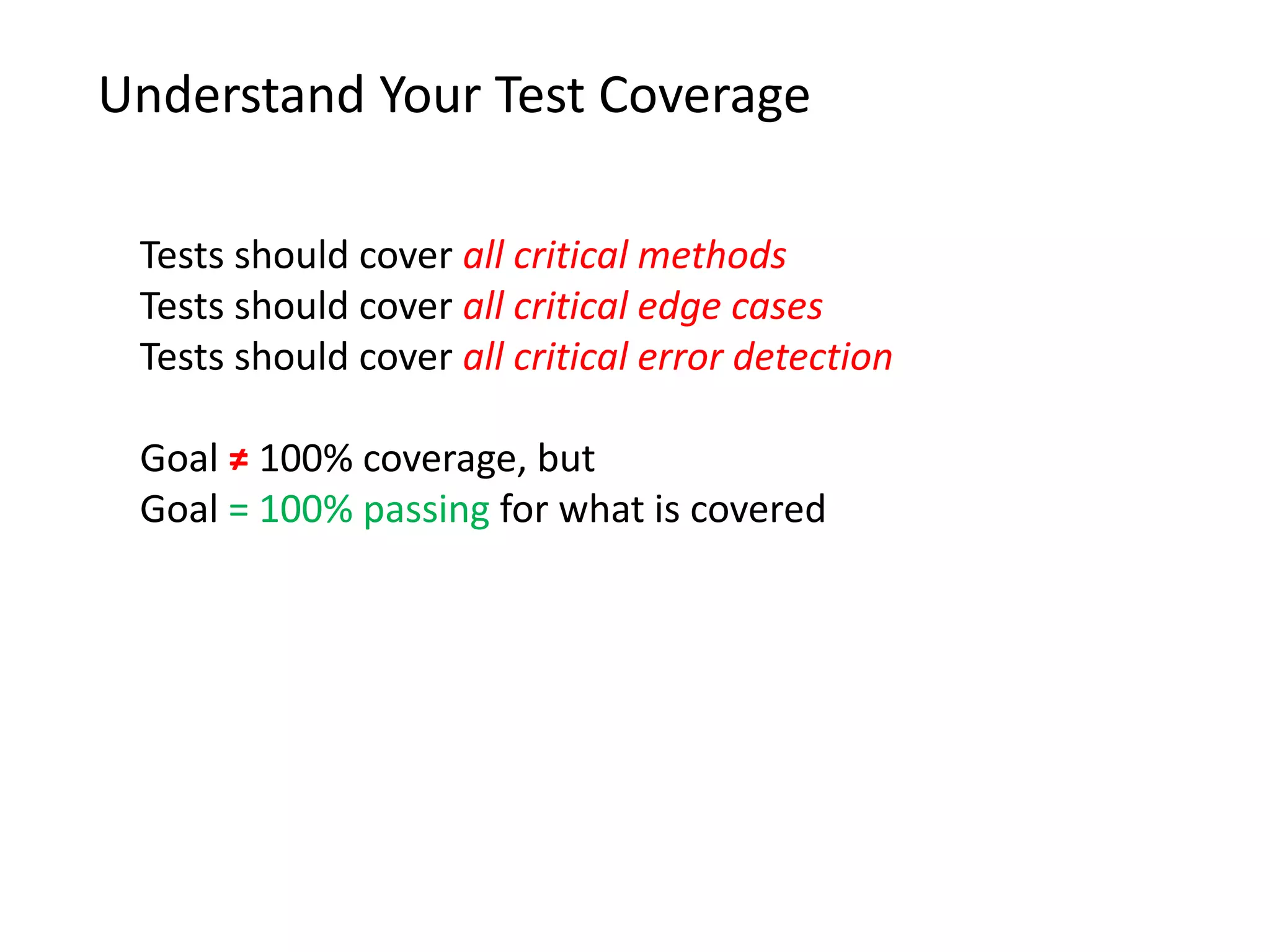

Understand Your Test Coverage Tests should cover all critical methods Tests should cover all critical edge cases Tests should cover all critical error detection Goal ≠ 100% coverage, but Goal = 100% passing for what is covered

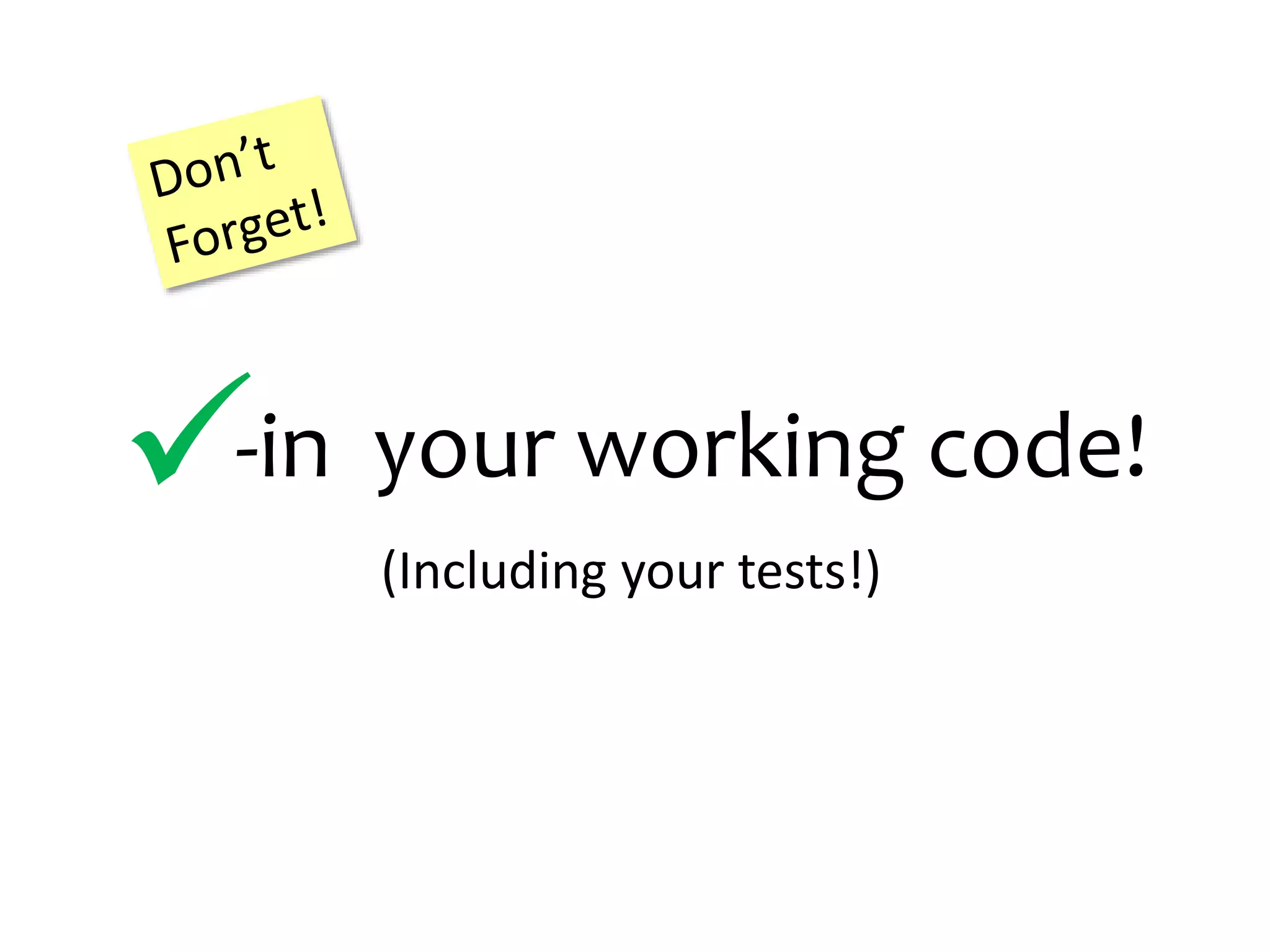

-in your working code! (Including your tests!)
Write Test  Execute Test to Show Failure Create Feature To Pass Test  Why? Know test will show fail Why? Tests = Specs Acceptance Tests Describe Desired Behavior Describe Feature Test Steps  Recurse over this pattern! Underneath… …are Unit Tests

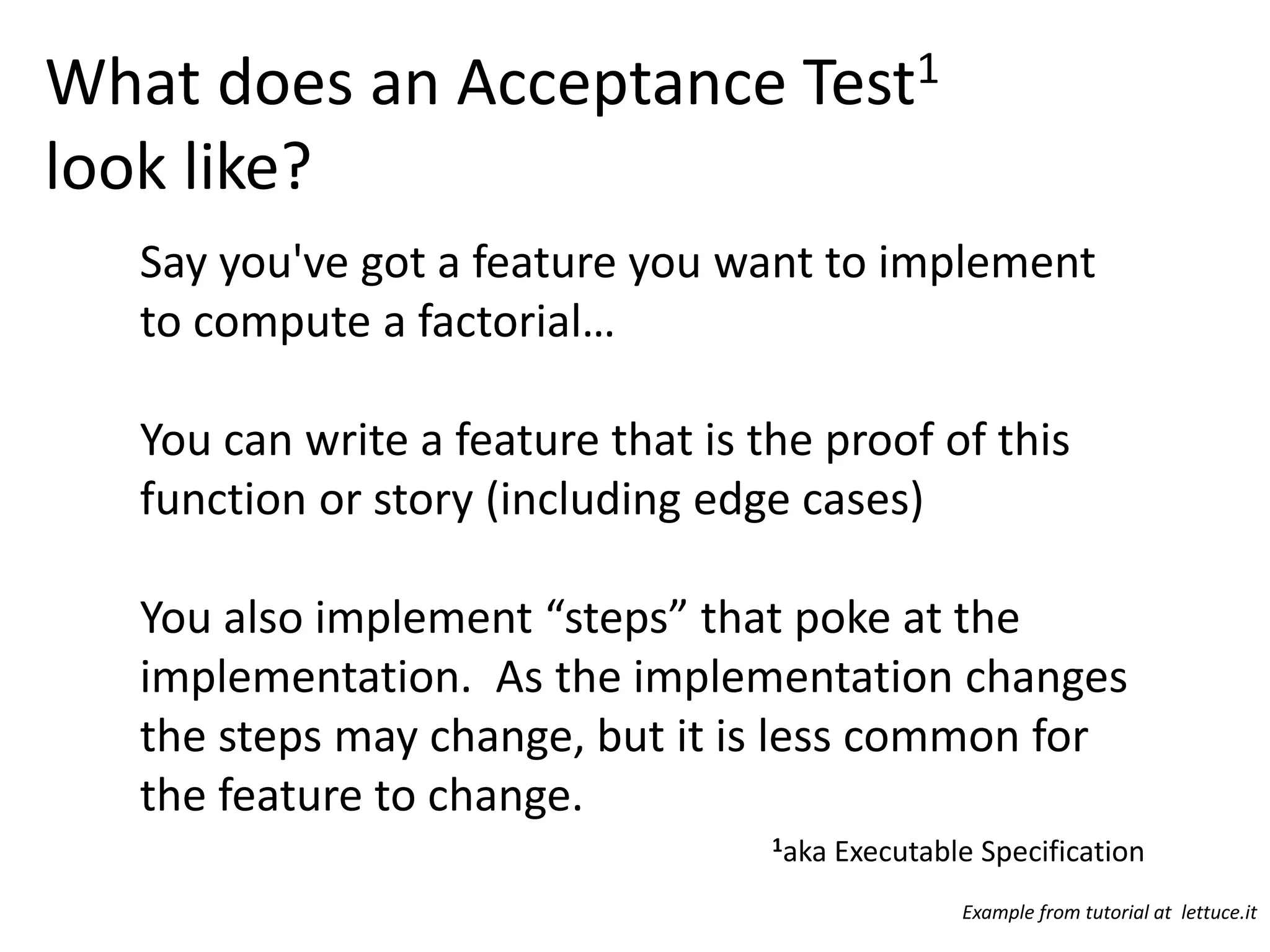

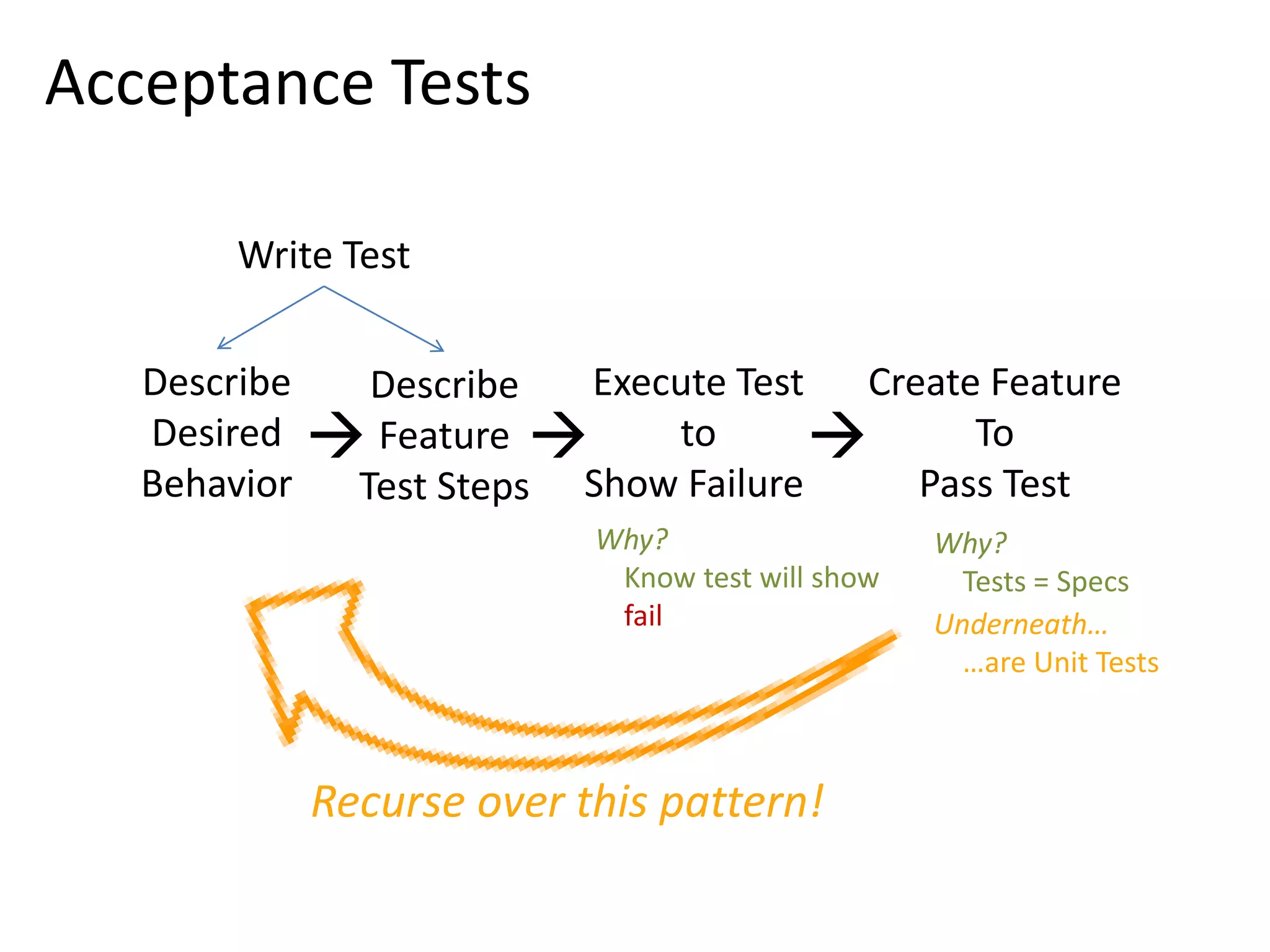

What does an Acceptance Test1 look like? Say you've got a feature you want to implement to compute a factorial… You can write a feature that is the proof of this function or story (including edge cases) You also implement “steps” that poke at the implementation. As the implementation changes the steps may change, but it is less common for the feature to change. 1aka Executable Specification Example from tutorial at lettuce.it

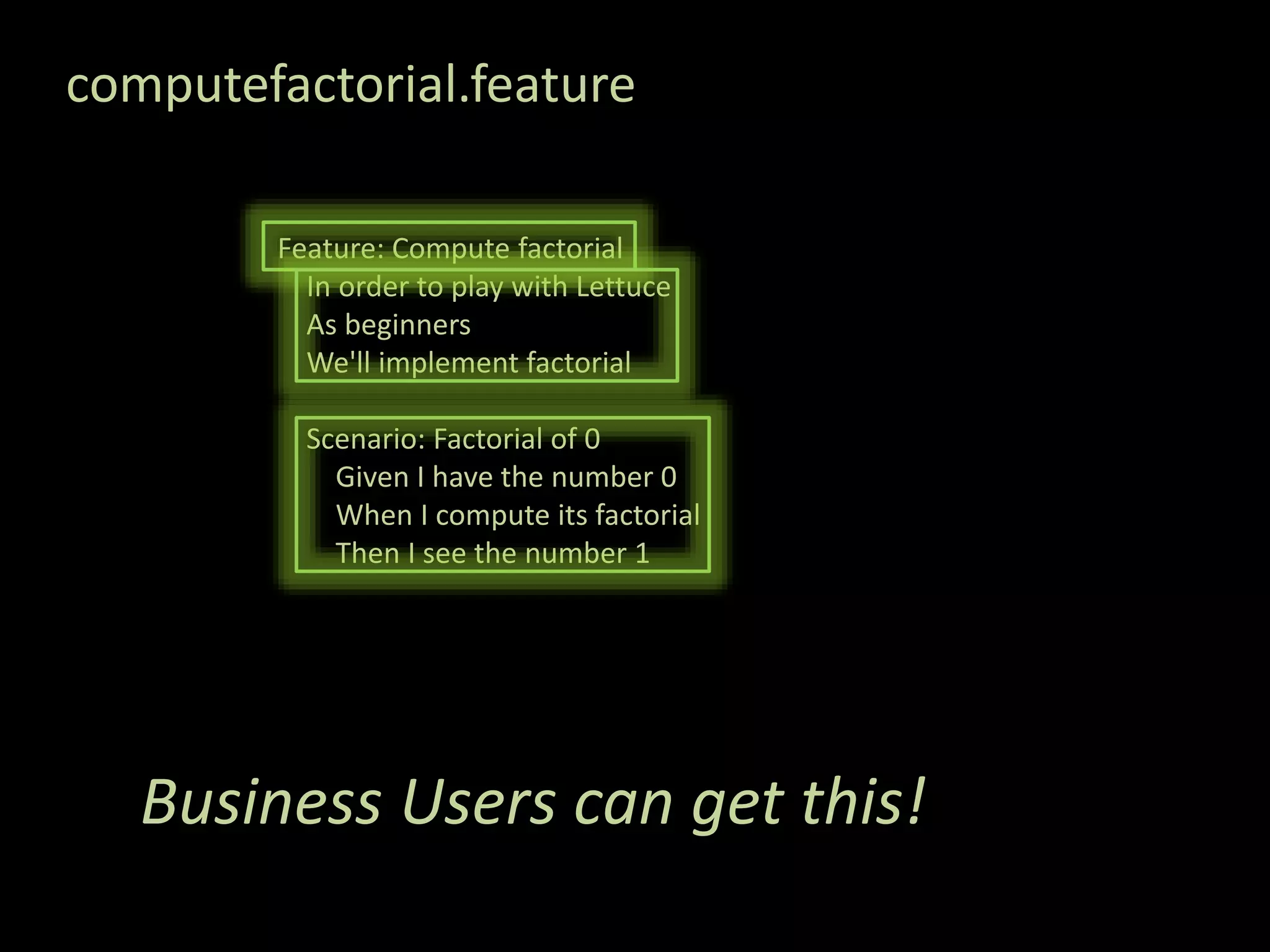

computefactorial.feature Feature: Compute factorial In order to play with Lettuce As beginners We'll implement factorial Scenario: Factorial of 0 Given I have the number 0 When I compute its factorial Then I see the number 1 Business Users can get this!

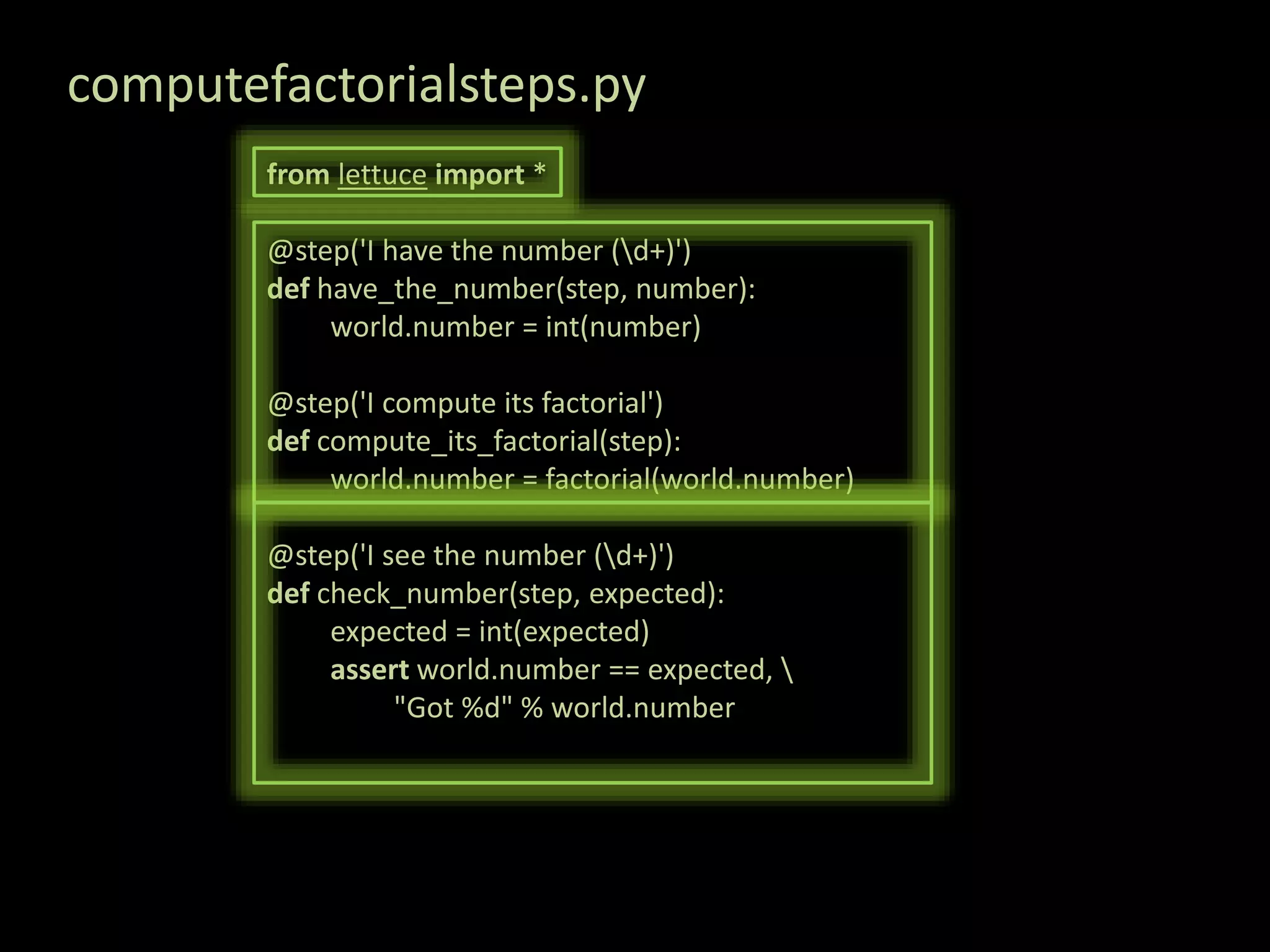

computefactorialsteps.py from lettuce import * @step('I have the number (d+)') def have_the_number(step, number): world.number = int(number) @step('I compute its factorial') def compute_its_factorial(step): world.number = factorial(world.number) @step('I see the number (d+)') def check_number(step, expected): expected = int(expected) assert world.number == expected, "Got %d" % world.number
To exercise the test: Run Feature (duh!) Add more code to fix problems and re-run….
computefactorial.py def factorial(number): return 1 by definition, we know that the factorial of 0 is 1 So as a mock, we created a function that just returned 1

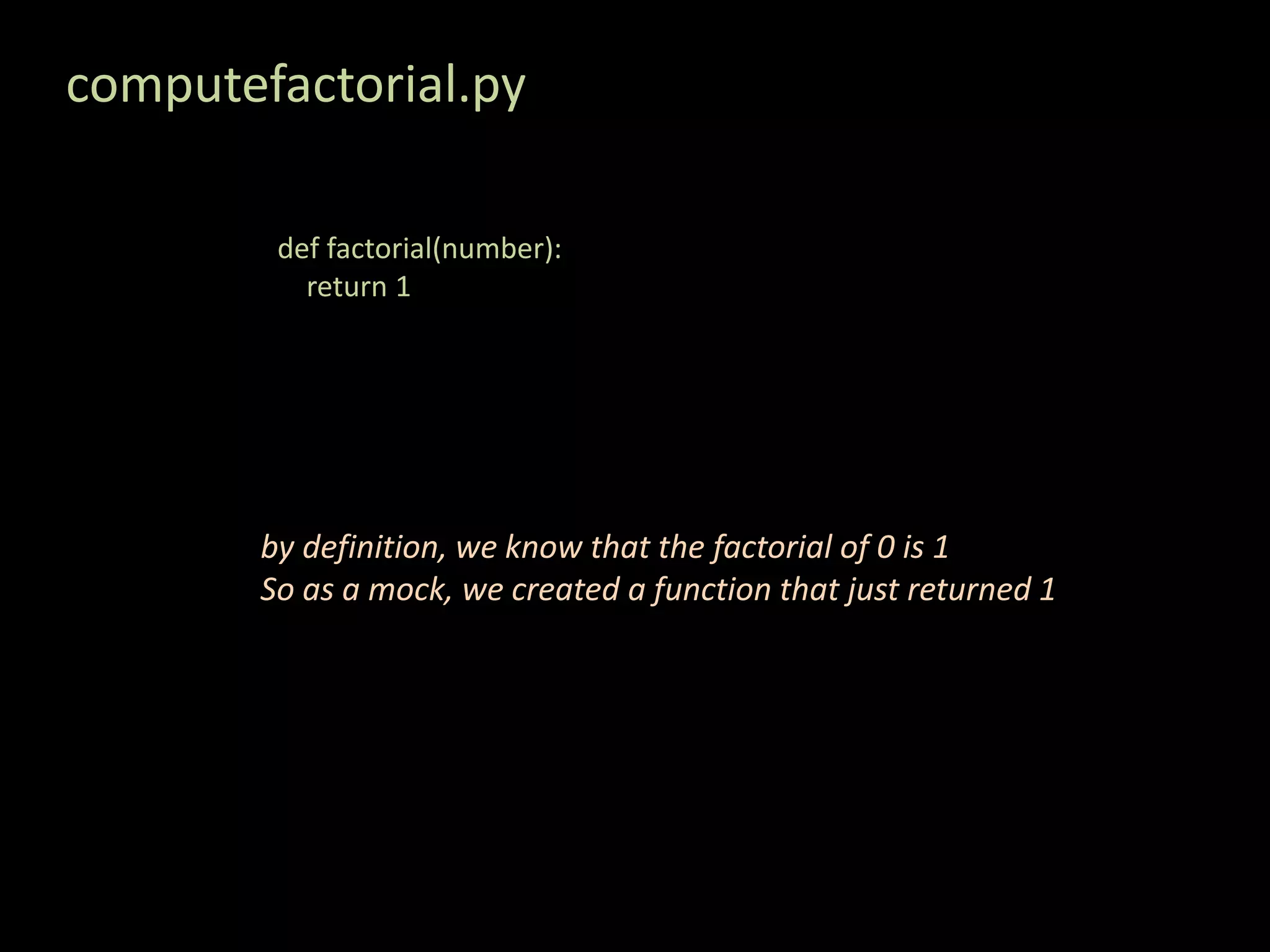

To exercise the test: Re-run Feature (duh!) Need more than one case of course, so let’s add more test cases; i.e. feature scenarios

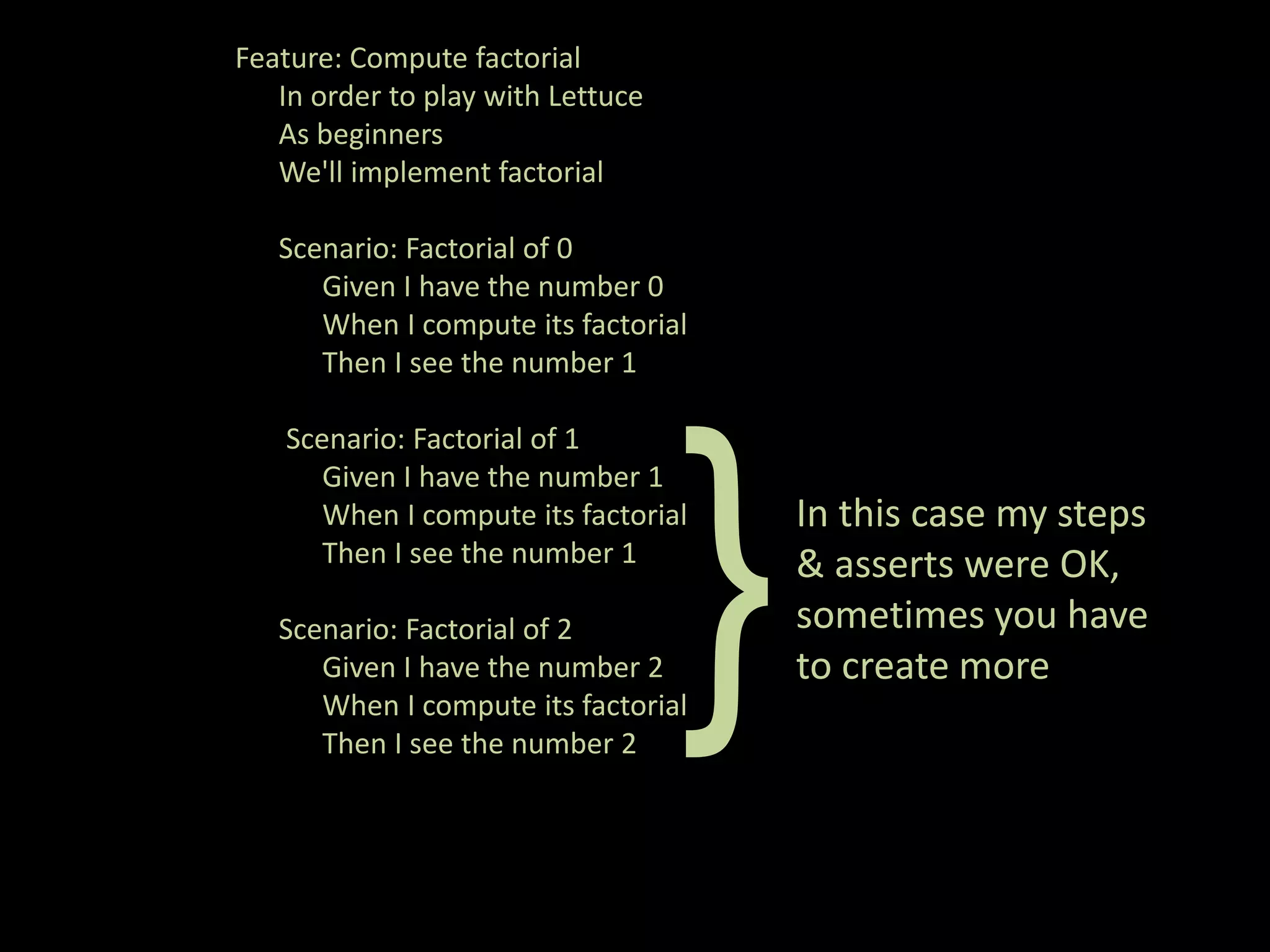

Feature: Compute factorial In order to play with Lettuce As beginners We'll implement factorial Scenario: Factorial of 0 Given I have the number 0 When I compute its factorial Then I see the number 1 Scenario: Factorial of 1 Given I have the number 1 When I compute its factorial In this case my steps Then I see the number 1 }Given I have the number 2 When I compute its factorial Then I see the number 2 Scenario: Factorial of 2 & asserts were OK, sometimes you have to create more
To exercise the test: Rerun Feature (duh!) Change code to fix problems and re-run….
computefactorial.py def factorial(number): number = int(number) if (number == 0) or (number == 1): return 1 else: return number
To exercise the test: Rerun Feature (duh!) Add a few more cases so we get realistic…

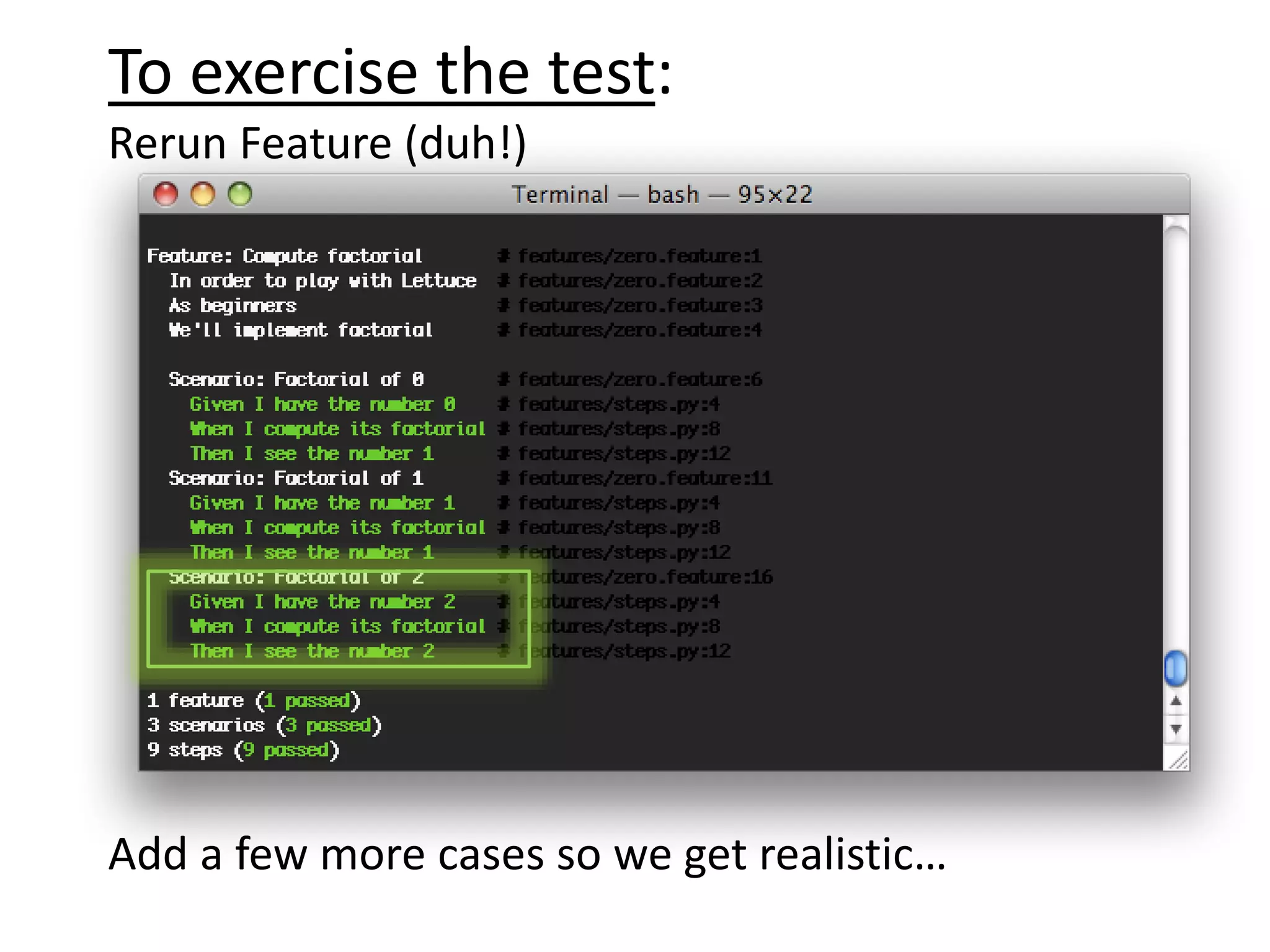

Feature: Compute factorial In order to play with Lettuce As beginners We'll implement factorial Scenario: Factorial of 0 … Scenario: Factorial of 1 … Scenario: Factorial of 2 … Scenario: Factorial of 3 Given I have the number 3 Again my steps & When I compute its factorial Then I see the number 6 } Given I have the number 4 When I compute its factorial Then I see the number 24 Scenario: Factorial of 4 asserts were Ok this time, sometimes you have to create more

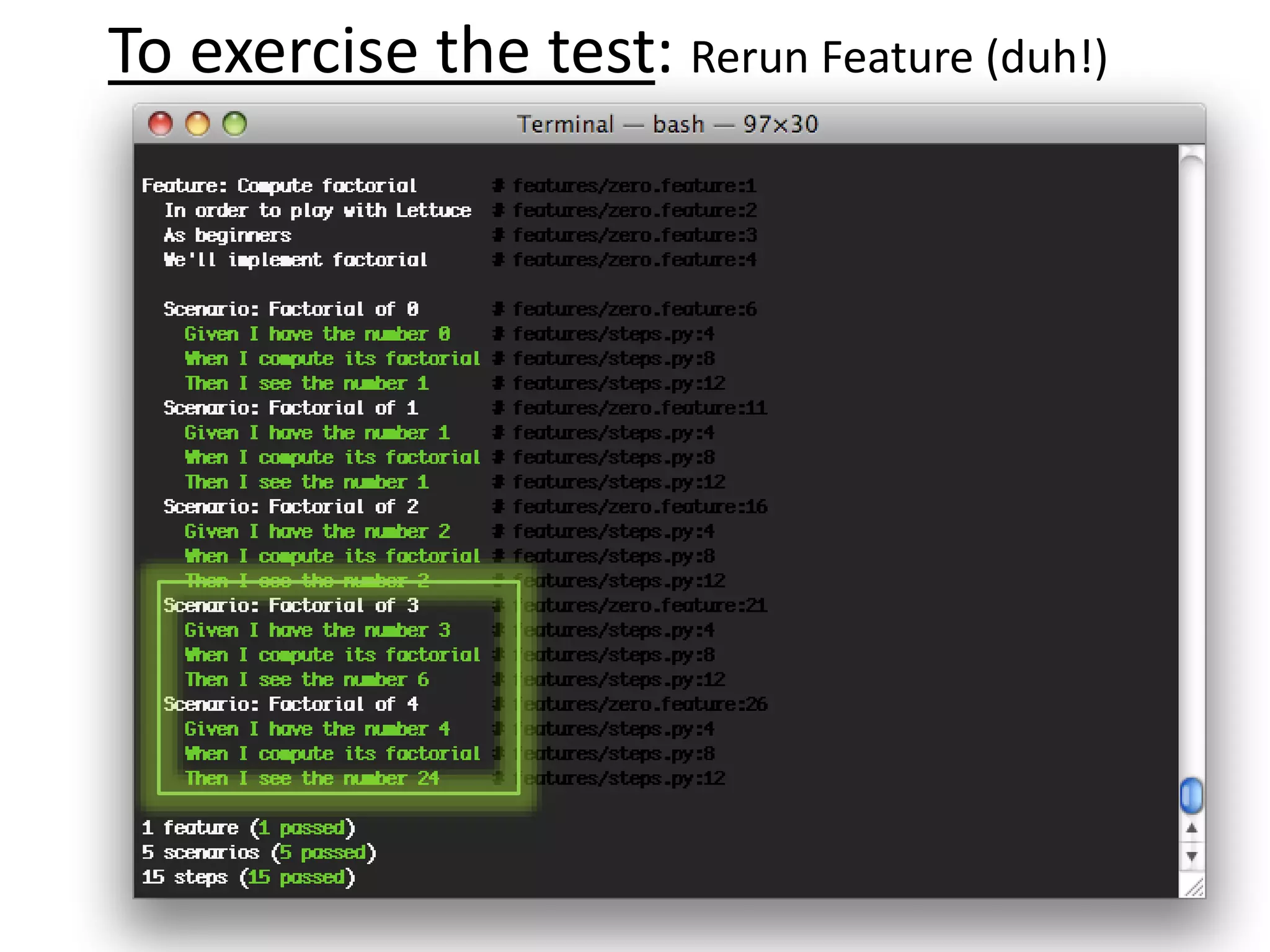

To exercise the test: Rerun Feature (duh!)

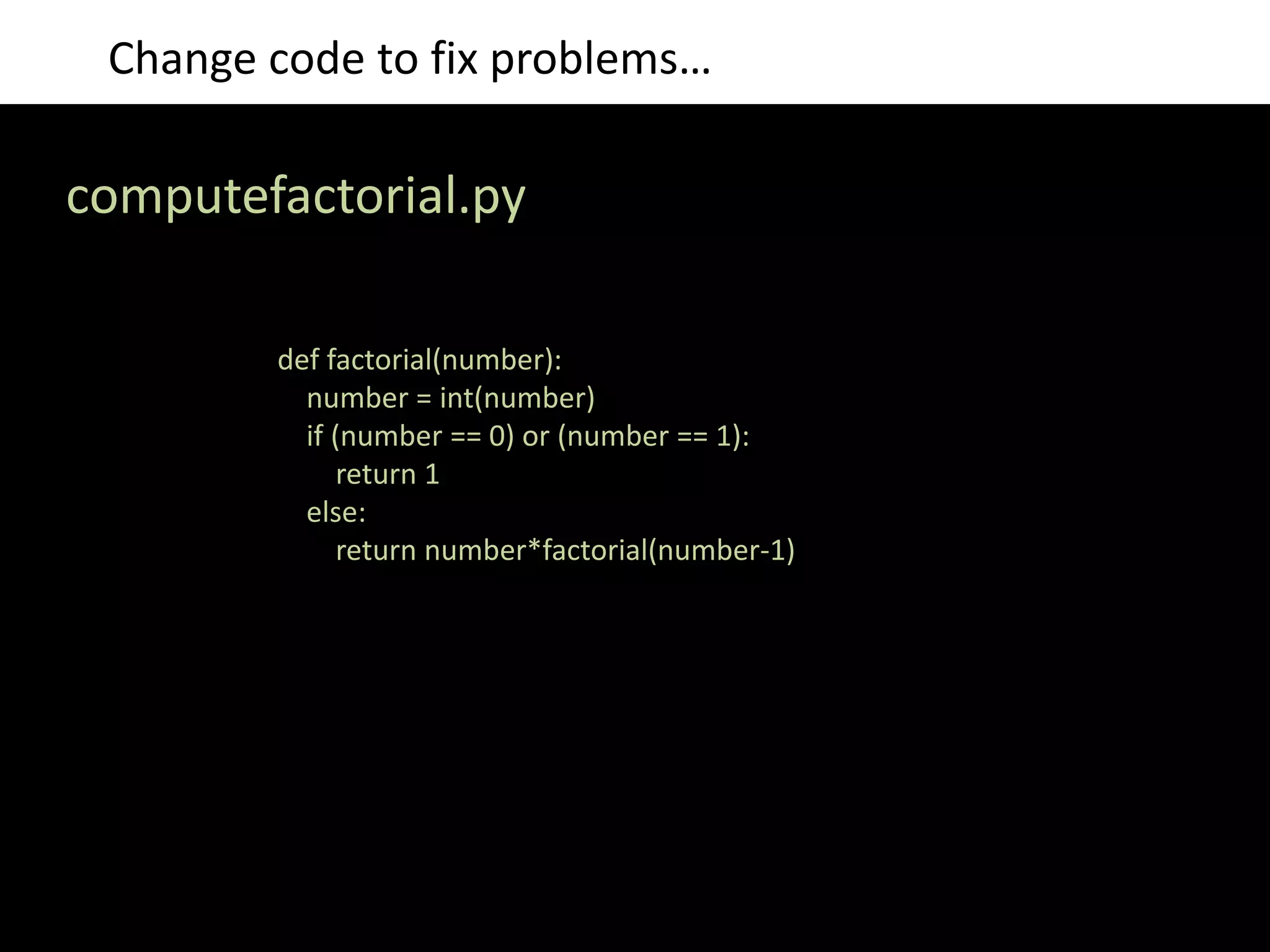

Change code to fix problems… computefactorial.py def factorial(number): number = int(number) if (number == 0) or (number == 1): return 1 else: return number*factorial(number-1)
To exercise the test: Rerun Feature (duh!)

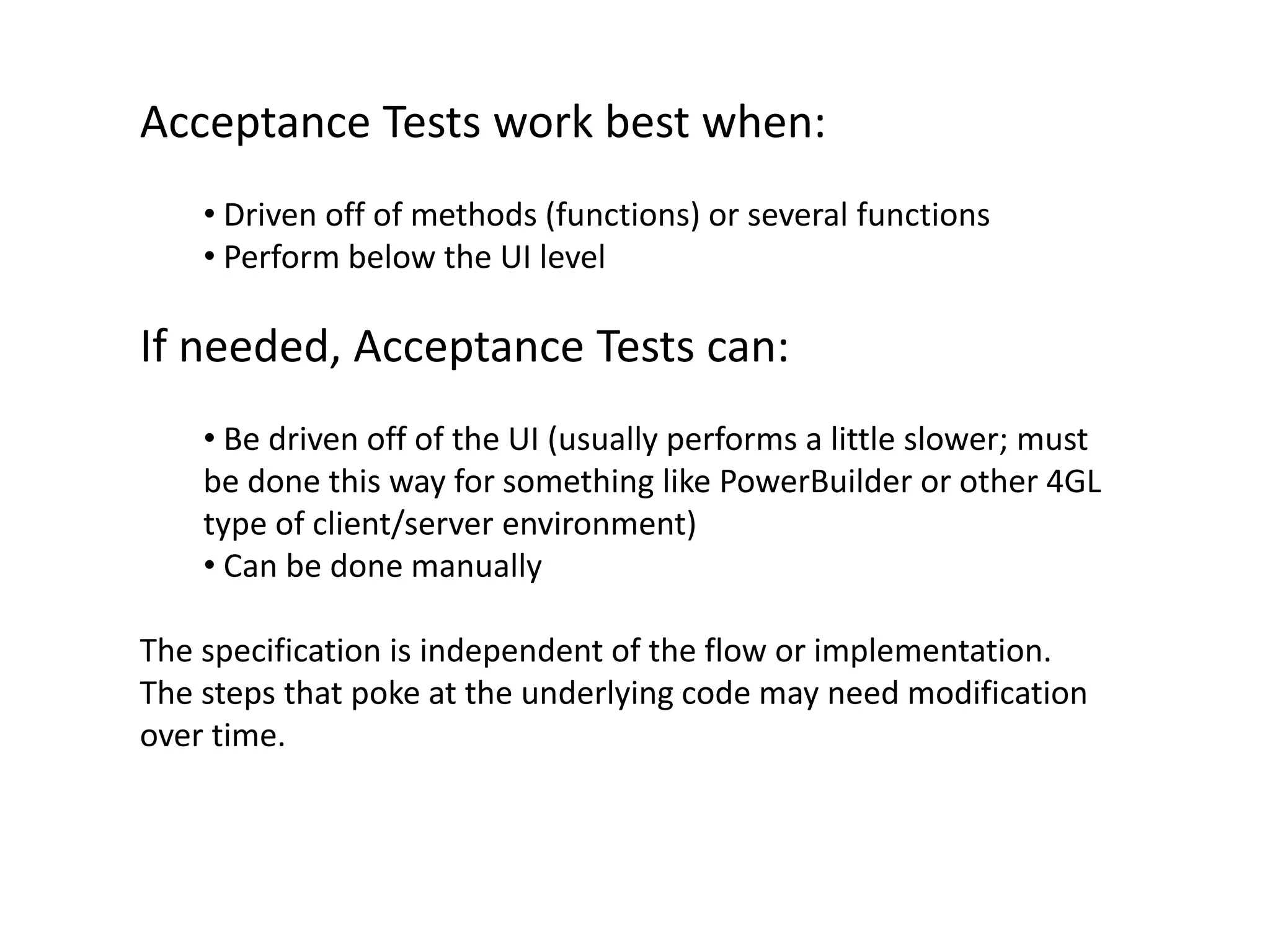

Acceptance Tests work best when: • Driven off of methods (functions) or several functions • Perform below the UI level If needed, Acceptance Tests can: • Be driven off of the UI (usually performs a little slower; must be done this way for something like PowerBuilder or other 4GL type of client/server environment) • Can be done manually The specification is independent of the flow or implementation. The steps that poke at the underlying code may need modification over time.
-in your working code! (Including your tests!)

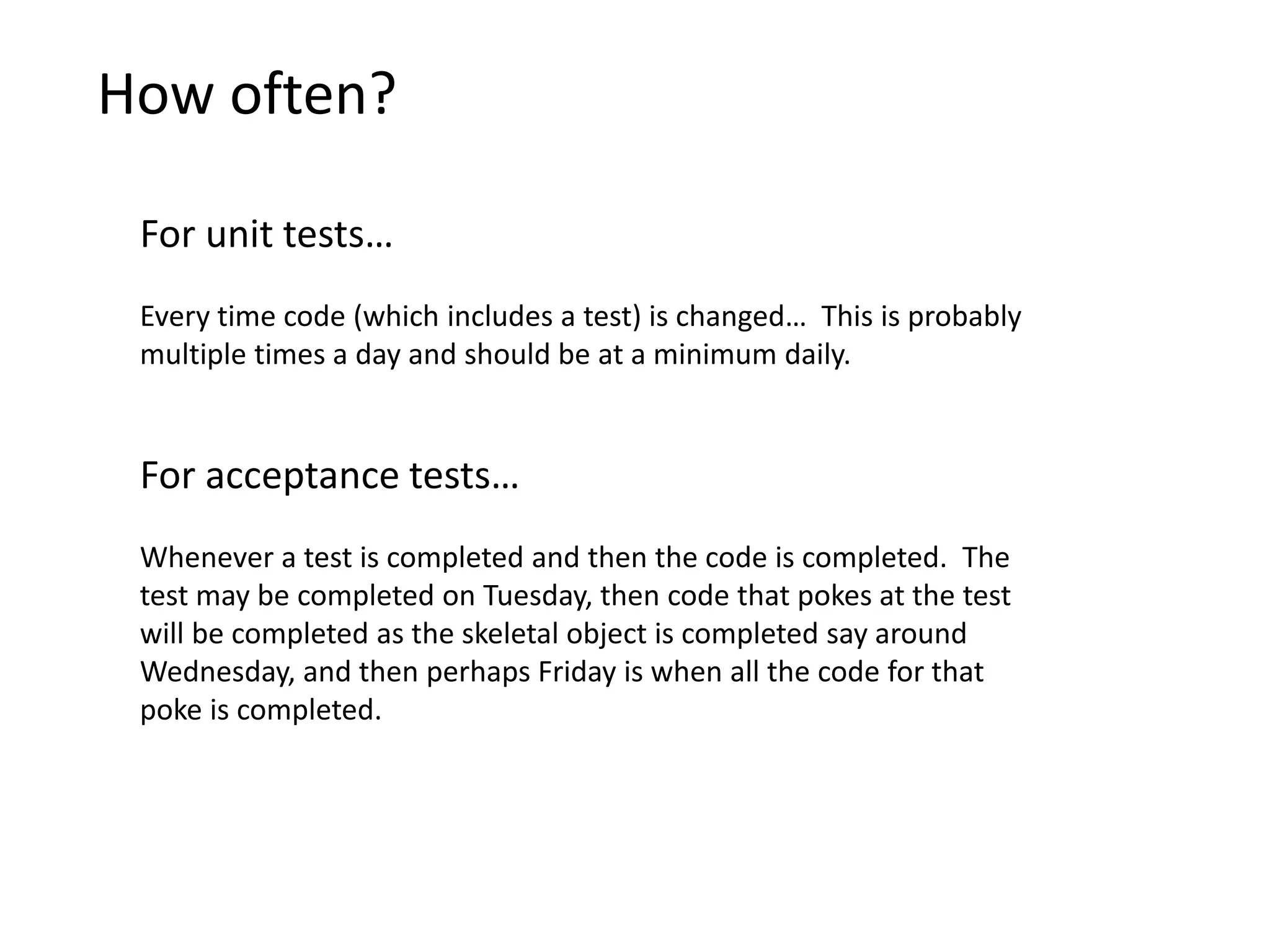

How often? For unit tests… Every time code (which includes a test) is changed… This is probably multiple times a day and should be at a minimum daily. For acceptance tests… Whenever a test is completed and then the code is completed. The test may be completed on Tuesday, then code that pokes at the test will be completed as the skeletal object is completed say around Wednesday, and then perhaps Friday is when all the code for that poke is completed.

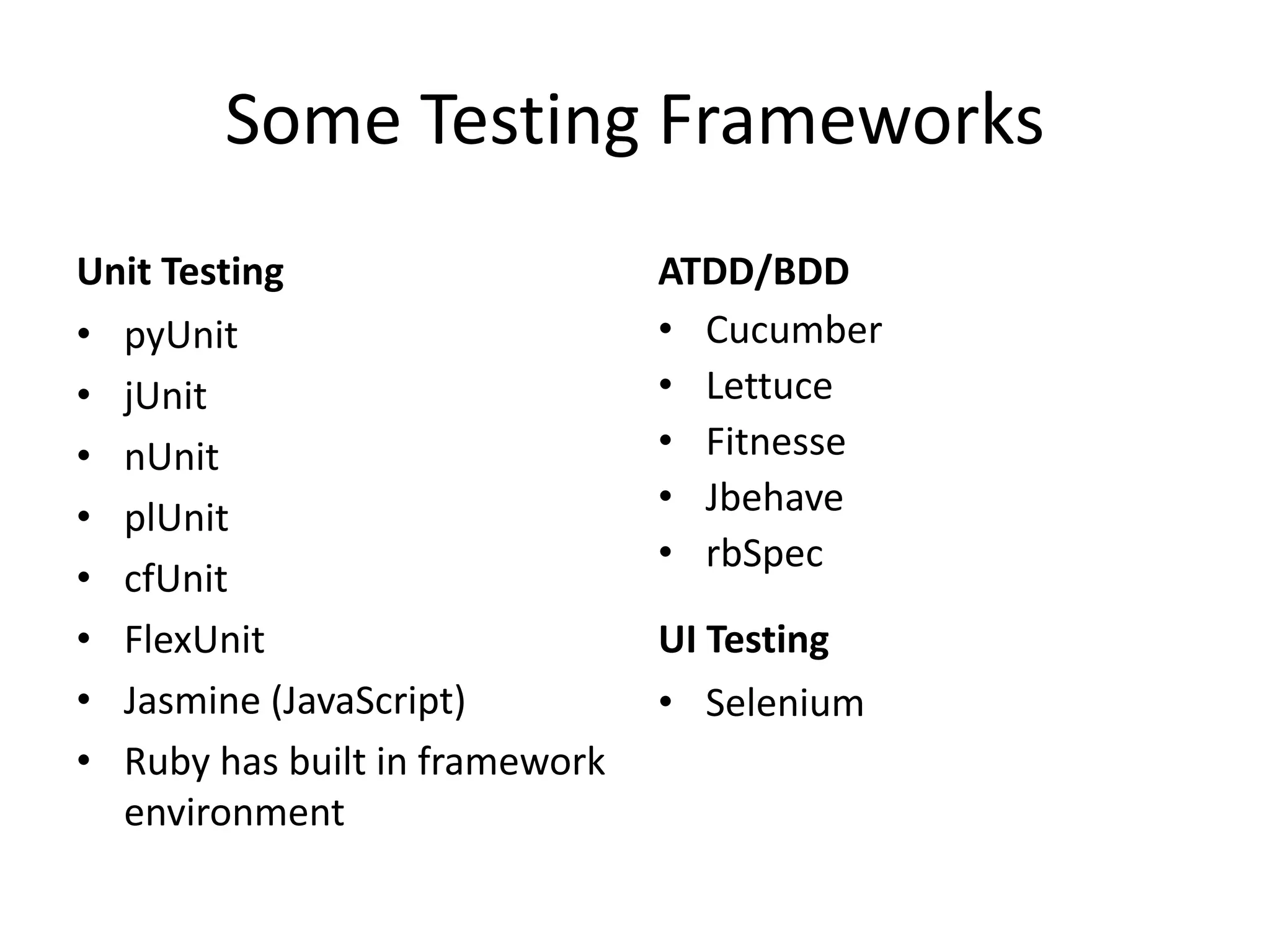

Some Testing Frameworks Unit Testing • pyUnit • jUnit • nUnit • plUnit • cfUnit • FlexUnit • Jasmine (JavaScript) • Ruby has built in framework environment ATDD/BDD • Cucumber • Lettuce • Fitnesse • Jbehave • rbSpec UI Testing • Selenium
You need a break! Take 5 Minutes

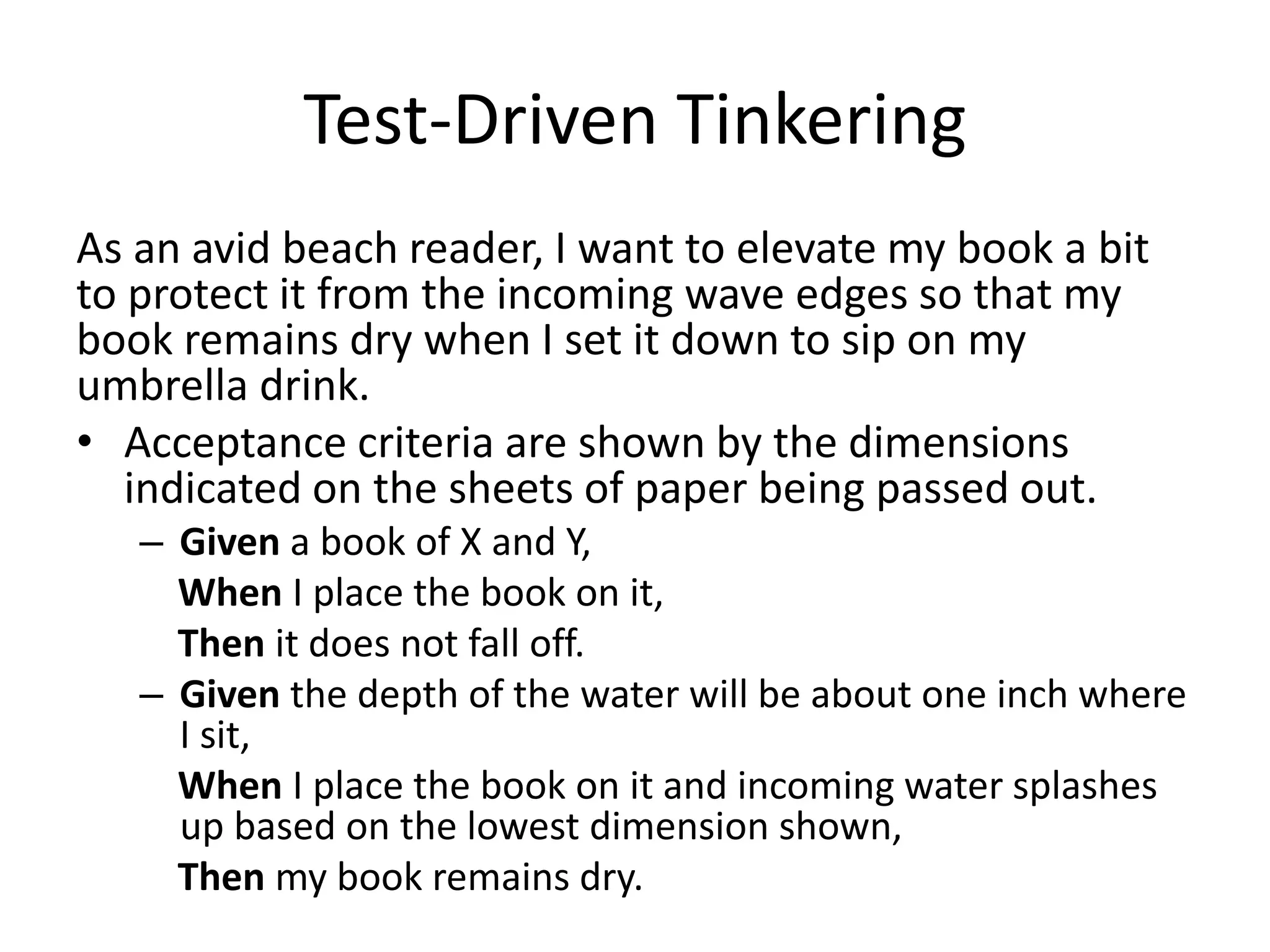

Test-Driven Tinkering As an avid beach reader, I want to elevate my book a bit to protect it from the incoming wave edges so that my book remains dry when I set it down to sip on my umbrella drink. • Acceptance criteria are shown by the dimensions indicated on the sheets of paper being passed out. – Given a book of X and Y, When I place the book on it, Then it does not fall off. – Given the depth of the water will be about one inch where I sit, When I place the book on it and incoming water splashes up based on the lowest dimension shown, Then my book remains dry.

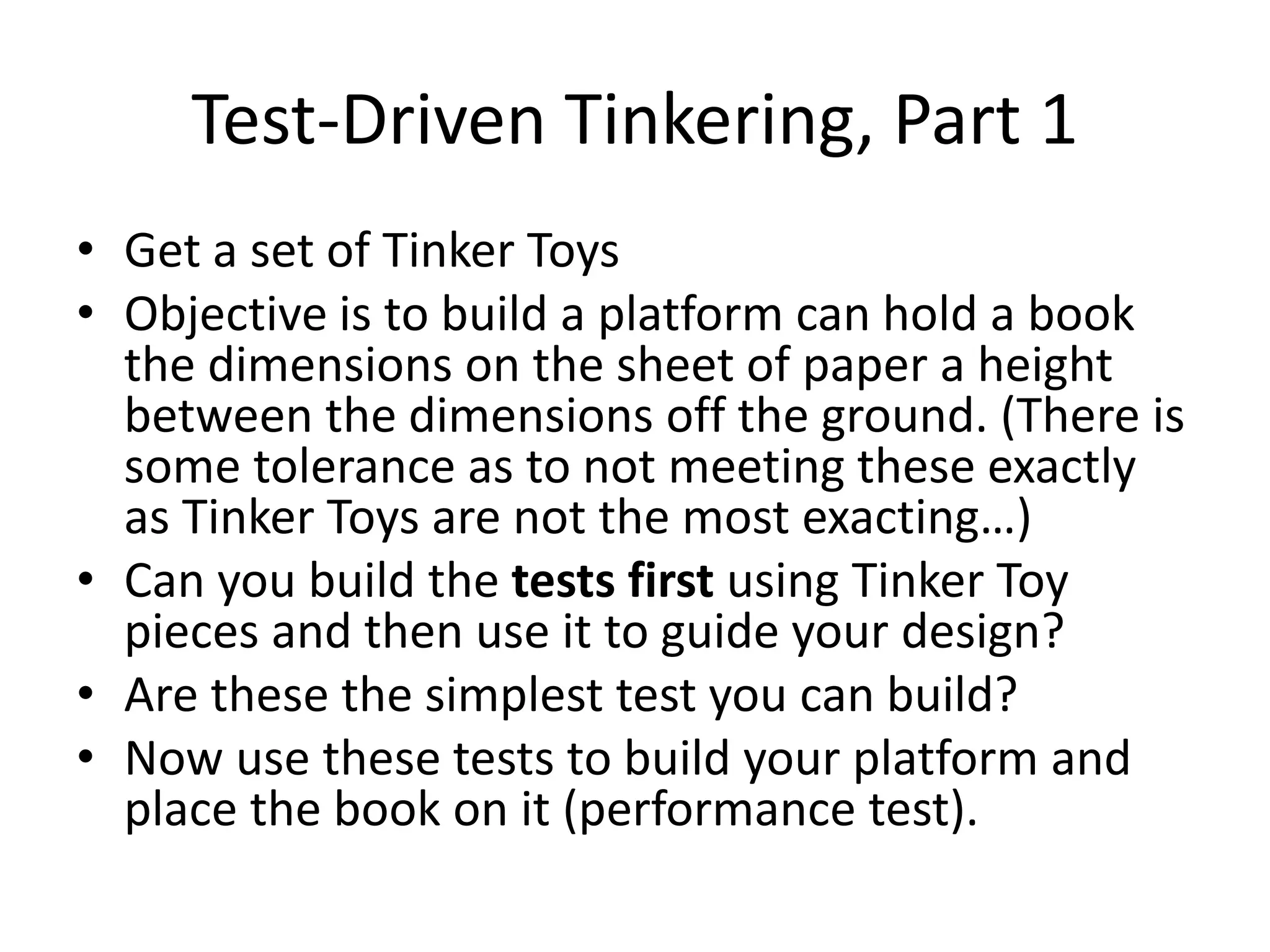

Test-Driven Tinkering, Part 1 • Get a set of Tinker Toys • Objective is to build a platform can hold a book the dimensions on the sheet of paper a height between the dimensions off the ground. (There is some tolerance as to not meeting these exactly as Tinker Toys are not the most exacting…) • Can you build the tests first using Tinker Toy pieces and then use it to guide your design? • Are these the simplest test you can build? • Now use these tests to build your platform and place the book on it (performance test).
Test-Driven Tinkering, Part 2 Given the waves come in closer When I need to move back towards the dunes Then I need a handle when I stand up to move the book elevator back with me • Now I want the structure’s height to be the height based on my new test (the handle I can use when I stand up). • Can you build a structure to pass this test while staying true to the other tests?
Test-Driven Tinkering Debrief
Test-Driven Tinkering Debrief • What do you think the Tinker Toys represent? • What tests were you able to construct before beginning your construction? How did they guide your design? • When you added onto your structure, did you break any of your prior tests? Congrats! AND…This brings us to …

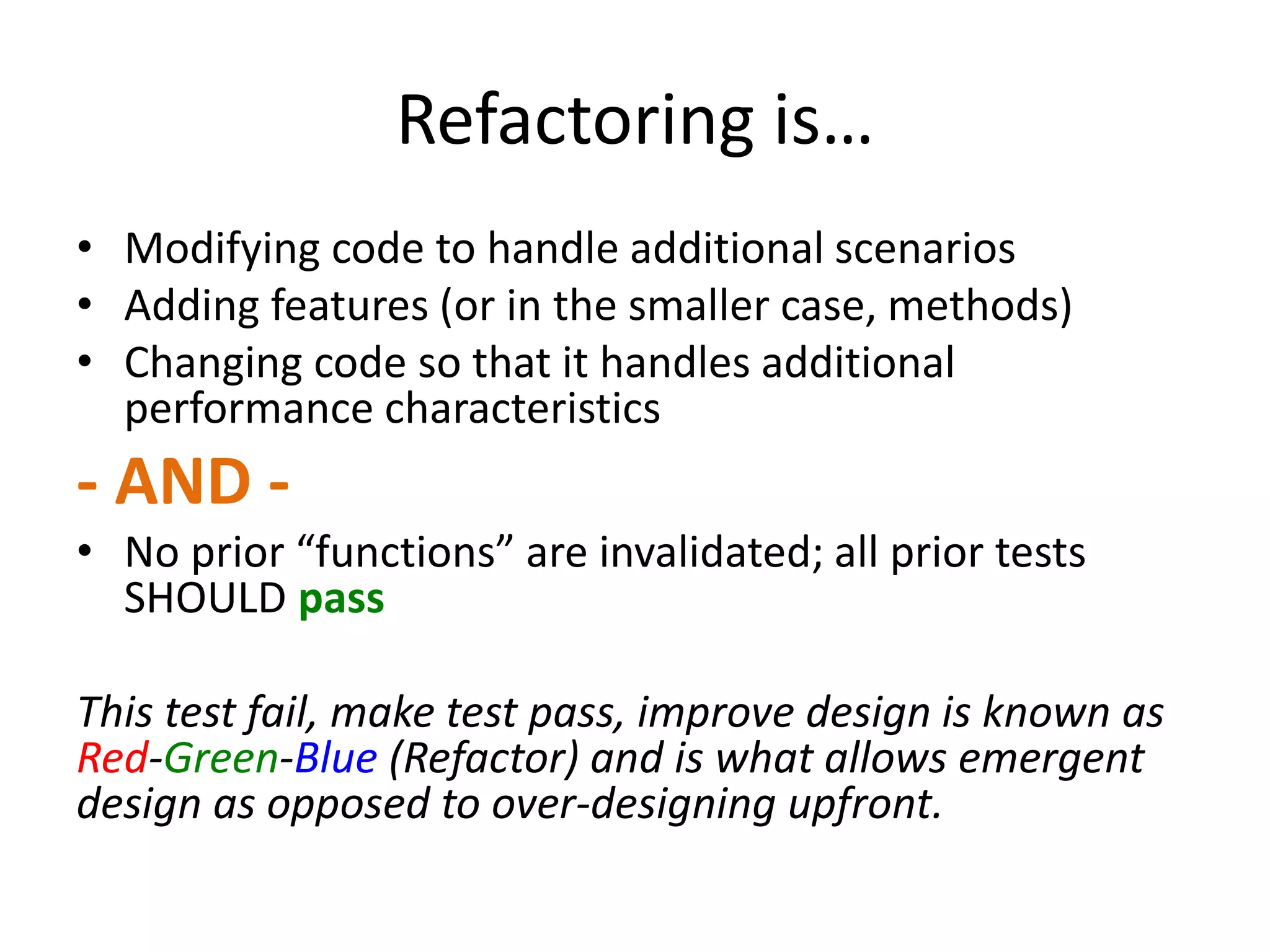

Refactoring is… • Modifying code to handle additional scenarios • Adding features (or in the smaller case, methods) • Changing code so that it handles additional performance characteristics - AND - • No prior “functions” are invalidated; all prior tests SHOULD pass This test fail, make test pass, improve design is known as Red-Green-Blue (Refactor) and is what allows emergent design as opposed to over-designing upfront.

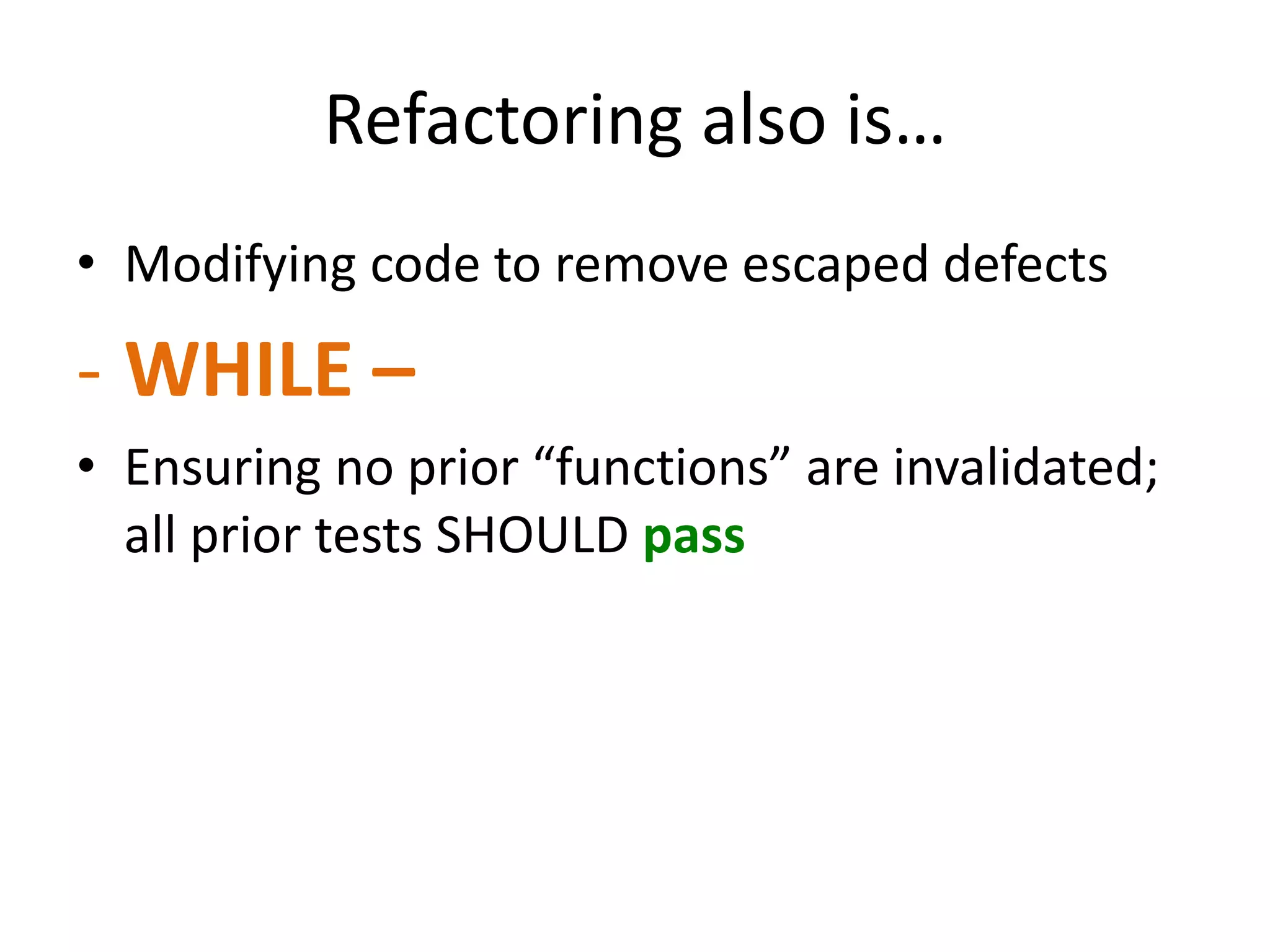

Refactoring also is… • Modifying code to remove escaped defects - WHILE – • Ensuring no prior “functions” are invalidated; all prior tests SHOULD pass
Think of TDD & Refactoring as Transforming Your Code into Something More Useful
Sometimes one one needs to refactor Legacy Code (oh the horror!)
#7 Mikado Method

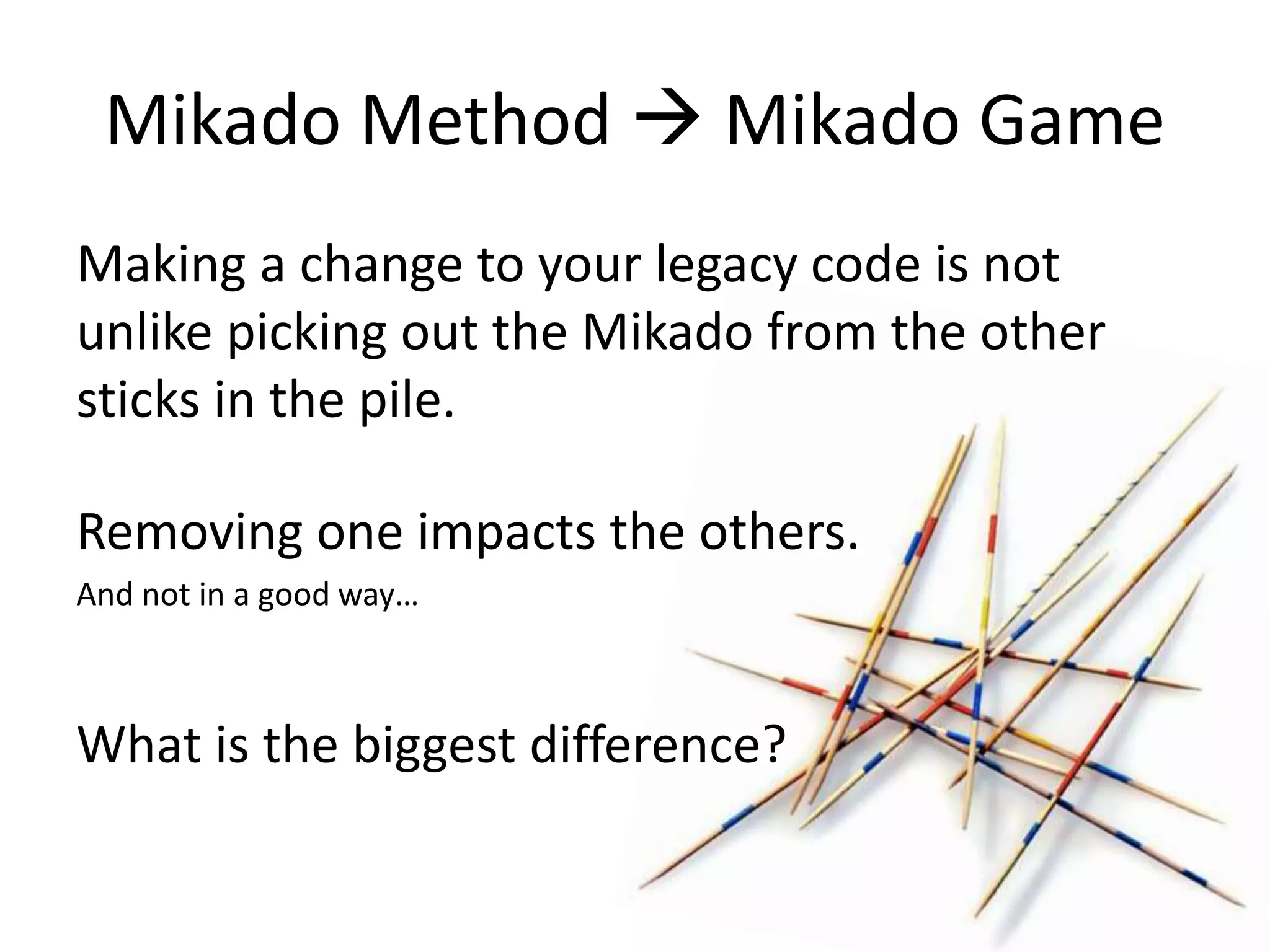

Mikado Method  Mikado Game Making a change to your legacy code is not unlike picking out the Mikado from the other sticks in the pile. Removing one impacts the others. And not in a good way… What is the biggest difference?
We can Revert our code!

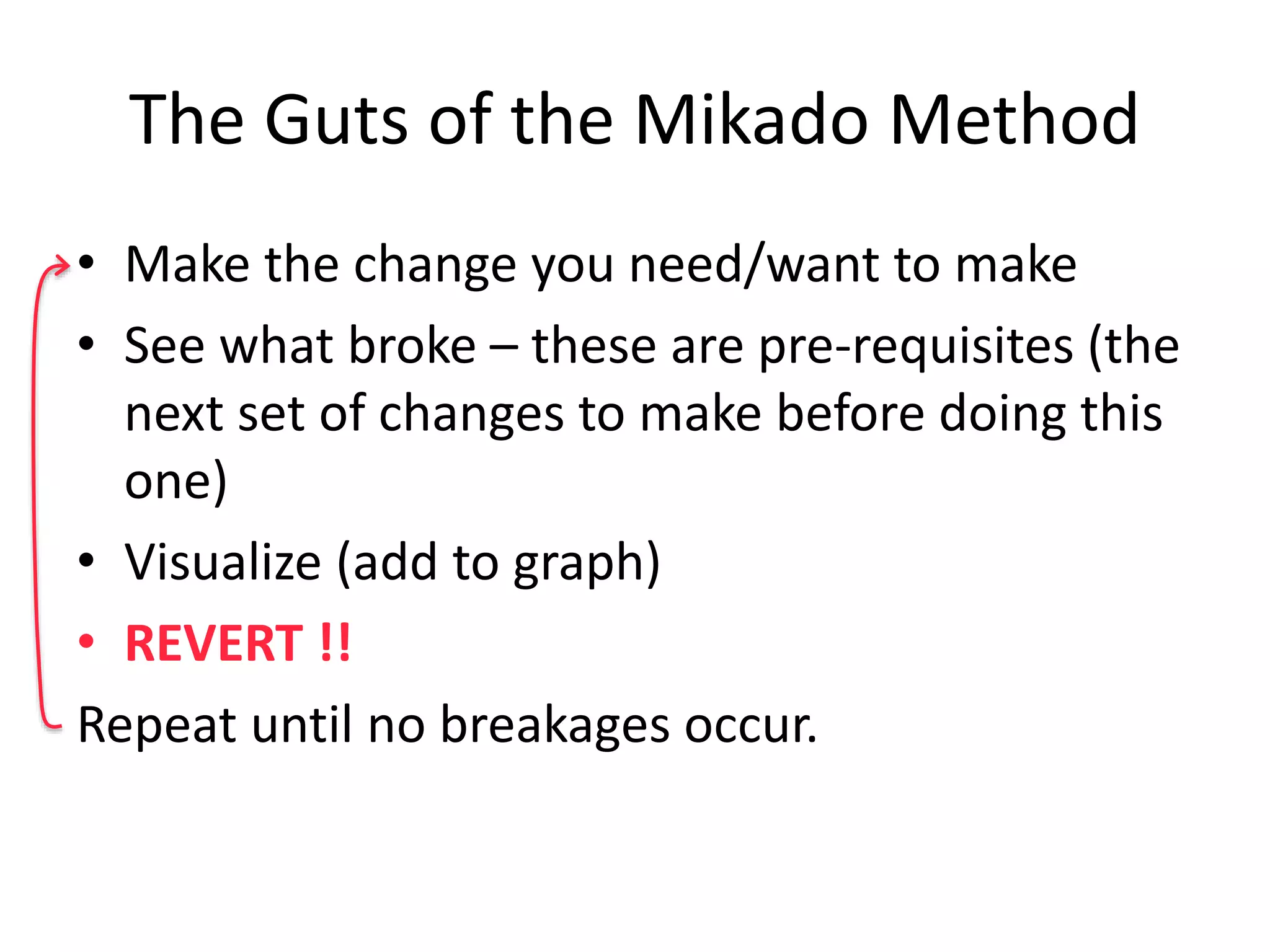

The Guts of the Mikado Method • Make the change you need/want to make • See what broke – these are pre-requisites (the next set of changes to make before doing this one) • Visualize (add to graph) • REVERT !! Repeat until no breakages occur.
Enable Database Concurrency Configure High Availability Reimplement DB Interface Change Connection Pooling Remove Redundant Code Change Properties File Isolate JDBC Connection Create RESTful Interface D i s c o v e r y R e f a c t o r ✓ ✓ ✓ ✓ ✓ ✓ ✓ ✓
Adding Tests to Legacy Code • Add unit (perhaps acceptance) tests as defects are removed or changes are made; basically anytime you make changes to the code. • Tests should capture what results should be displayed (Think assertions! -- Just like before) • I riddle you this: Why should we not go and simply add tests to everything?
#9 Continuous Delivery

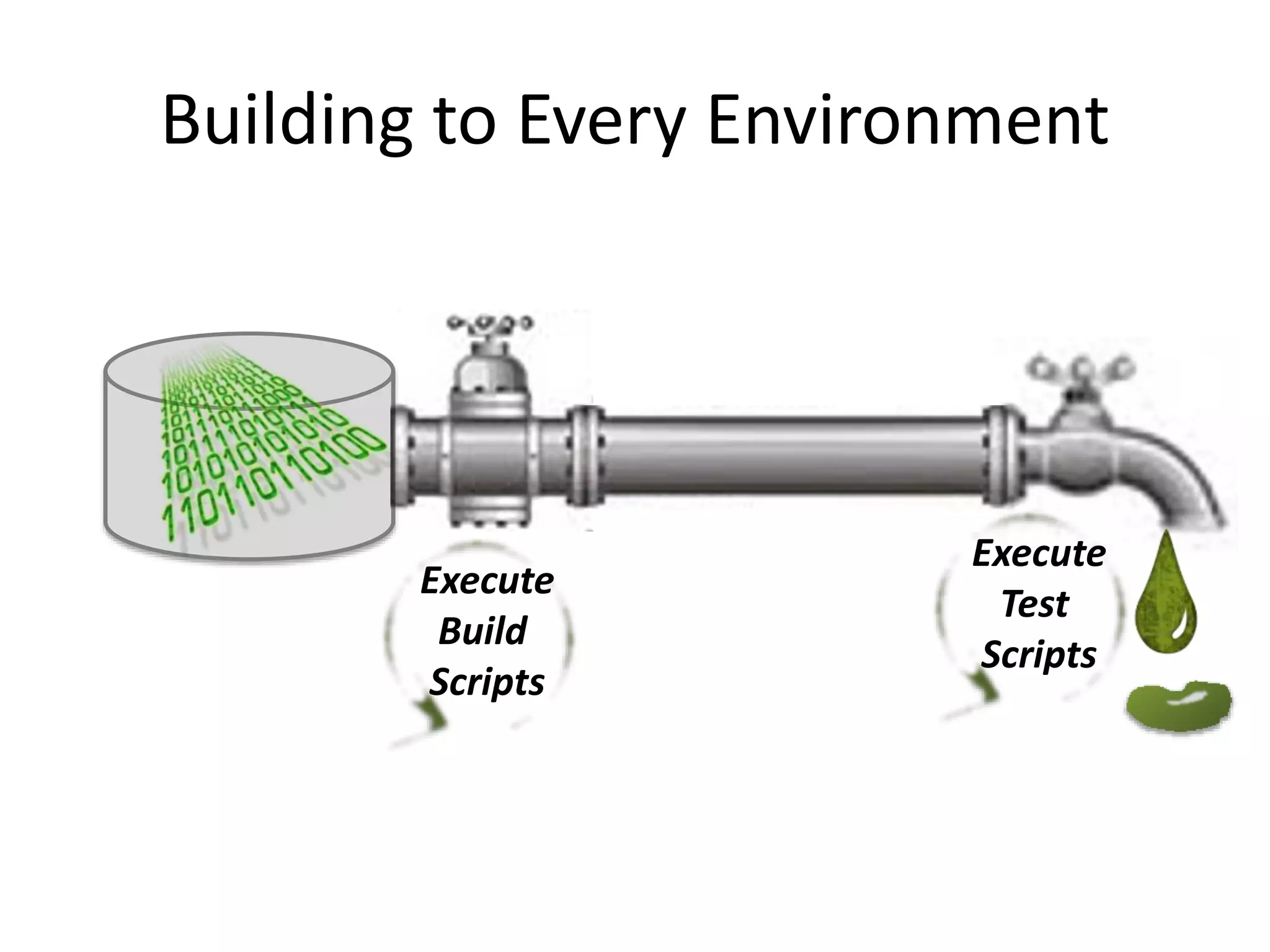

Building to Every Environment Execute Build Scripts Execute Test Scripts

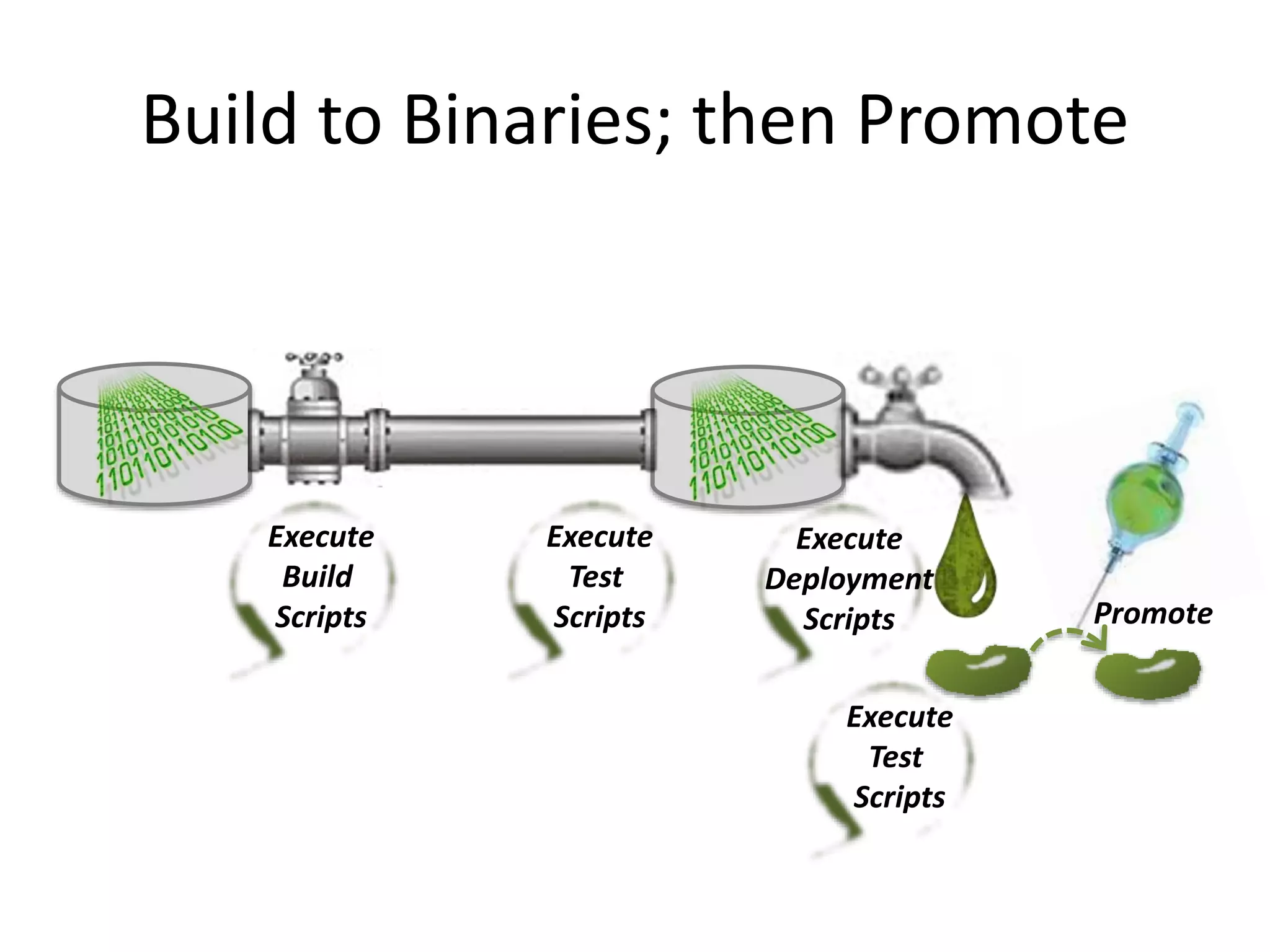

Build to Binaries; then Promote Execute Build Scripts Execute Test Scripts Execute Deployment Scripts Promote Execute Test Scripts
Deploy to all Environments Execute Build Scripts Build to Binaries; Execute Test Scripts Execute Deployment Scripts Execute Test Scripts

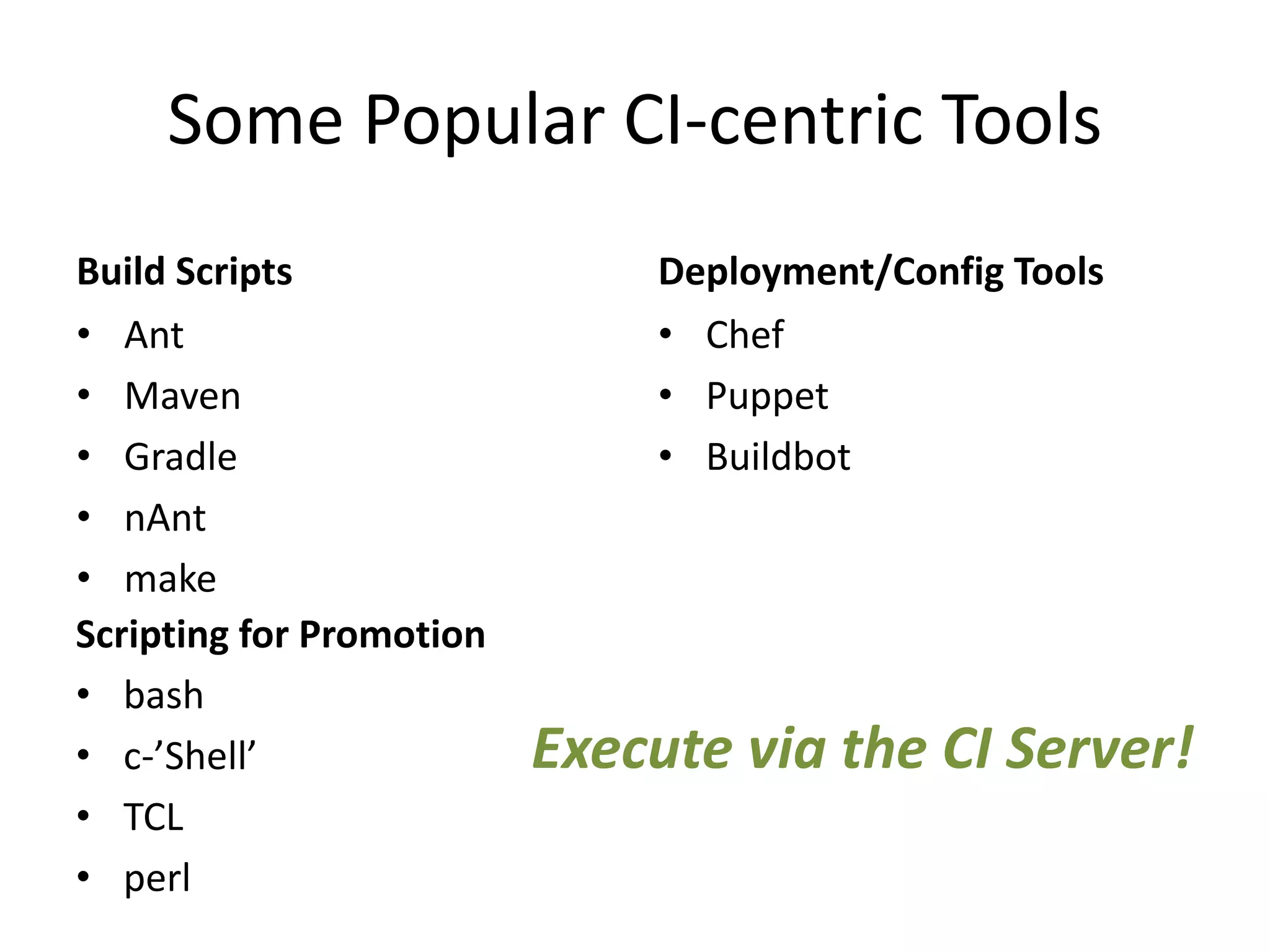

Some Popular CI-centric Tools Build Scripts • Ant • Maven • Gradle • nAnt • make Deployment/Config Tools • Chef • Puppet • Buildbot Scripting for Promotion • bash • c-’Shell’ • TCL • perl Execute via the CI Server!
Continuous Delivery meaningless is without some form of feedback loop
Types of (Post-Deployment) Feedback User Experience • Response times • Dwell times • Heatmap of “clicks” • Flow through the site Security • Attempted penetrations • Attempted DoS attacks Performance • Response times • Memory usage/Page faults • Storage growth Business Metrics • Improved cycle-time/ throughput on business process • Data quality (errors) • Additional fees/revenue • Reduced processing costs
Debrief
Following Good Engineering Practices… Makes for a more productive team – Faster feedback Faster feedback = Technical excellence – Catch defects before release Ø Defects = Happy CIO

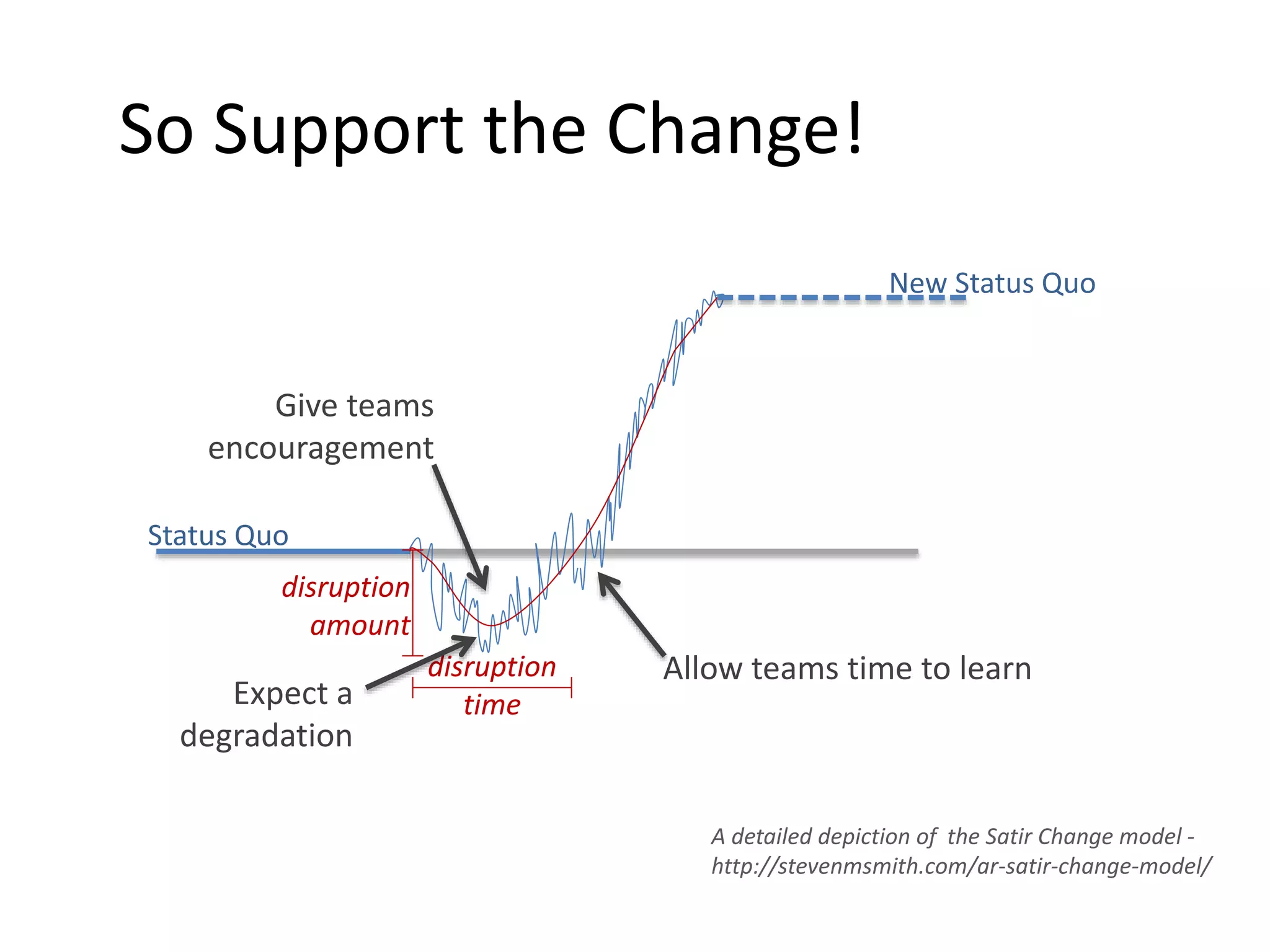

So Support the Change! Status Quo New Status Quo disruption amount disruption time Allow teams time to learn A detailed depiction of the Satir Change model - http://stevenmsmith.com/ar-satir-change-model/ Give teams encouragement Expect a degradation
Use this knowledge
…and Launch!
